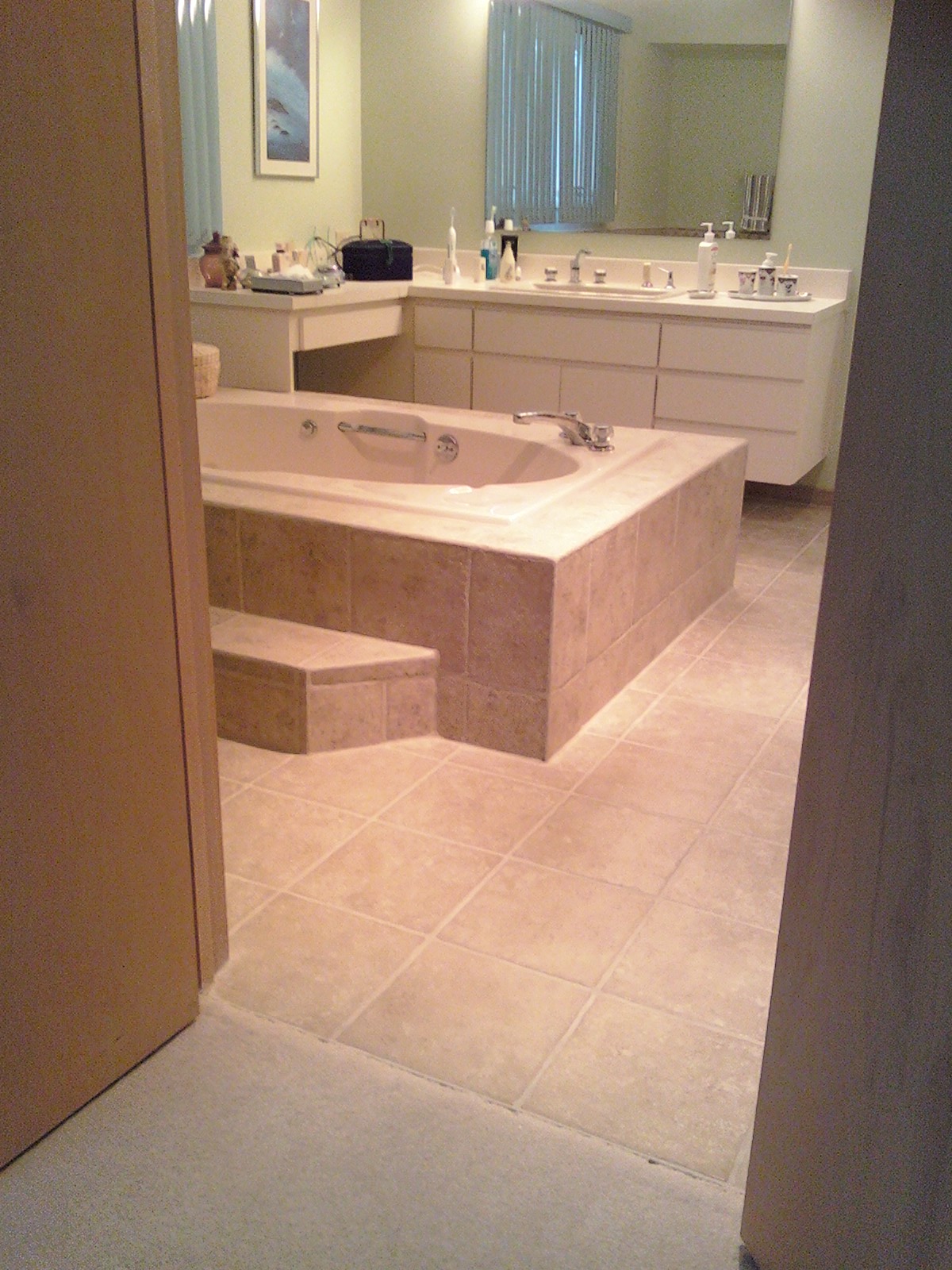

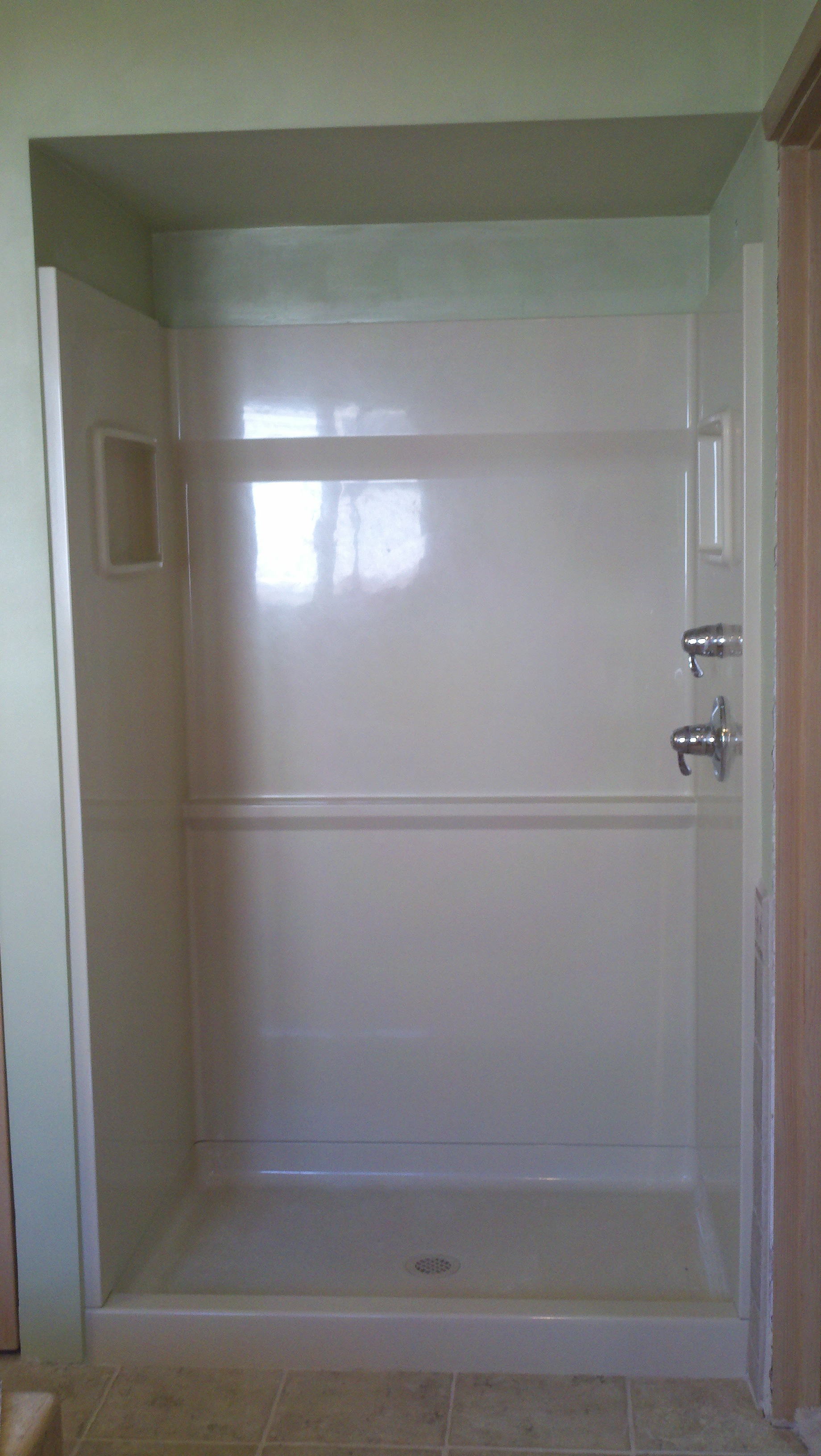

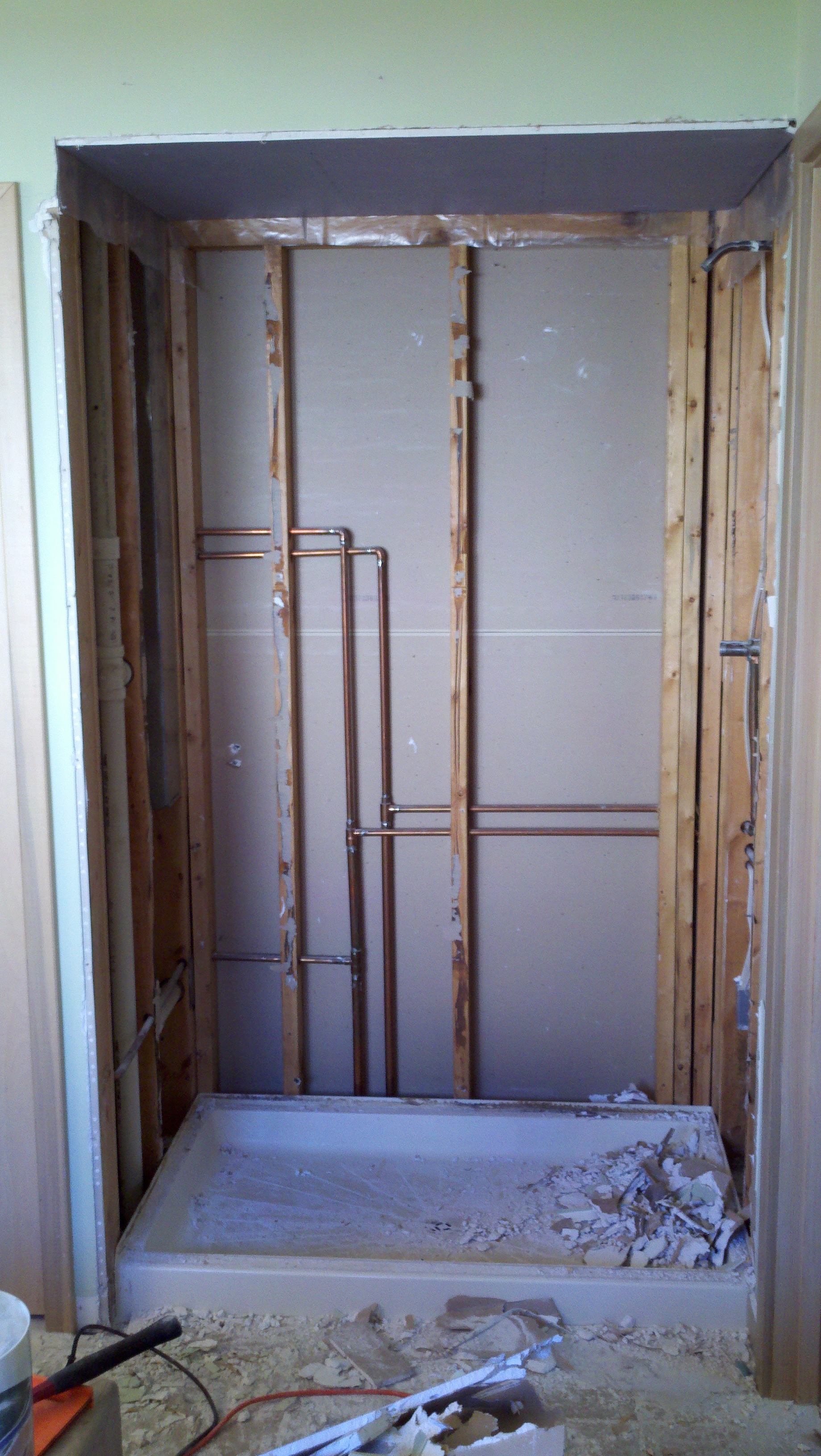

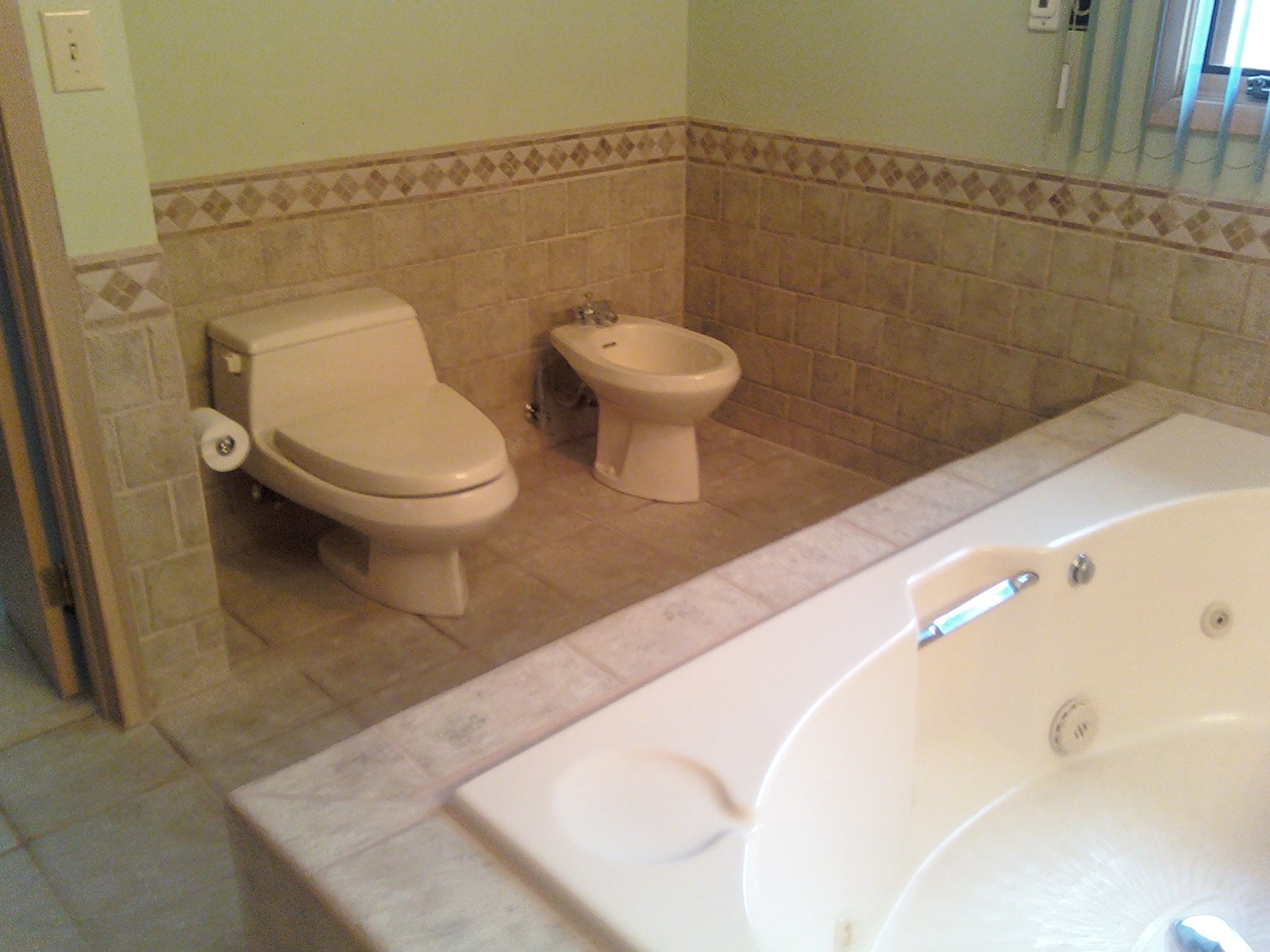

Master Bathroom

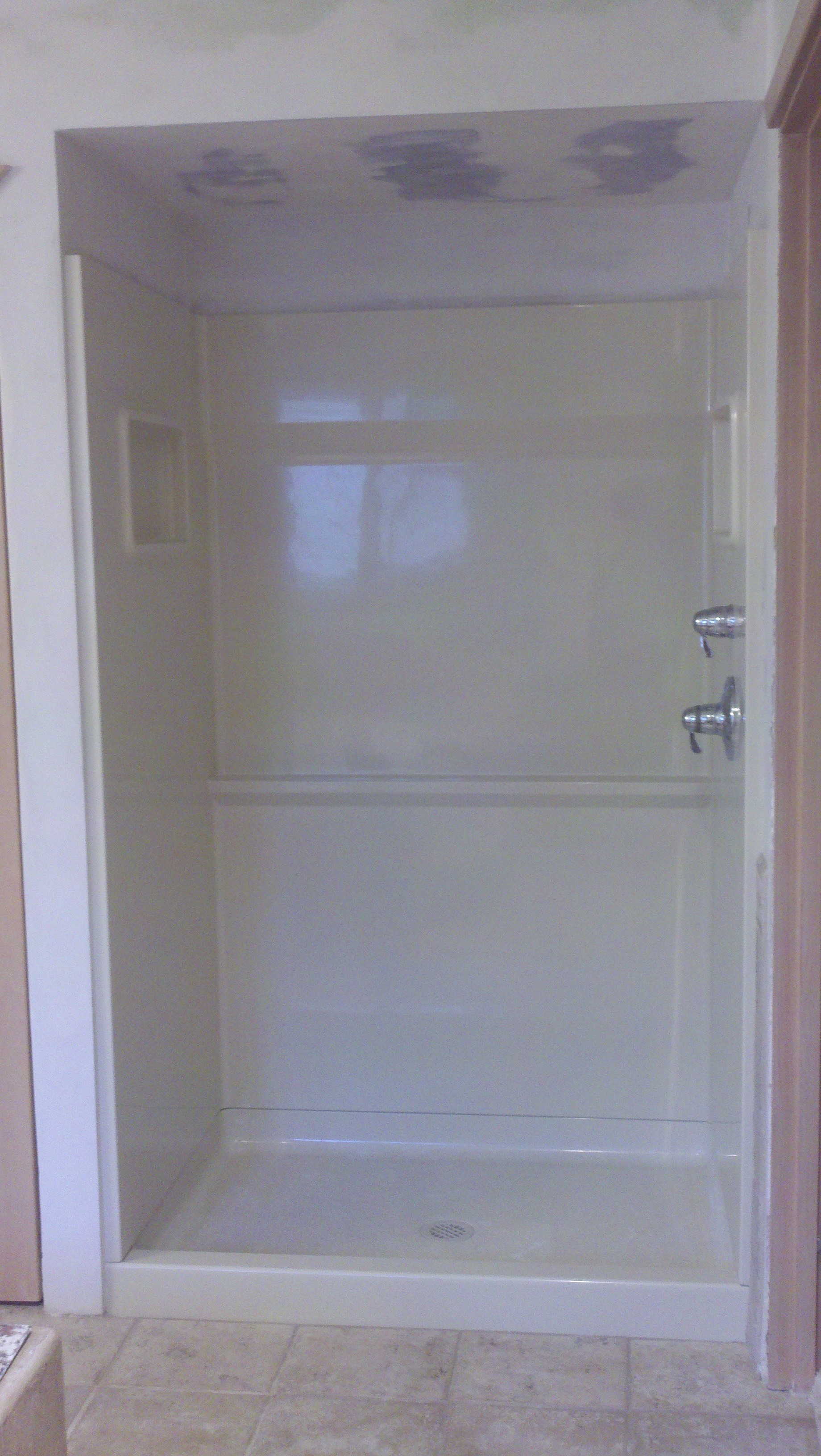

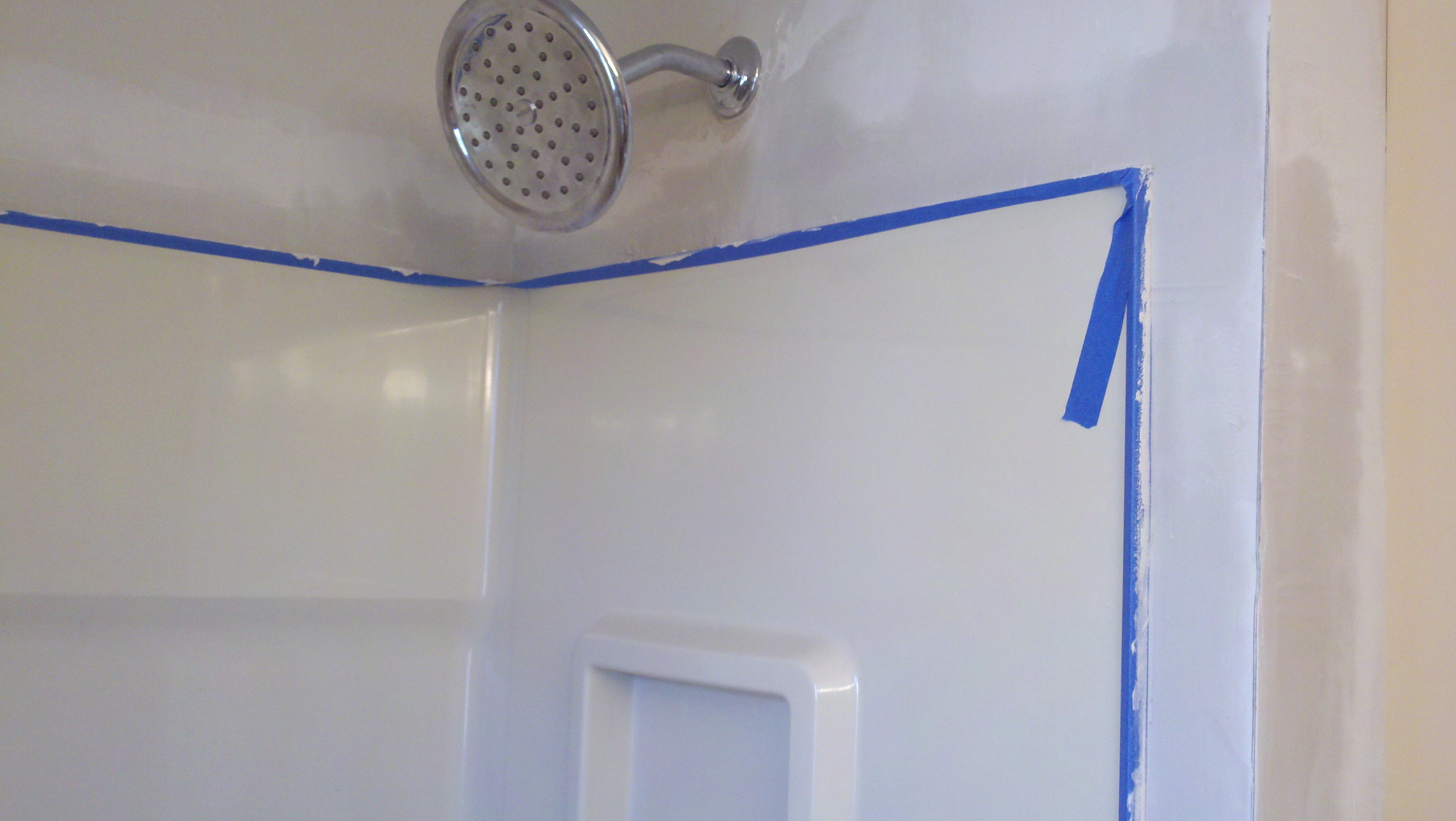

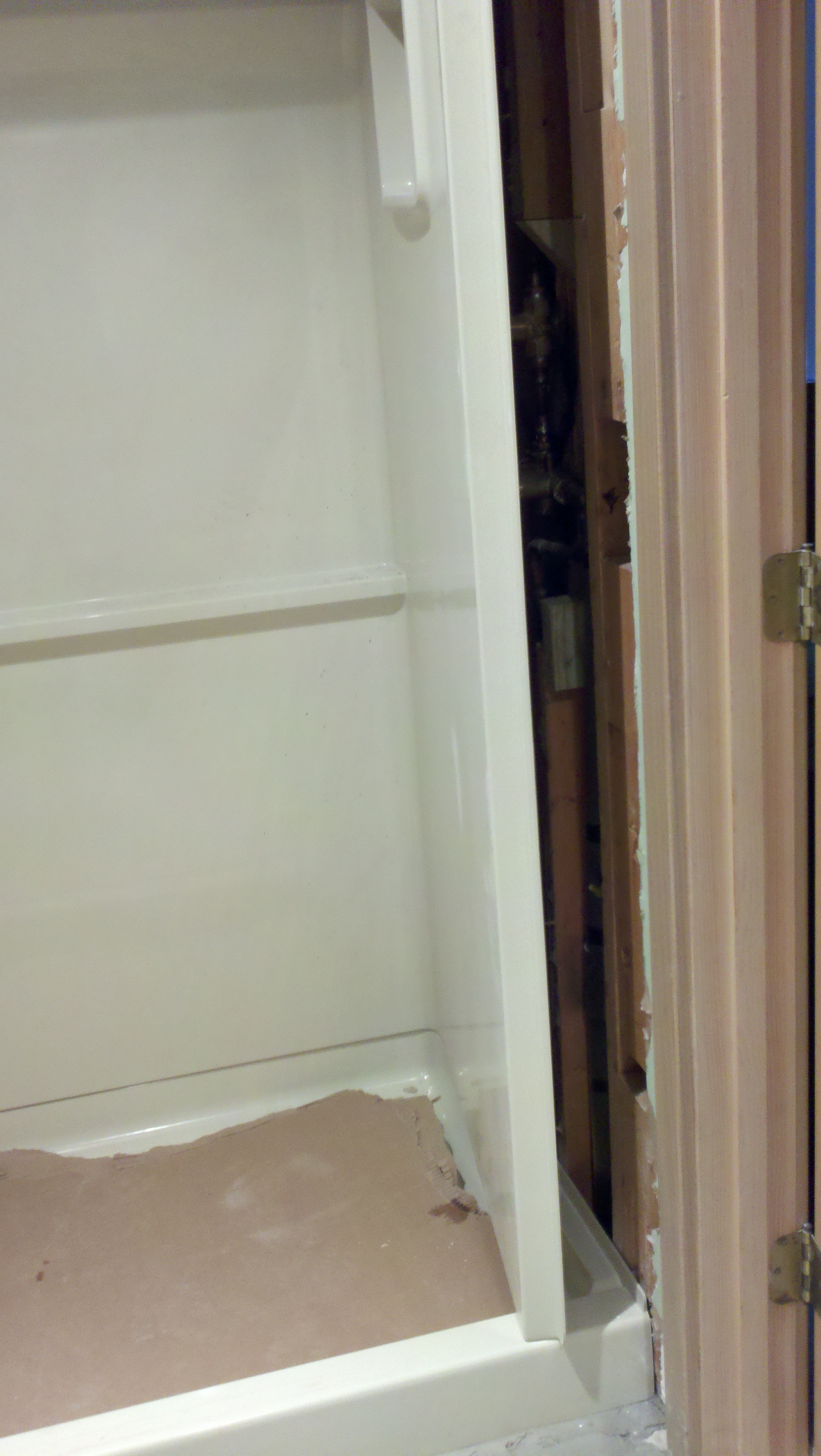

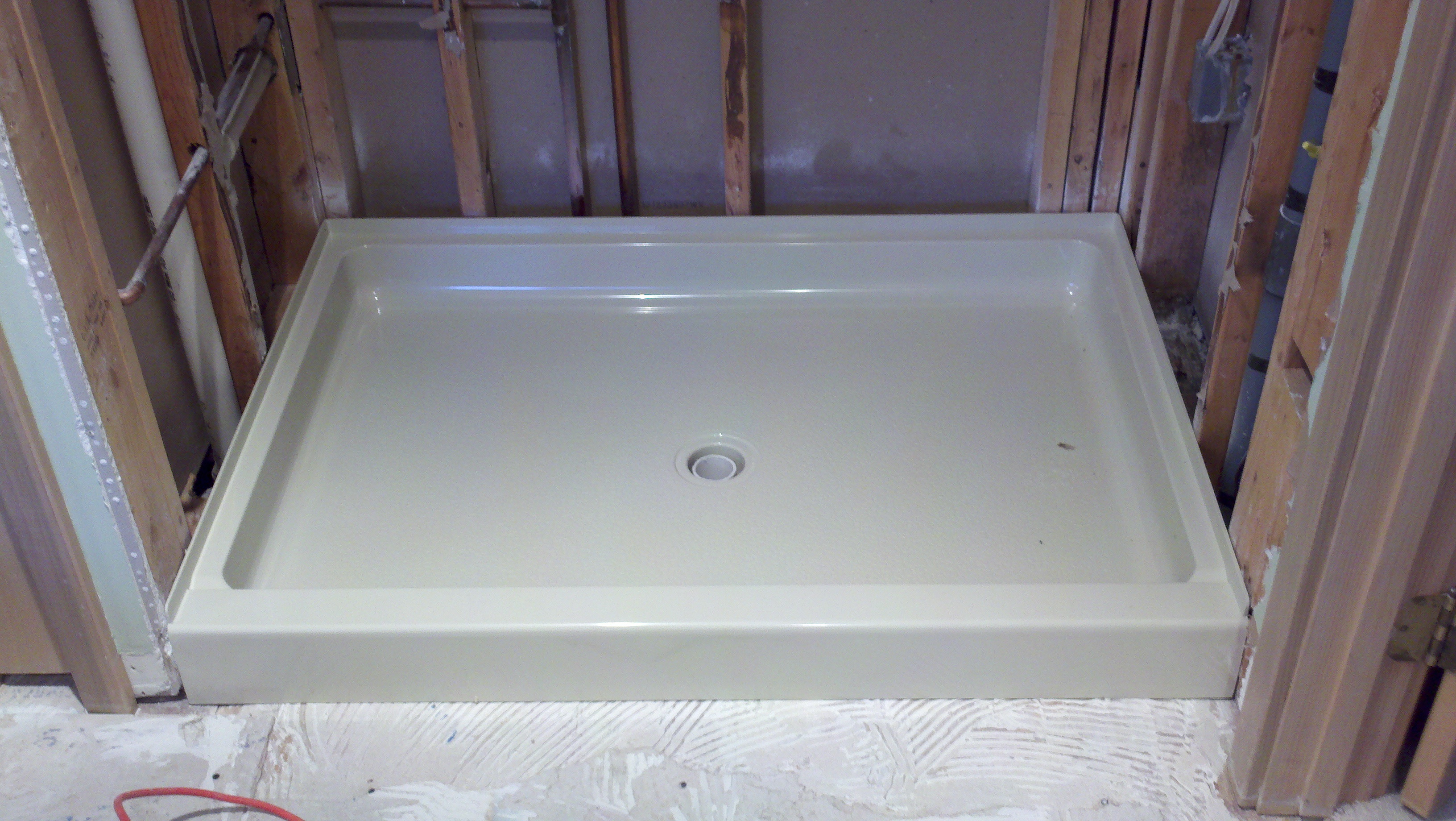

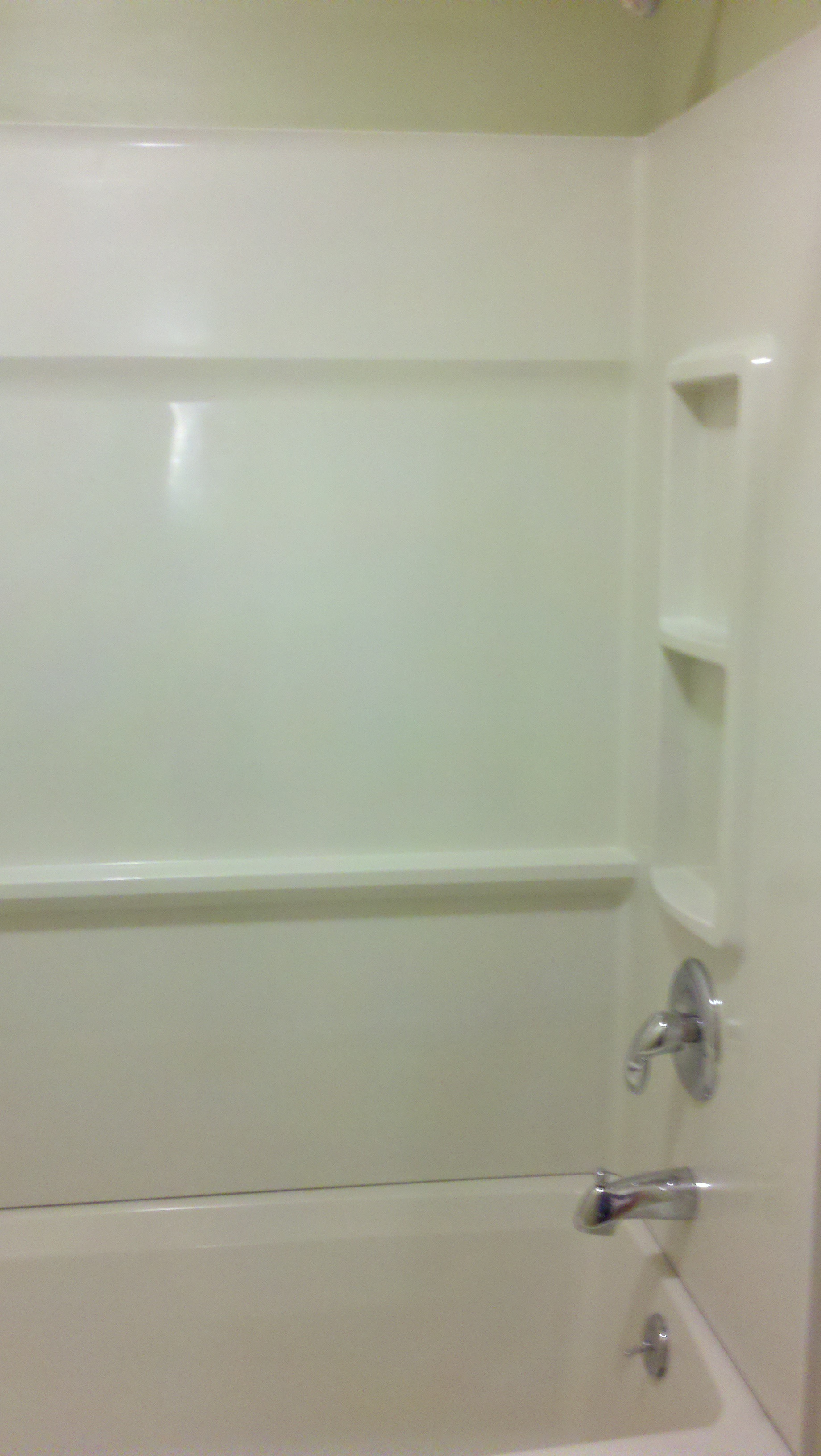

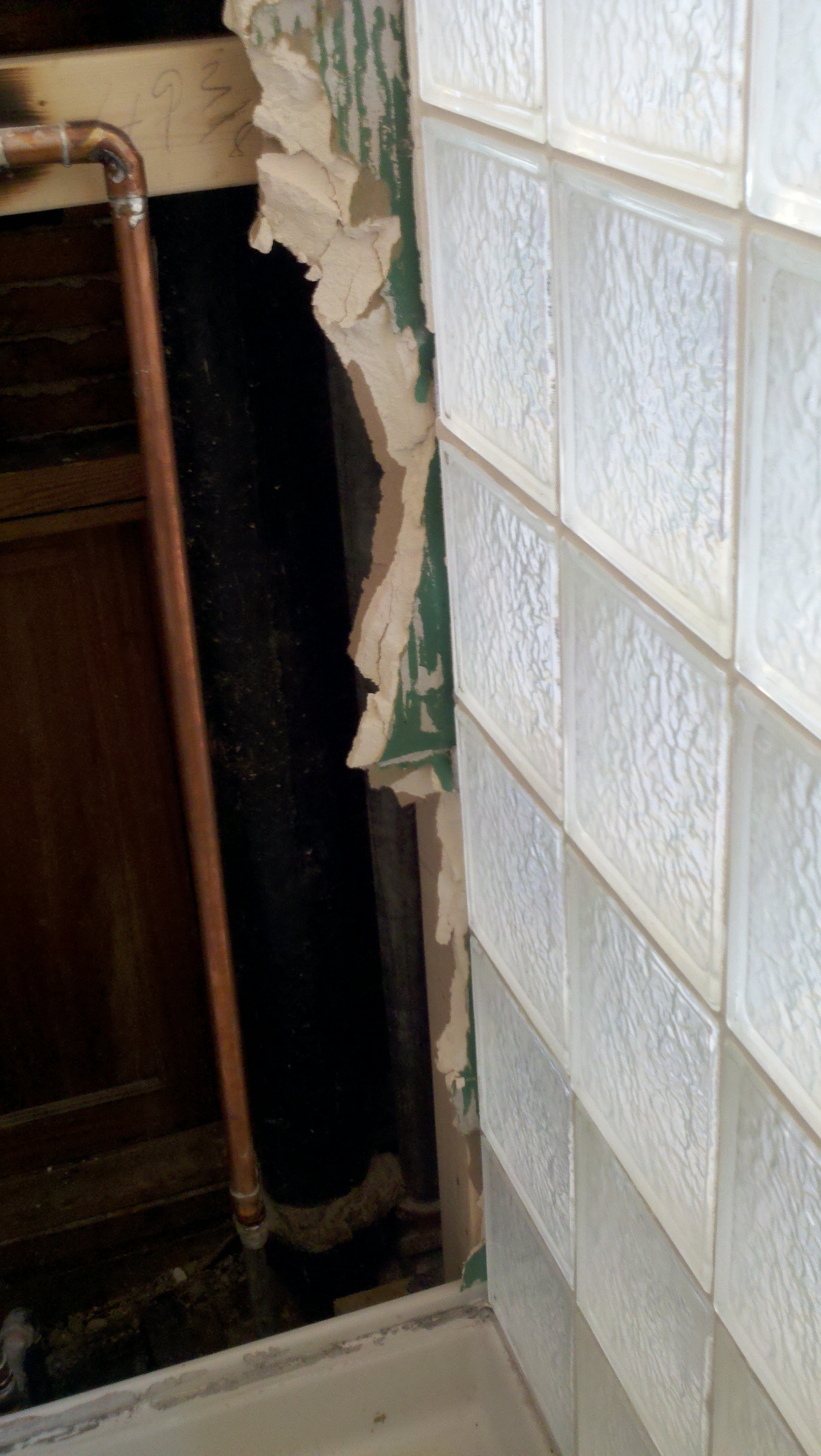

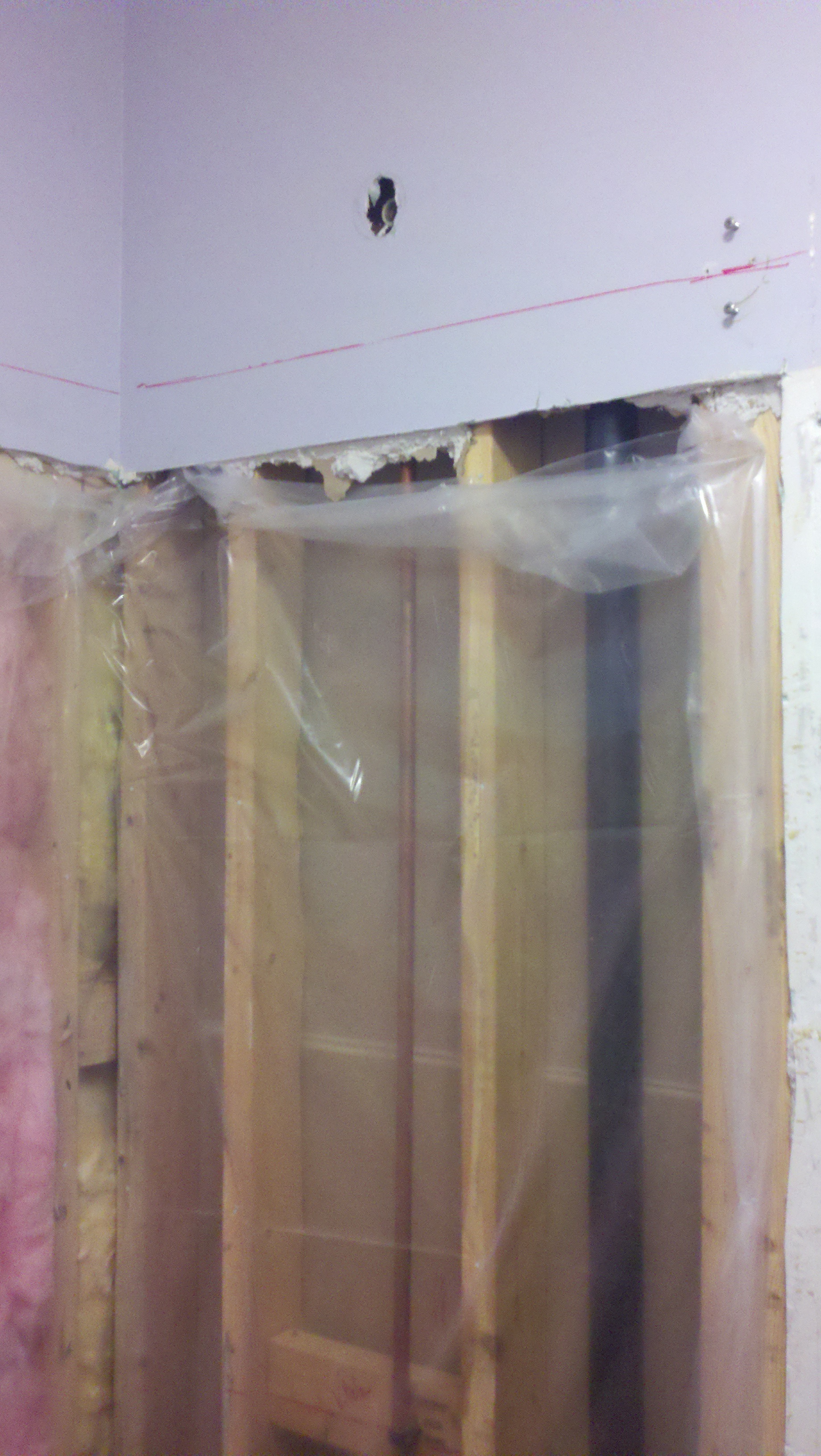

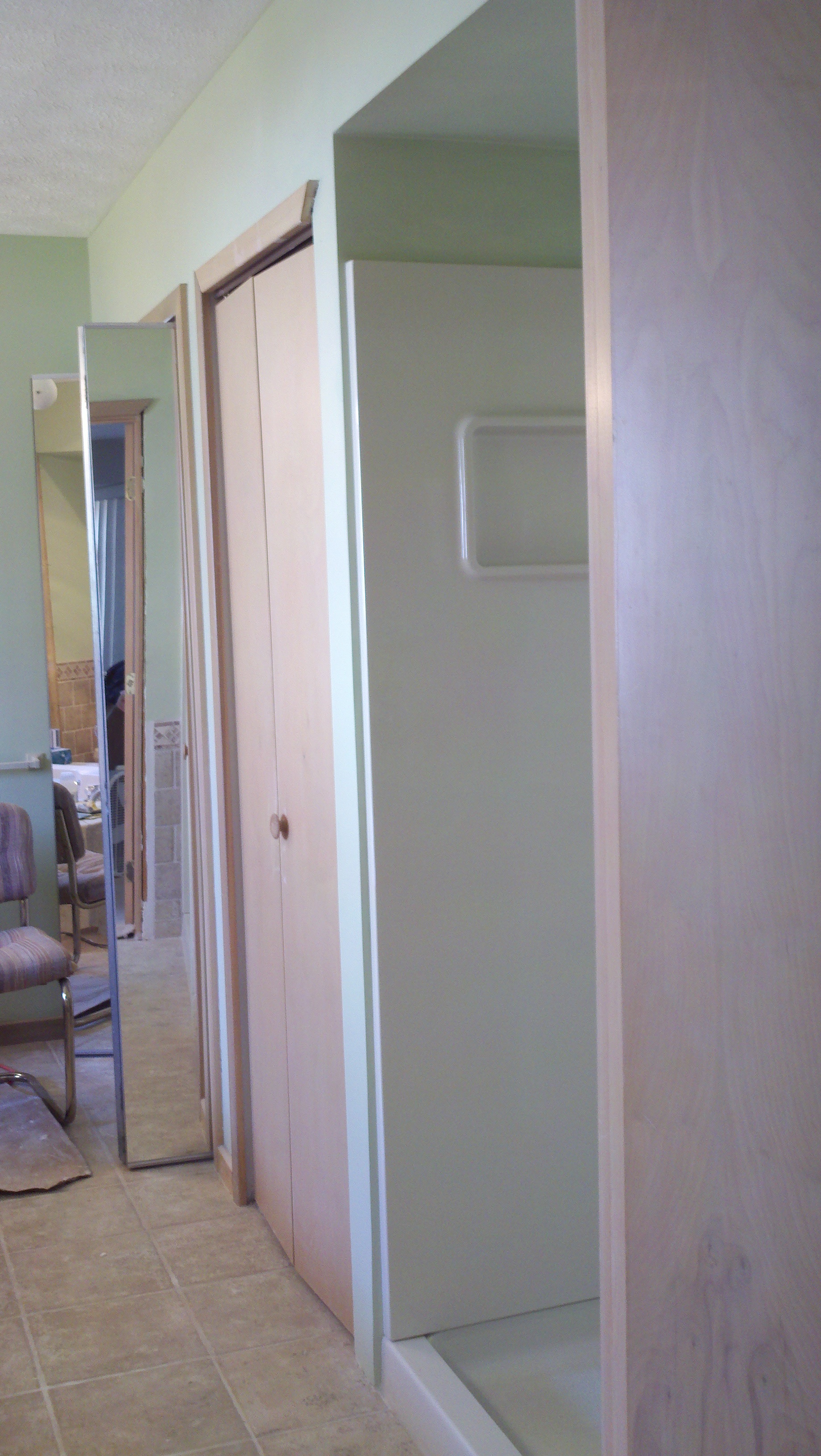

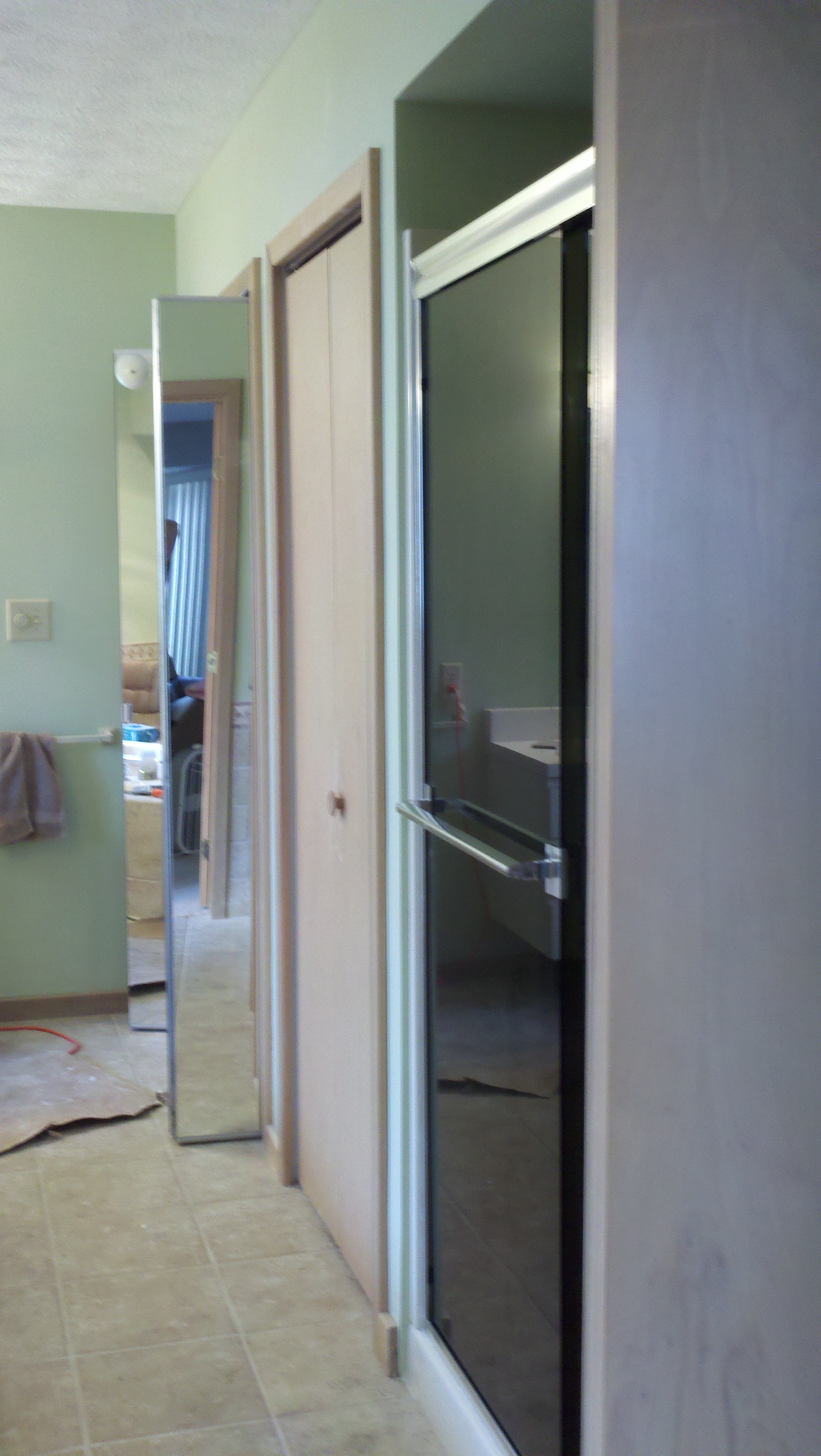

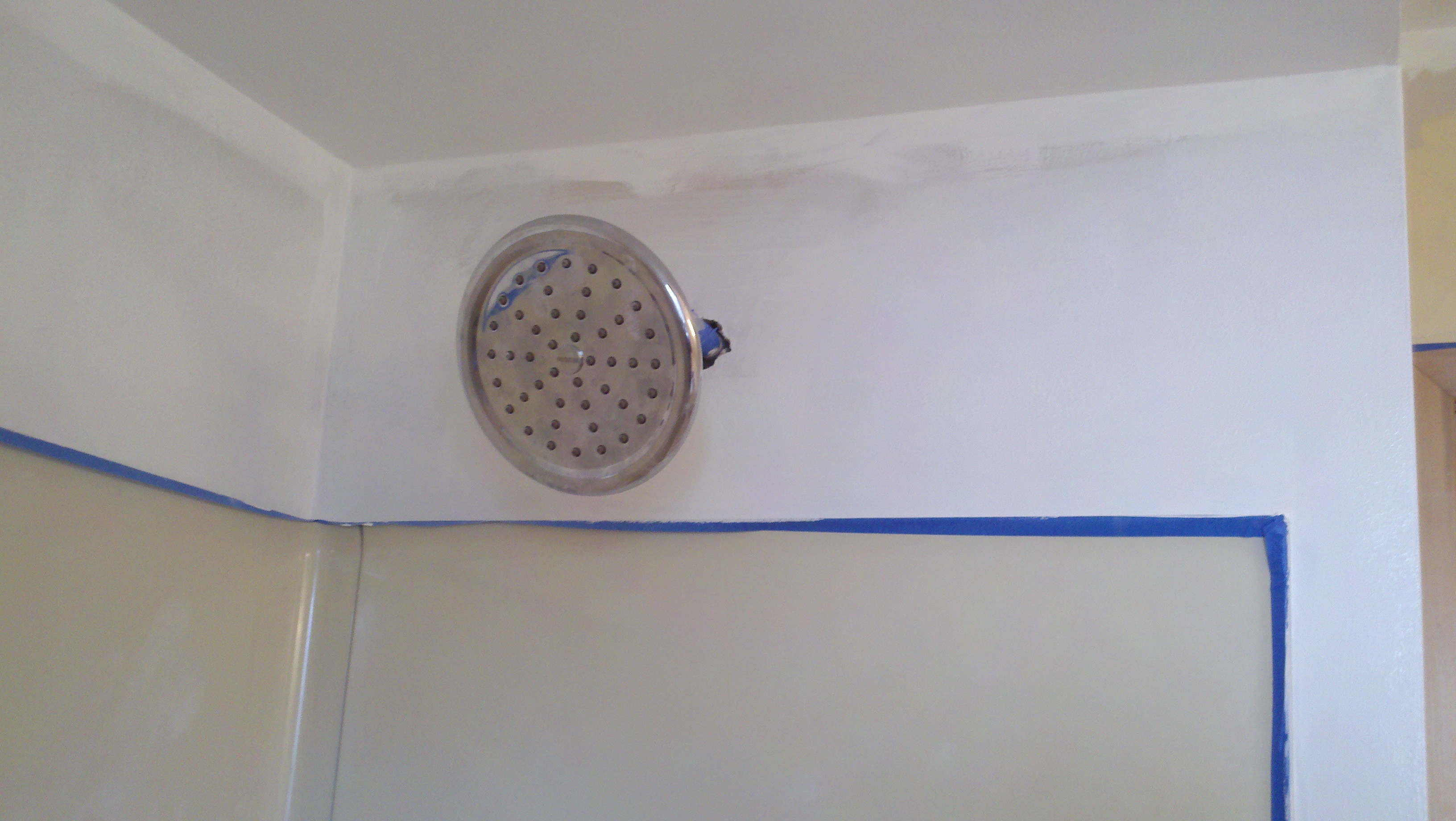

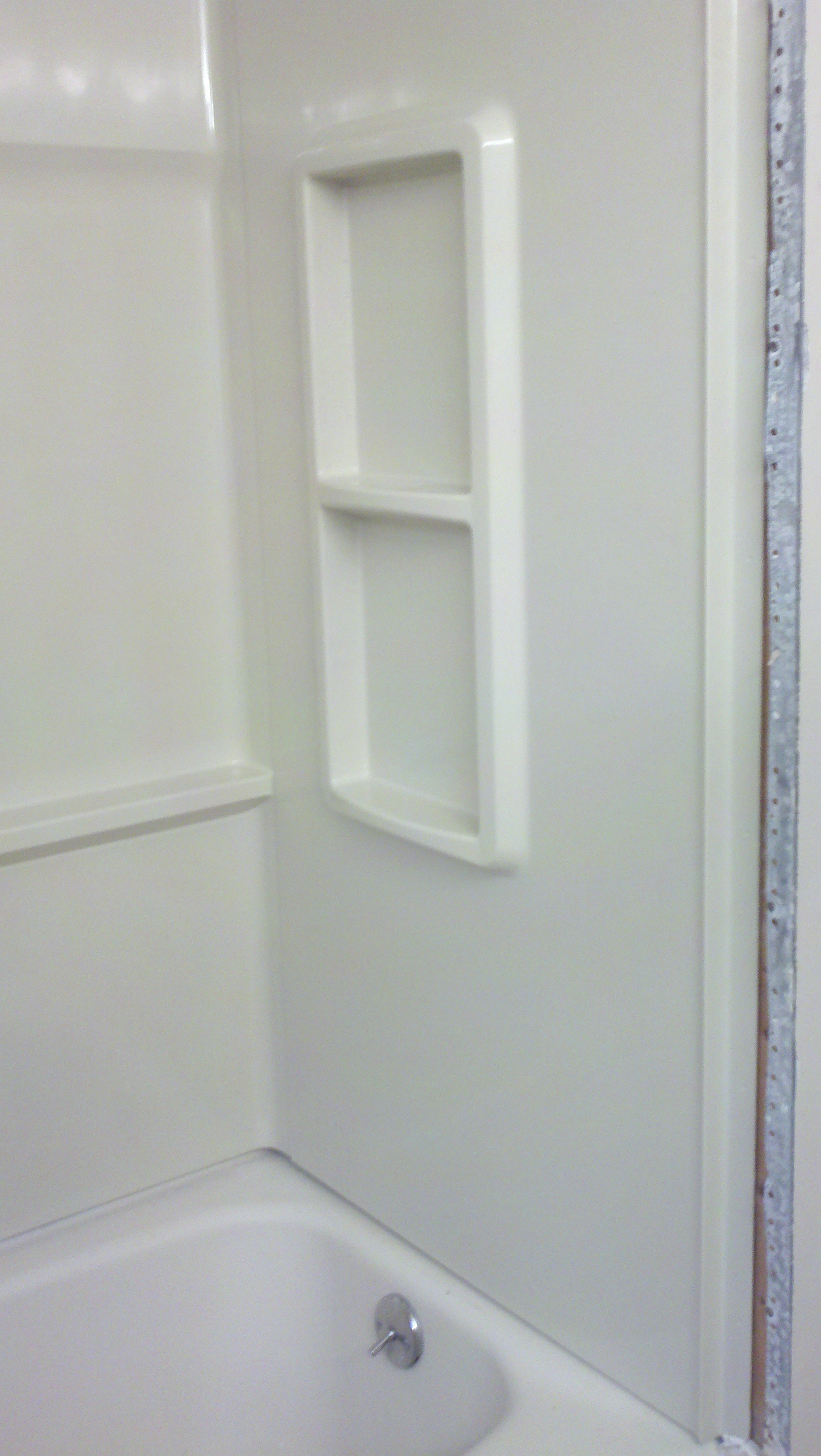

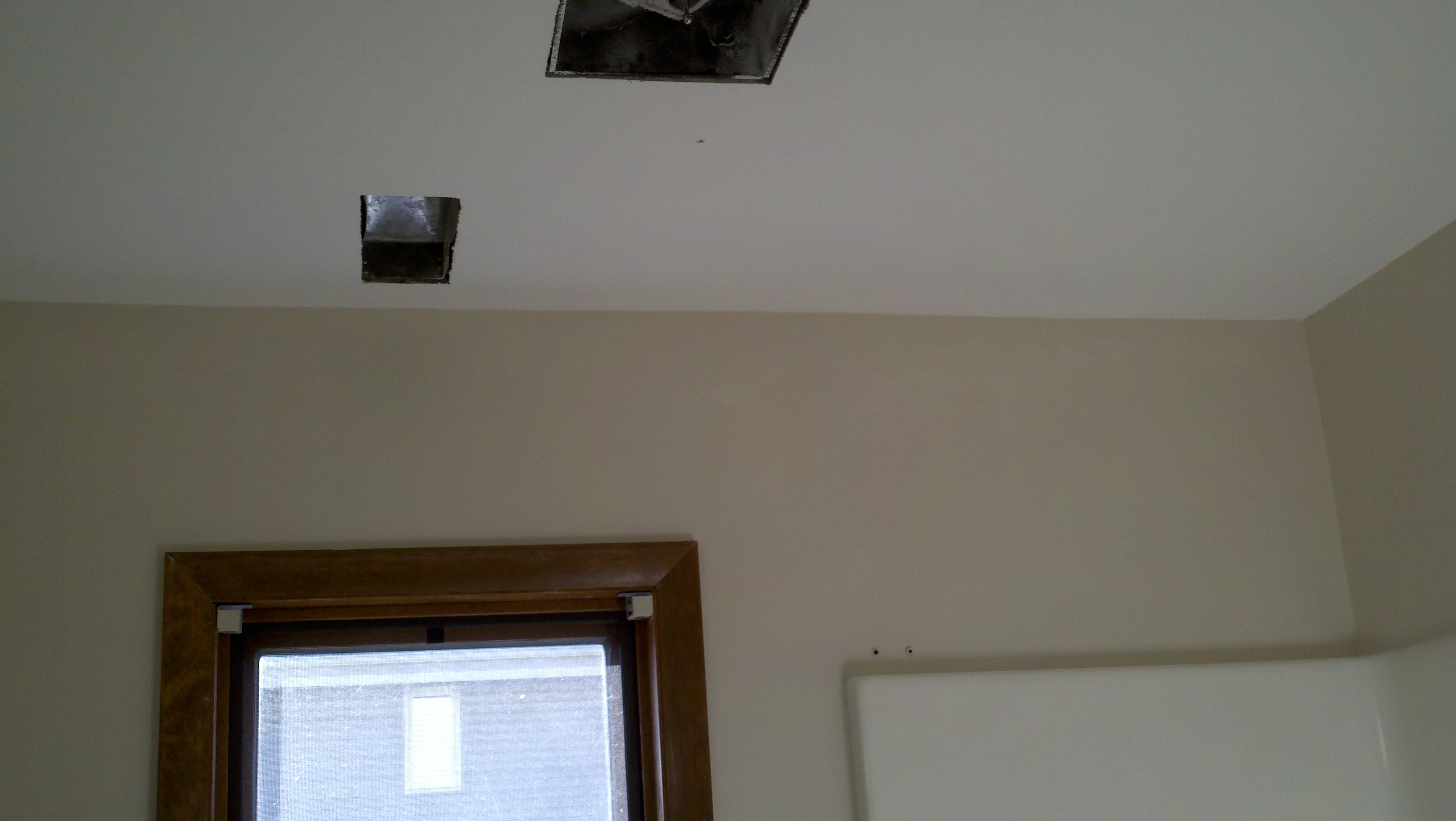

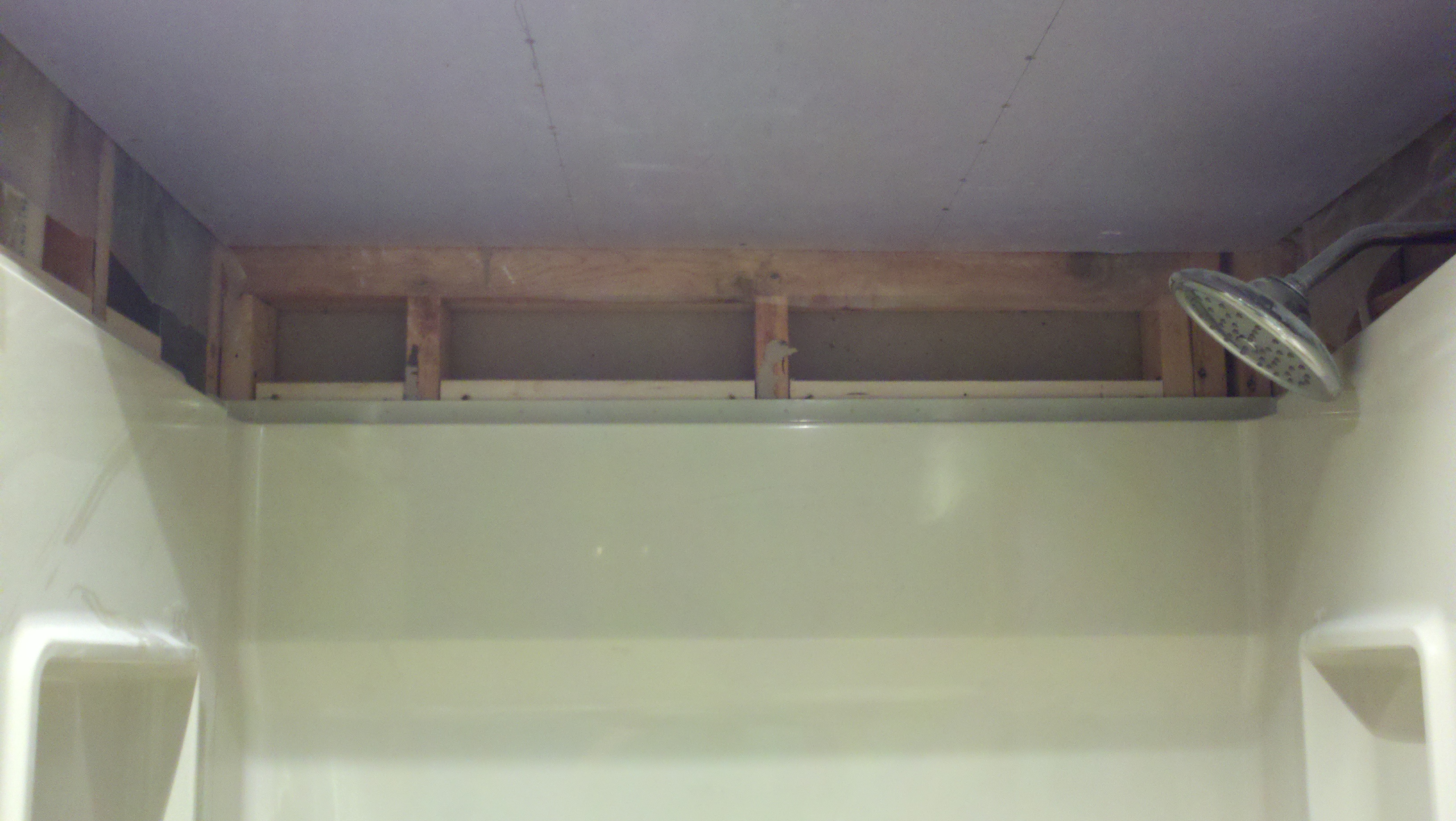

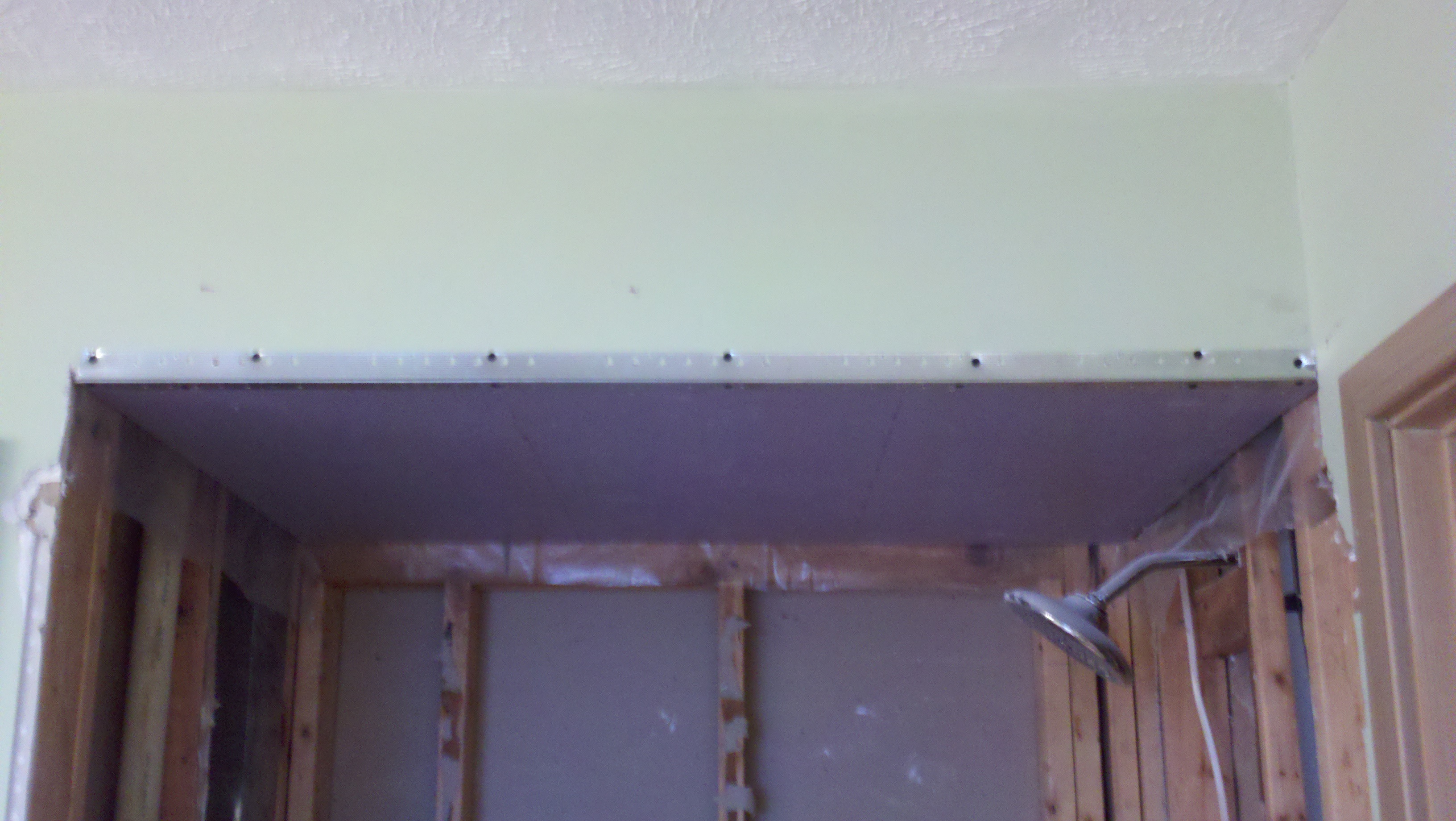

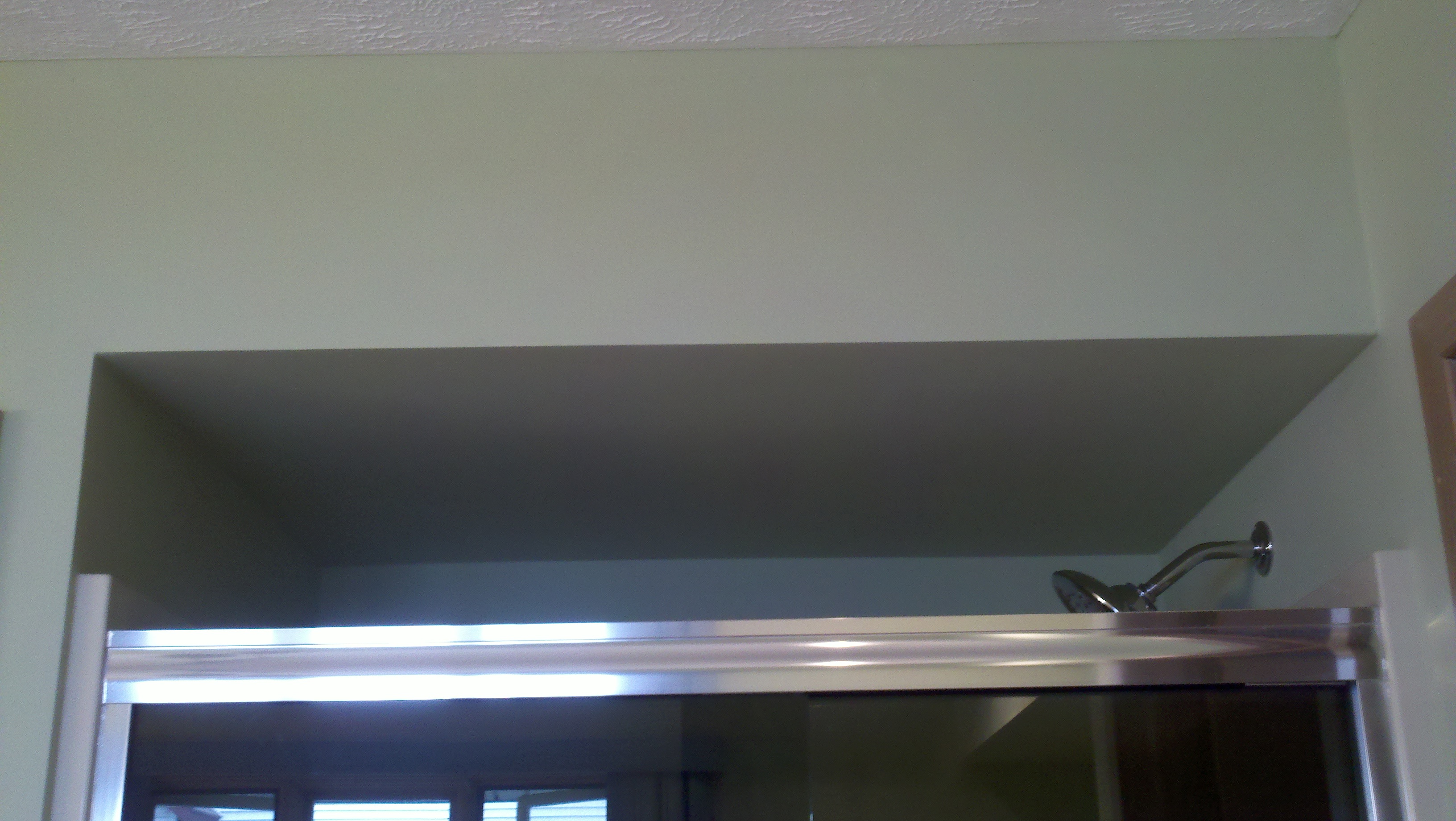

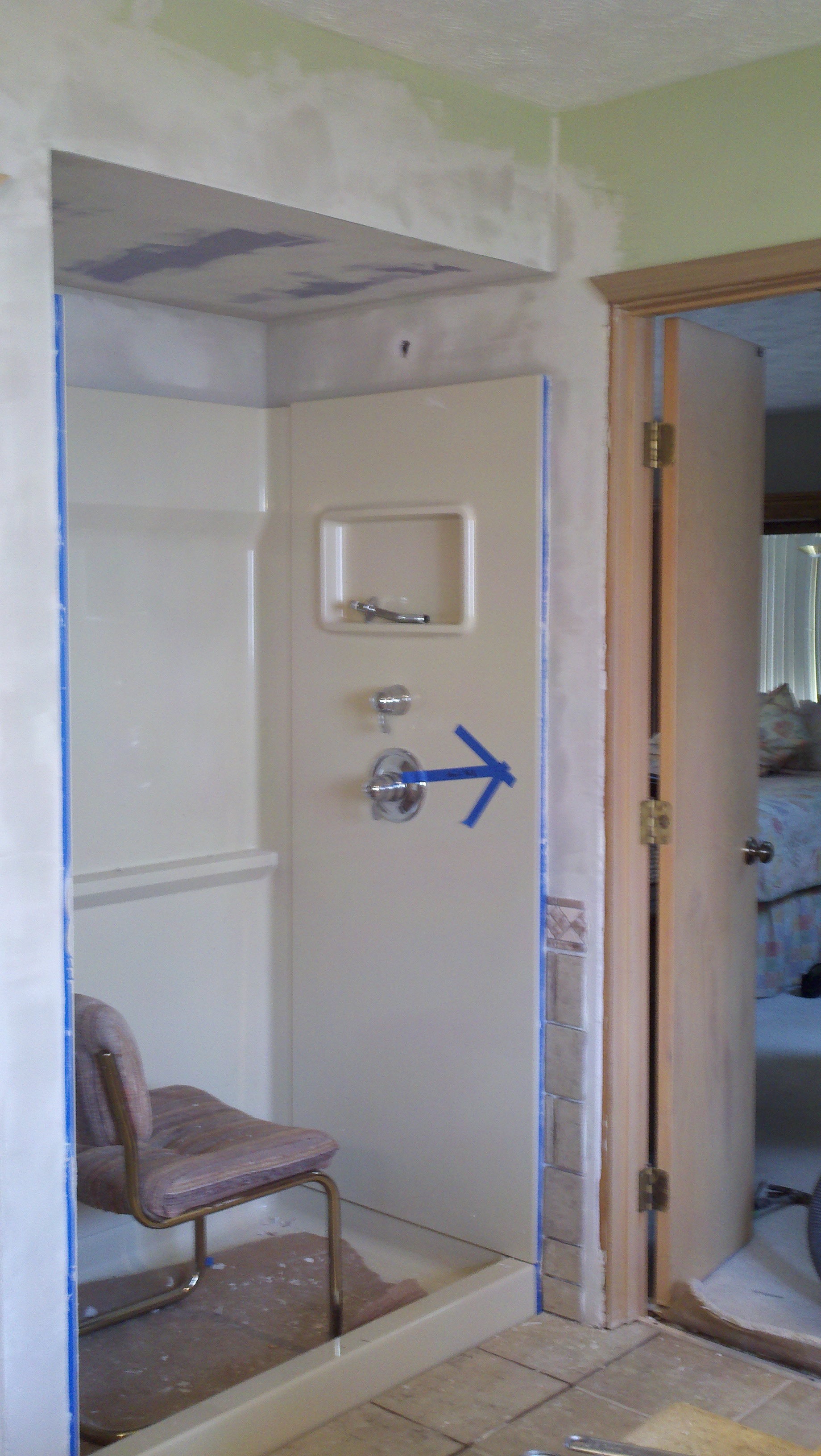

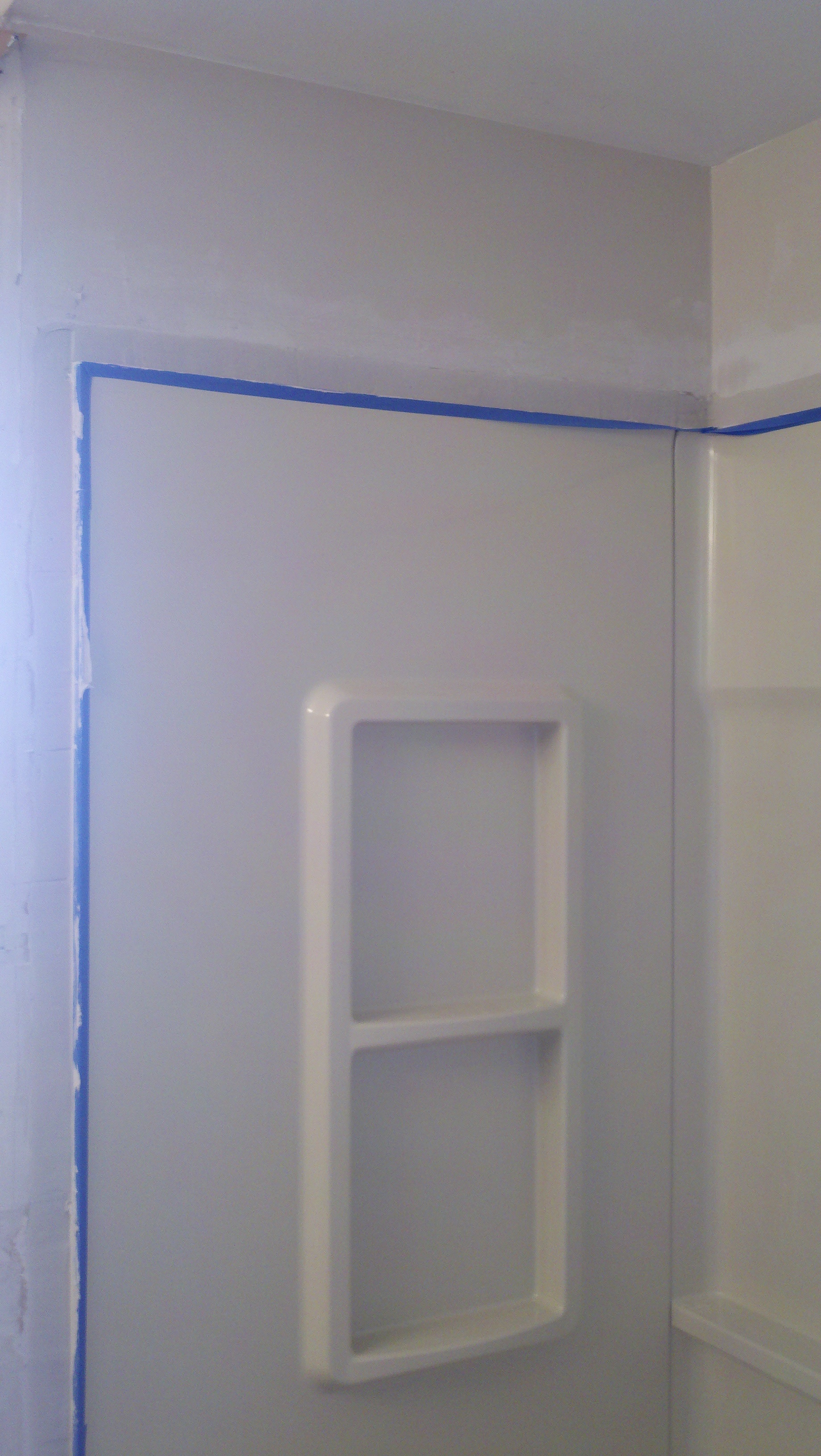

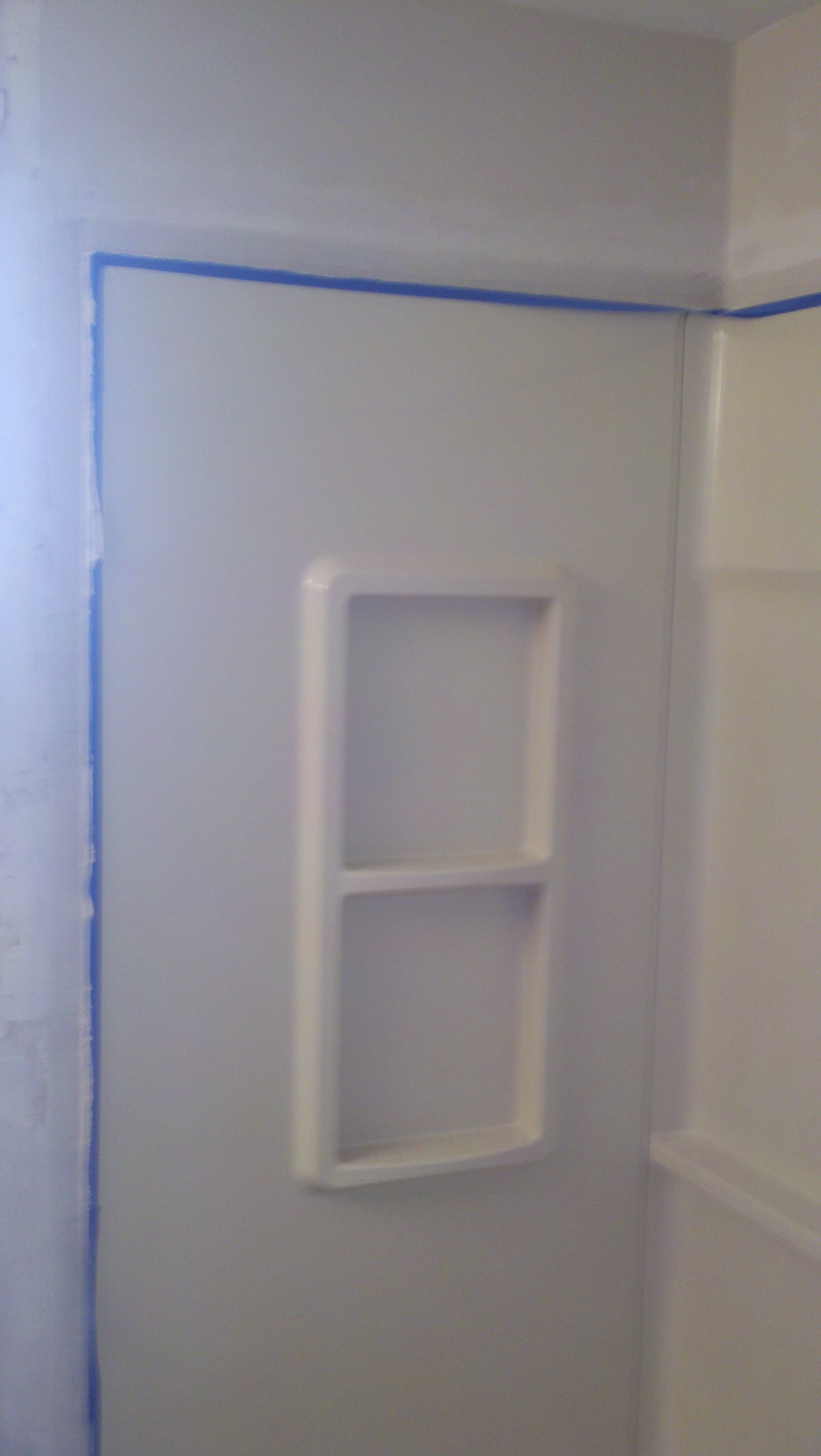

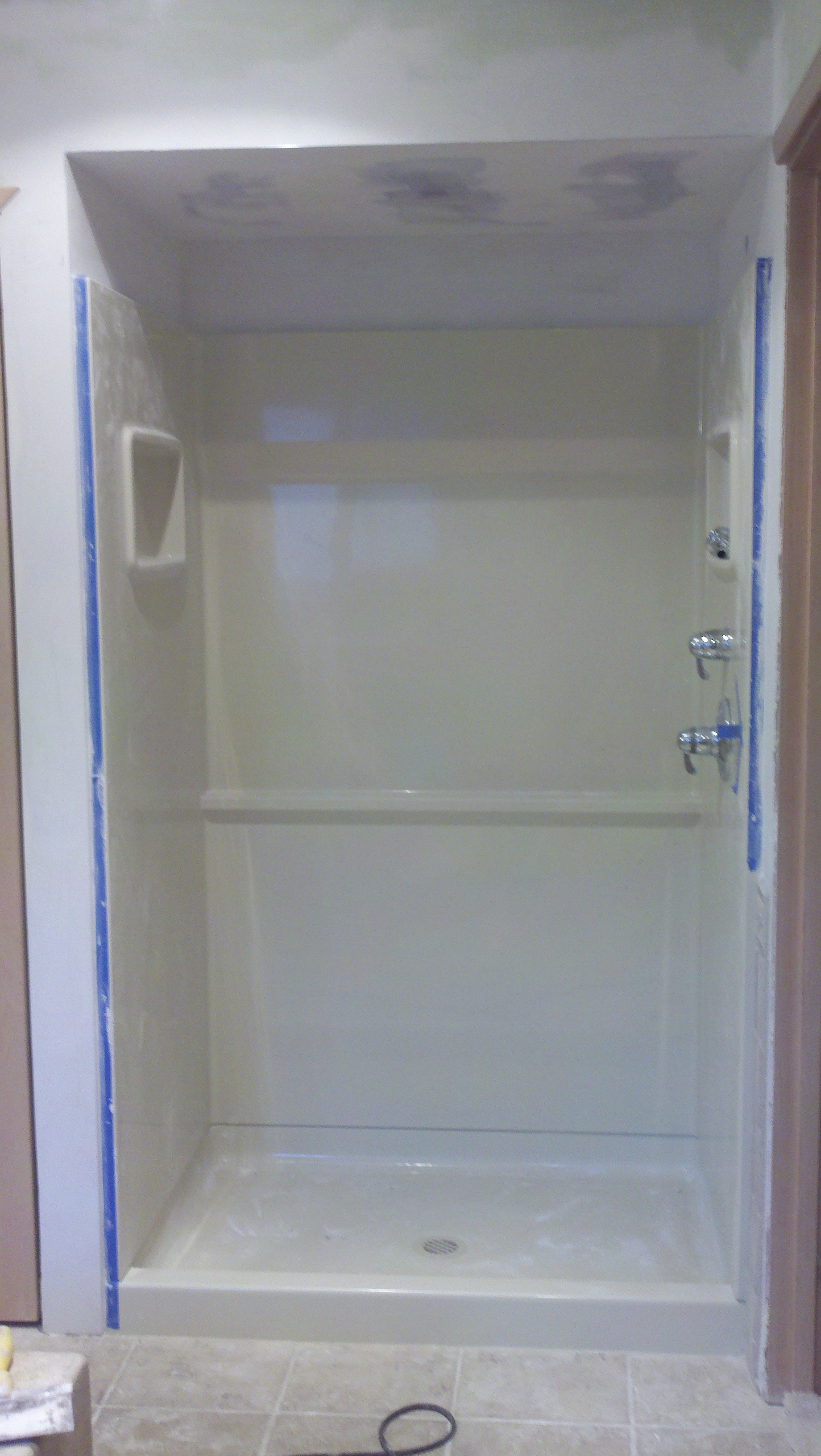

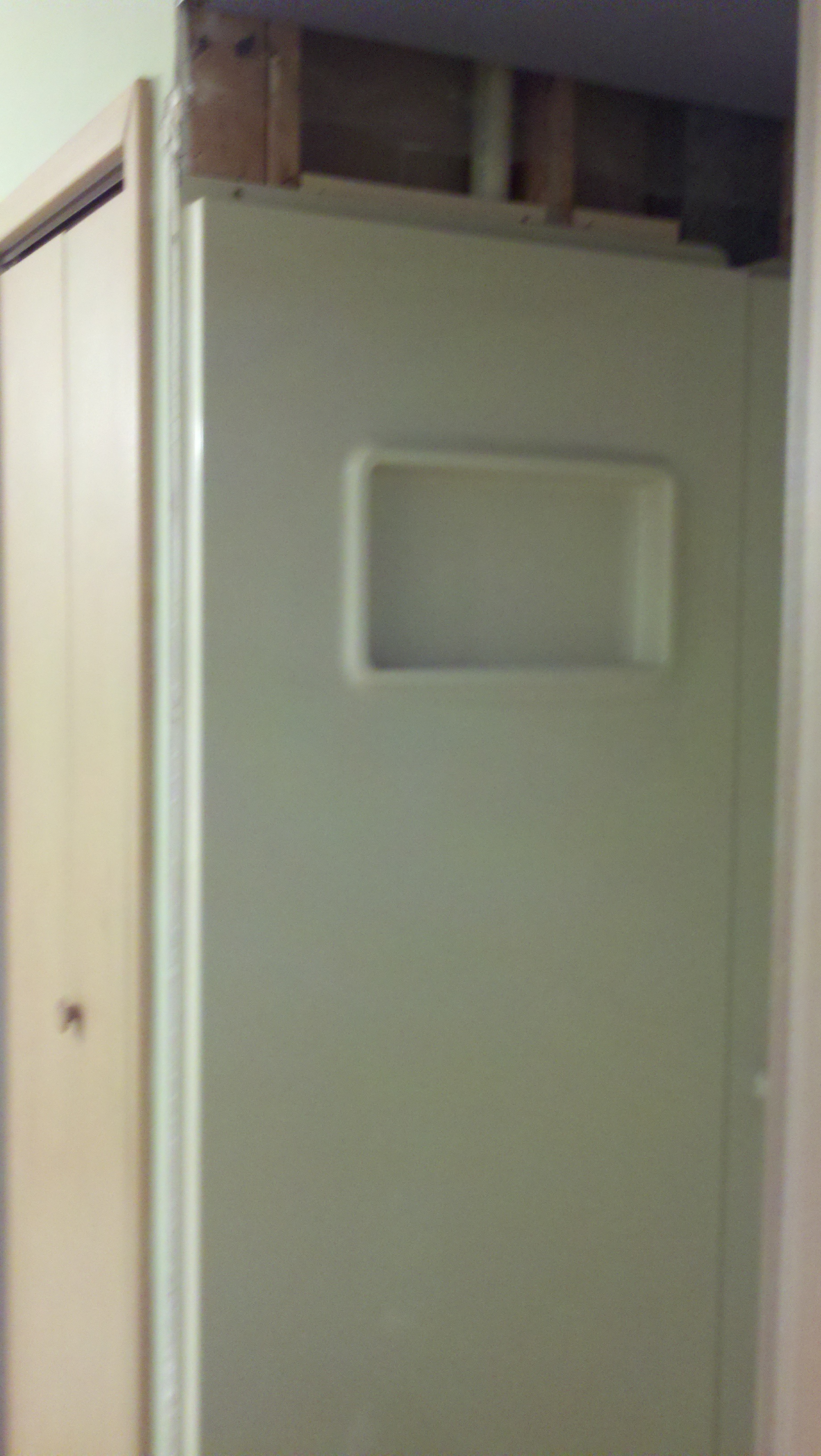

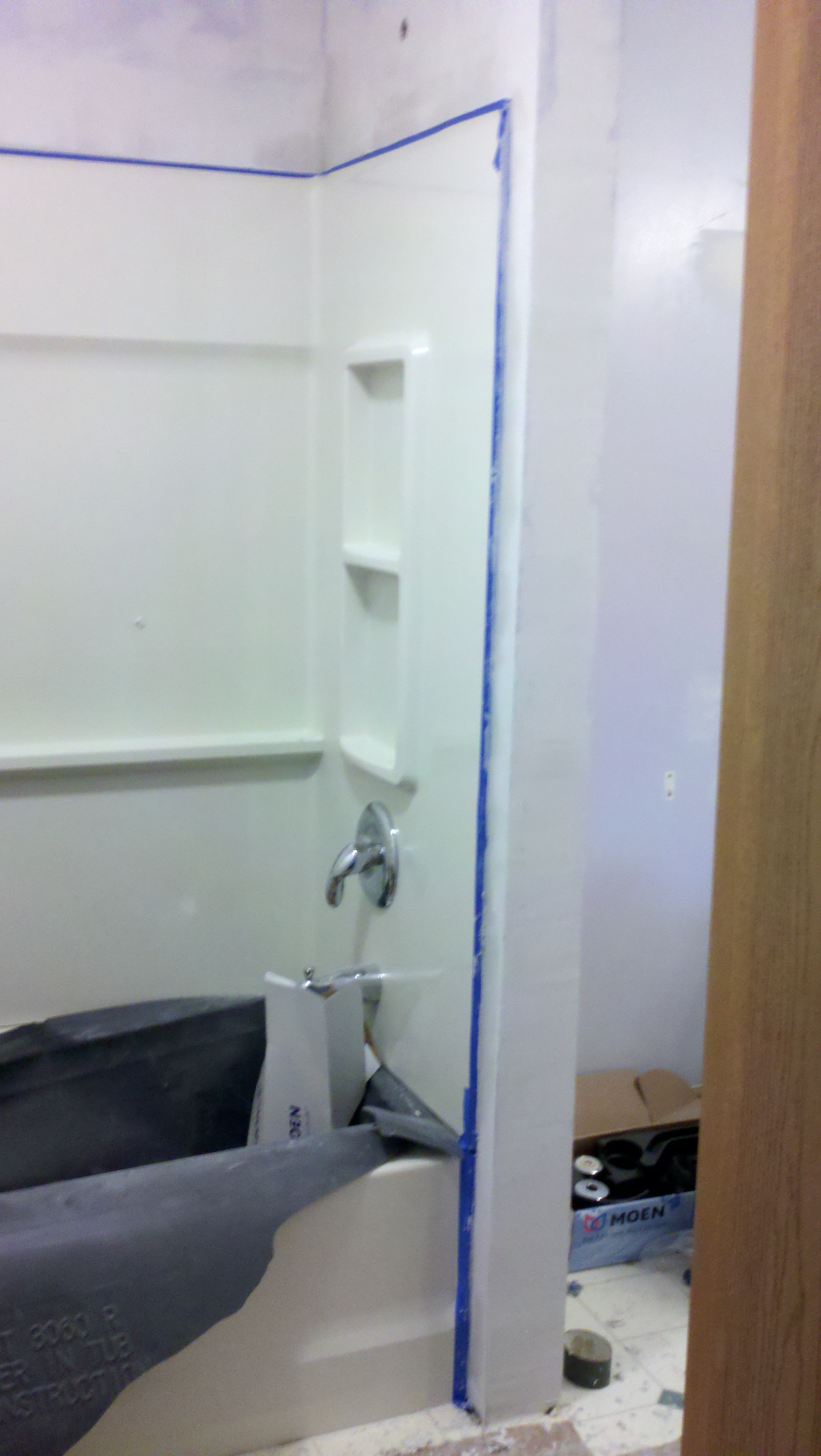

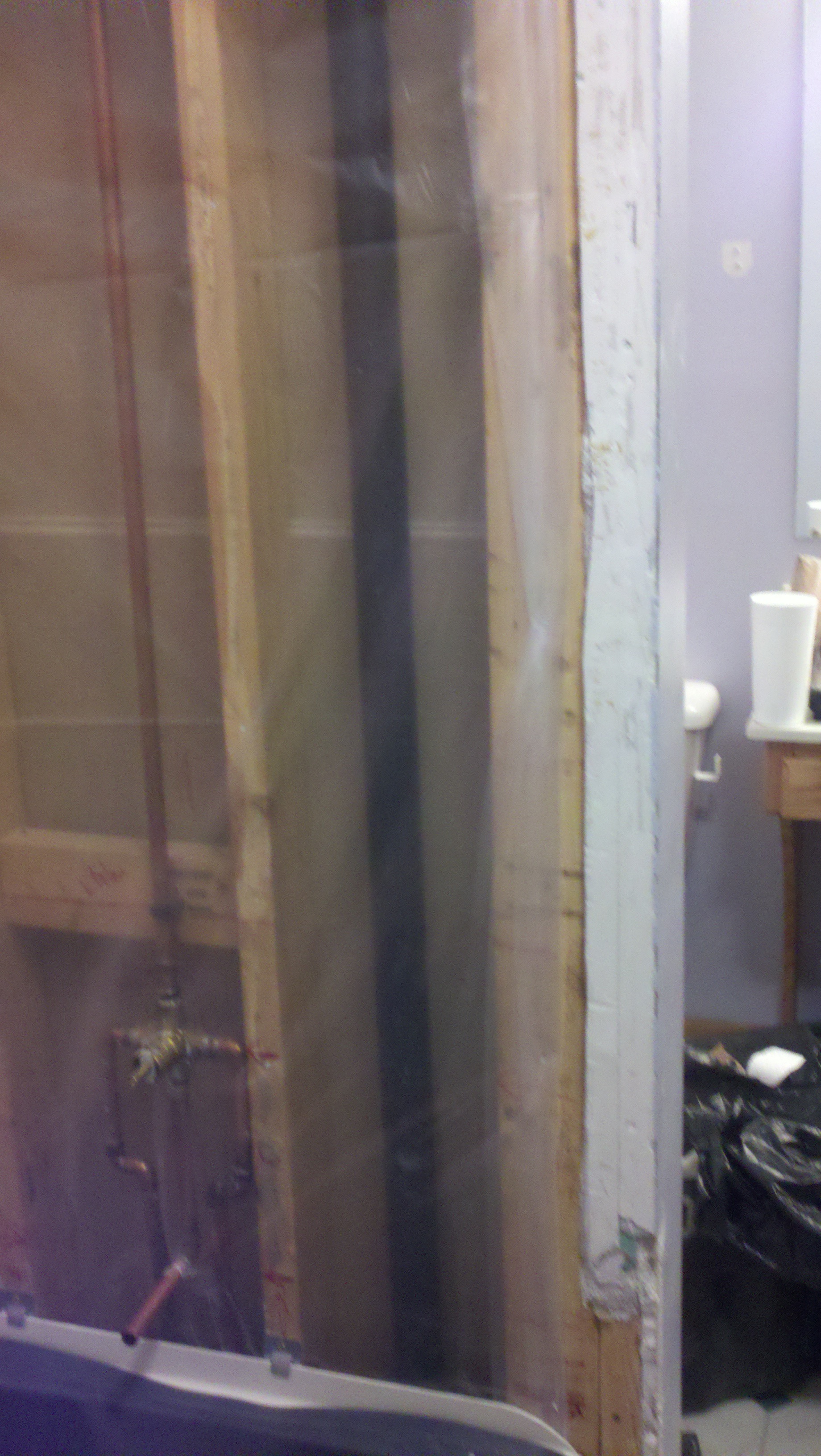

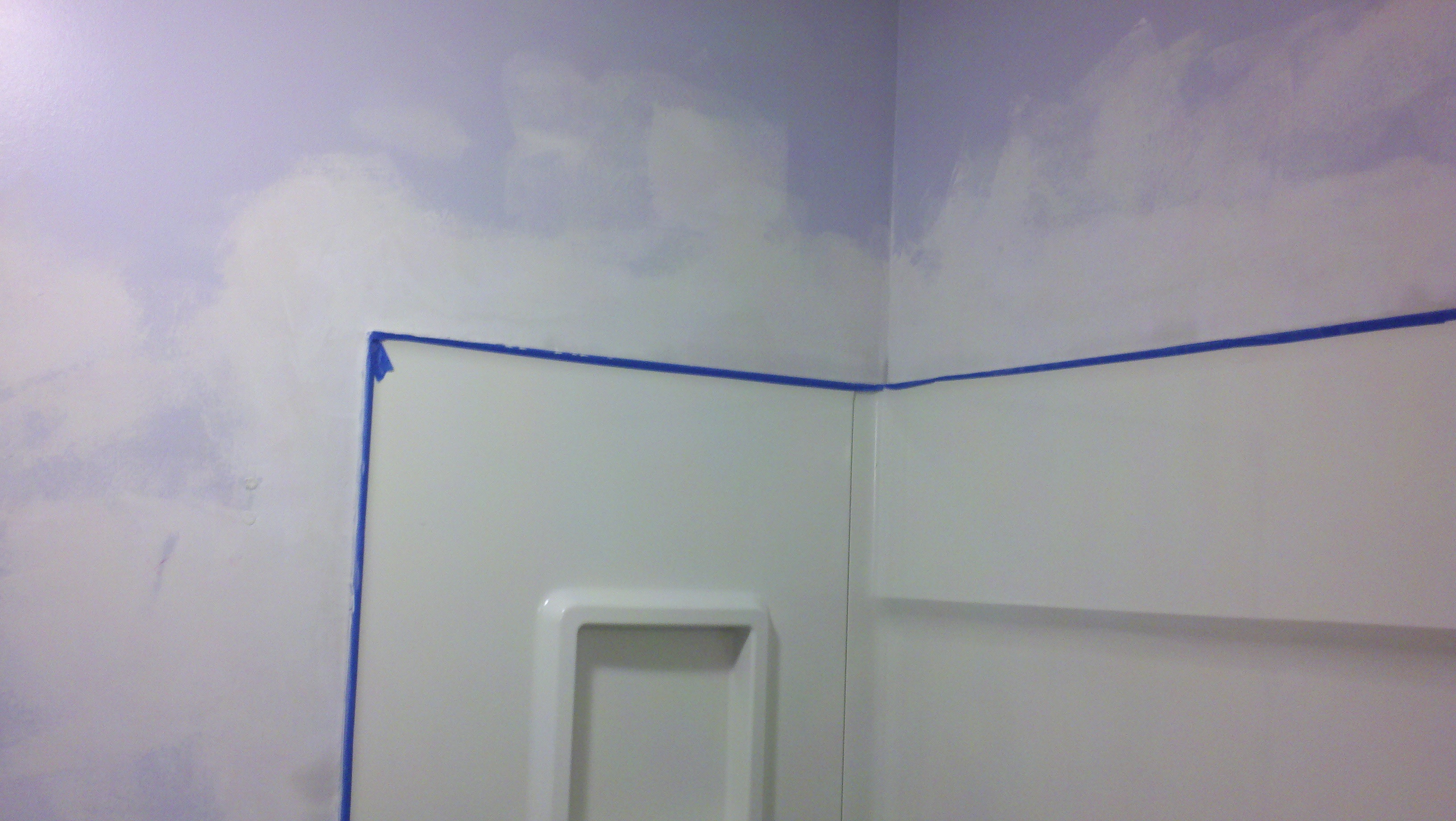

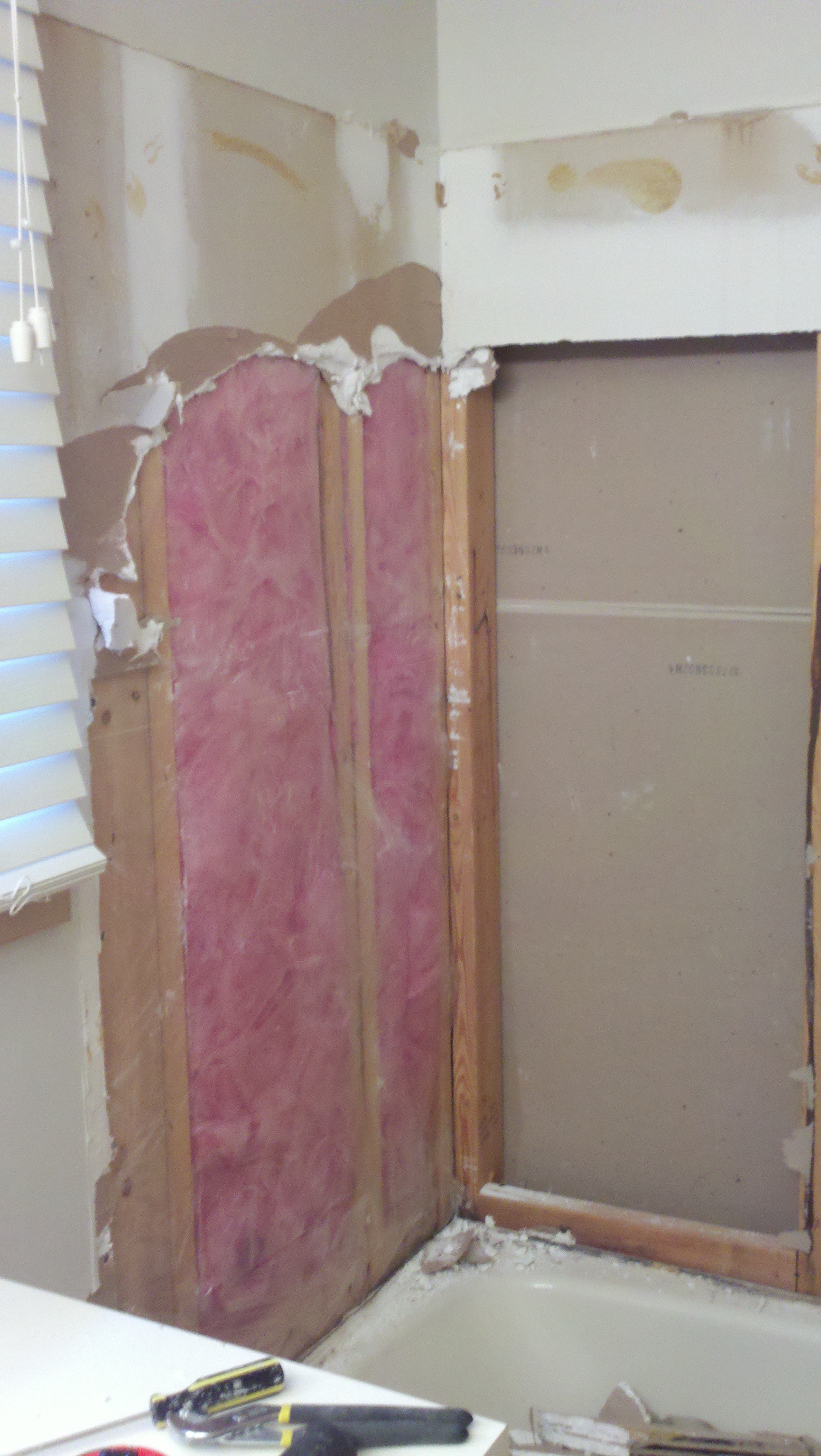

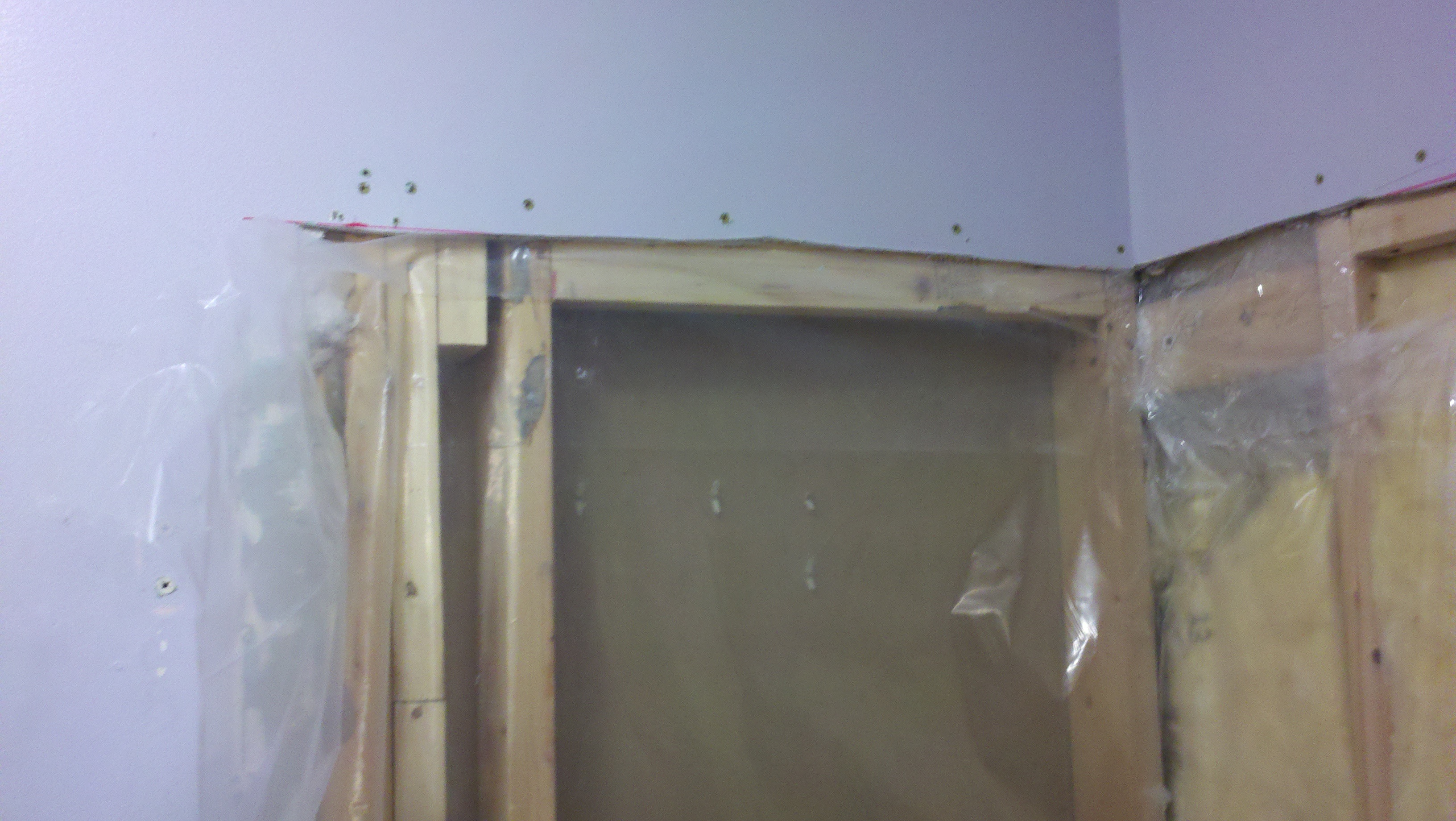

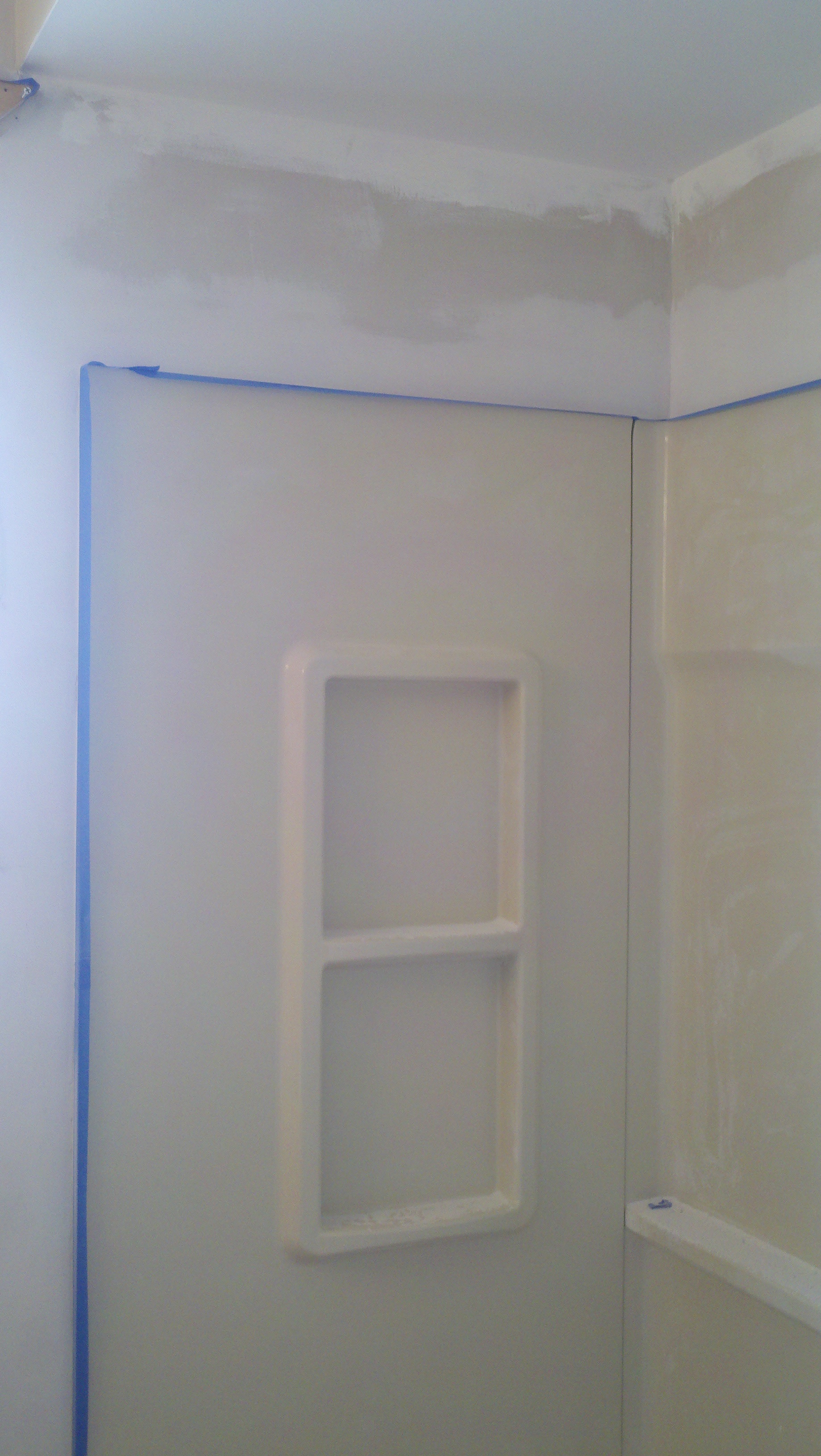

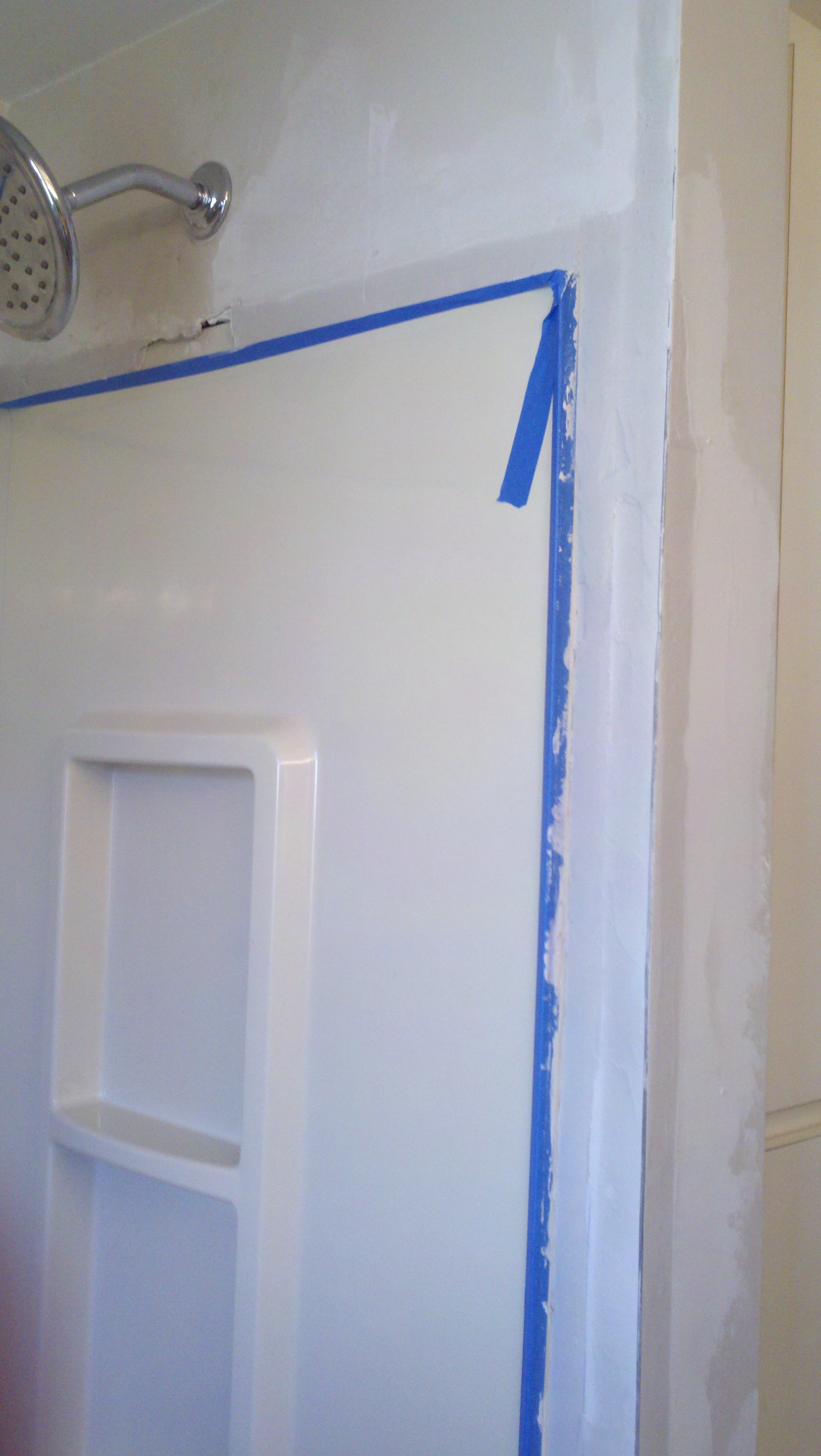

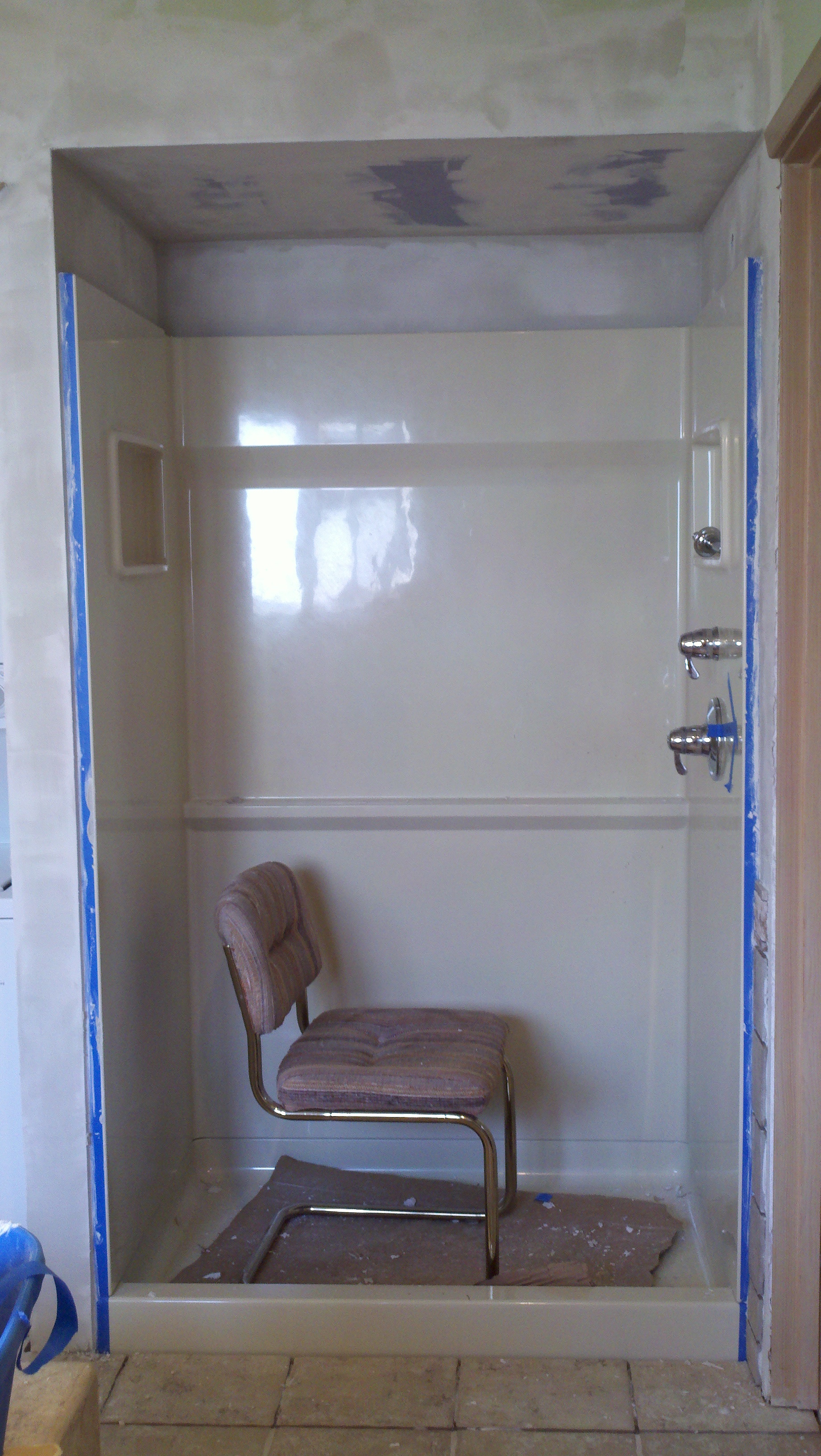

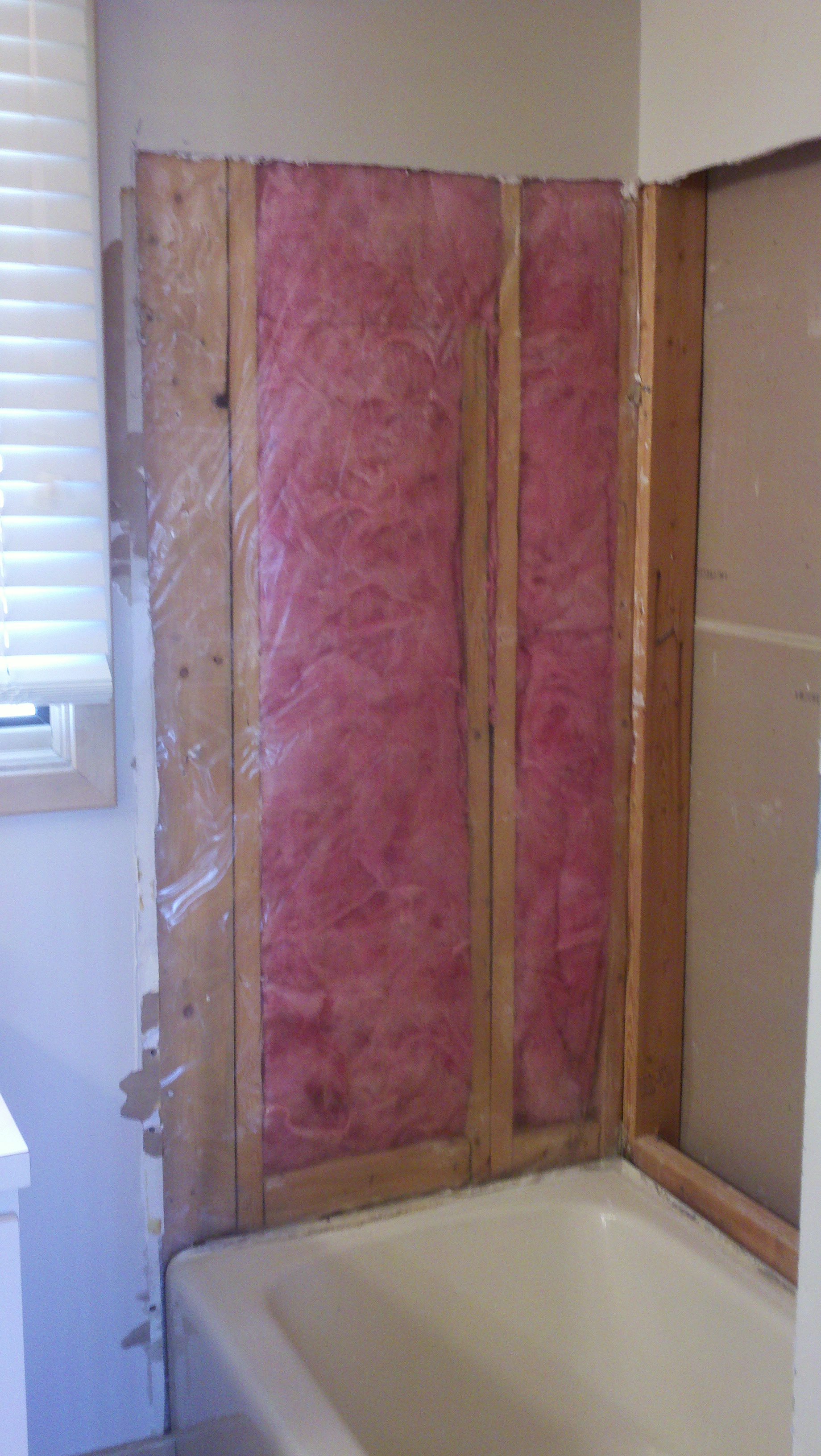

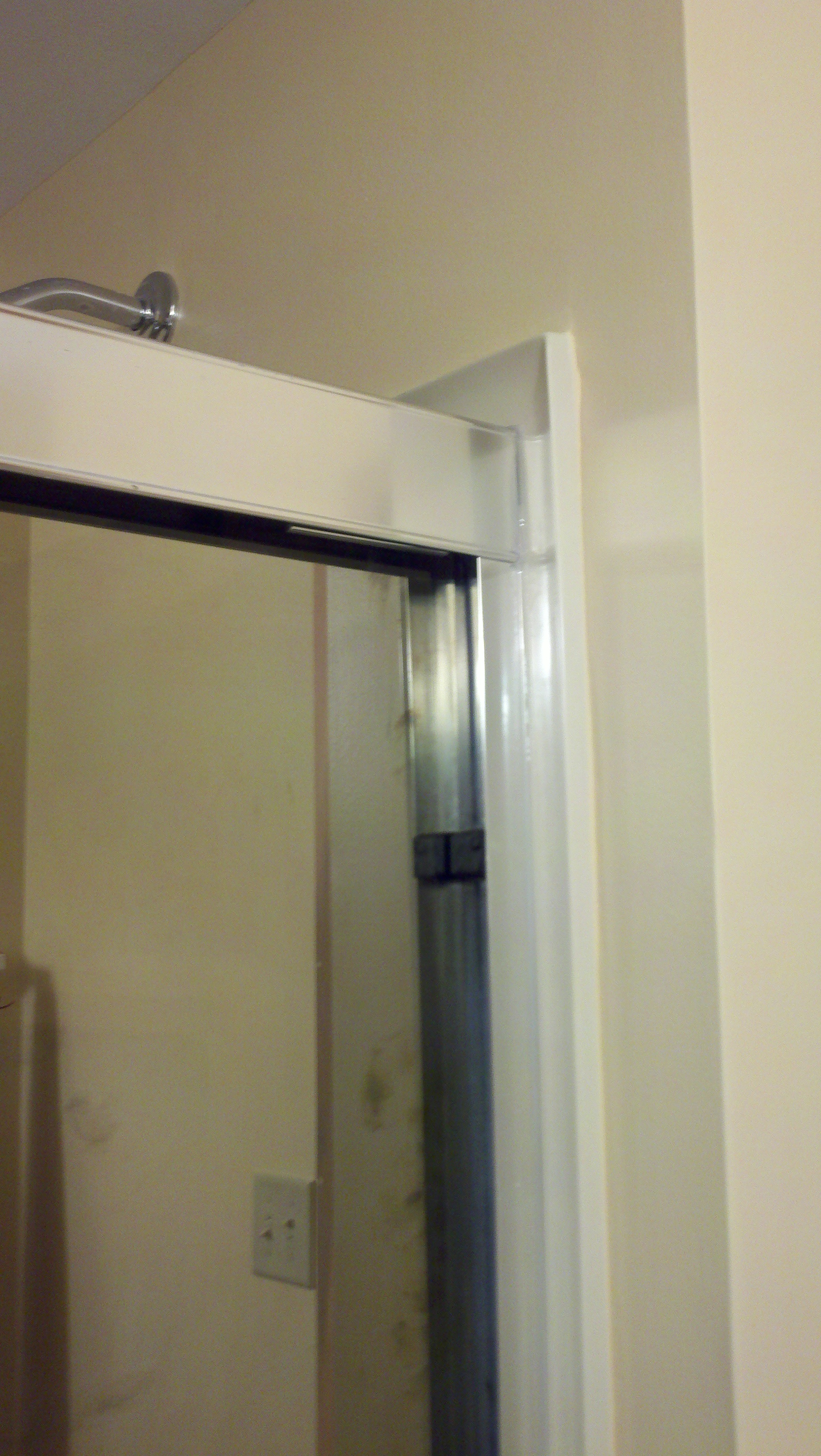

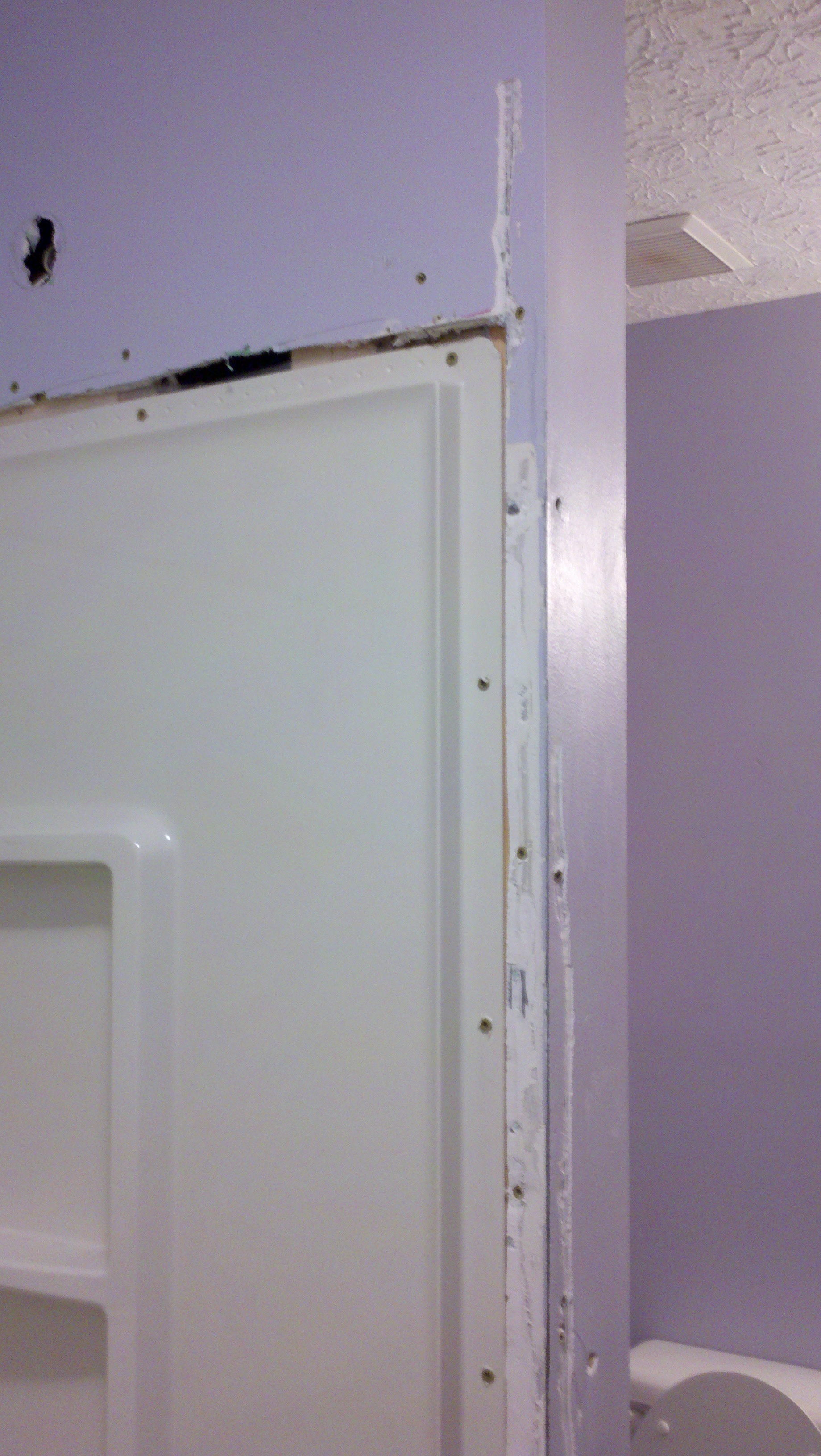

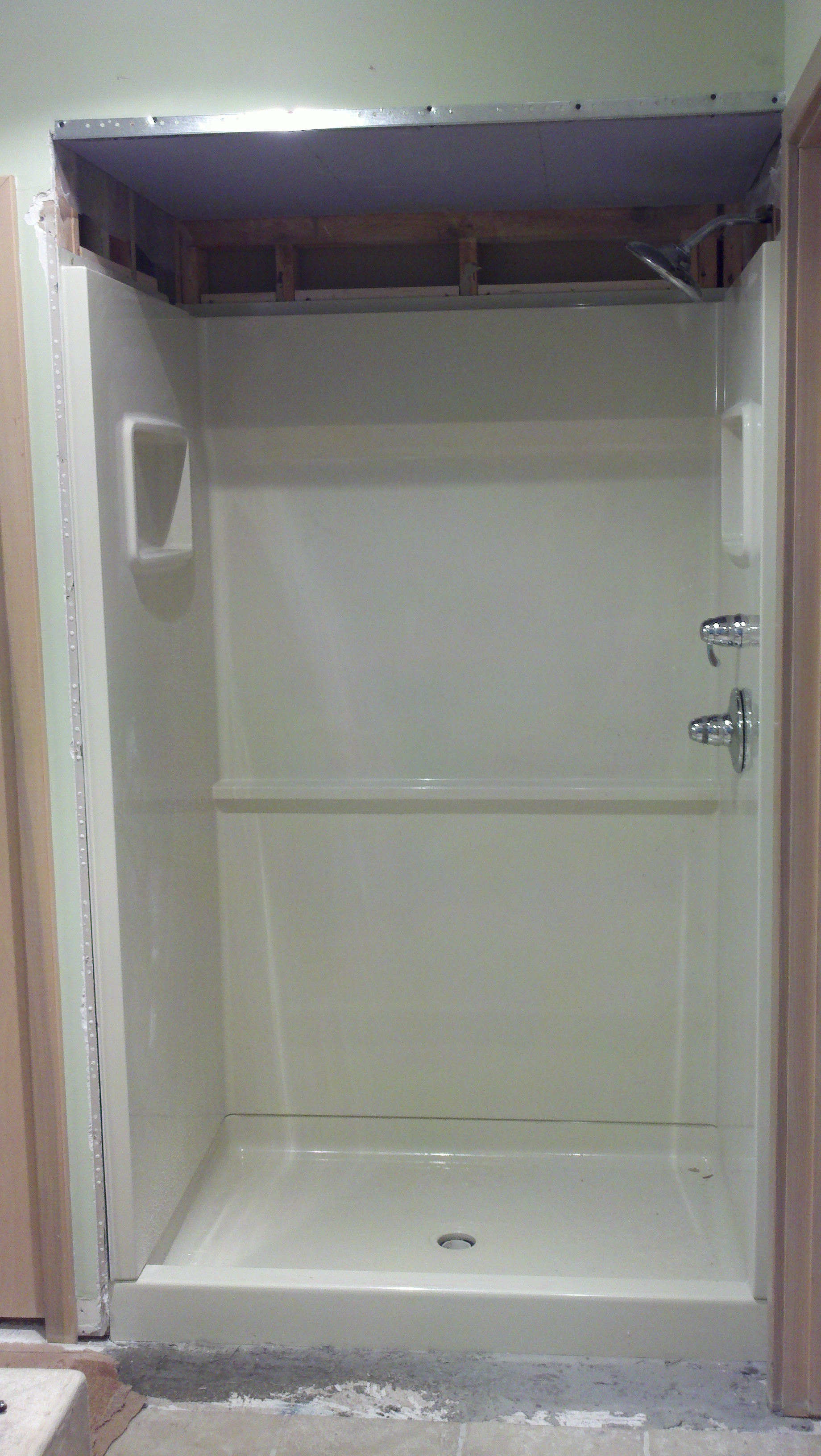

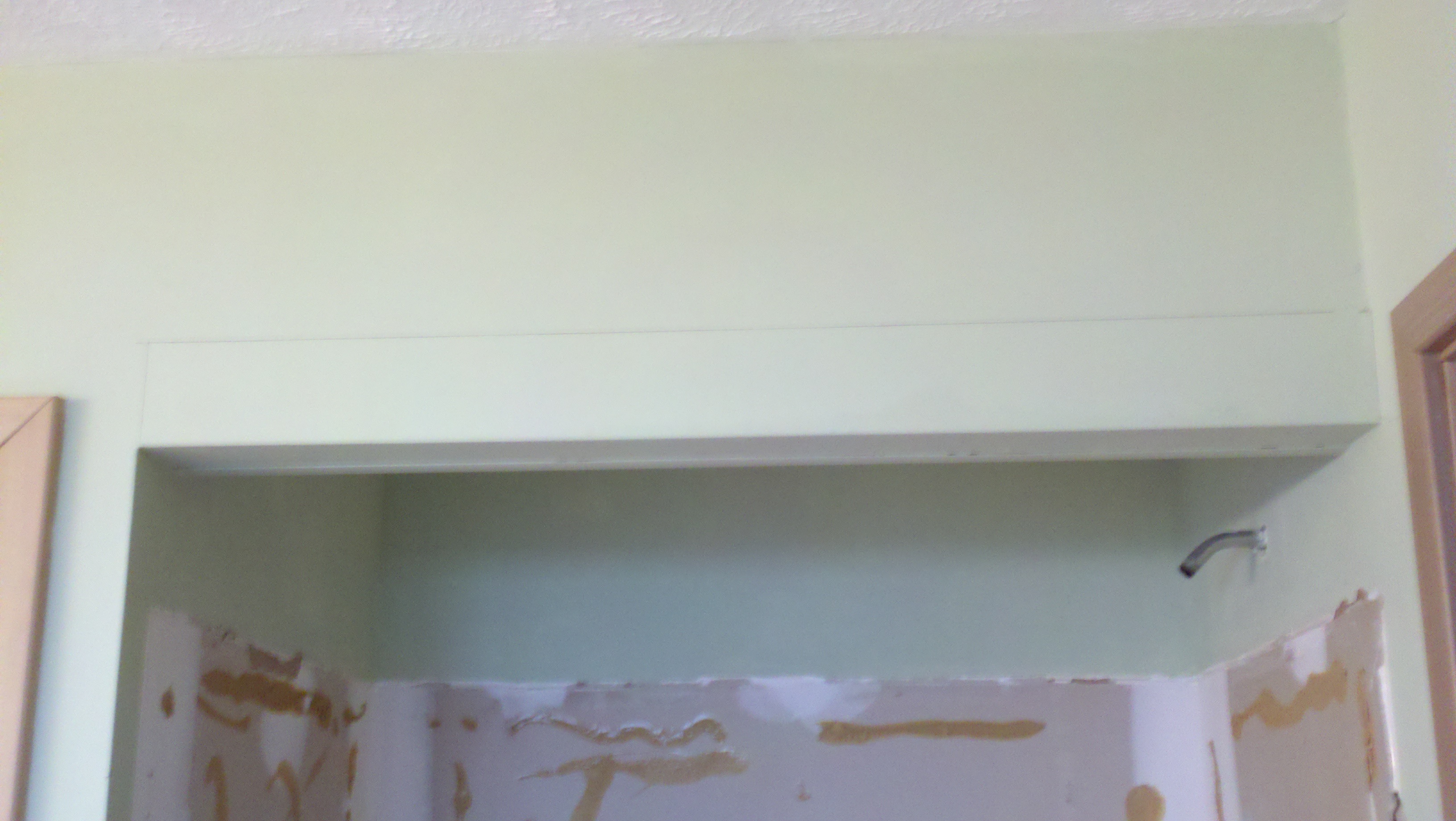

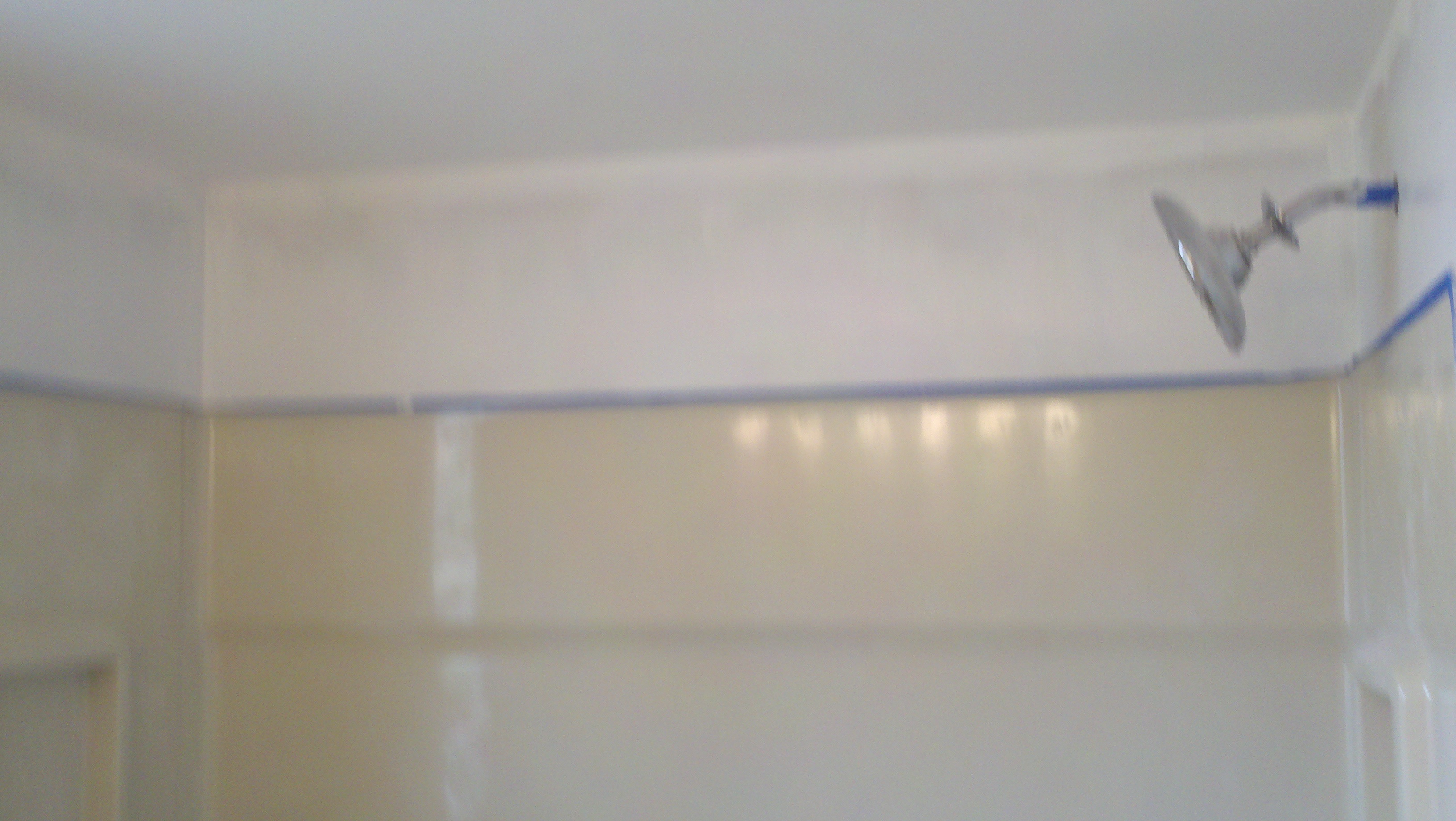

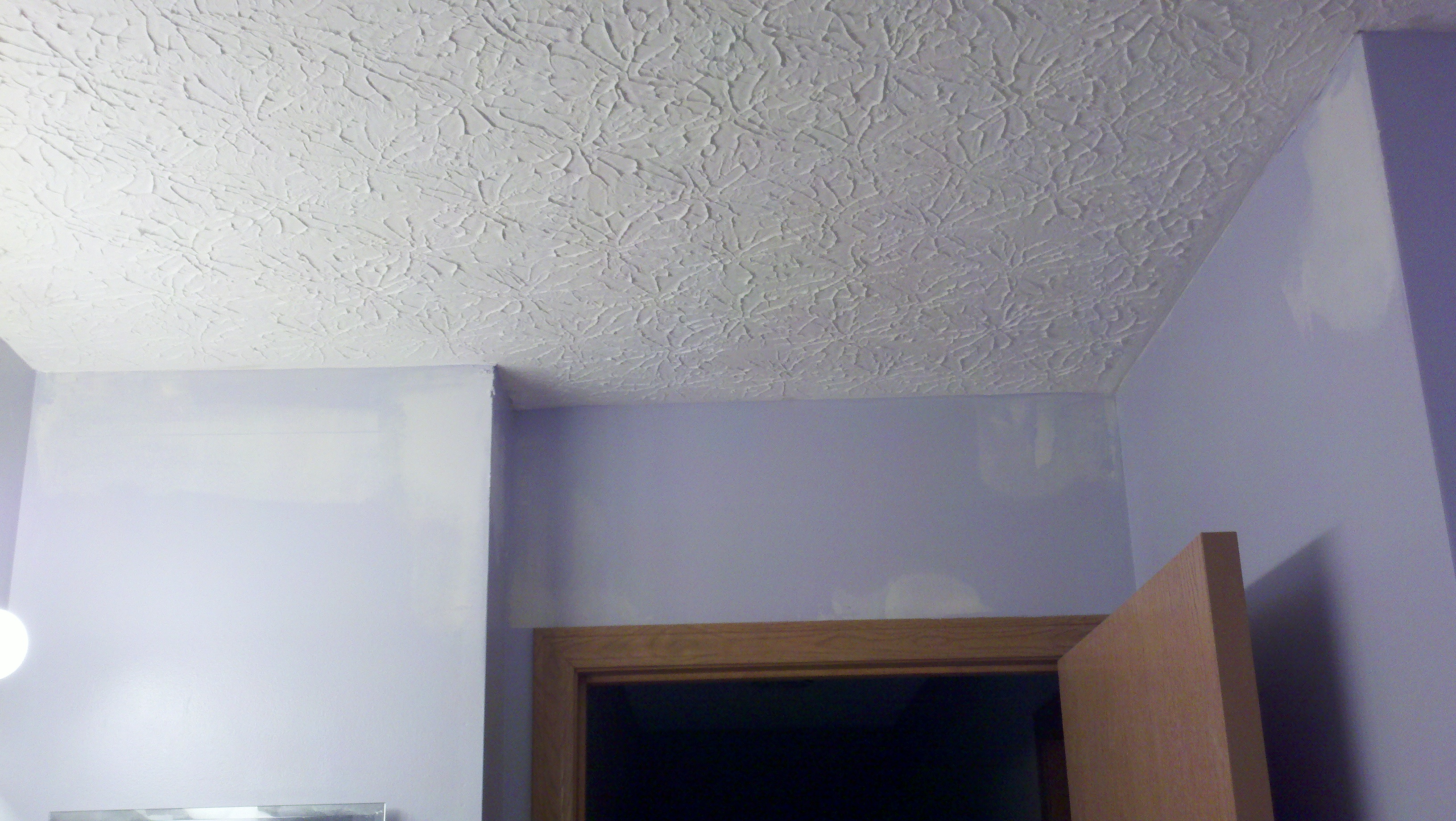

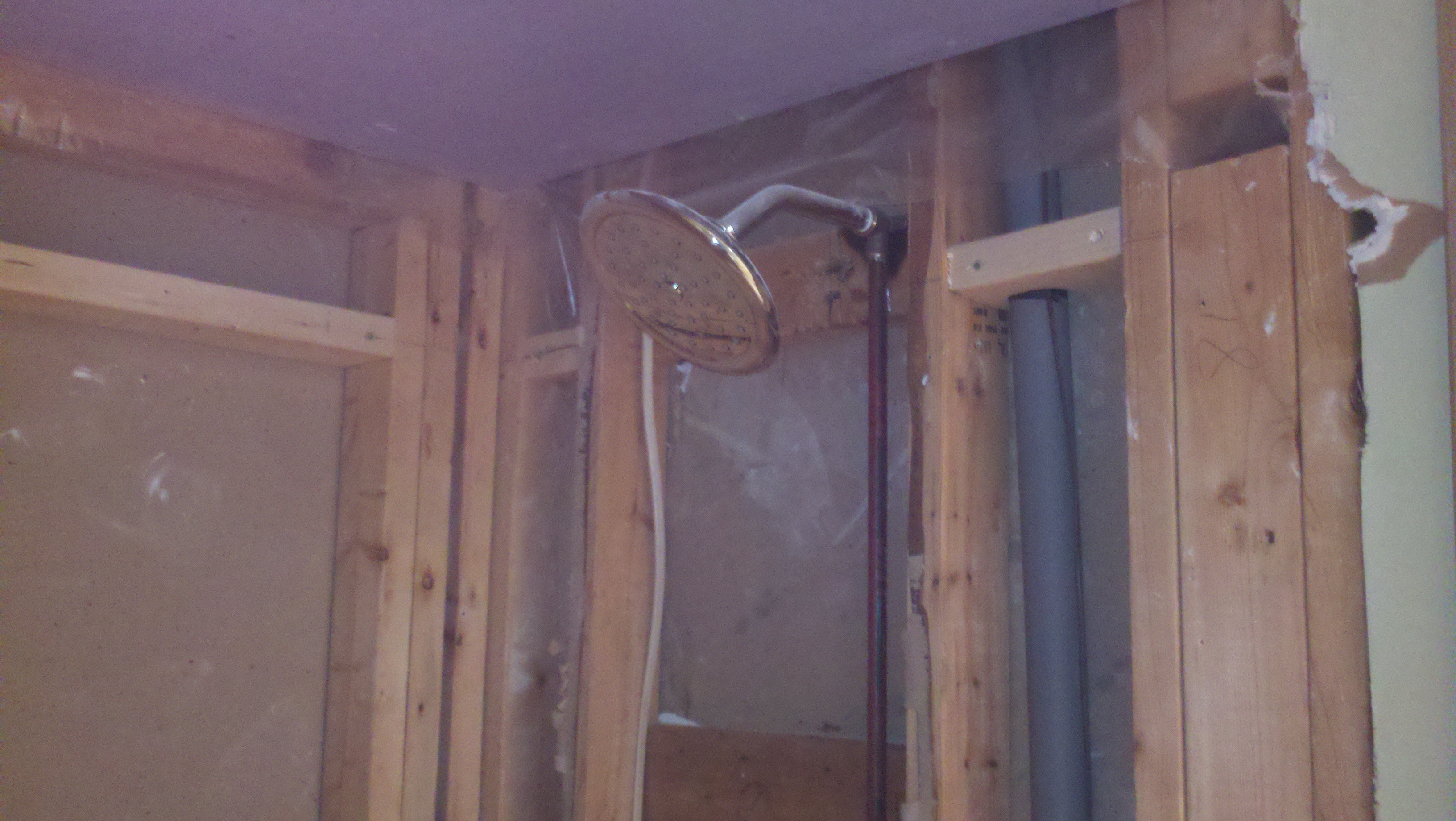

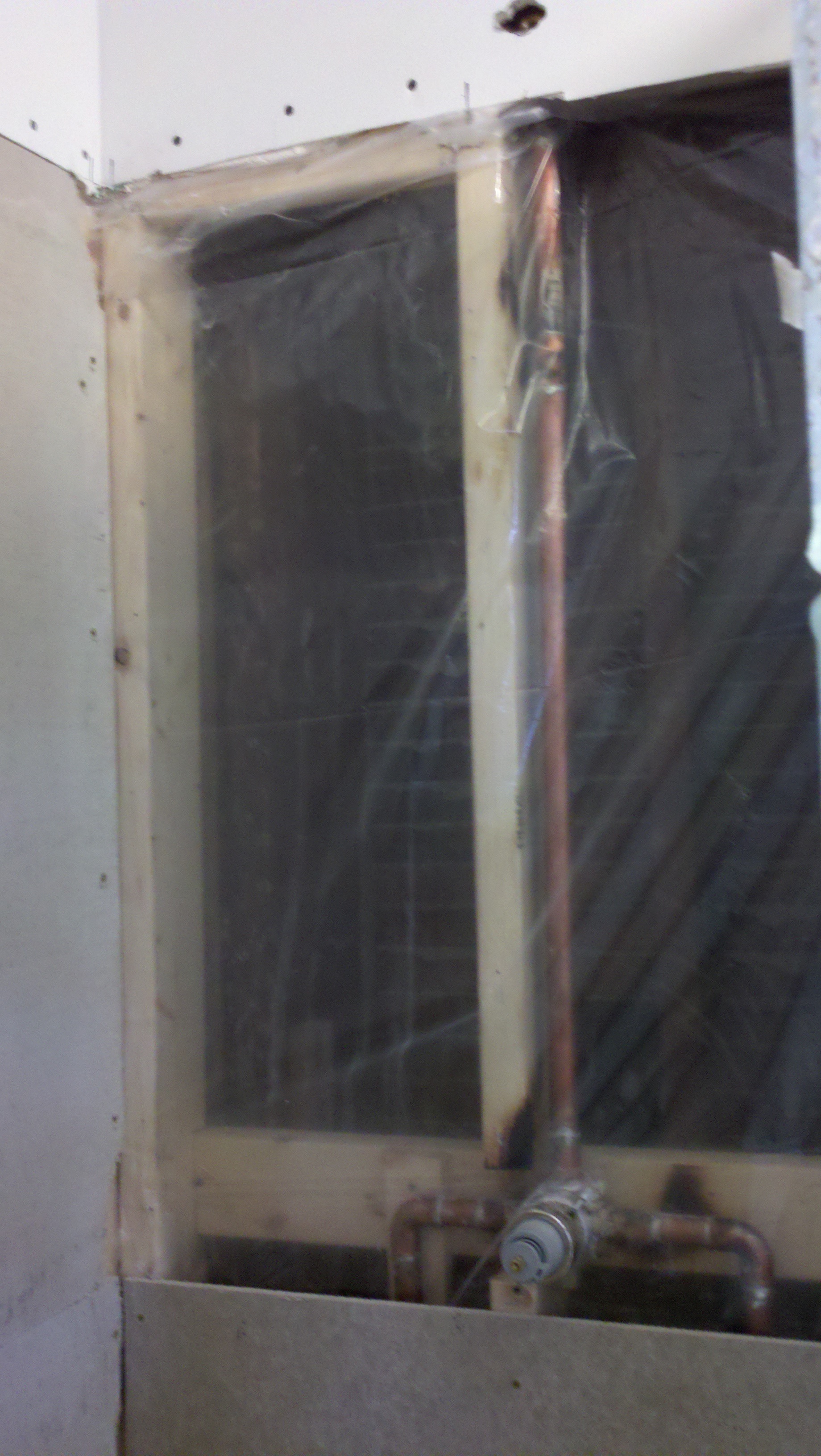

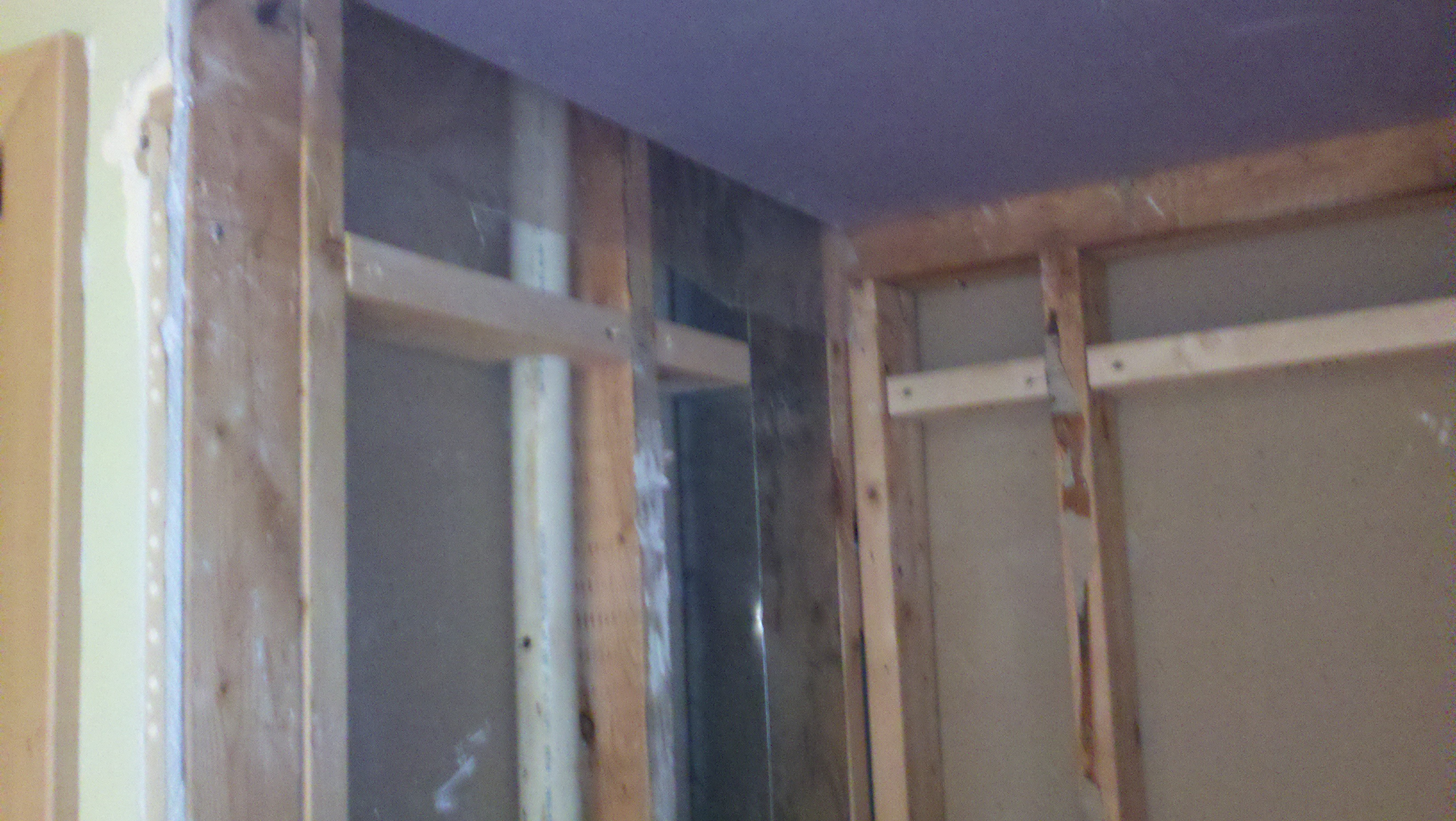

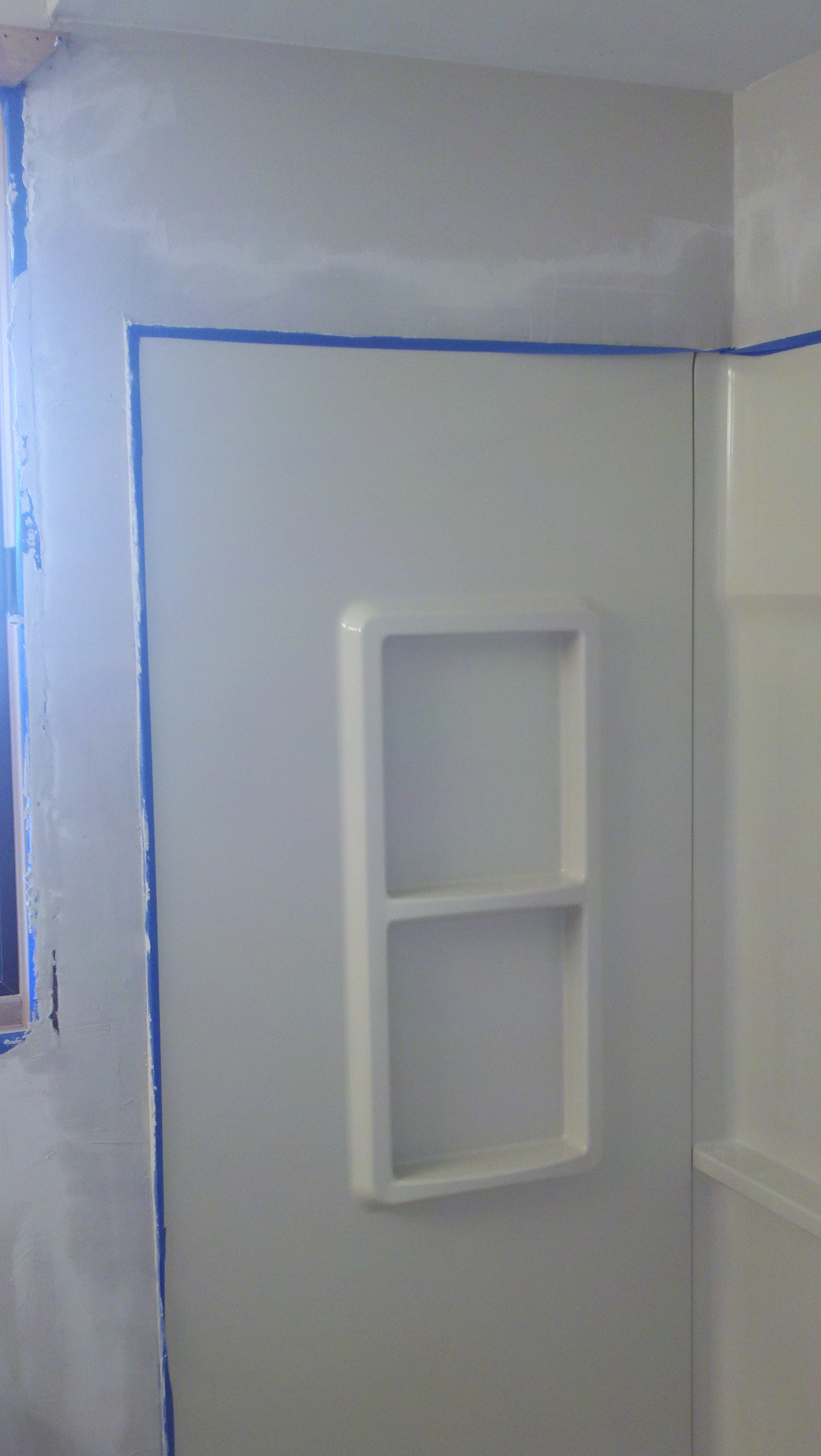

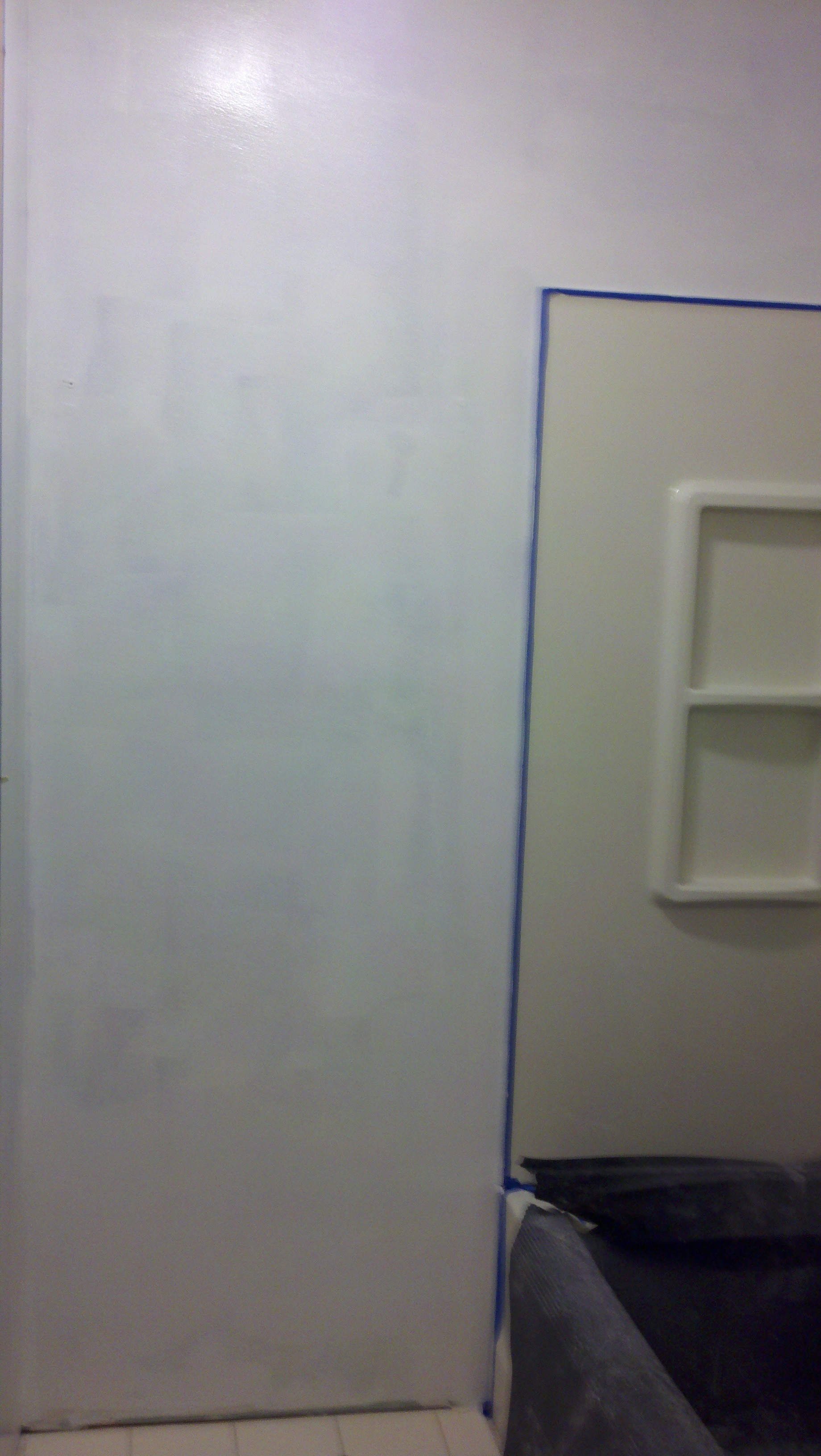

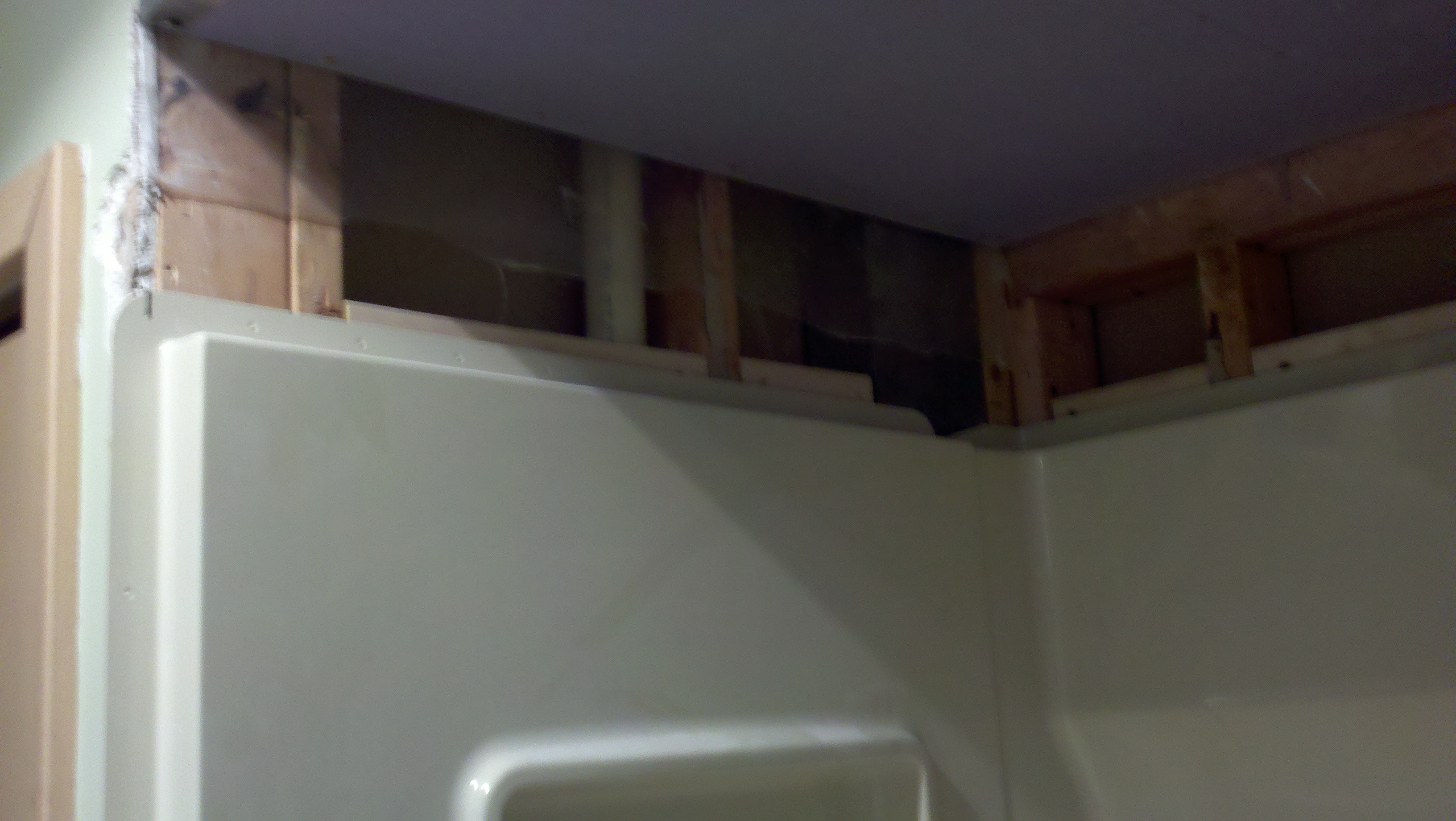

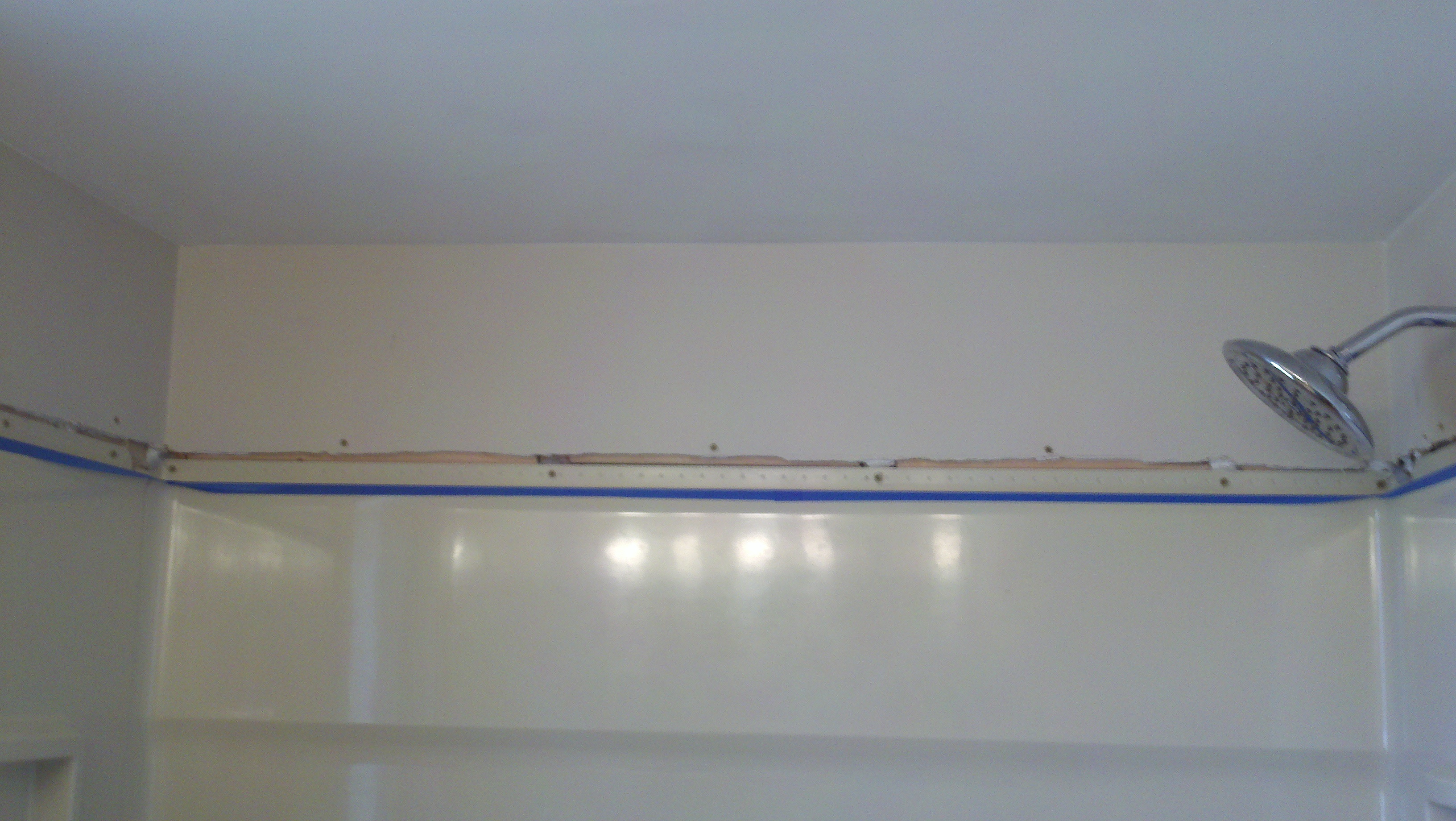

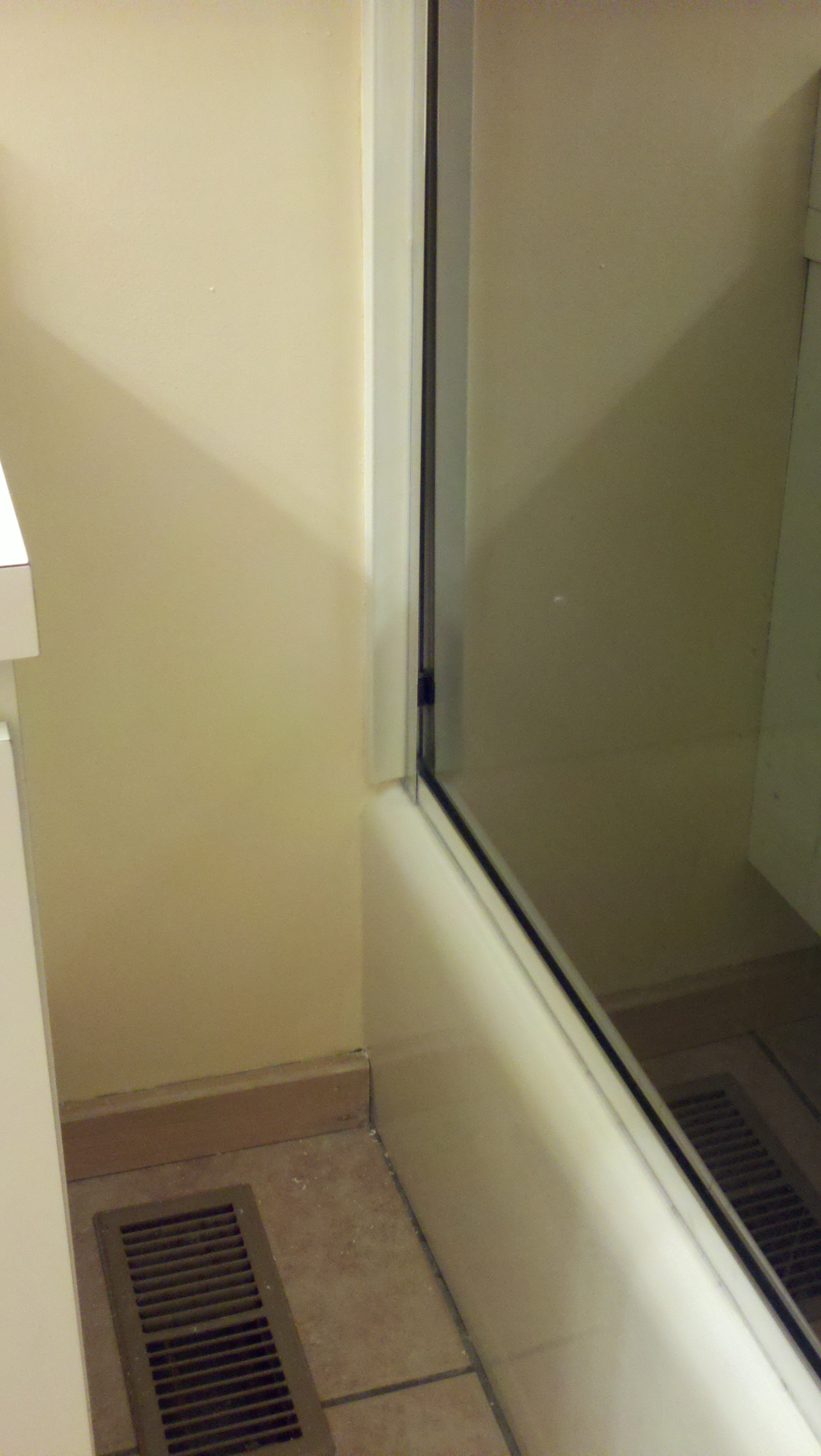

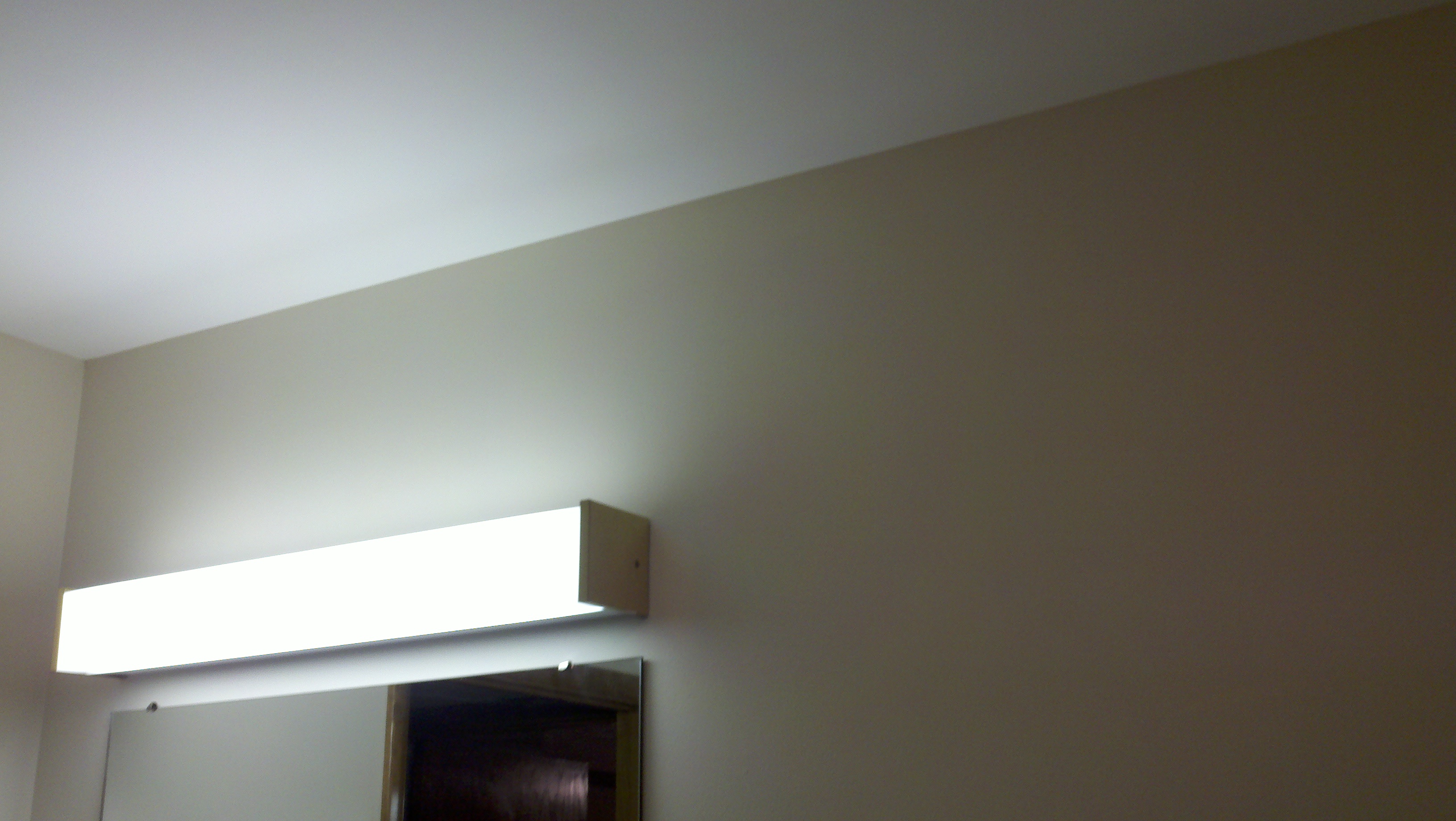

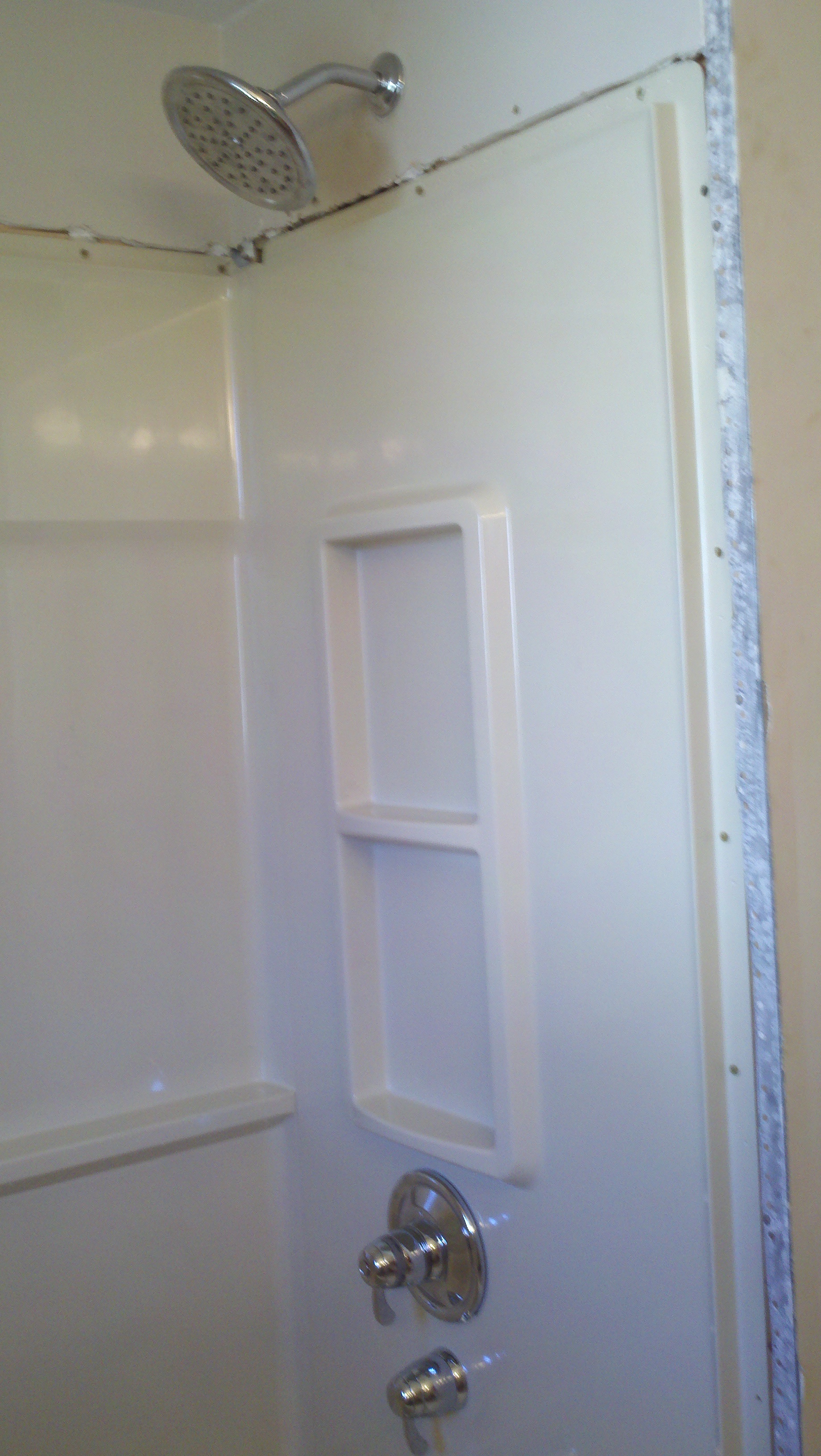

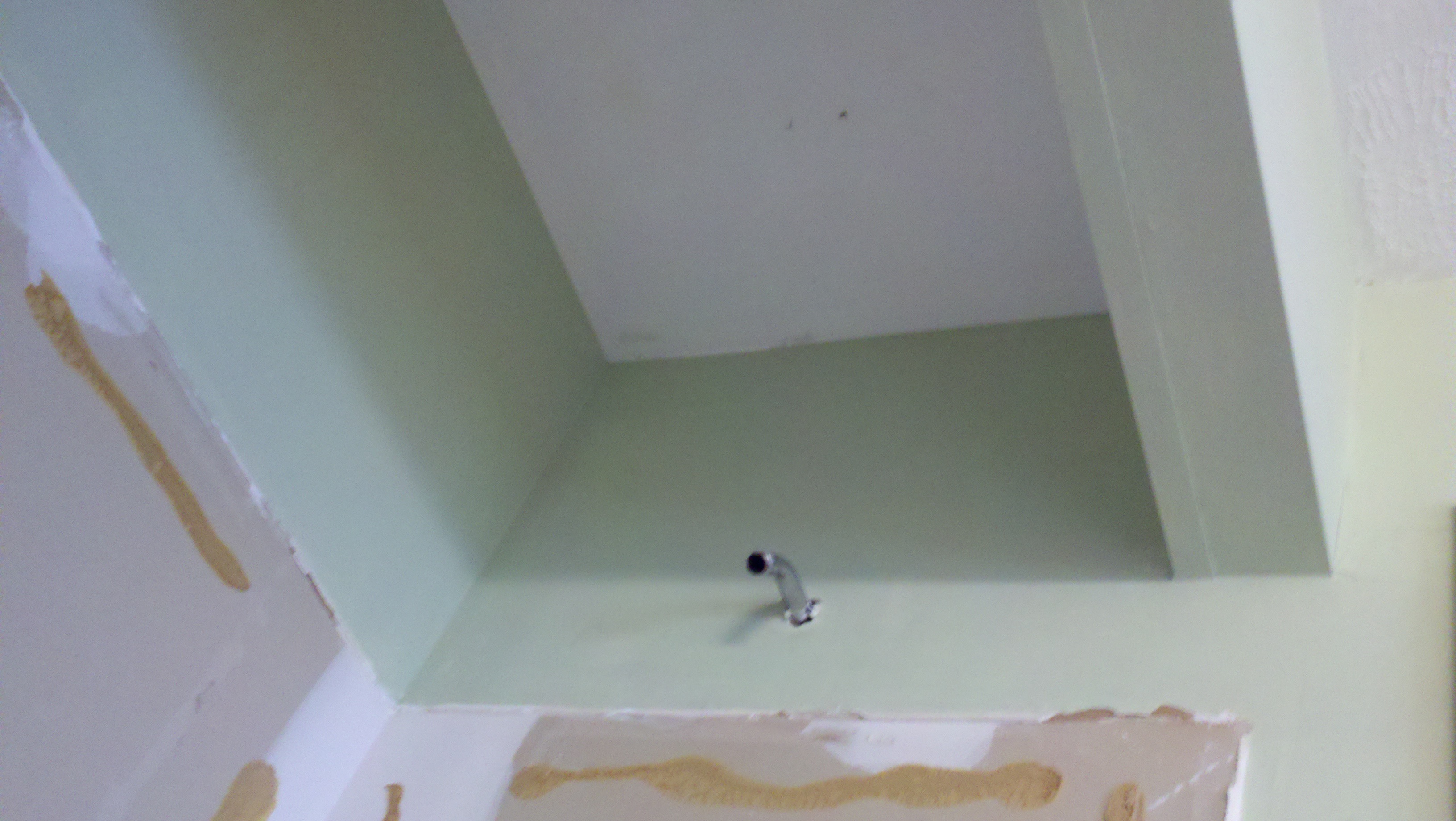

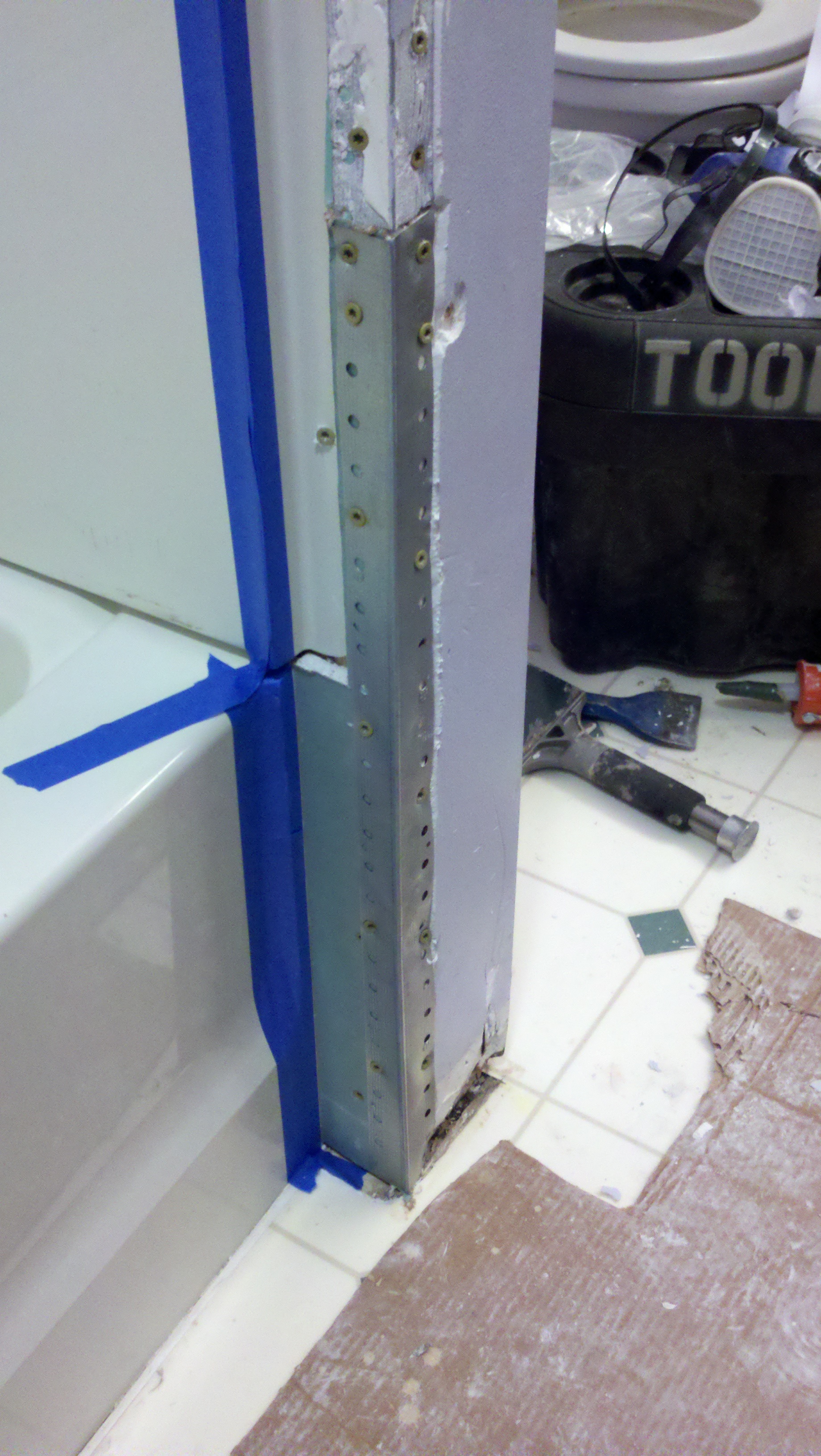

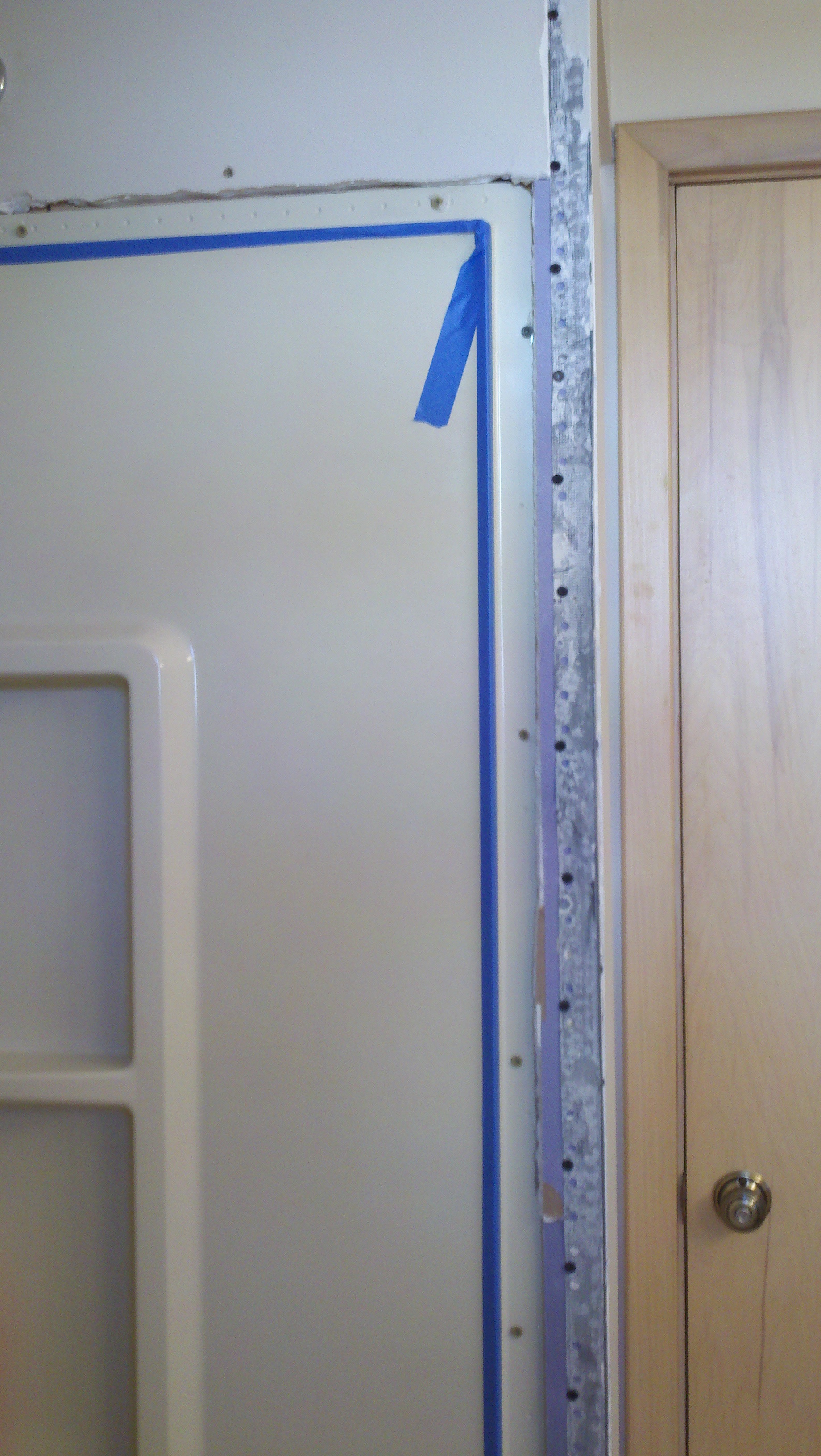

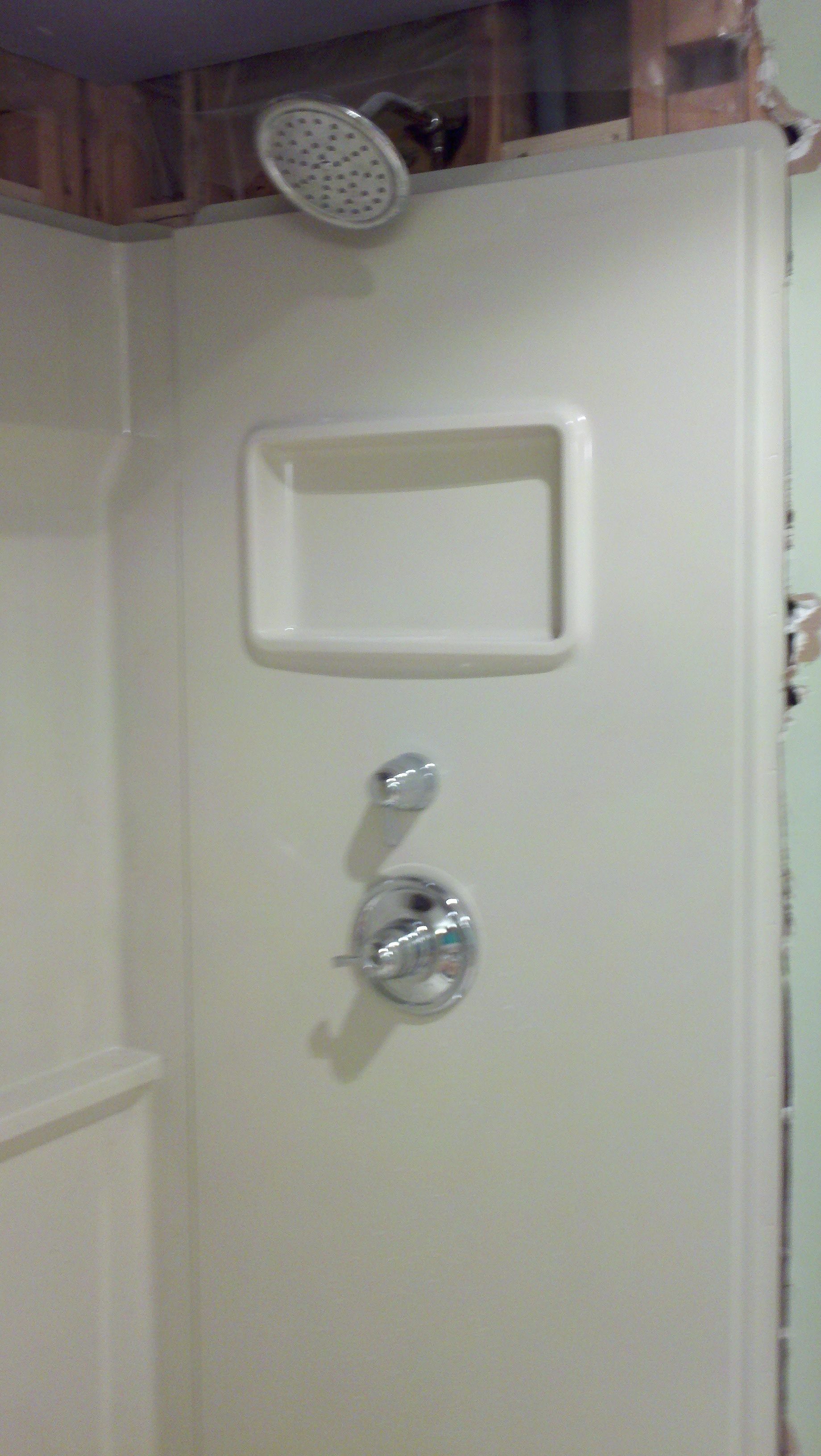

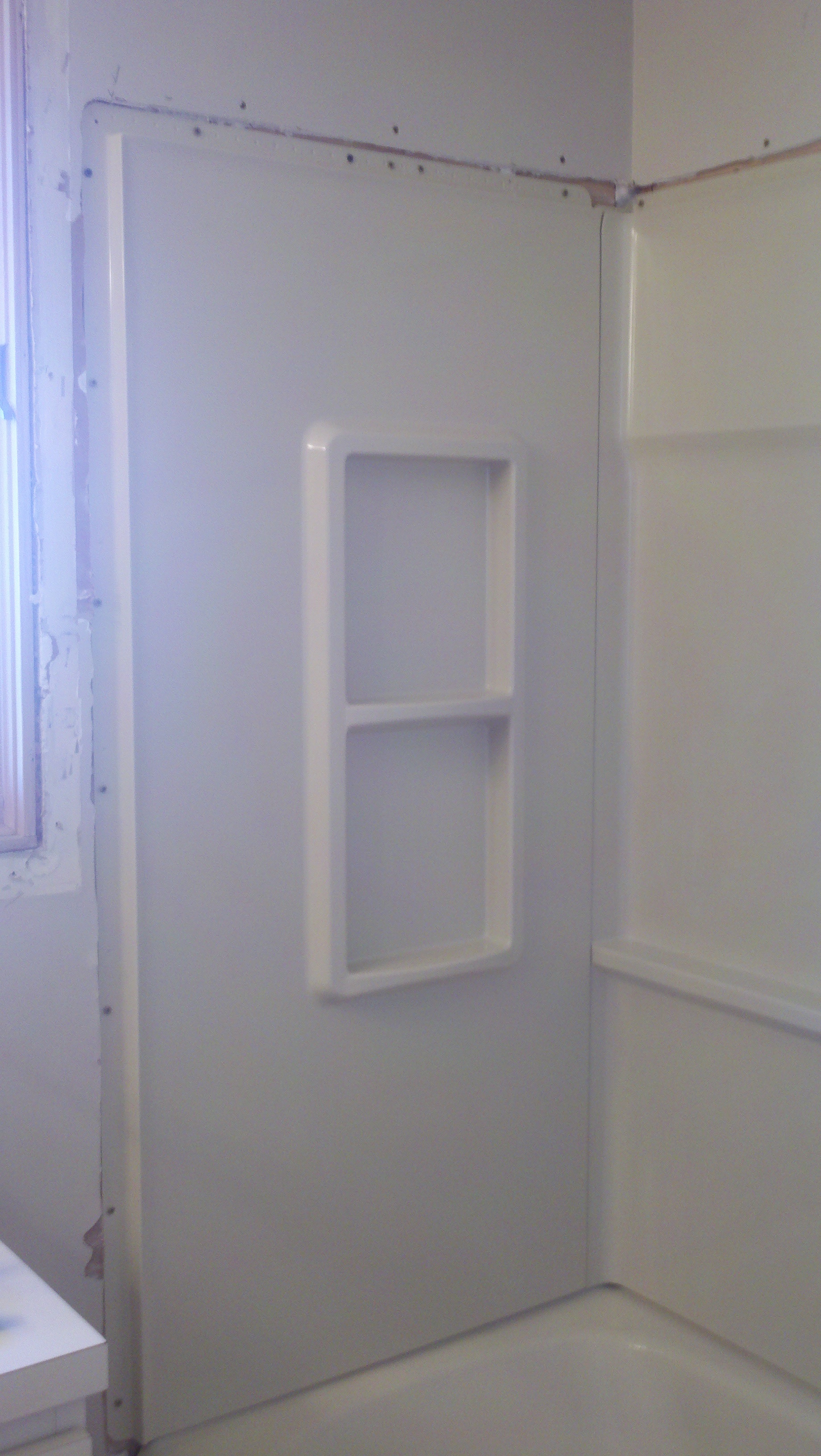

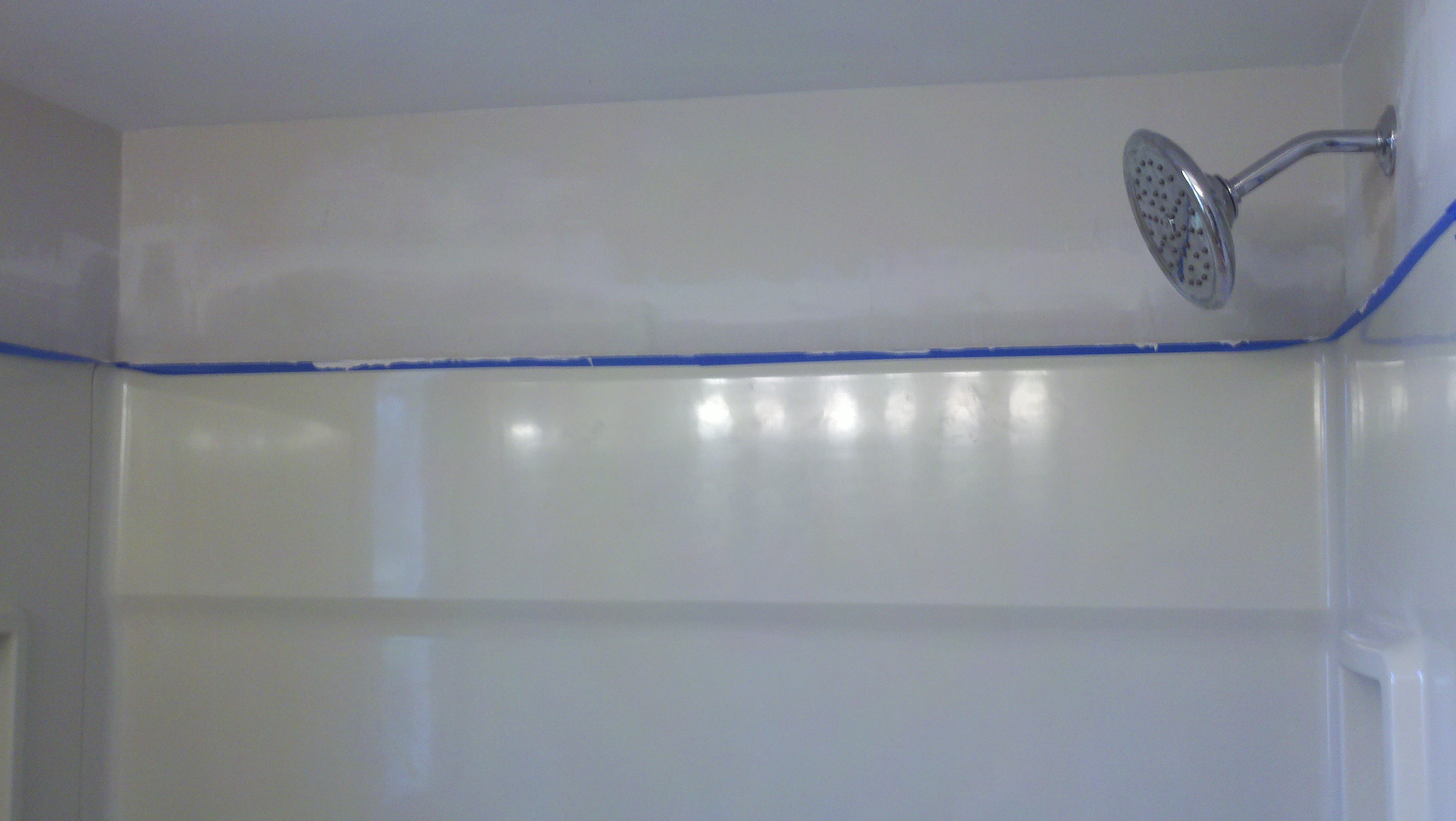

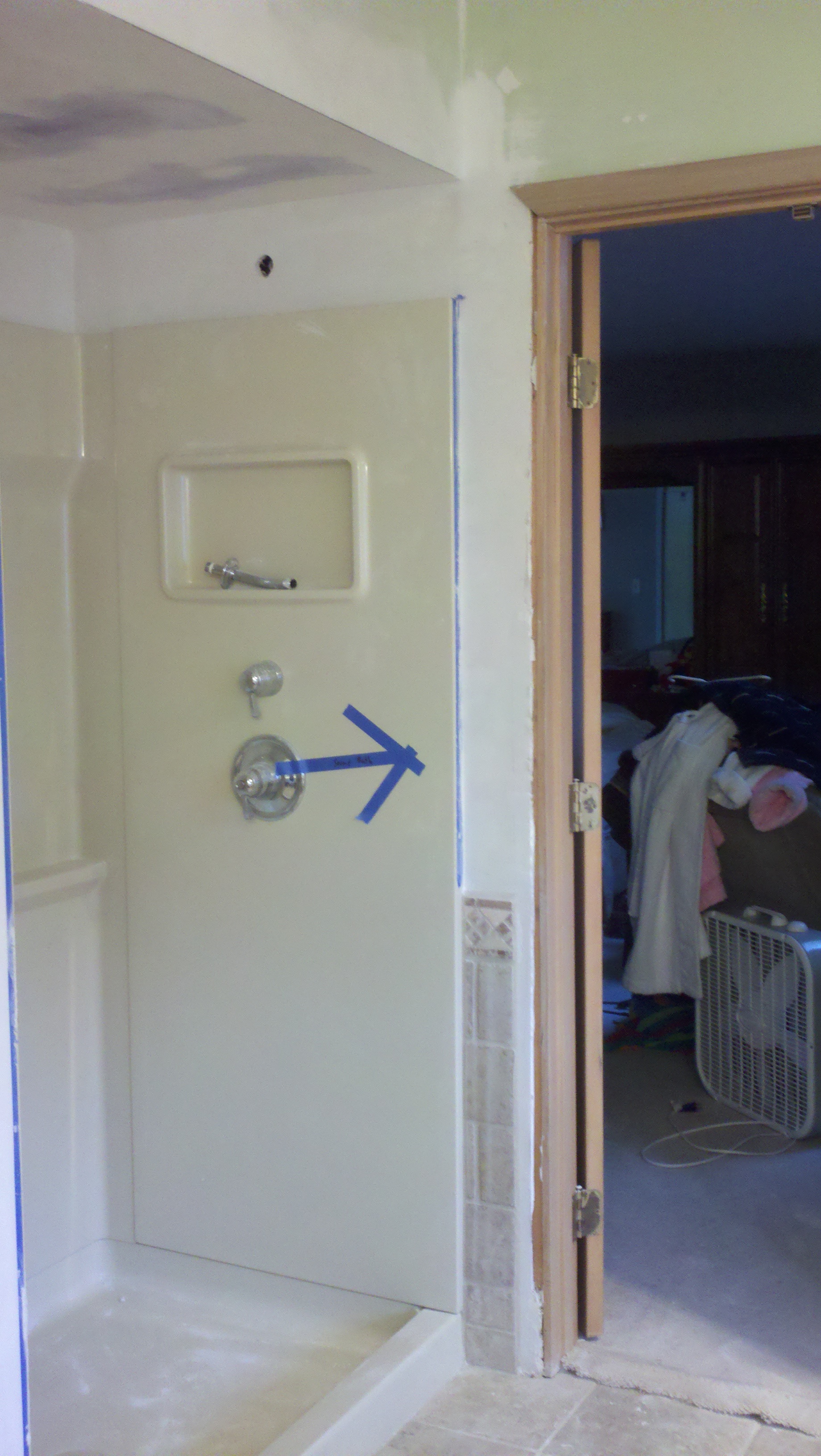

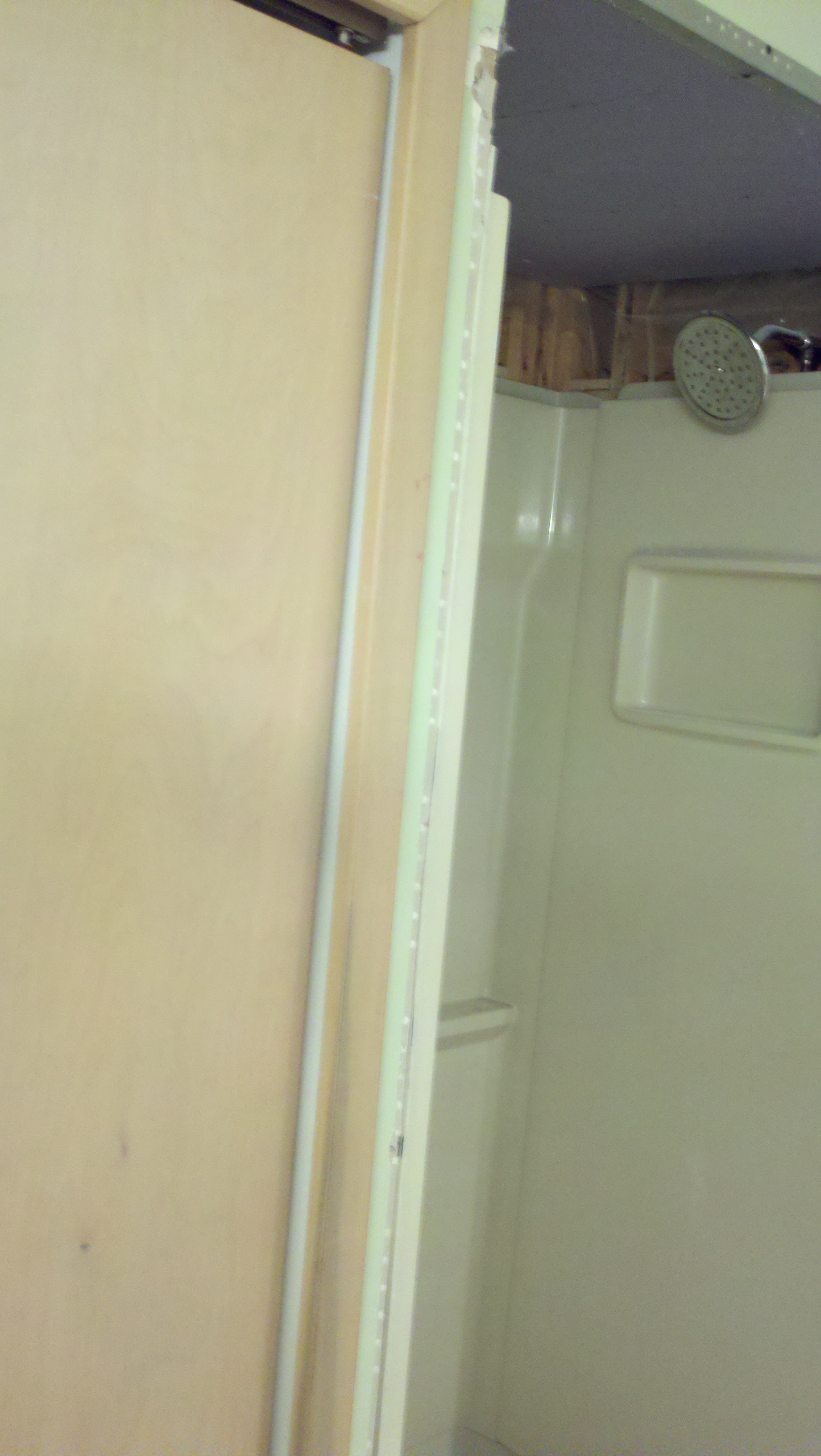

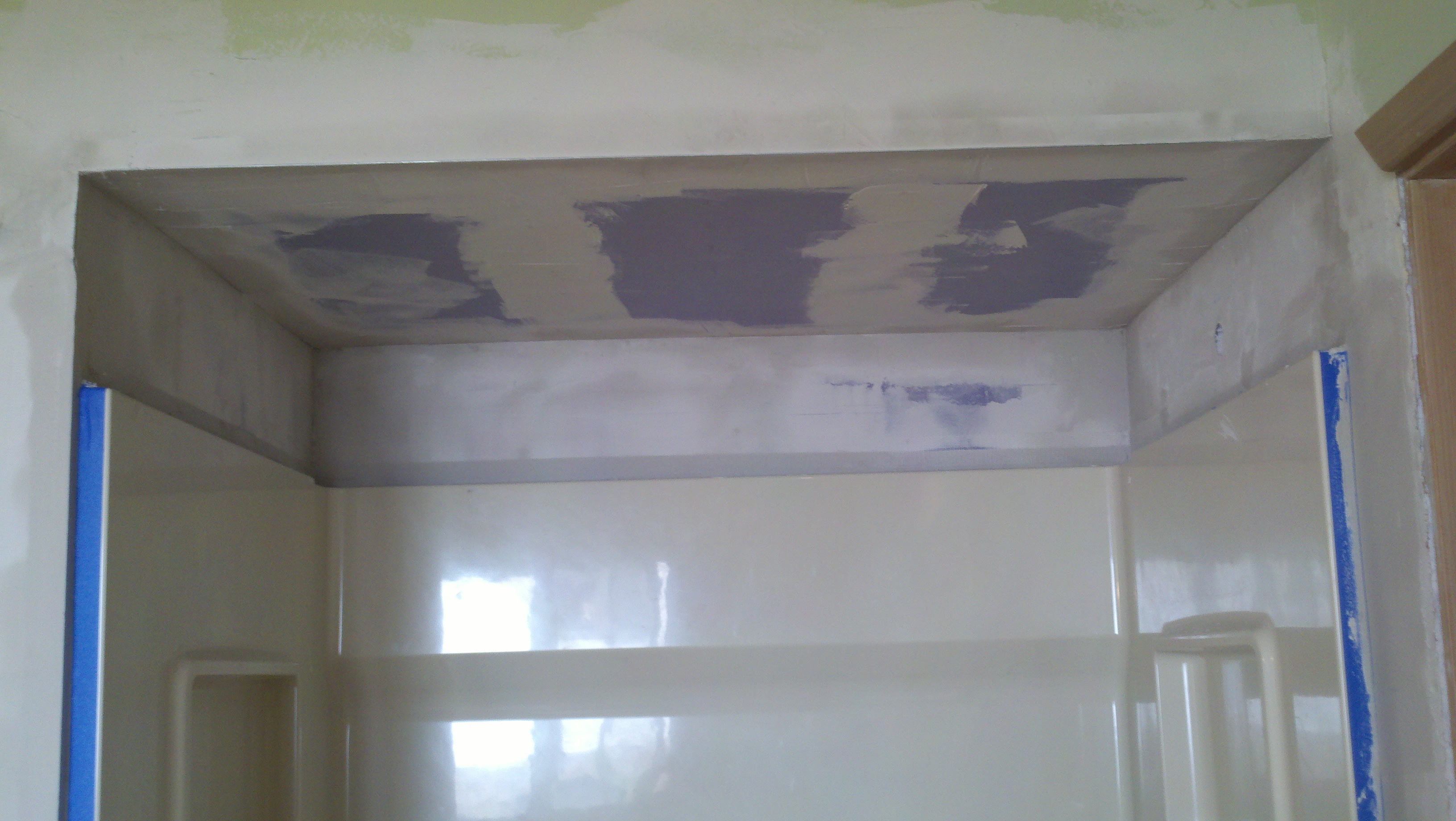

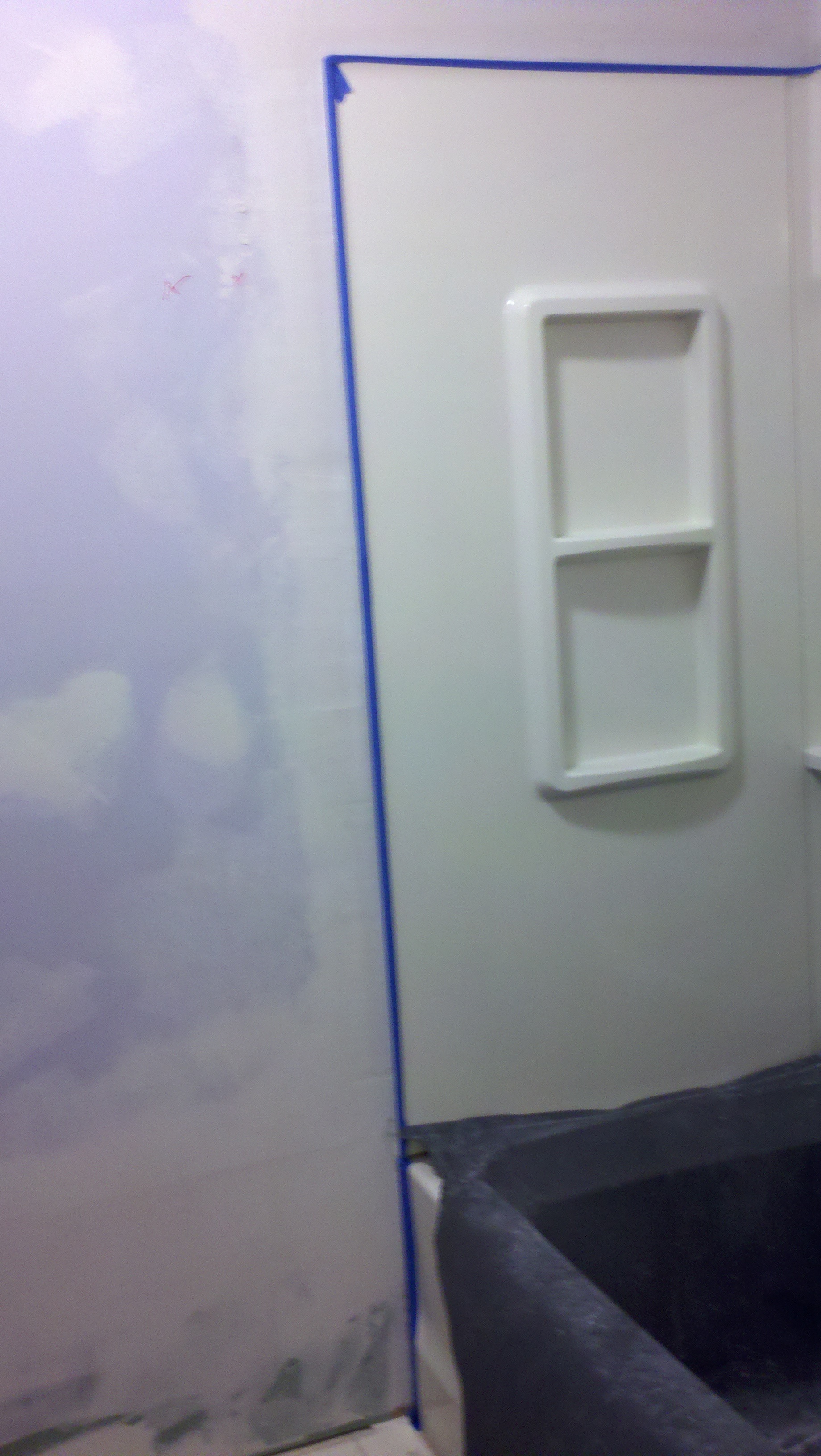

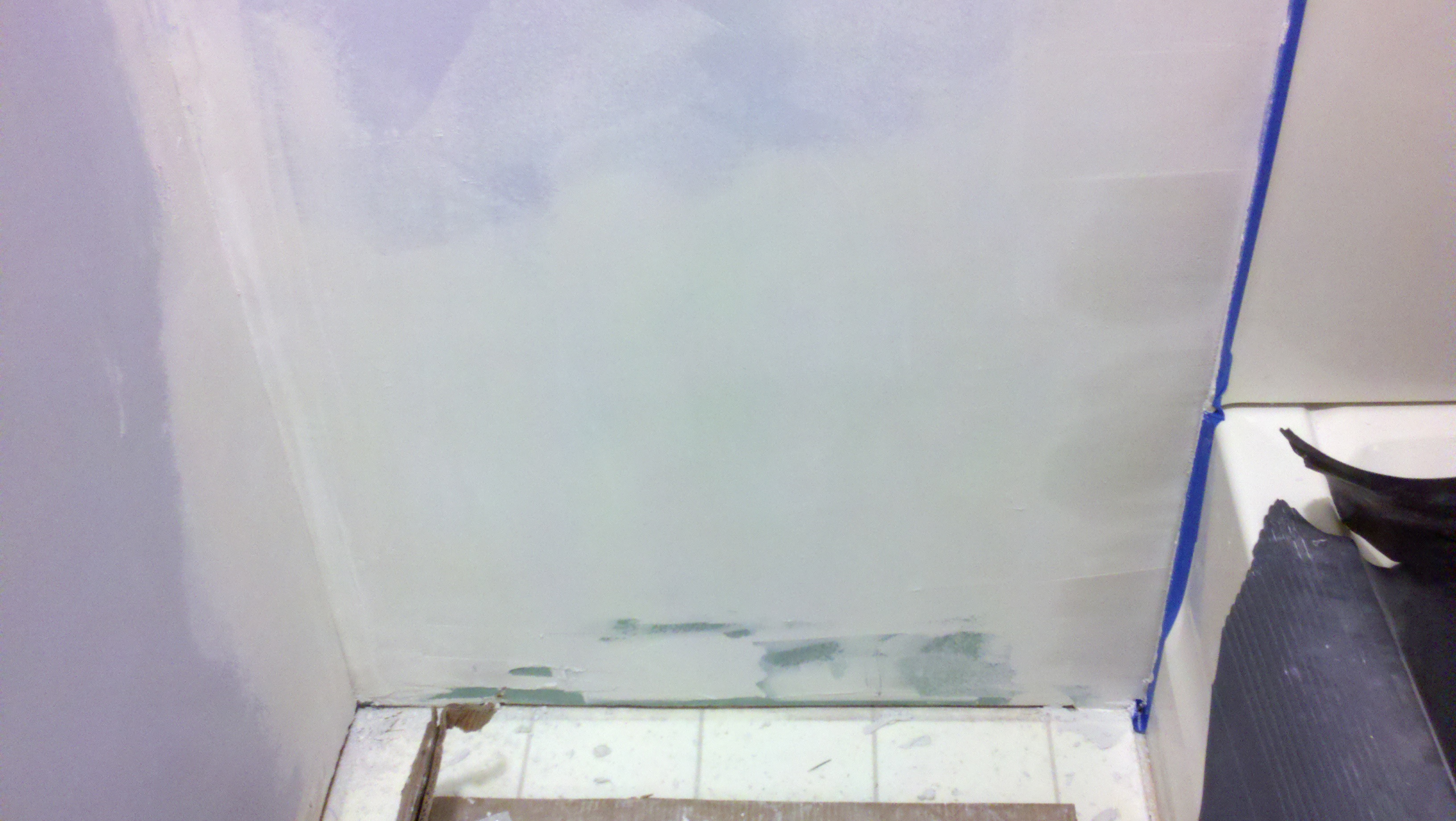

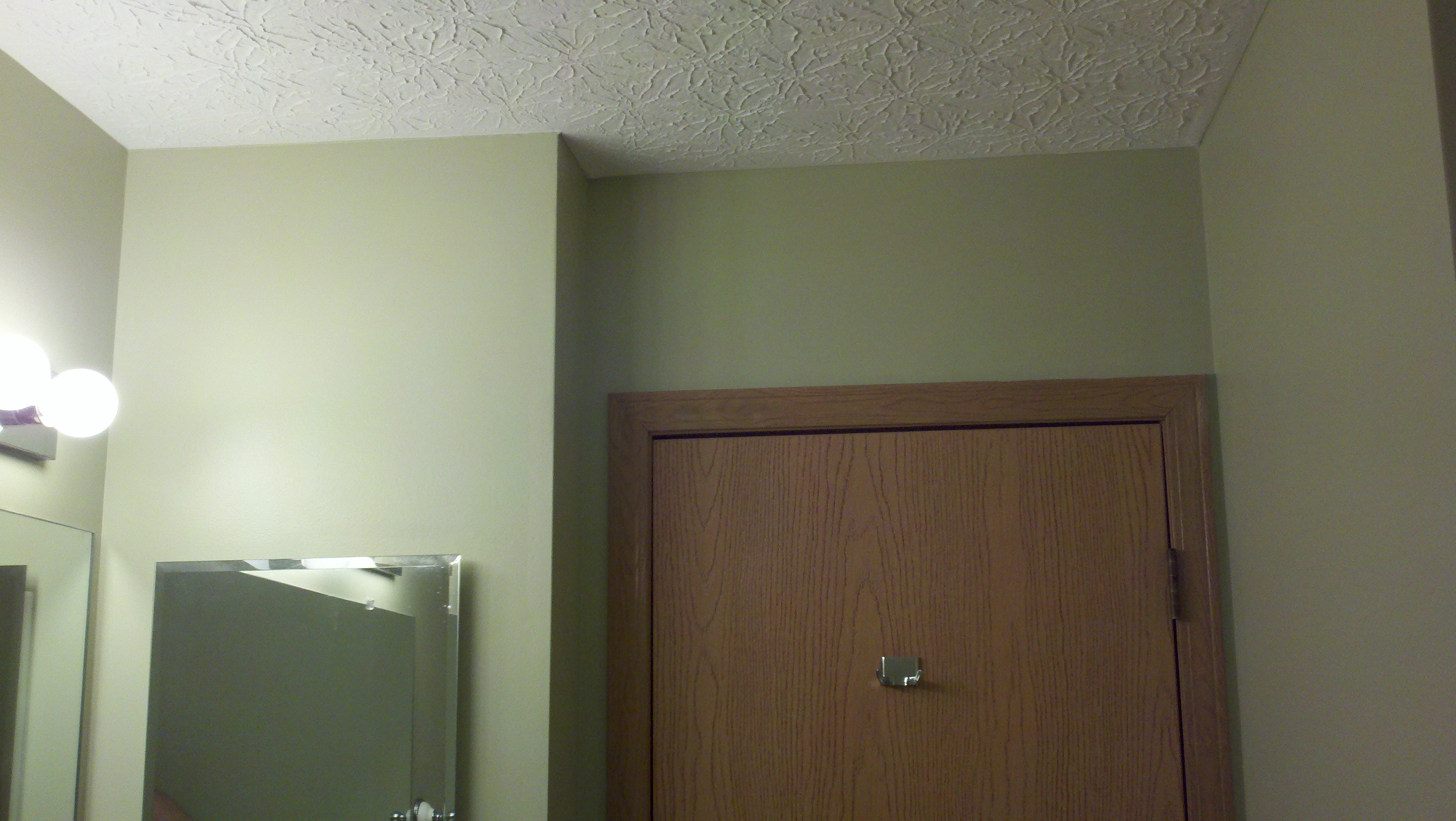

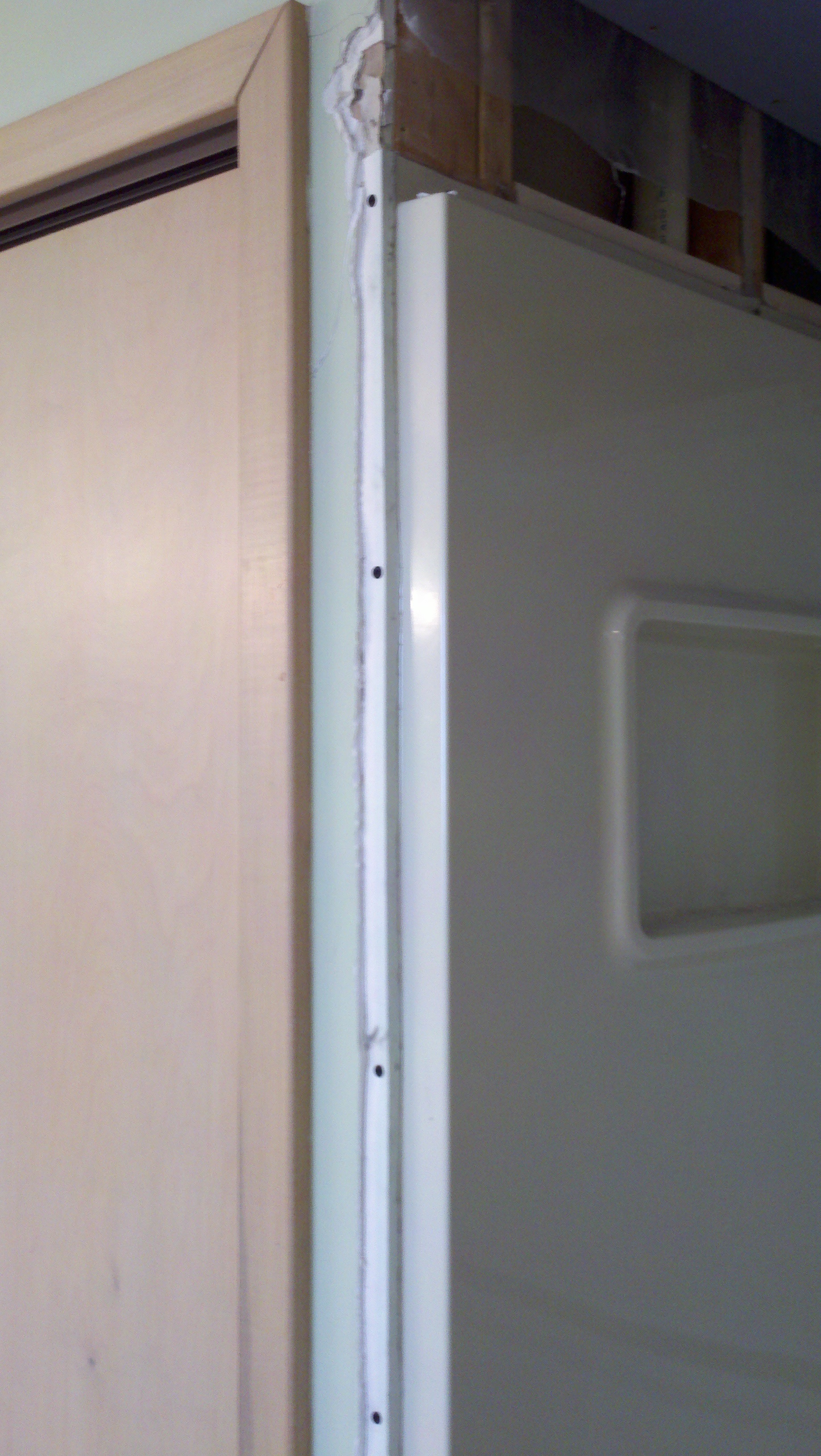

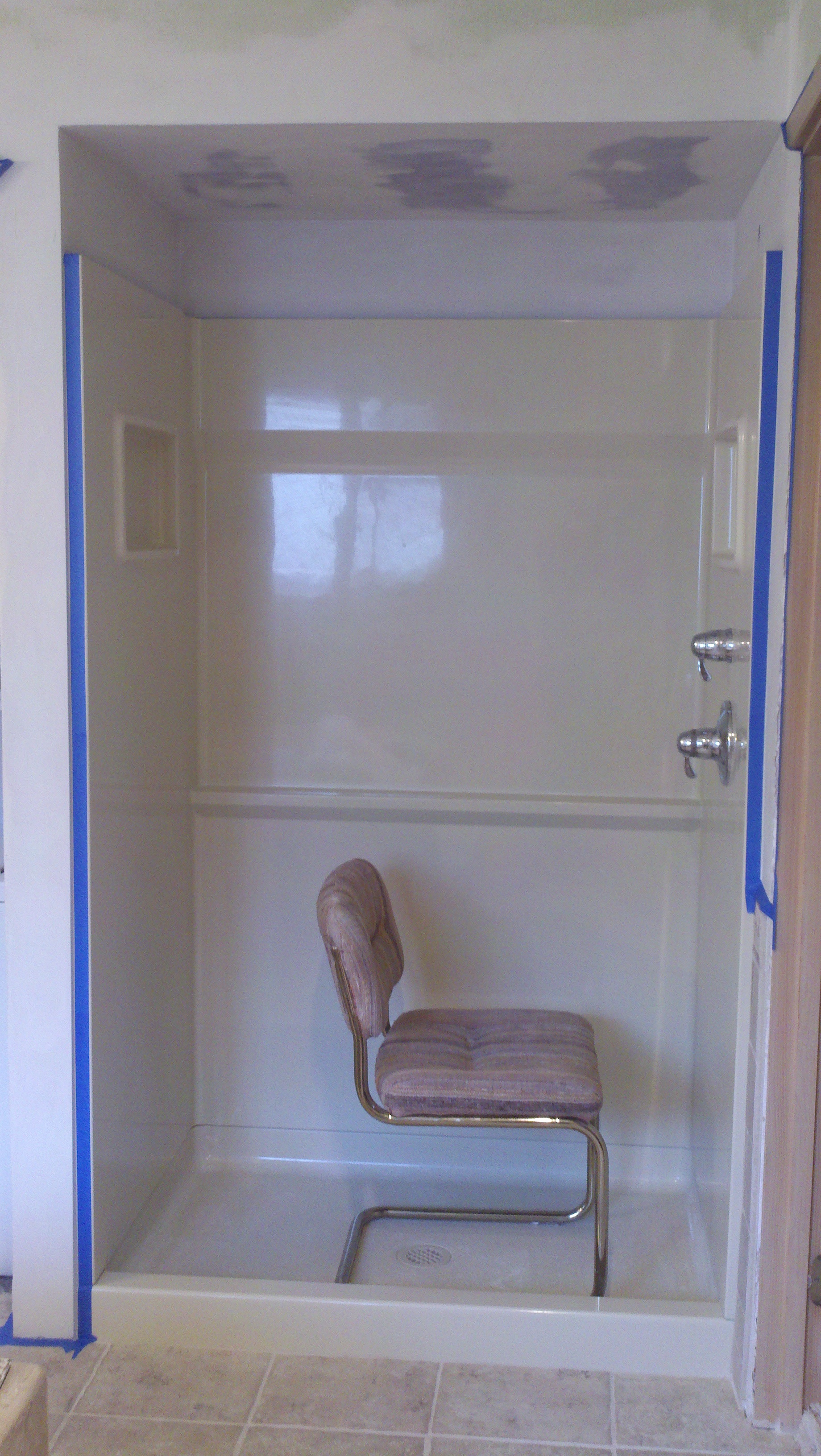

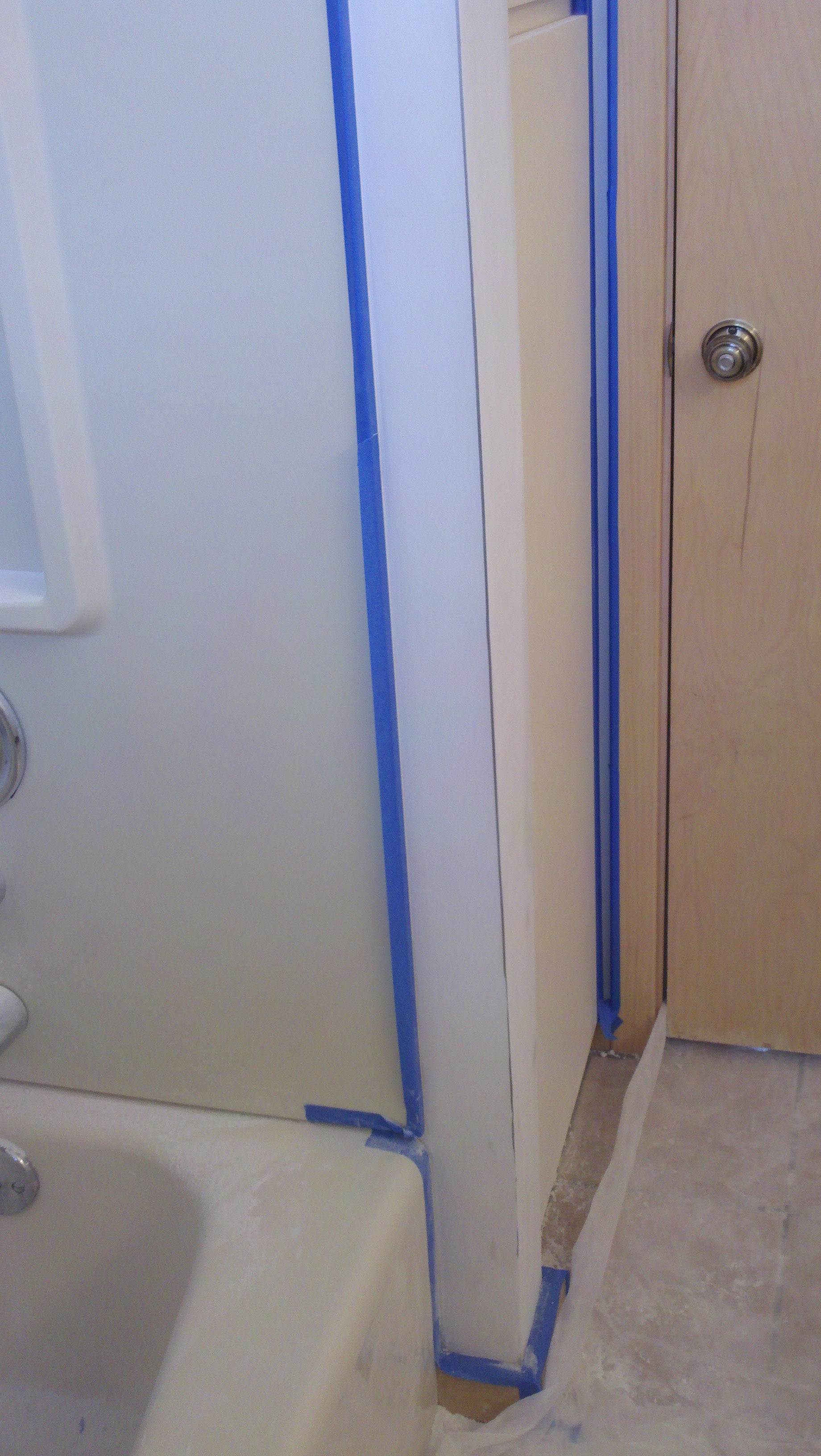

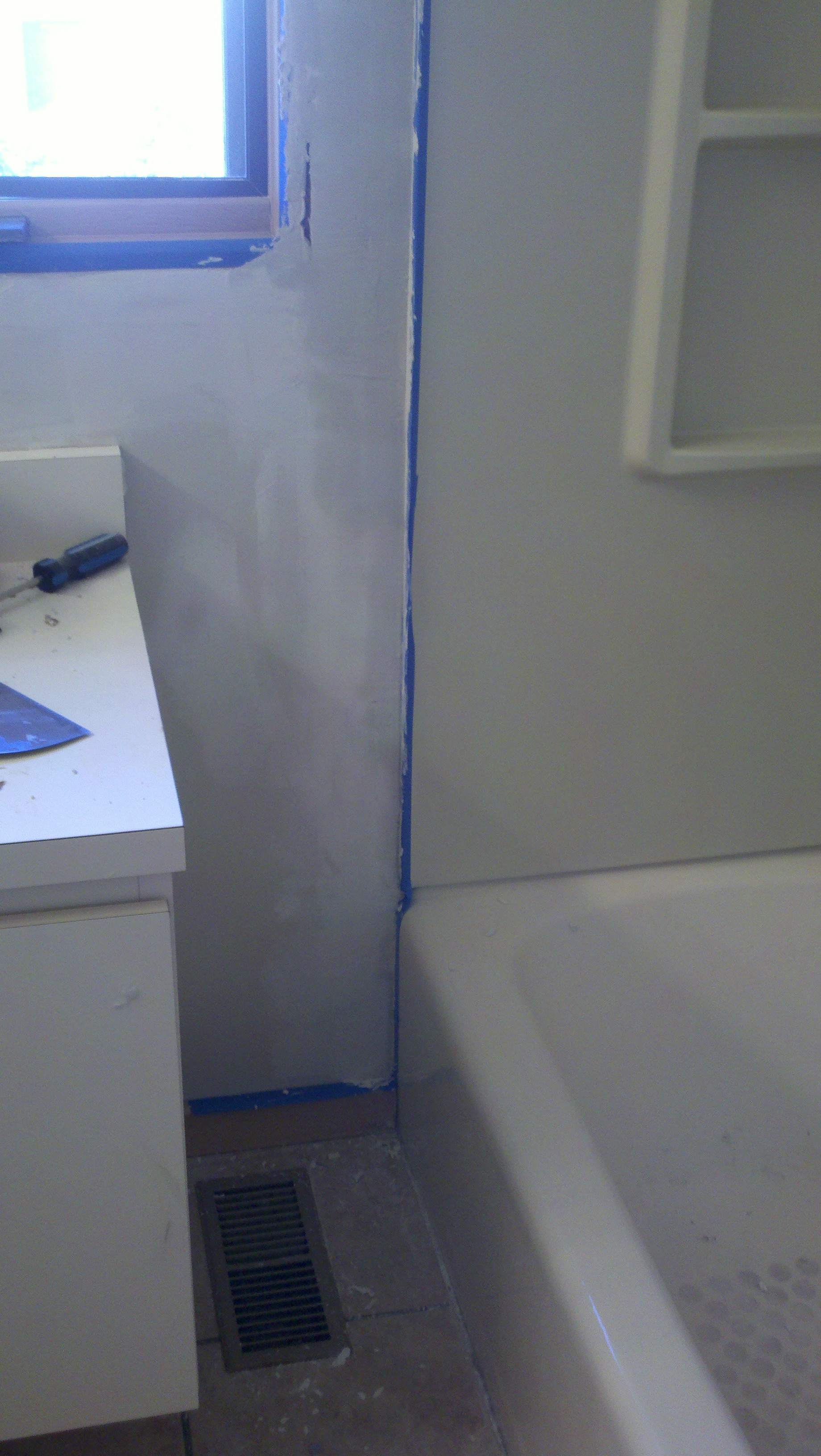

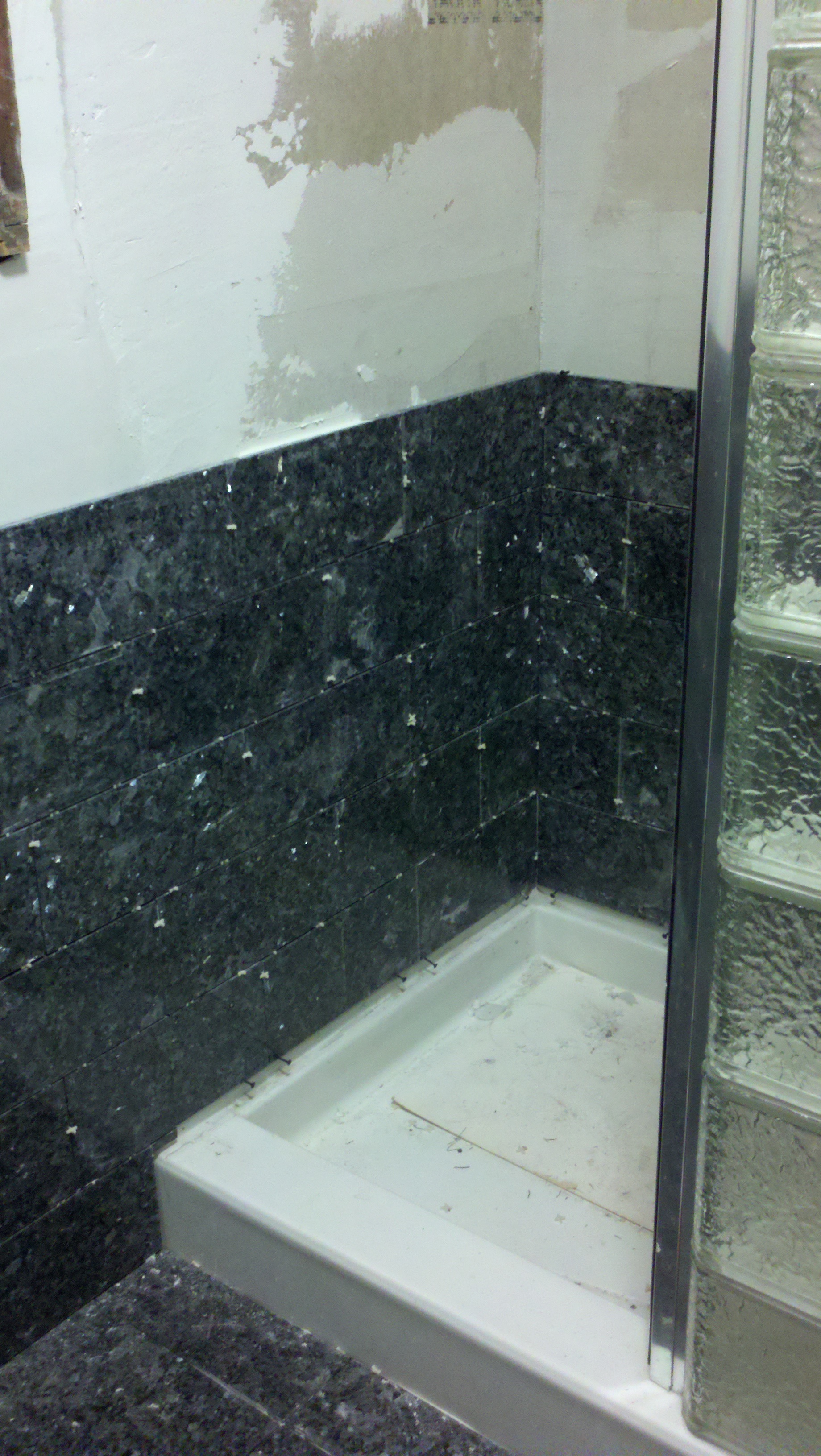

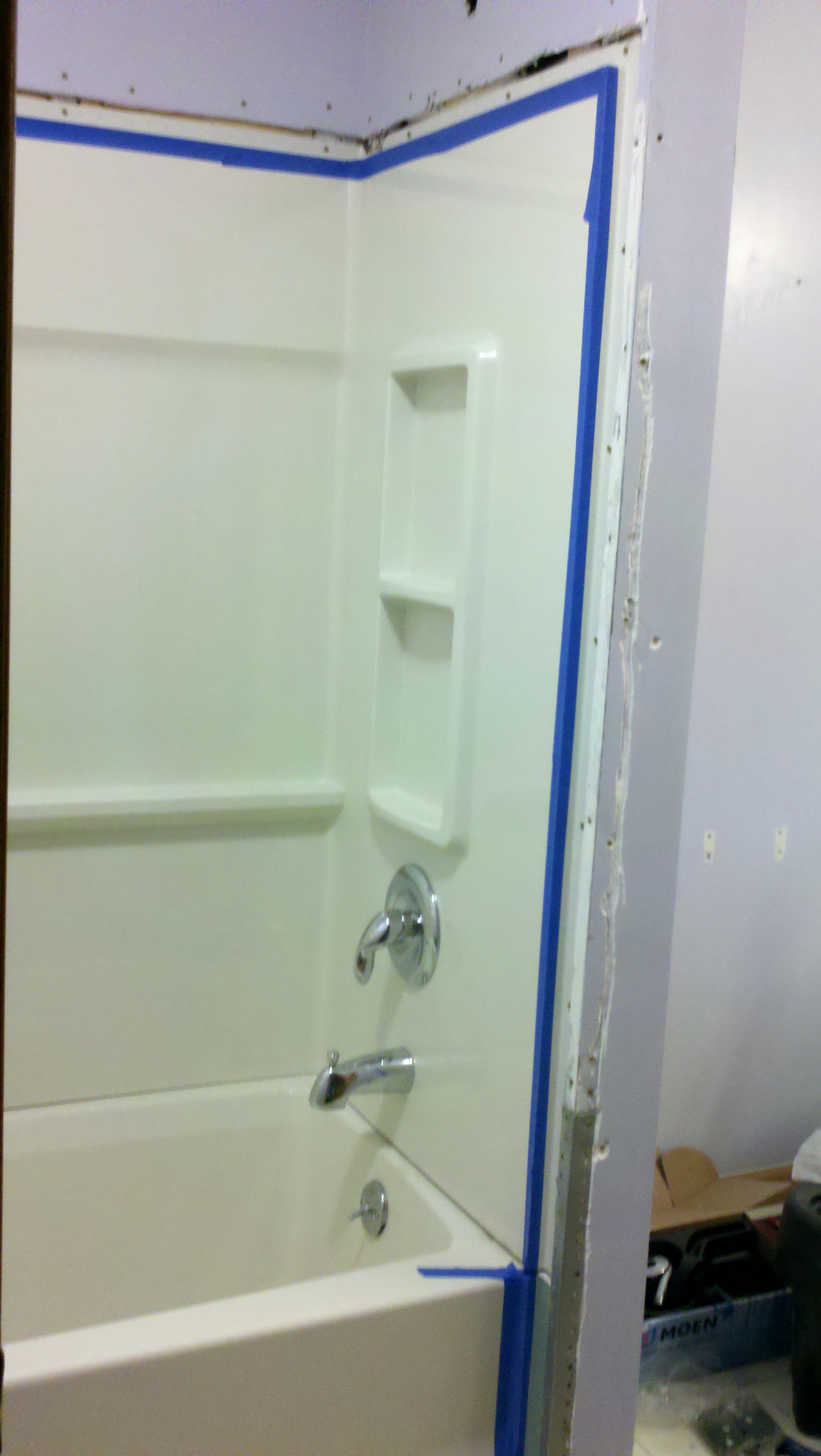

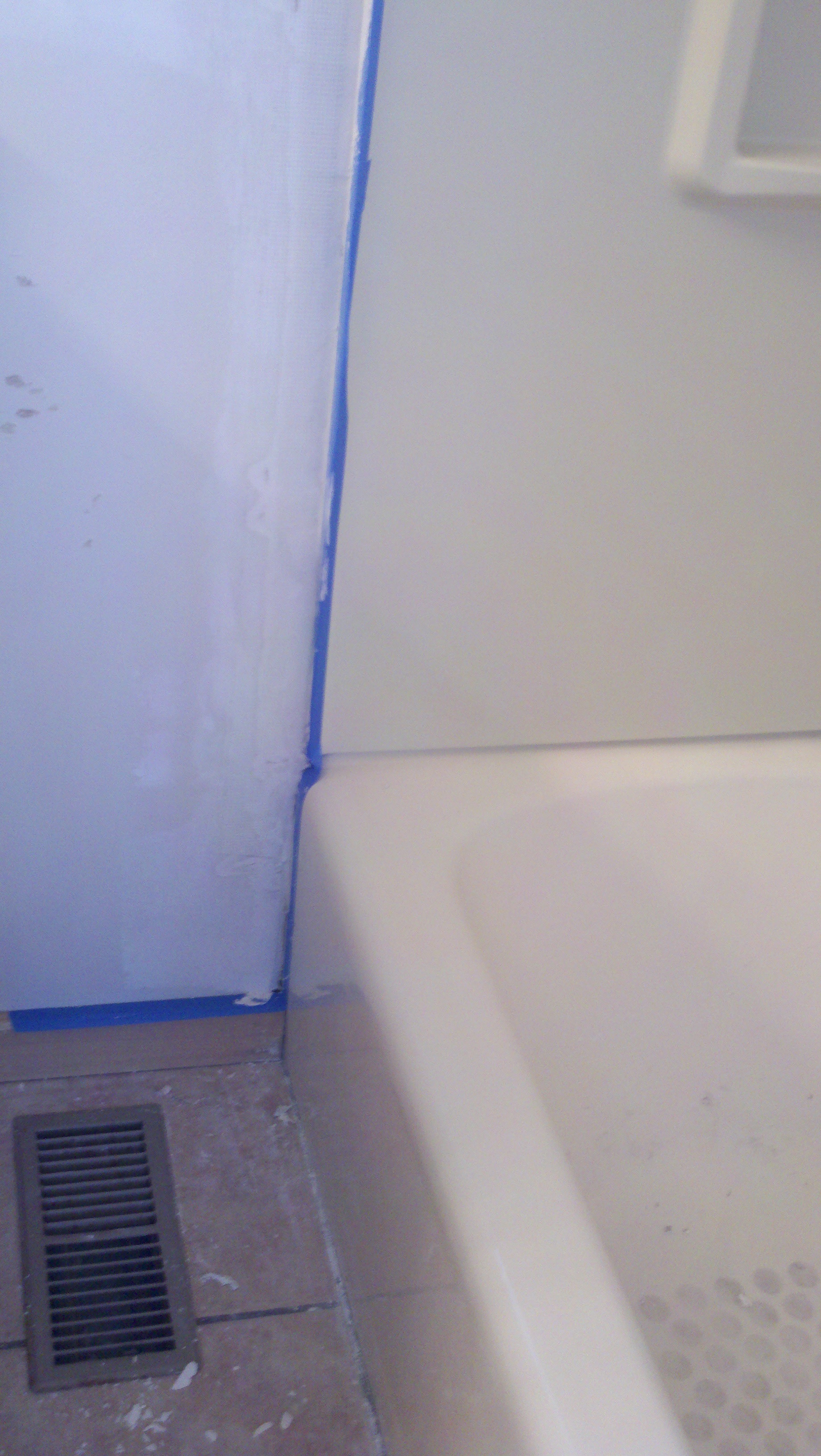

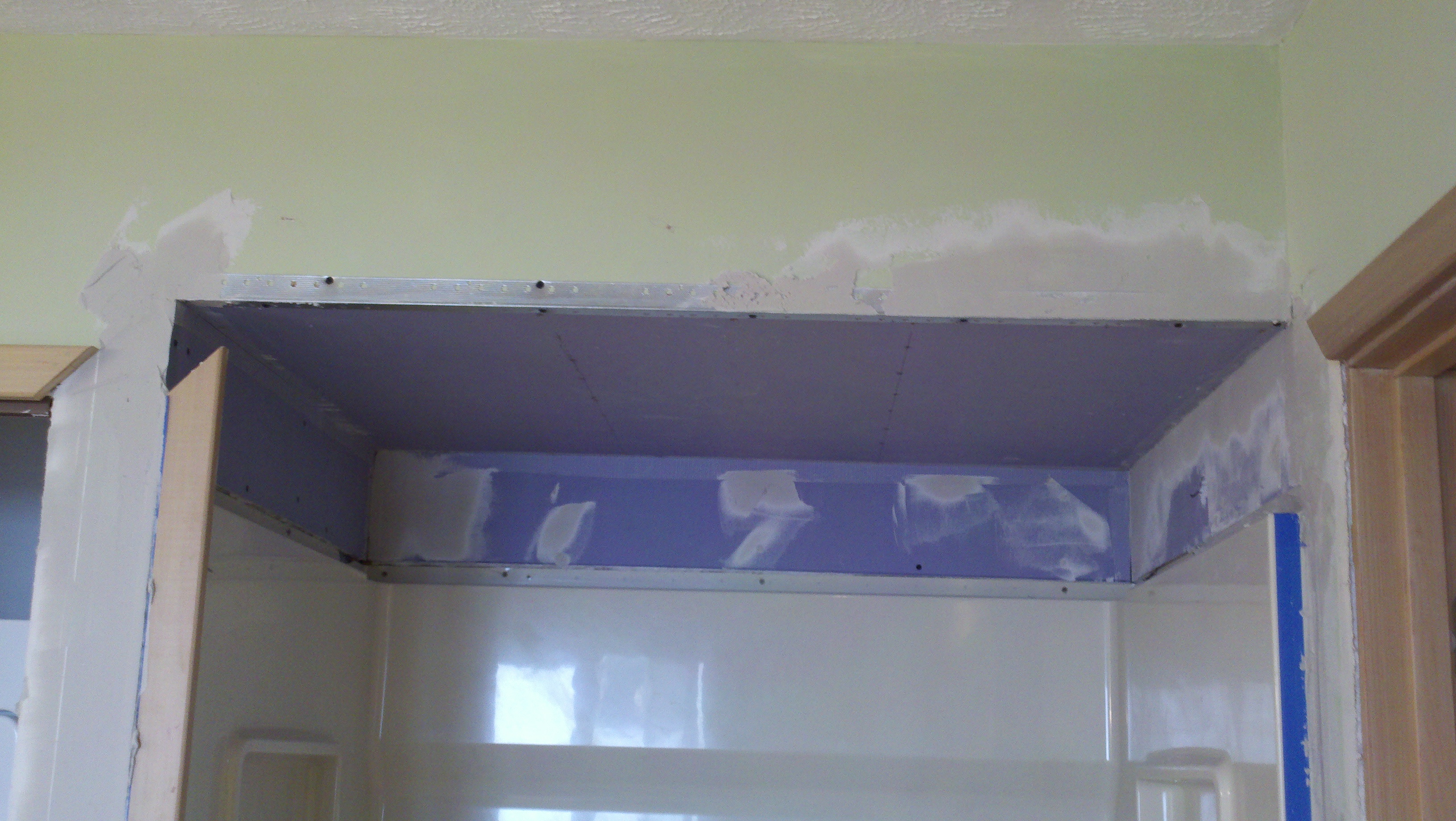

Shower Walls Replacement, Ceiling Alteration, & ExactTemp

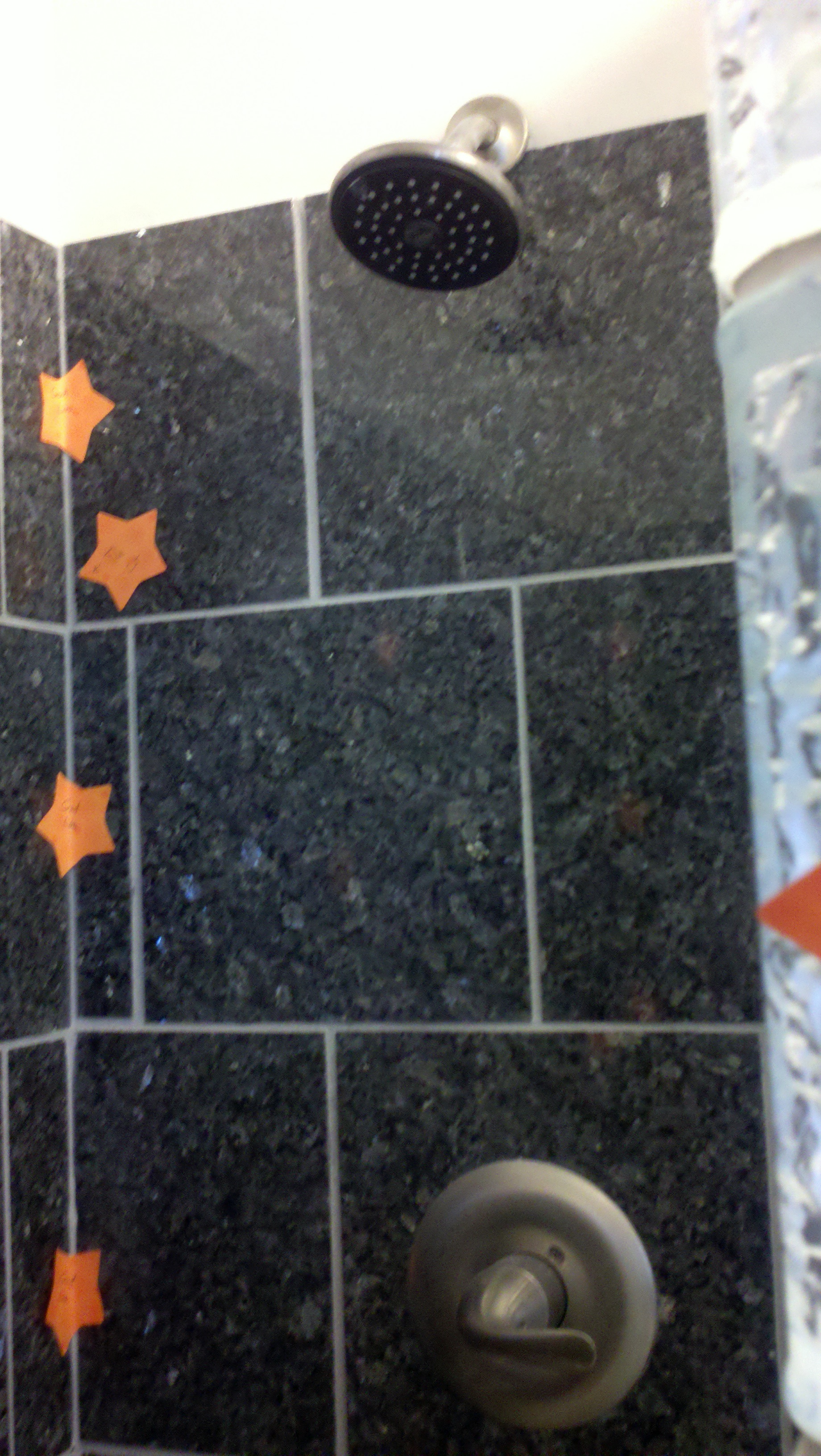

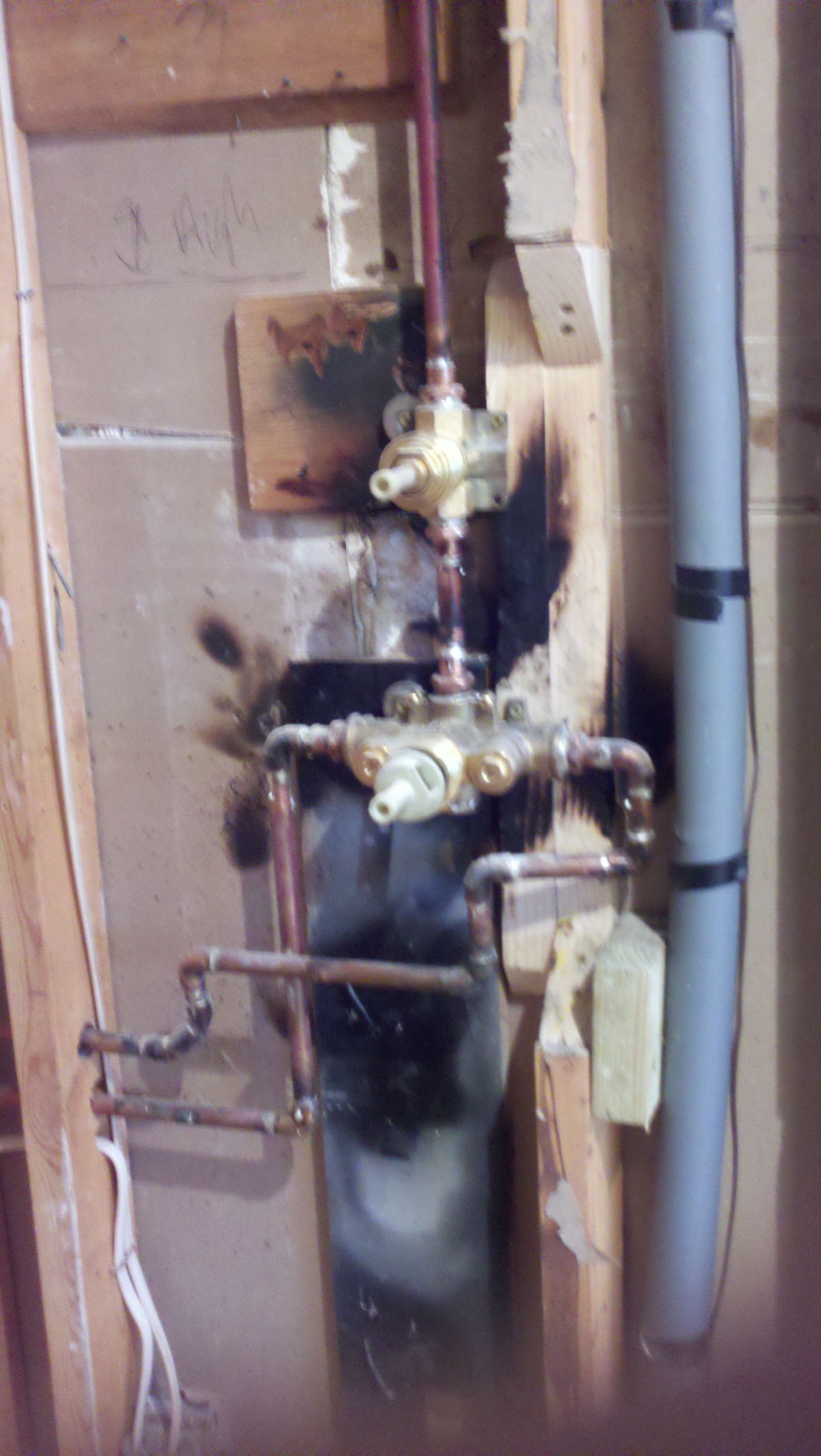

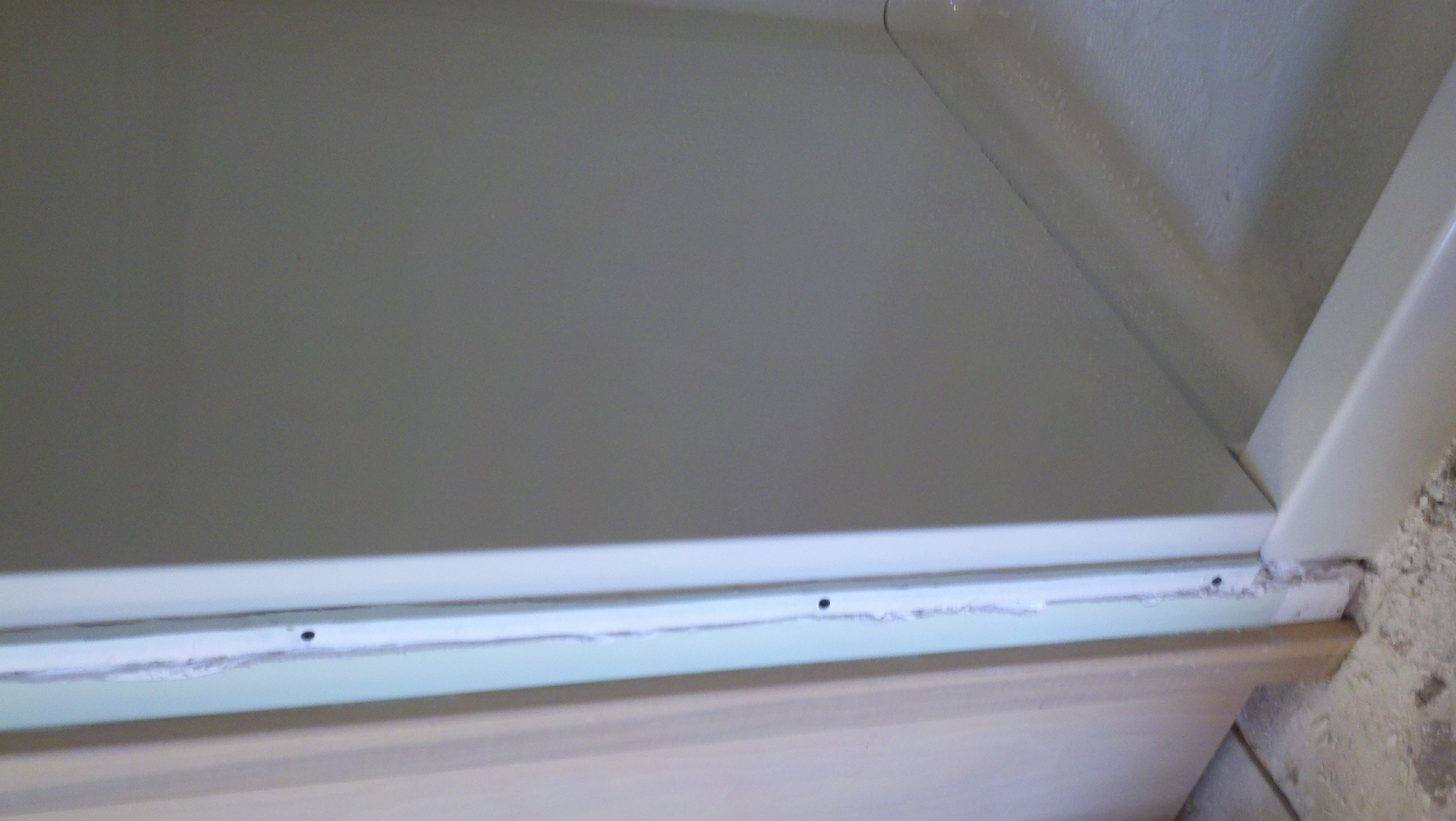

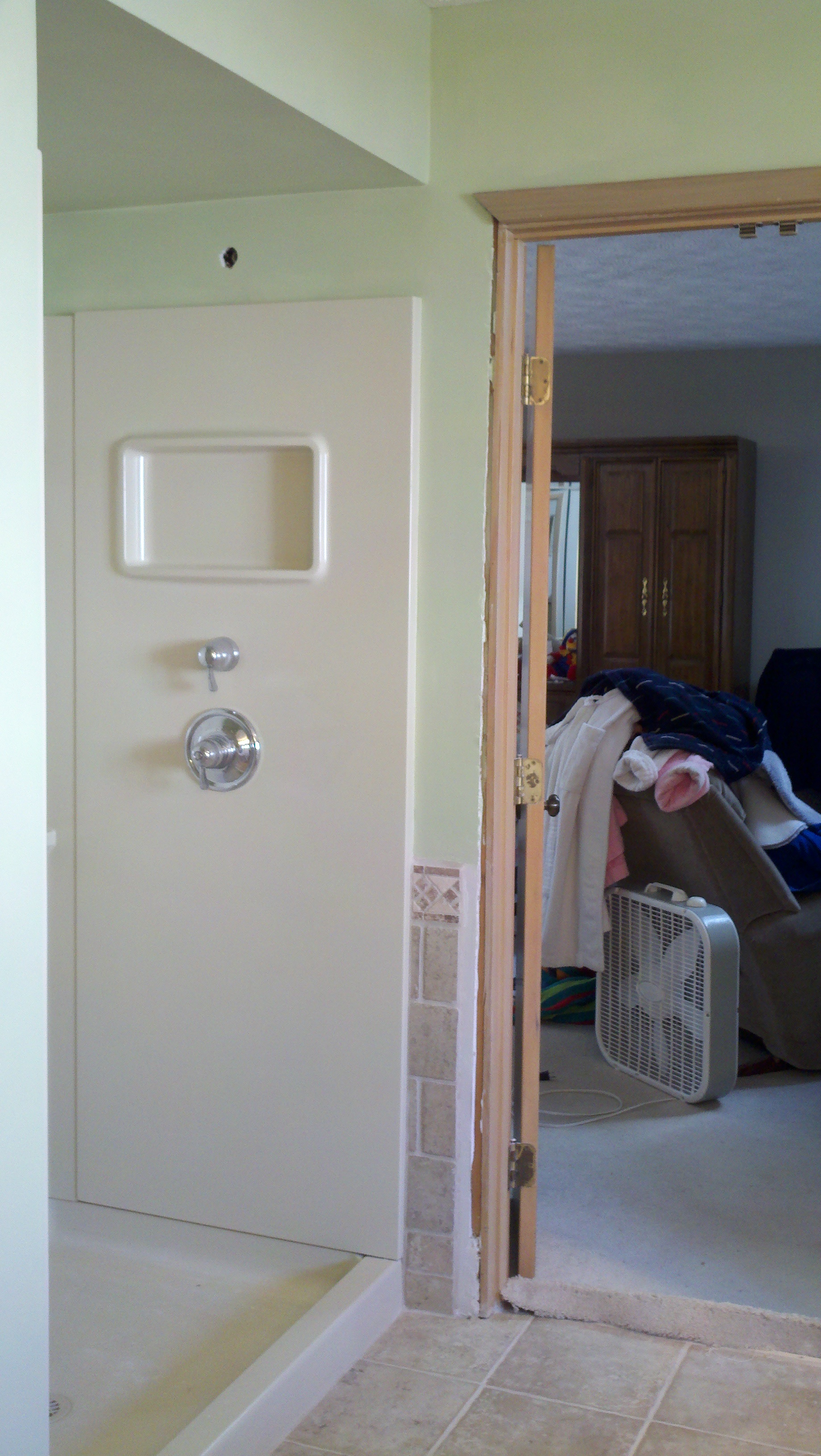

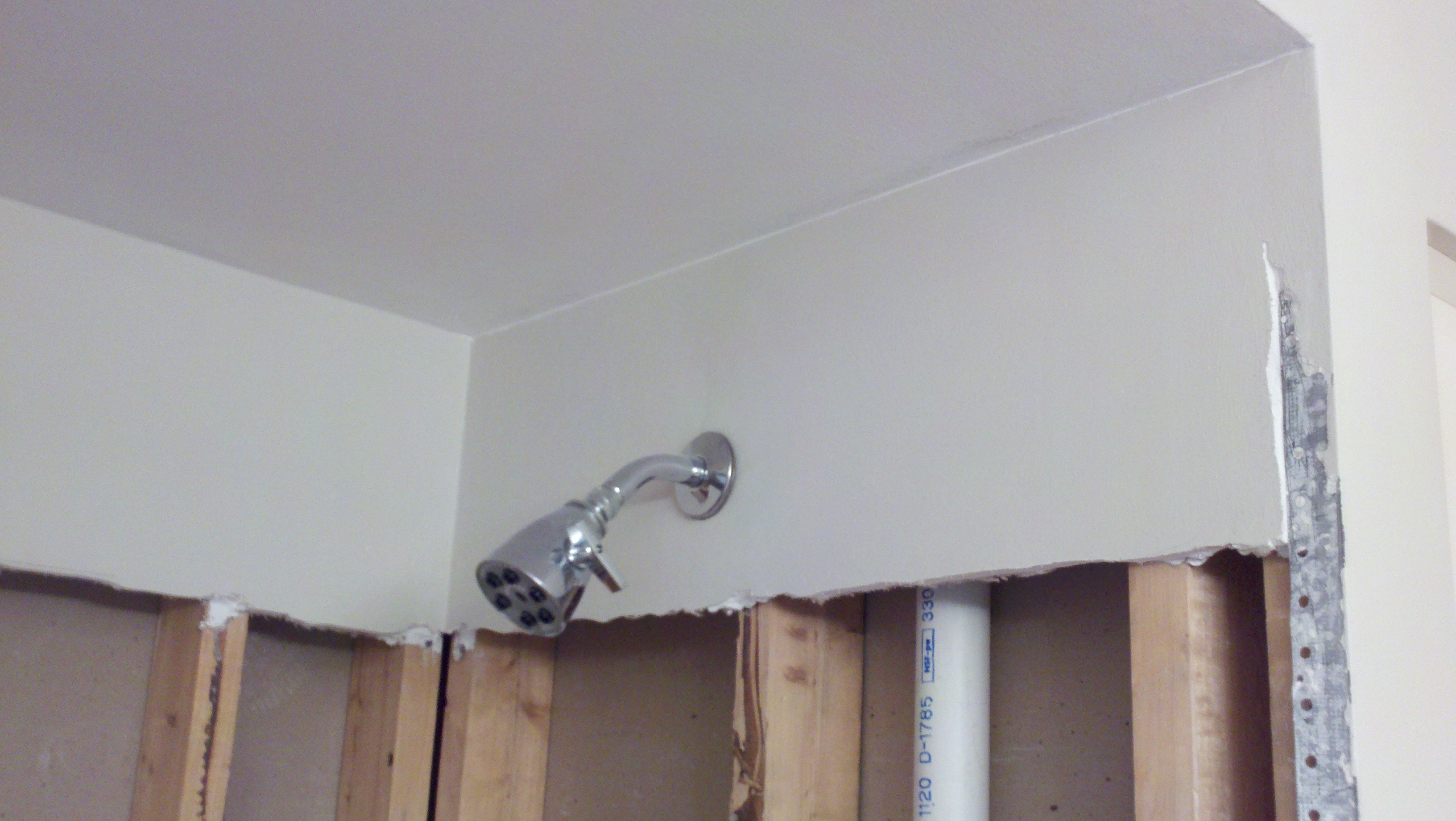

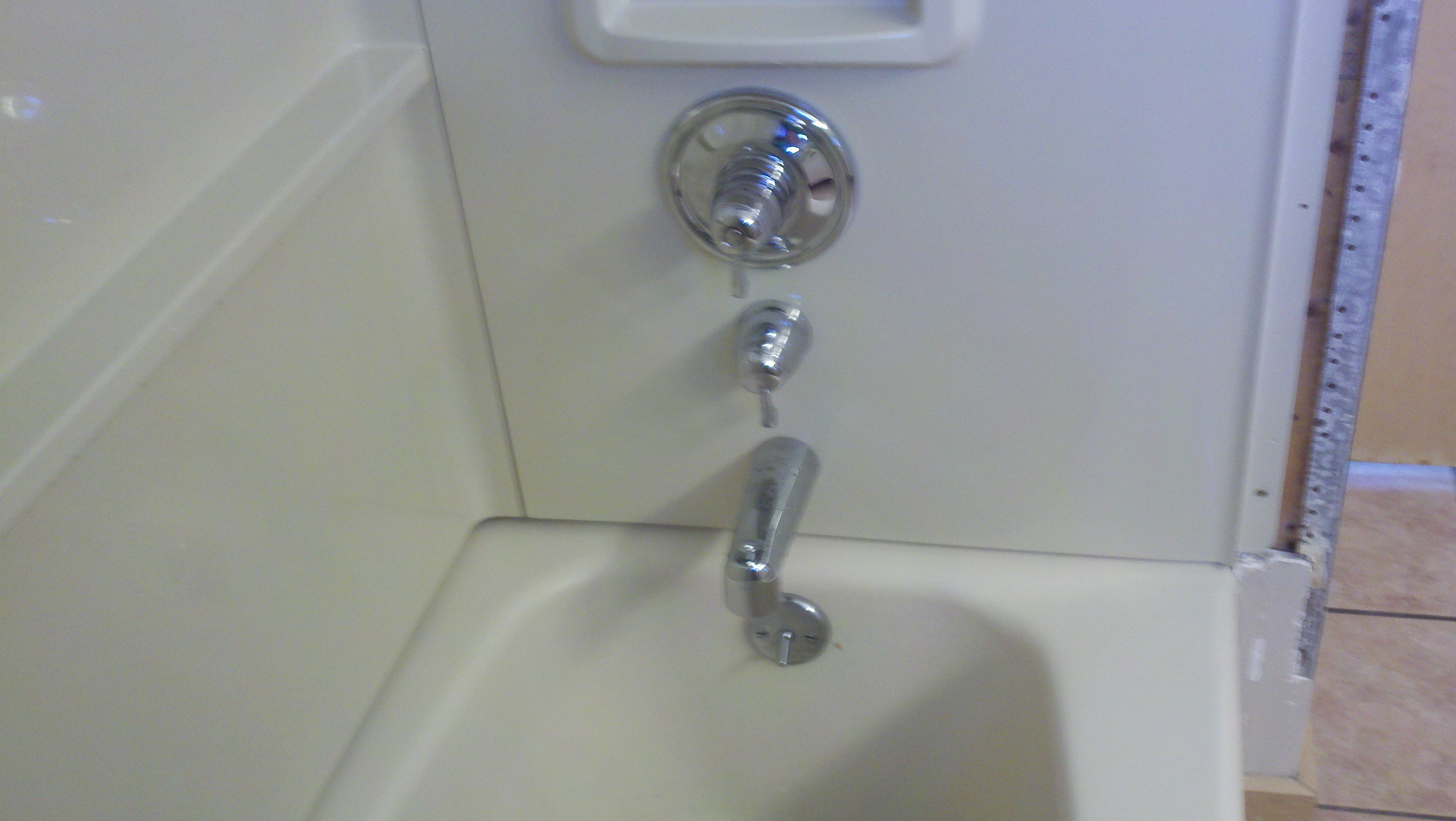

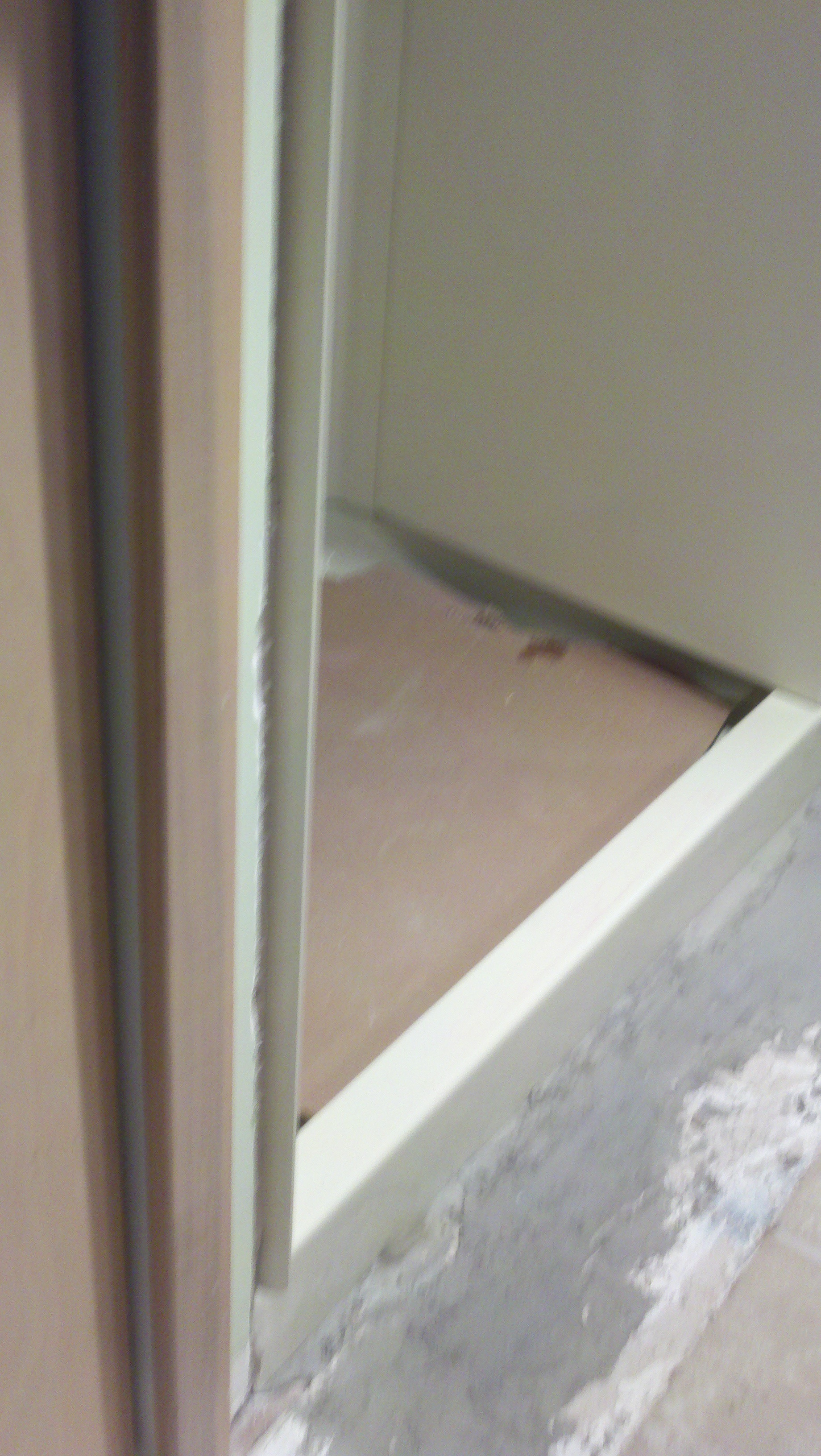

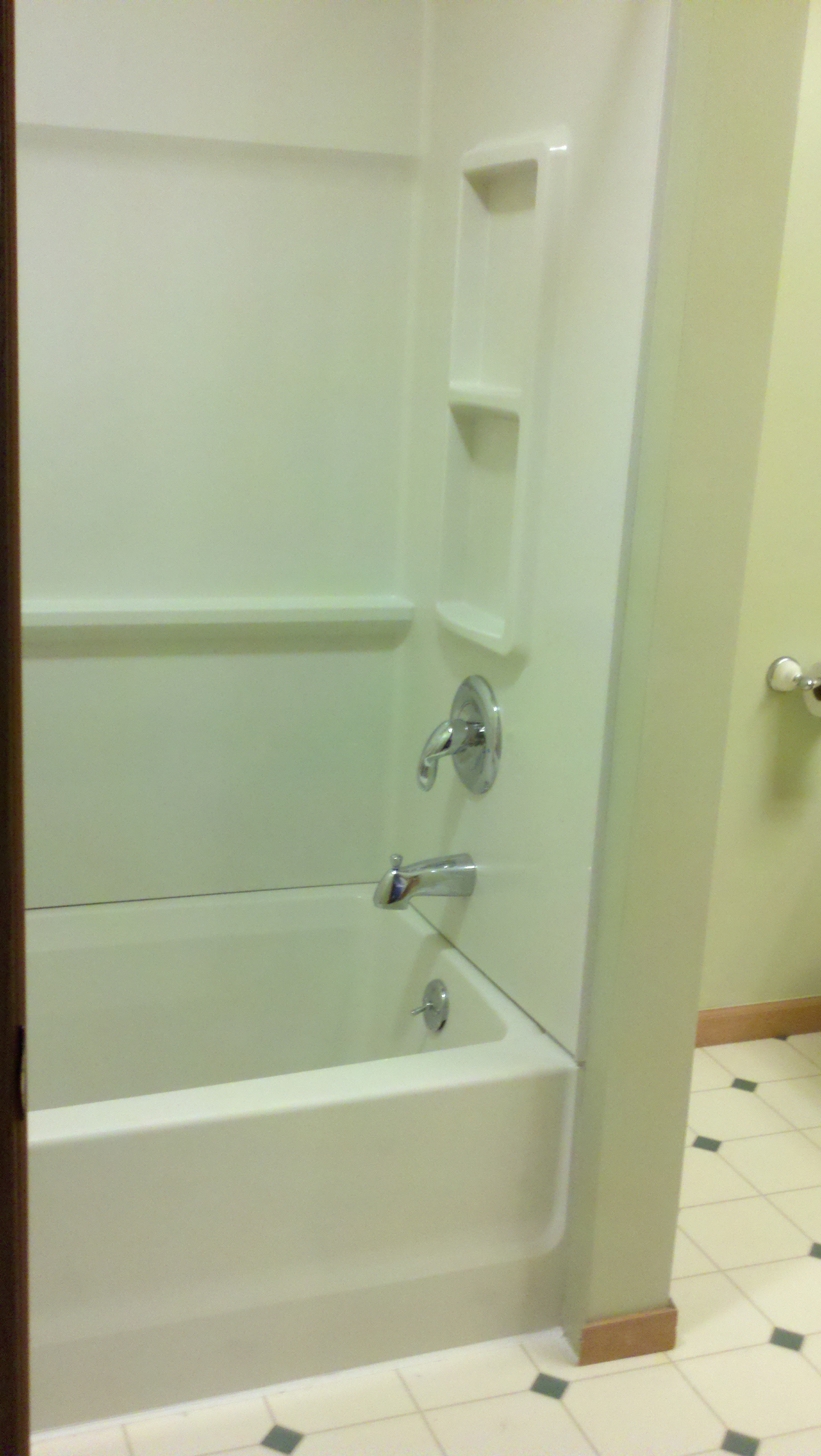

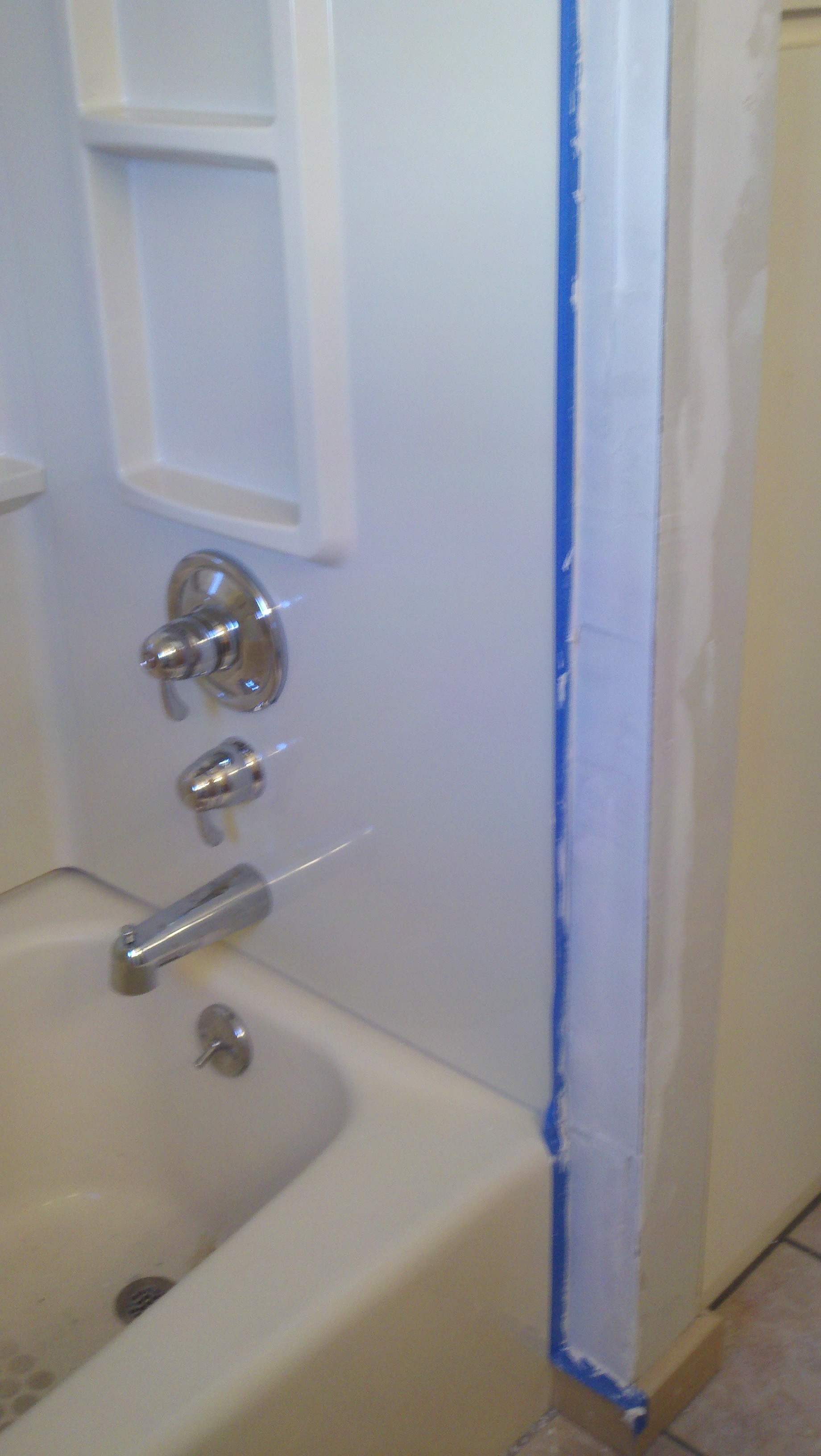

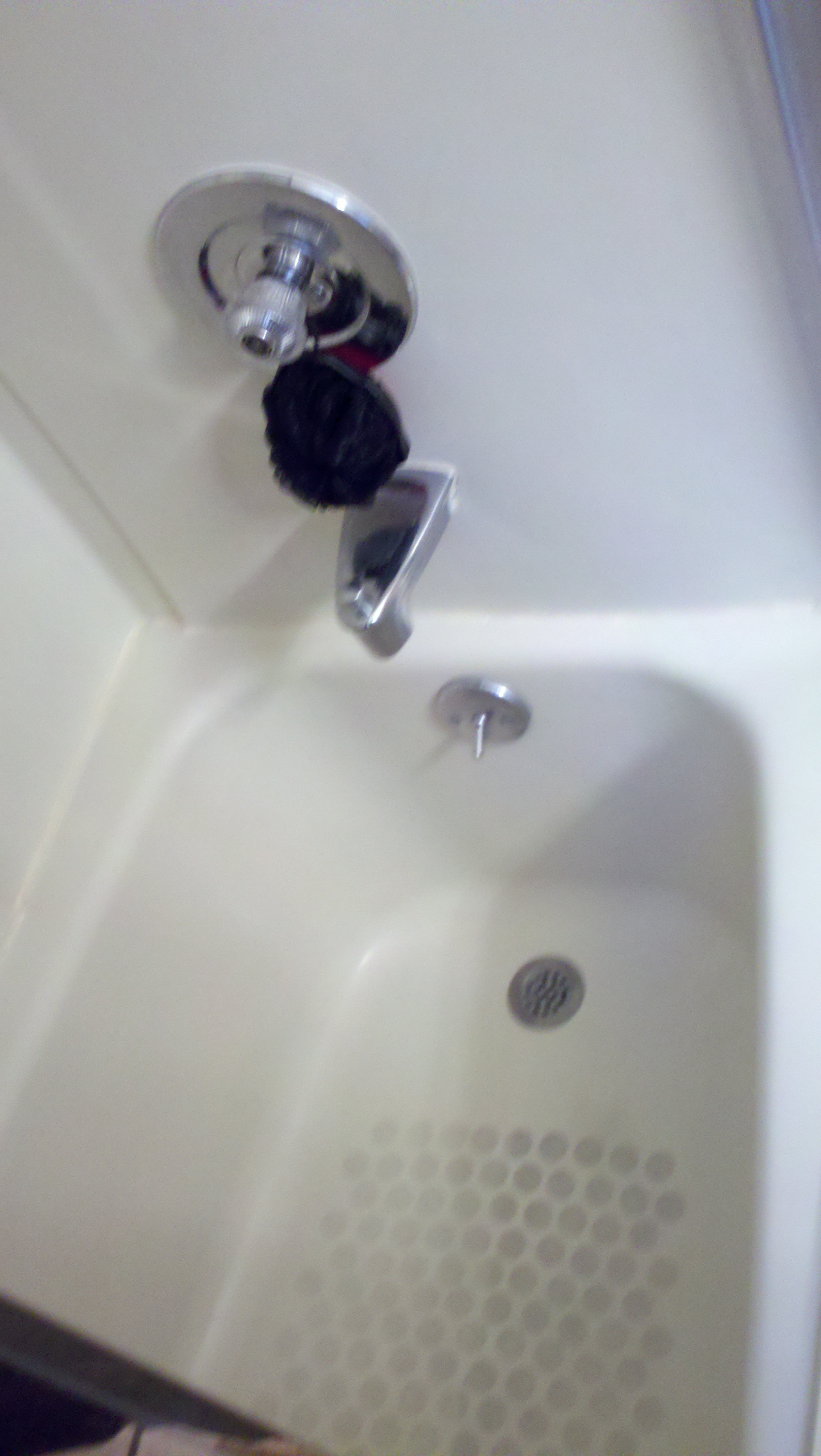

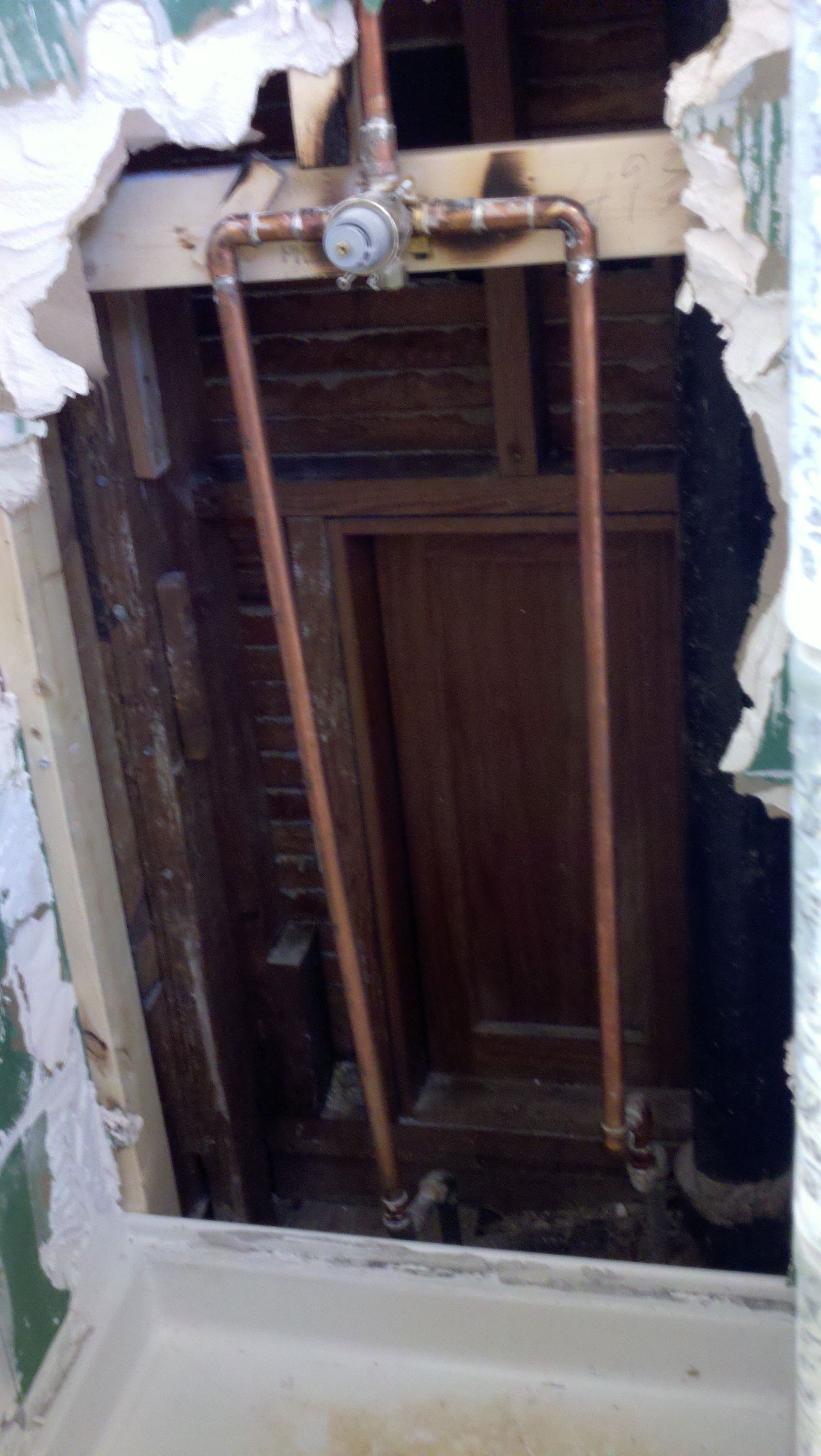

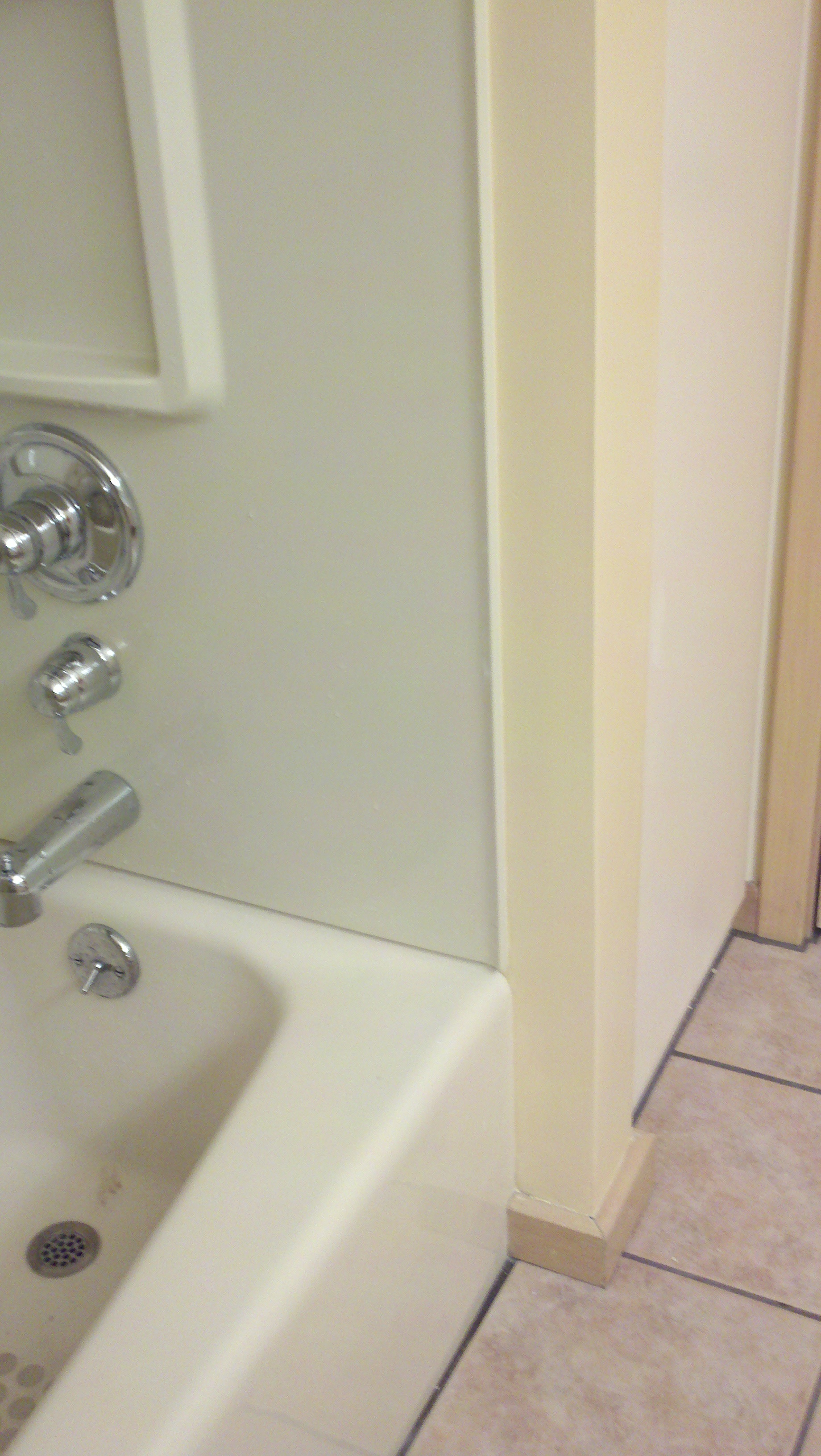

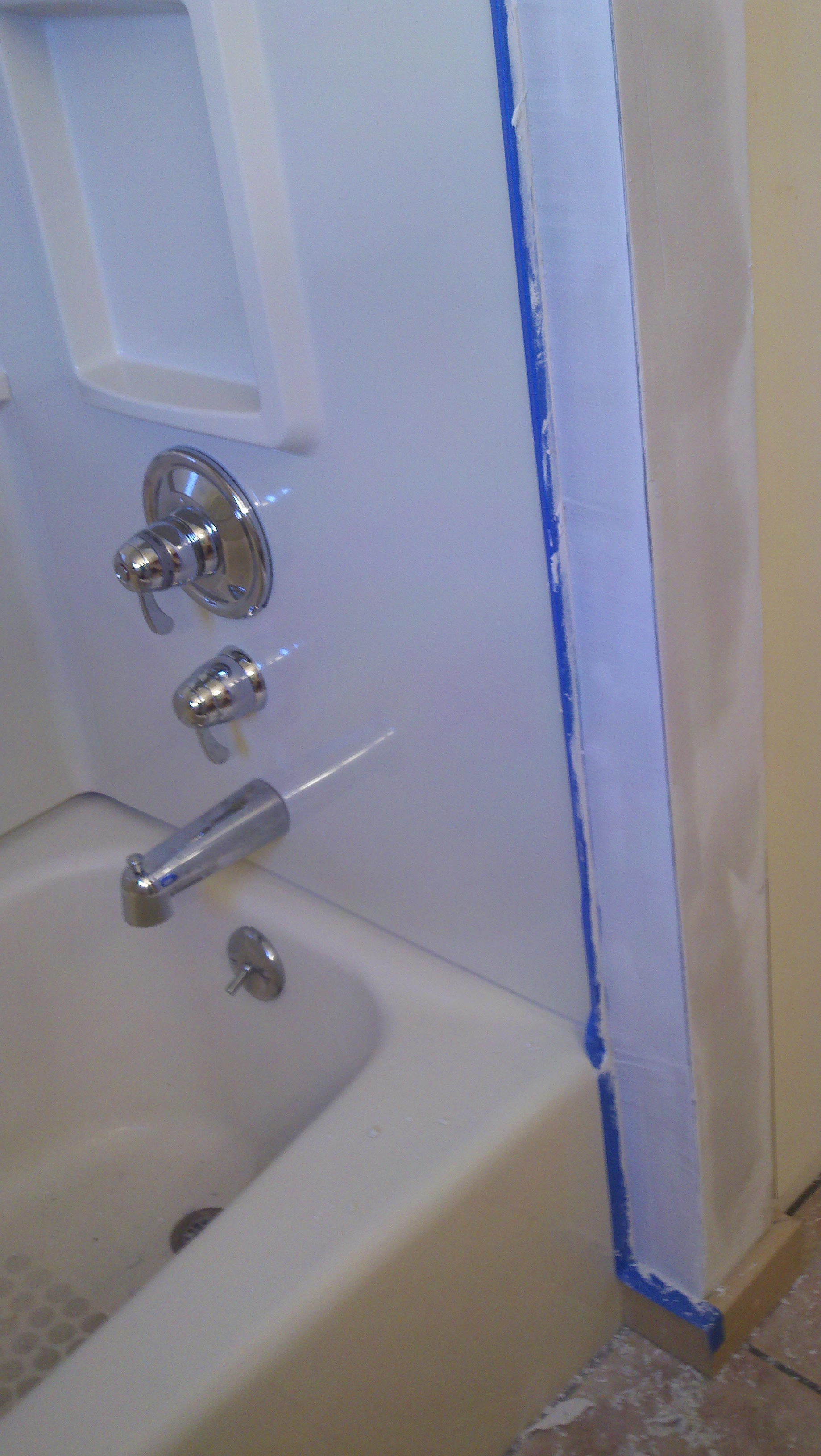

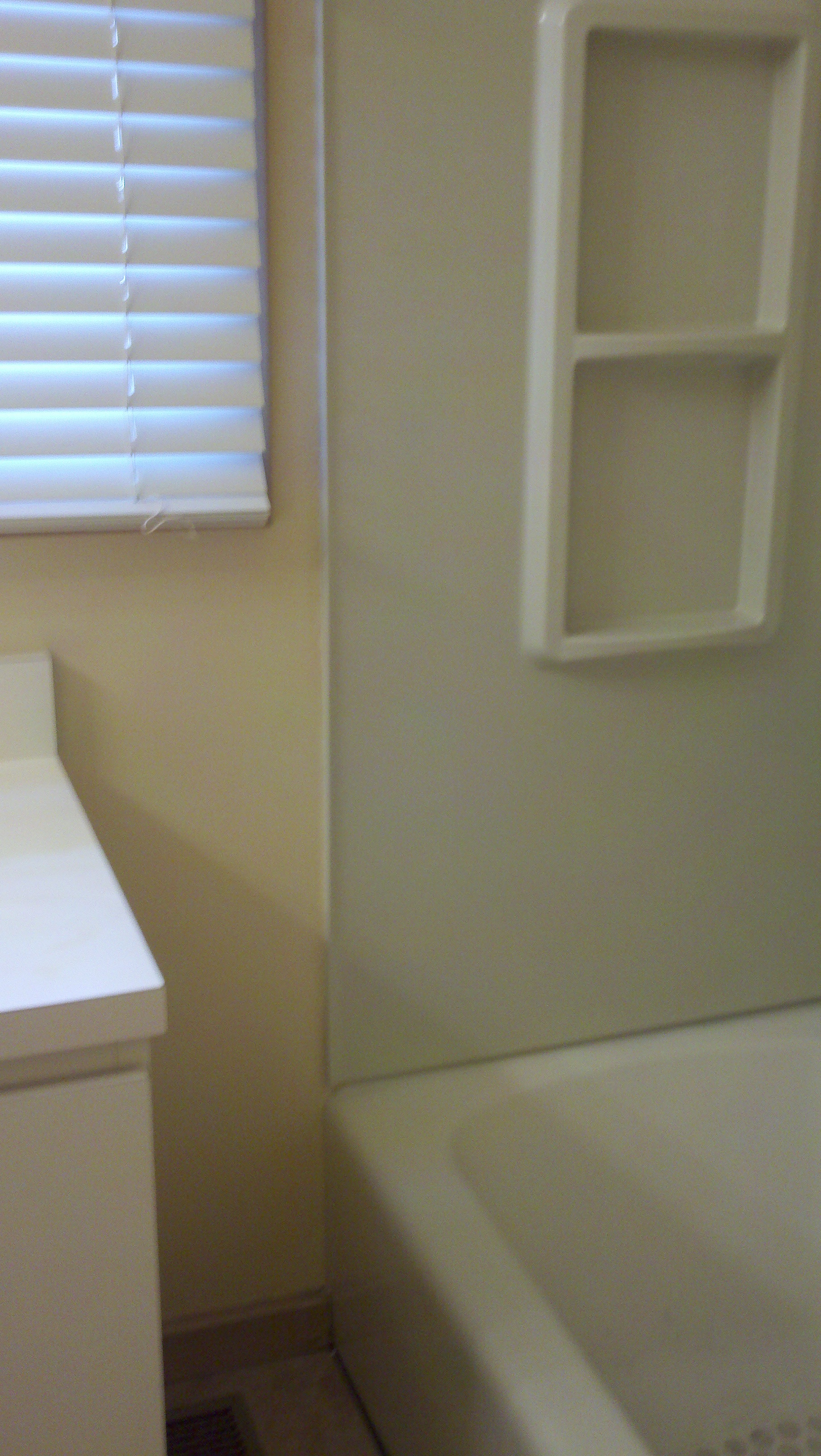

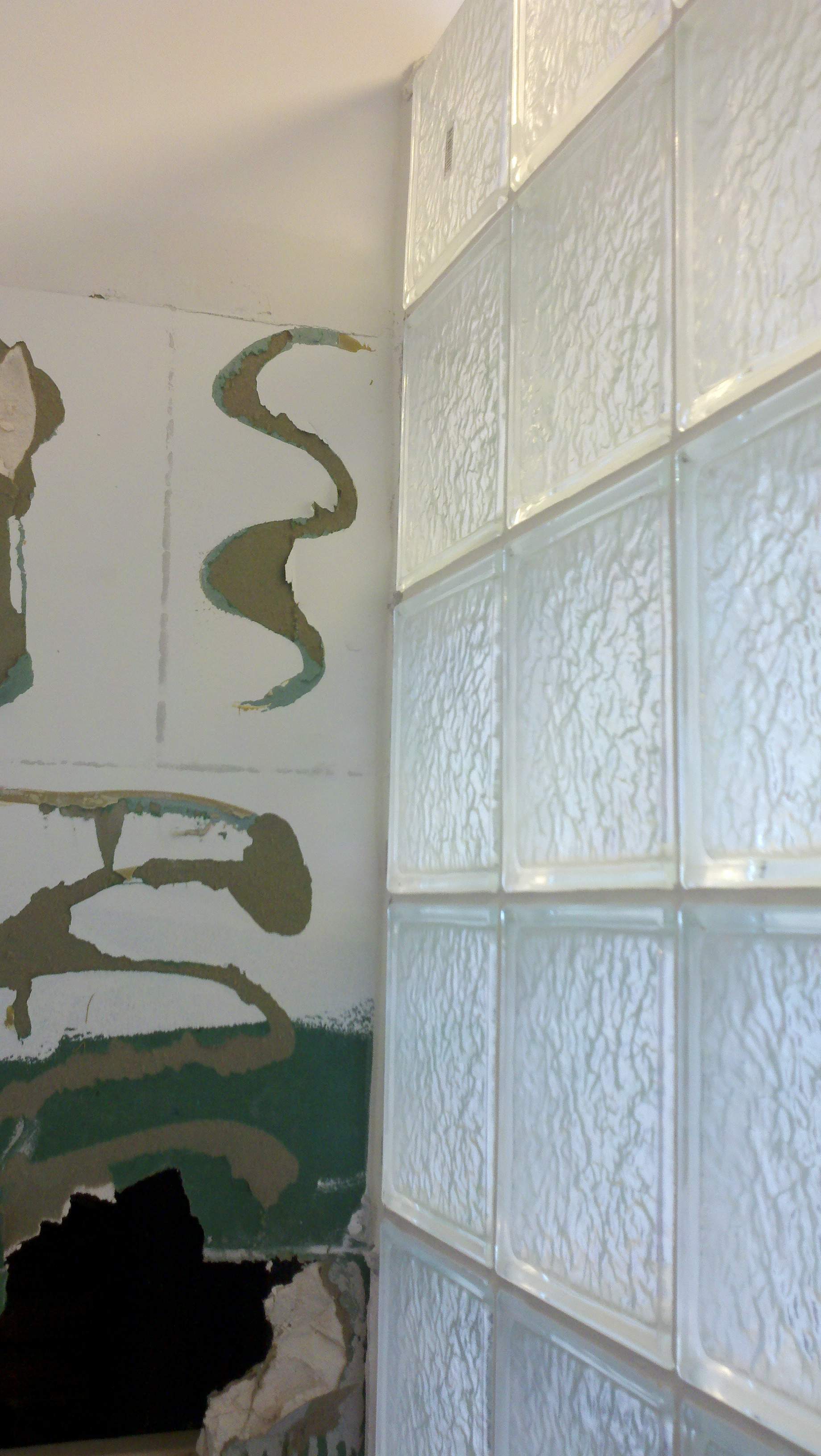

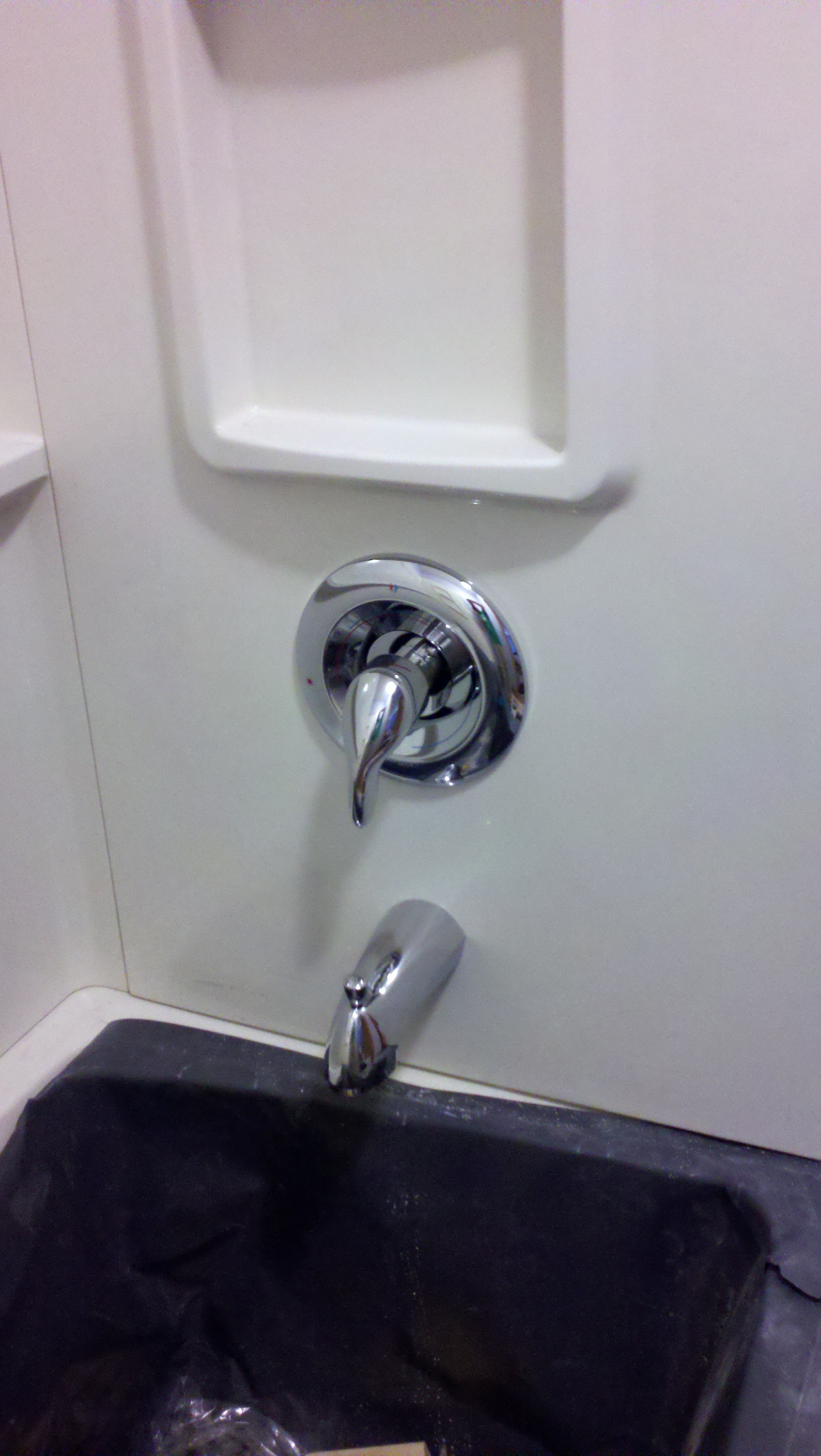

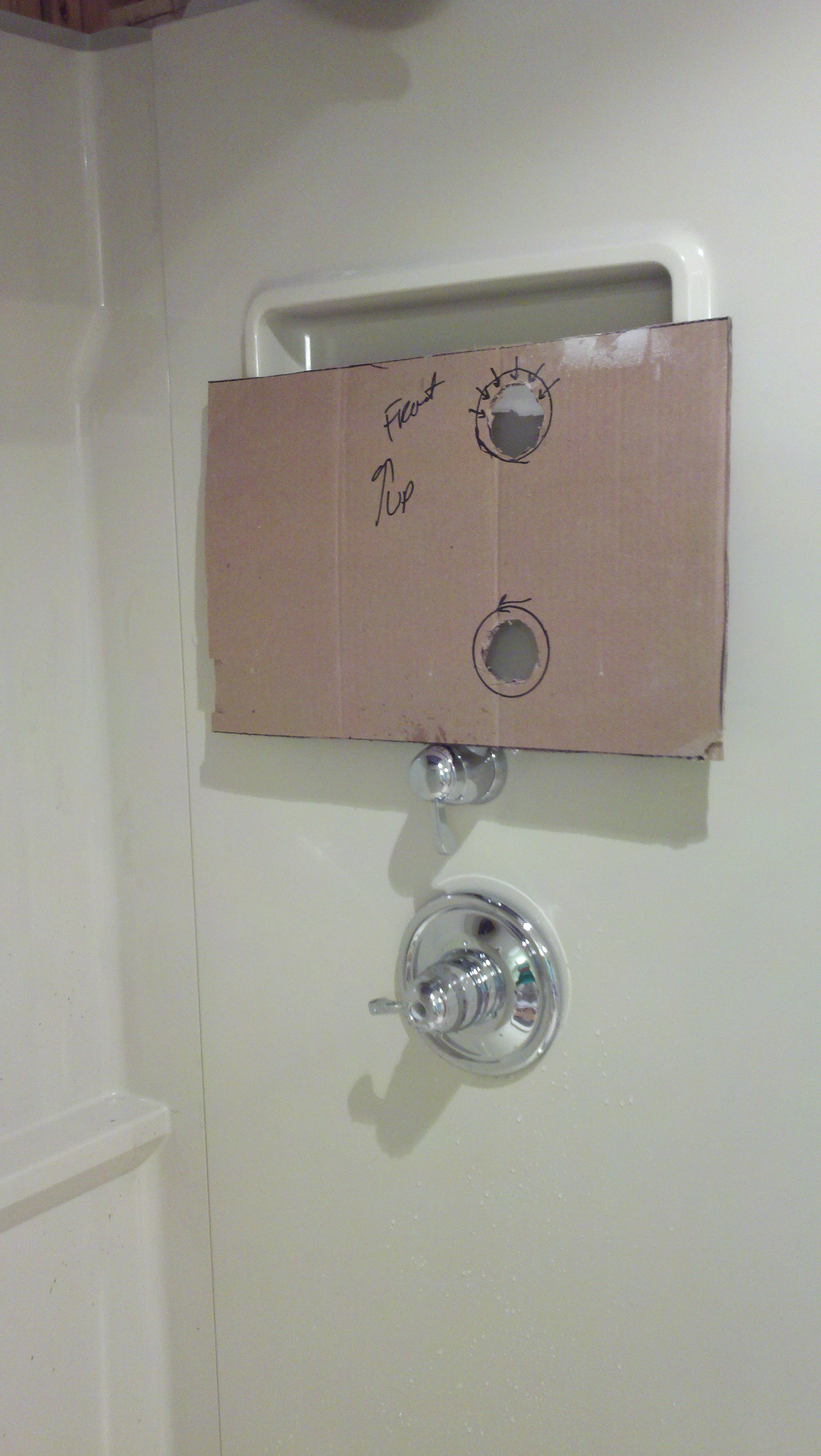

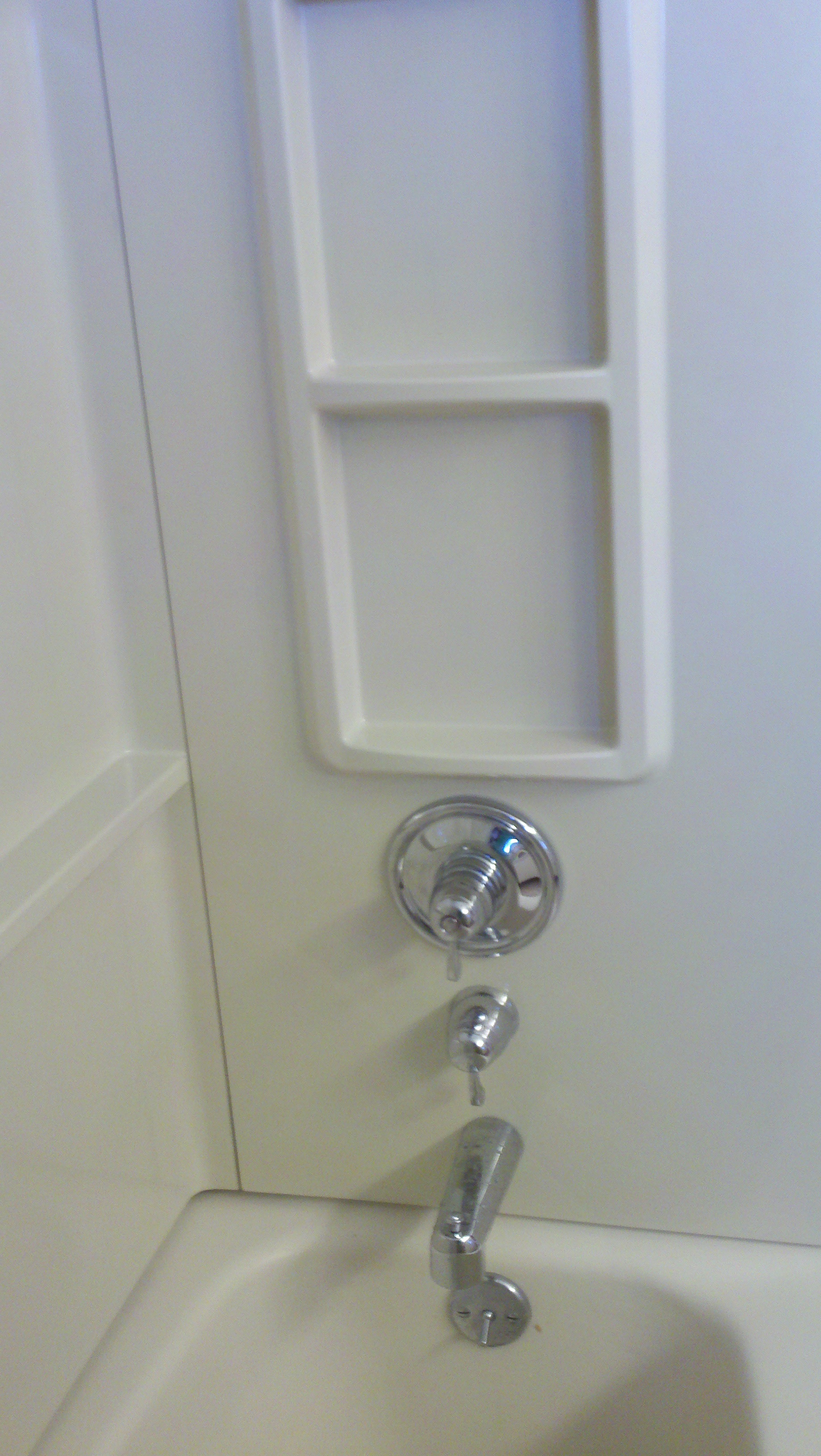

Thermostatic Faucet Installation
|

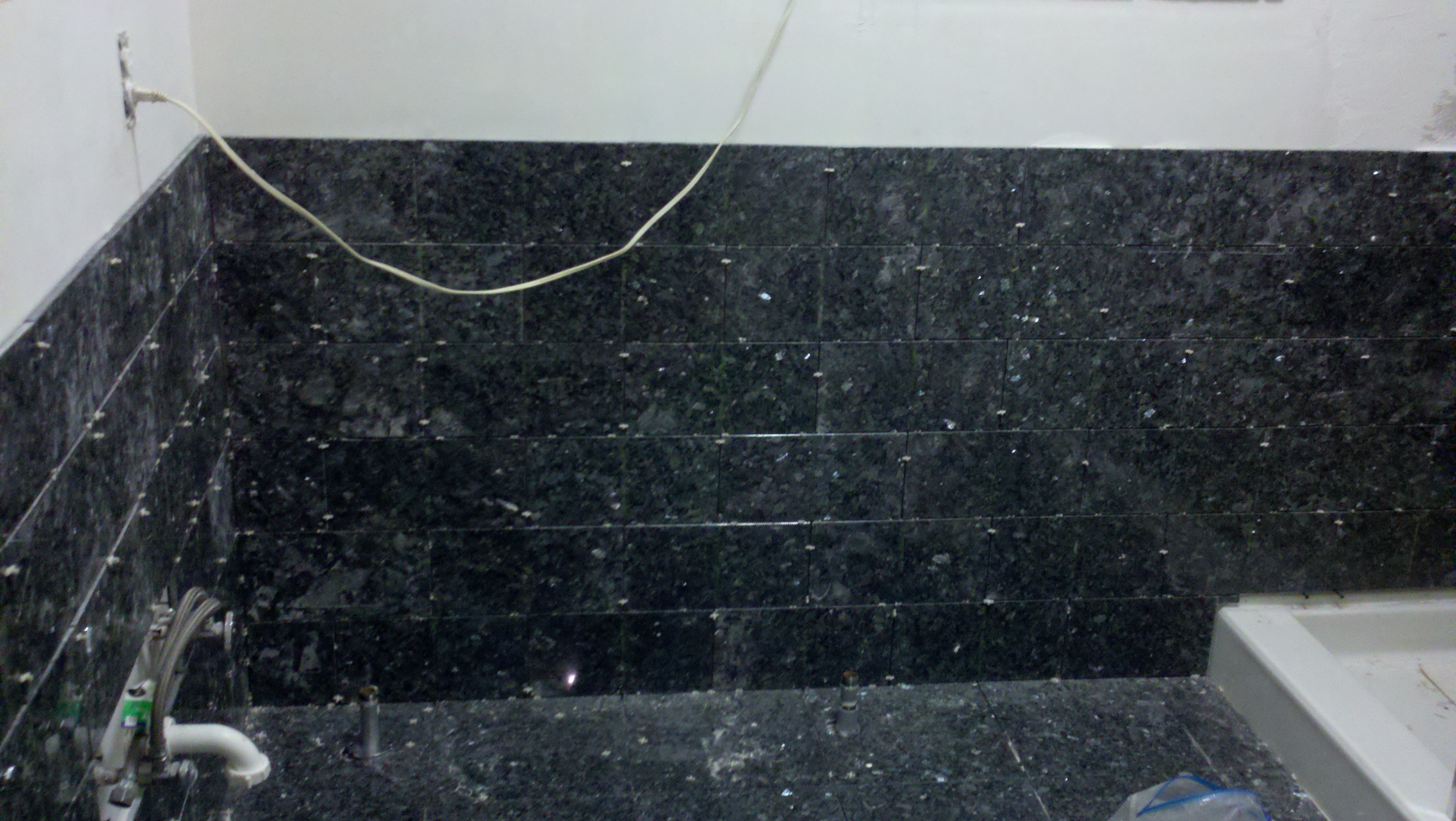

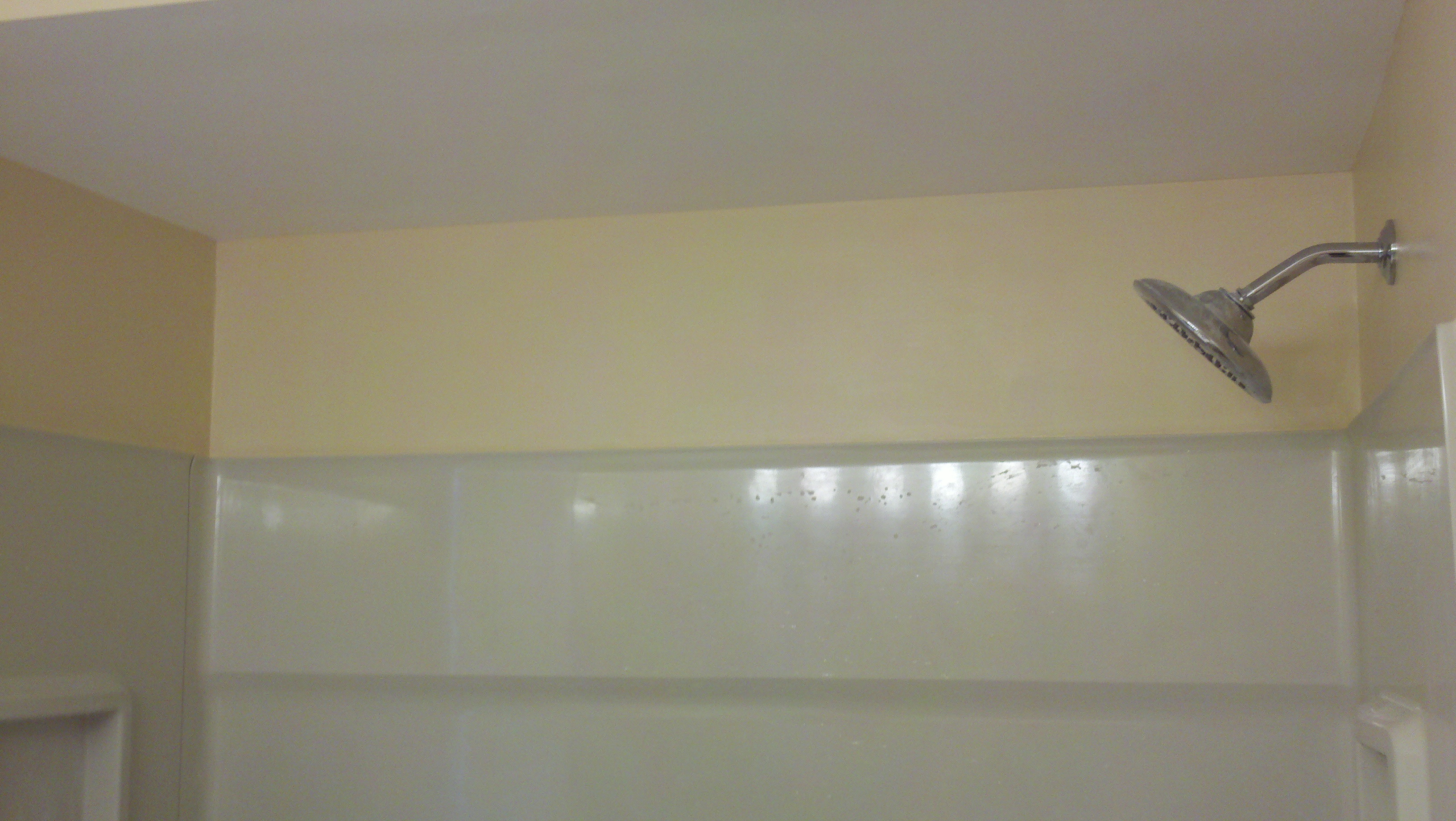

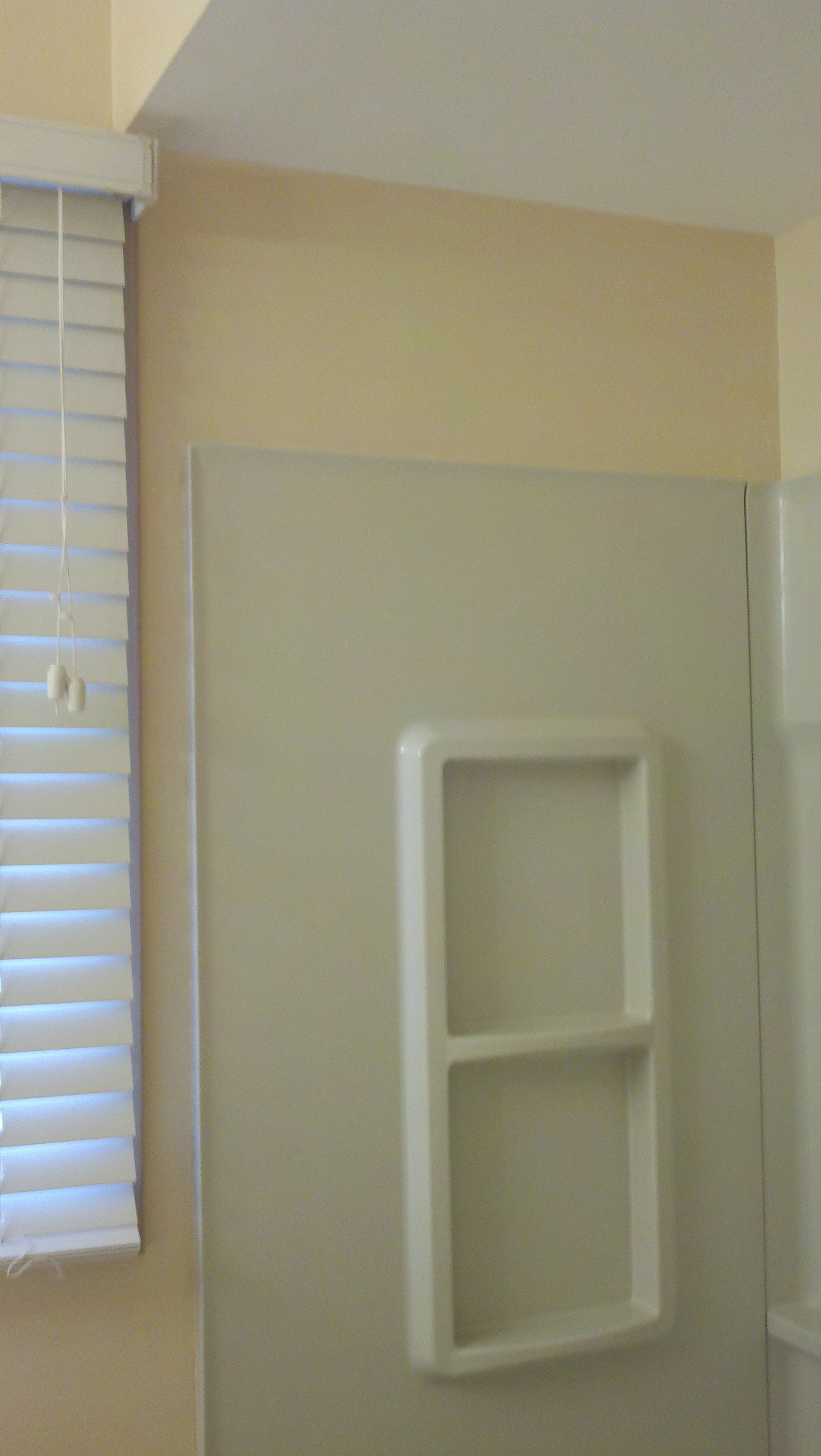

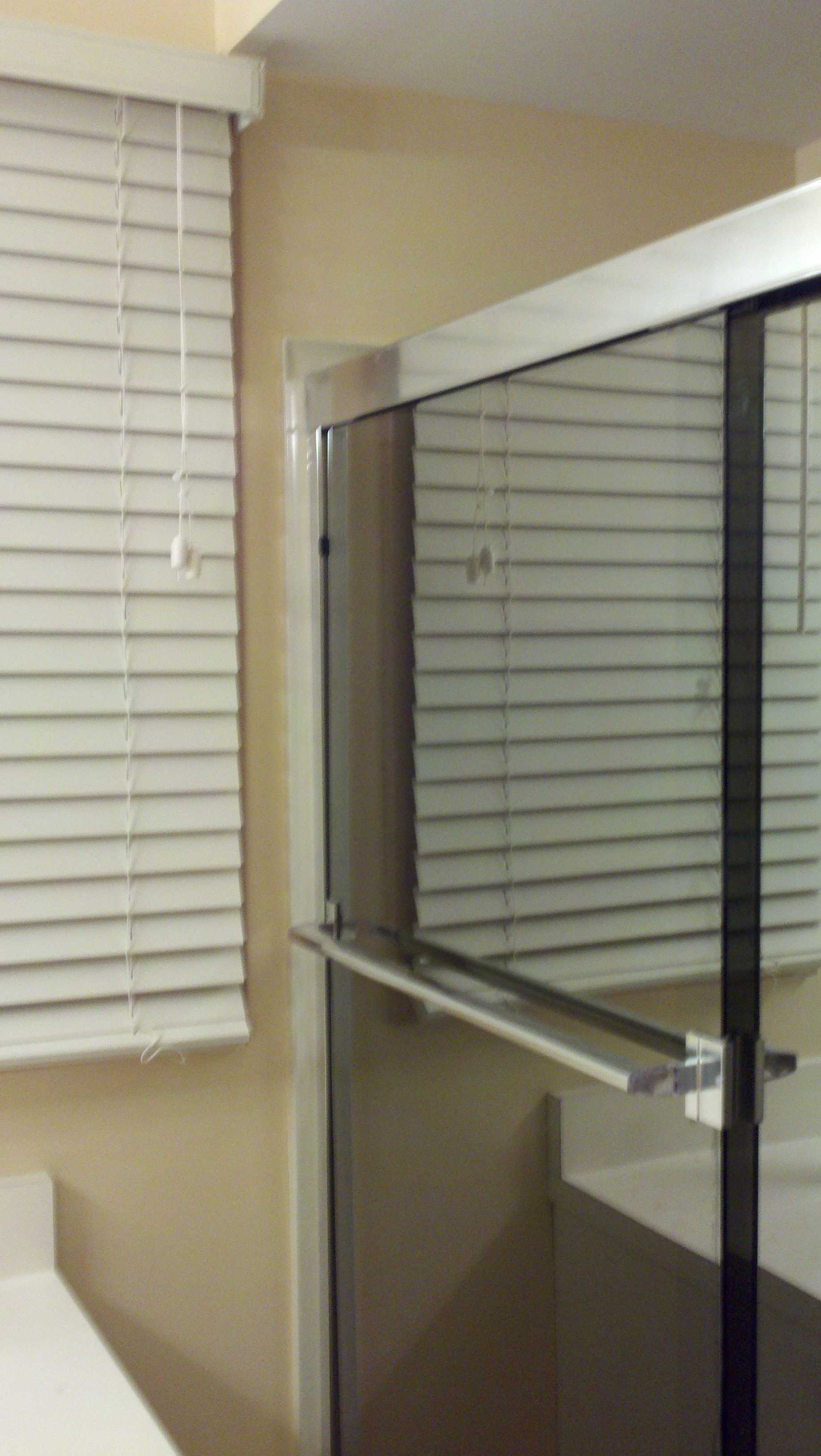

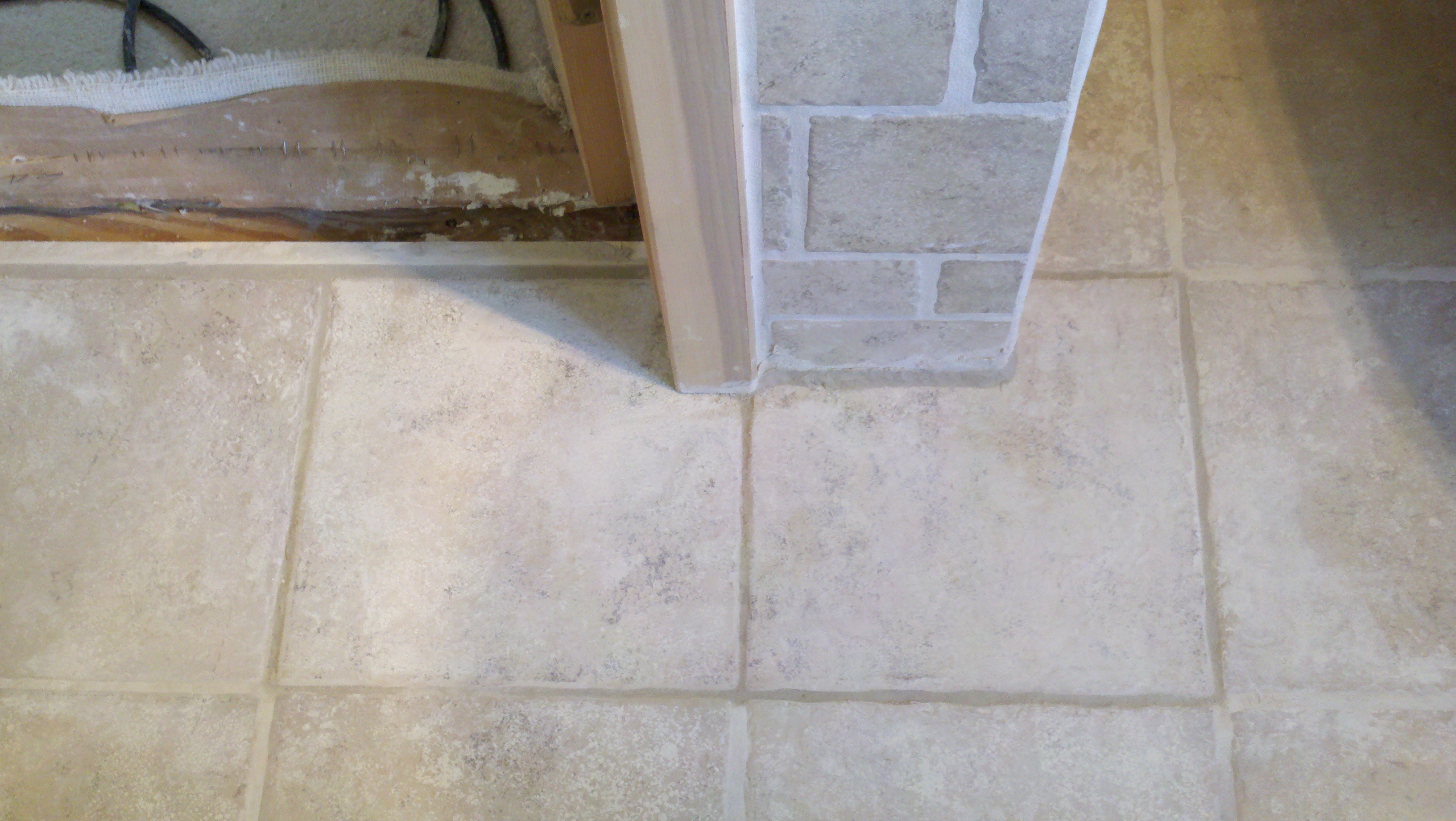

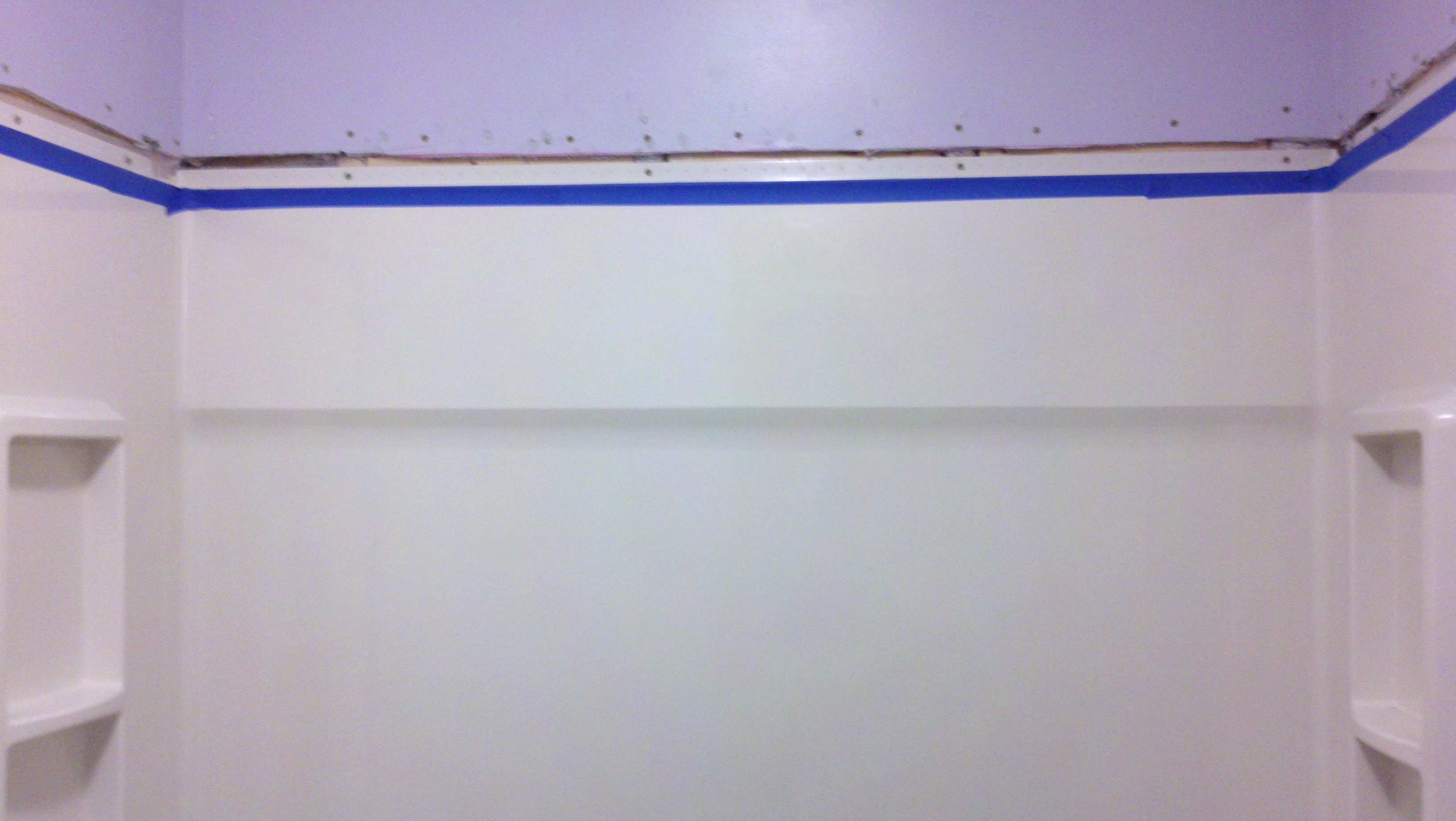

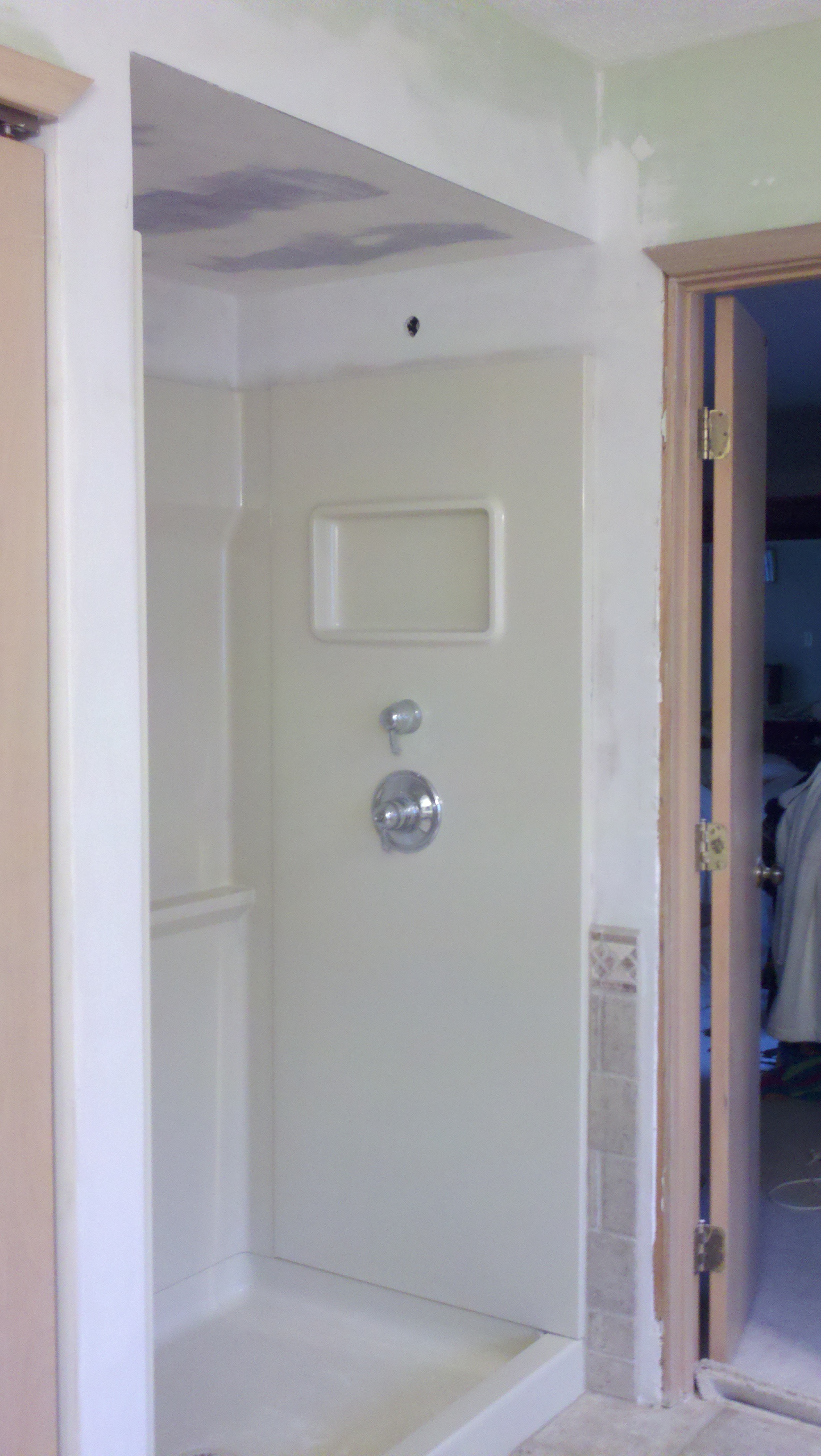

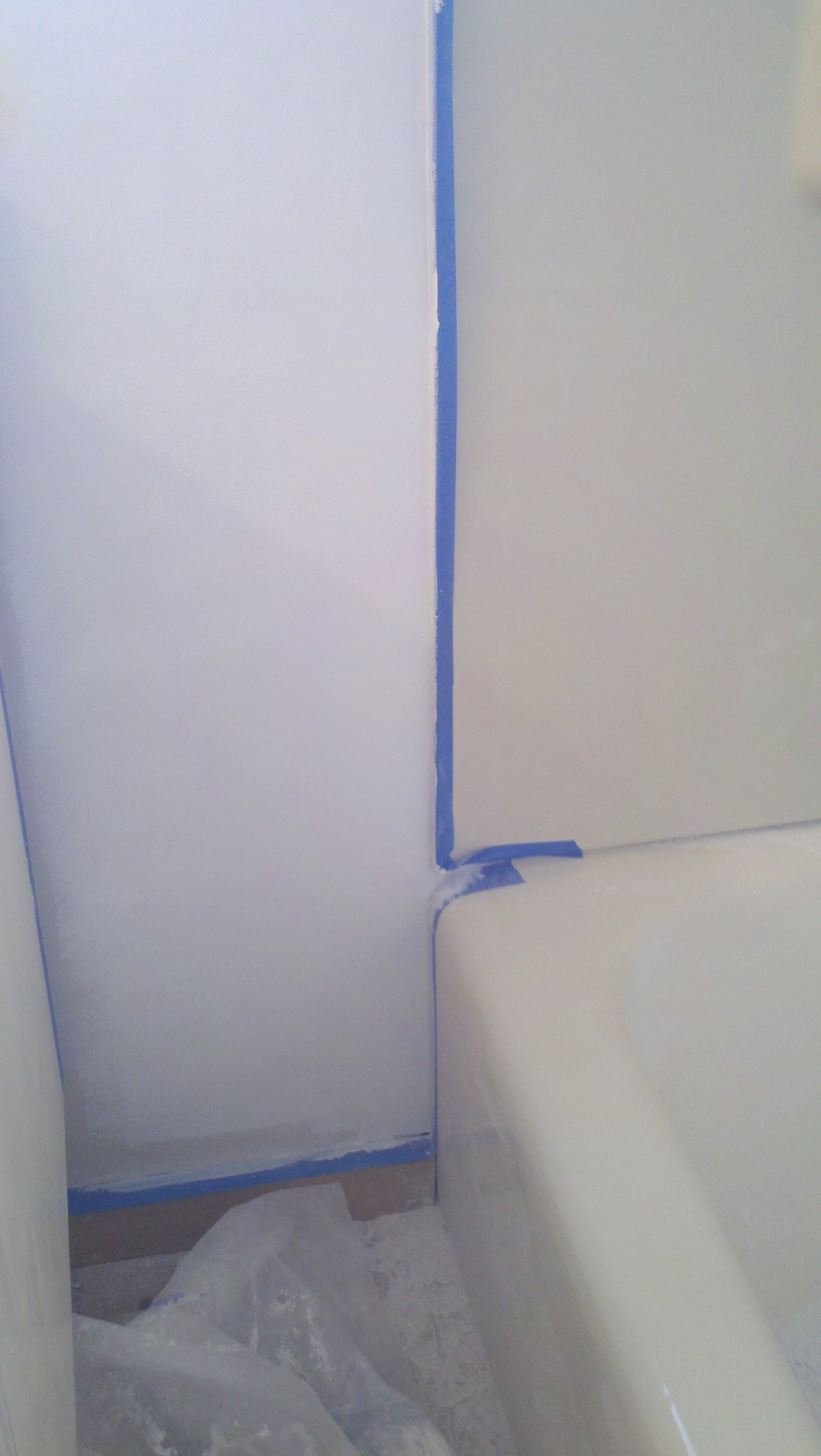

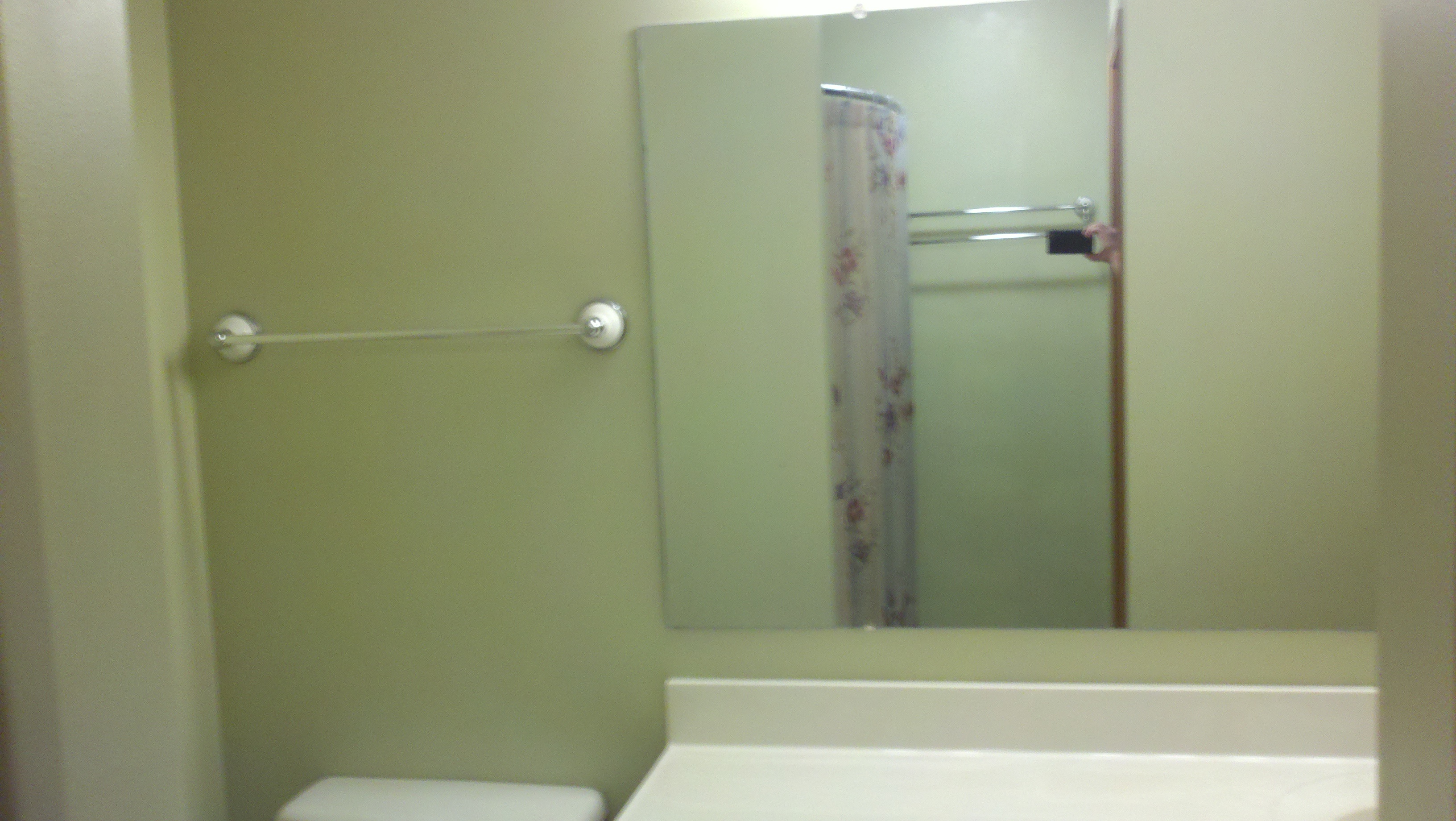

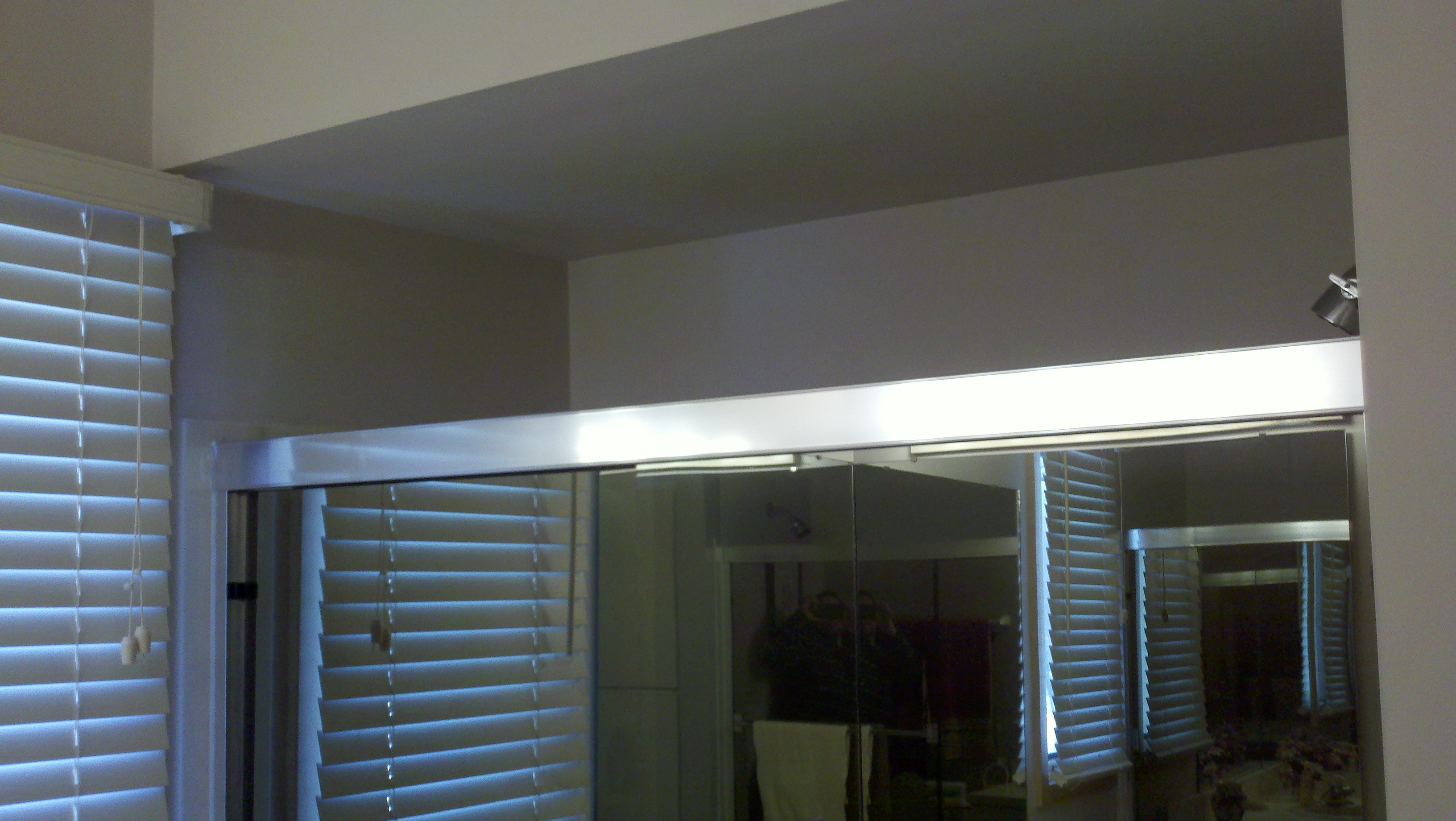

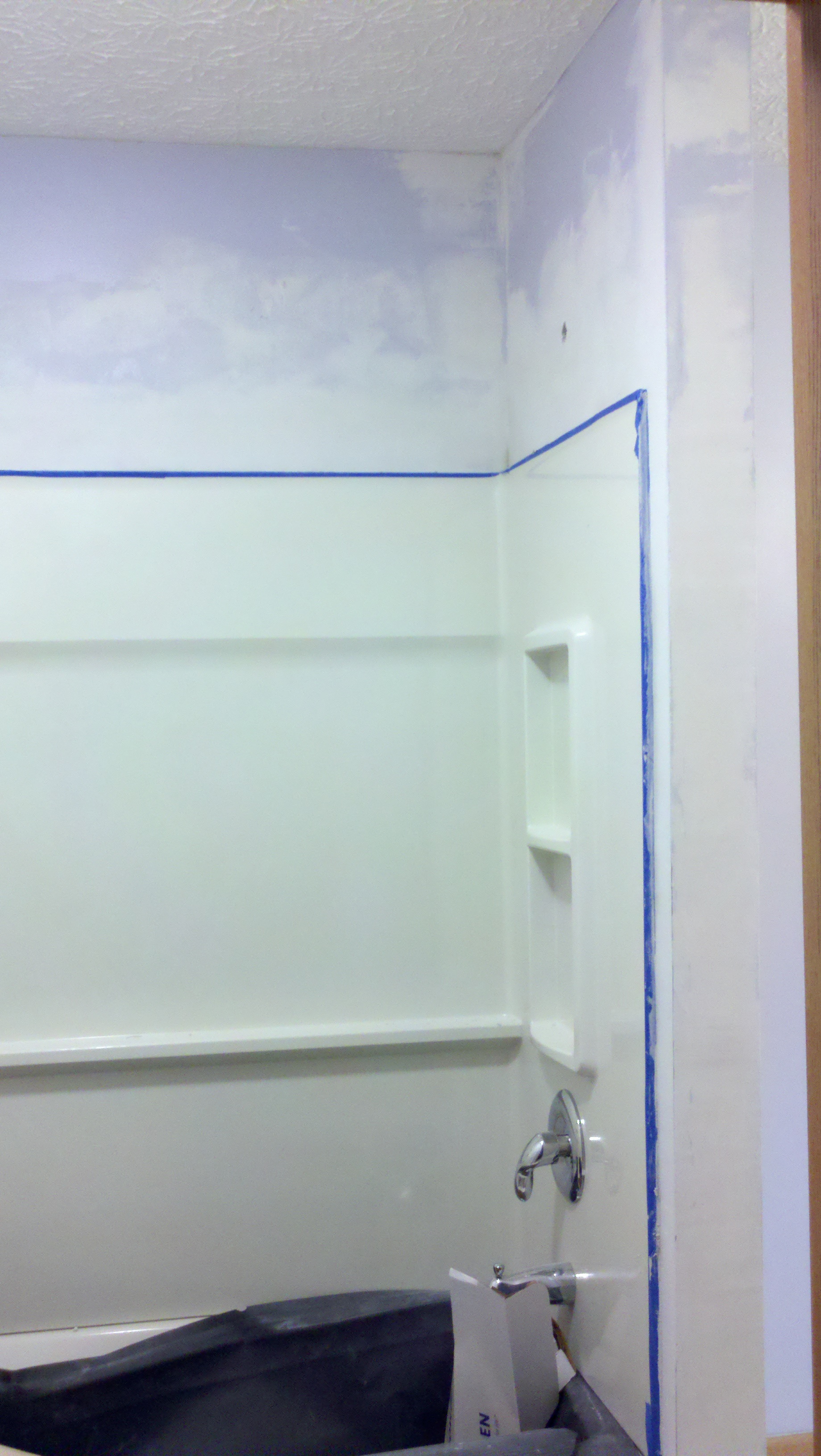

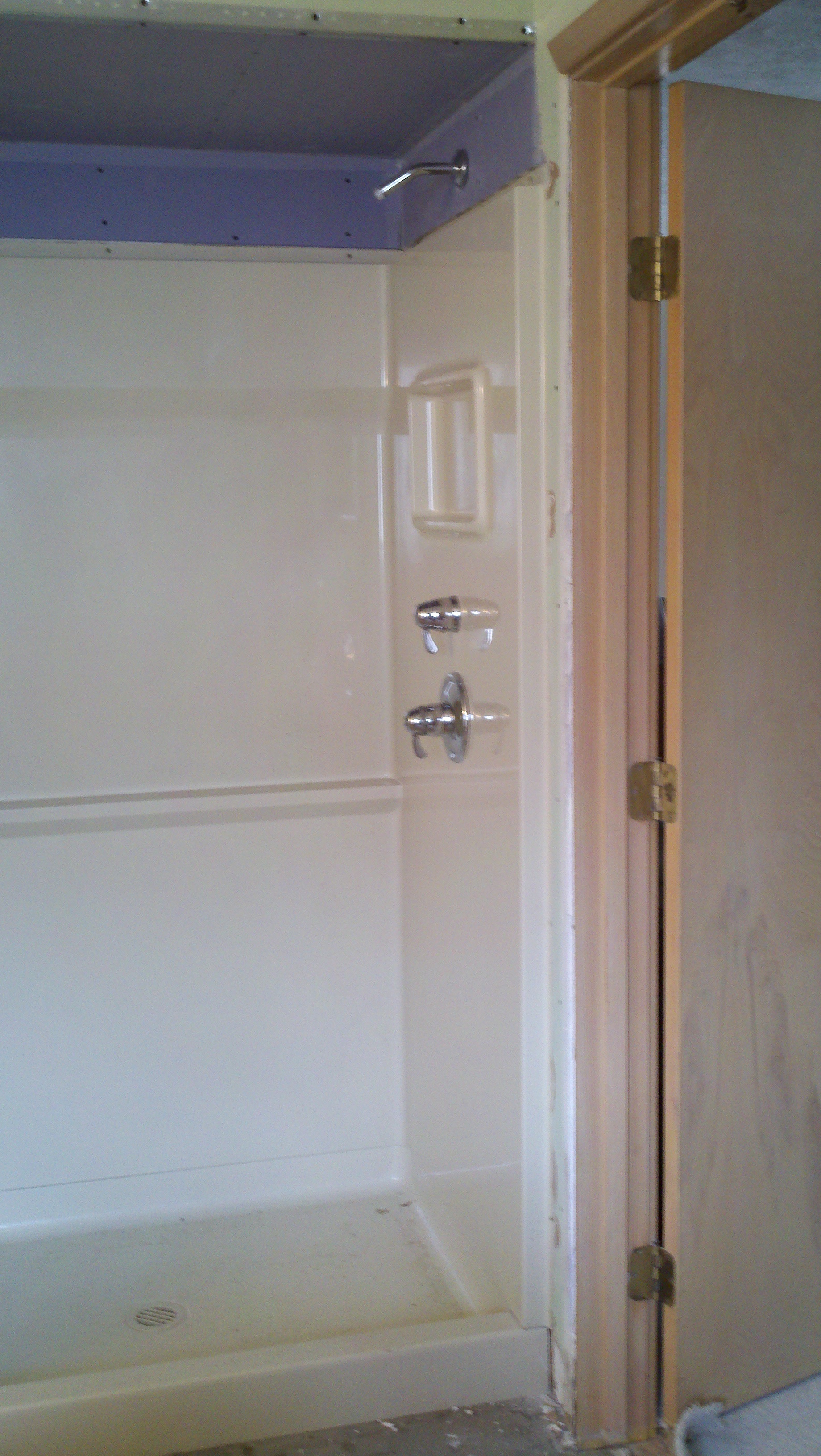

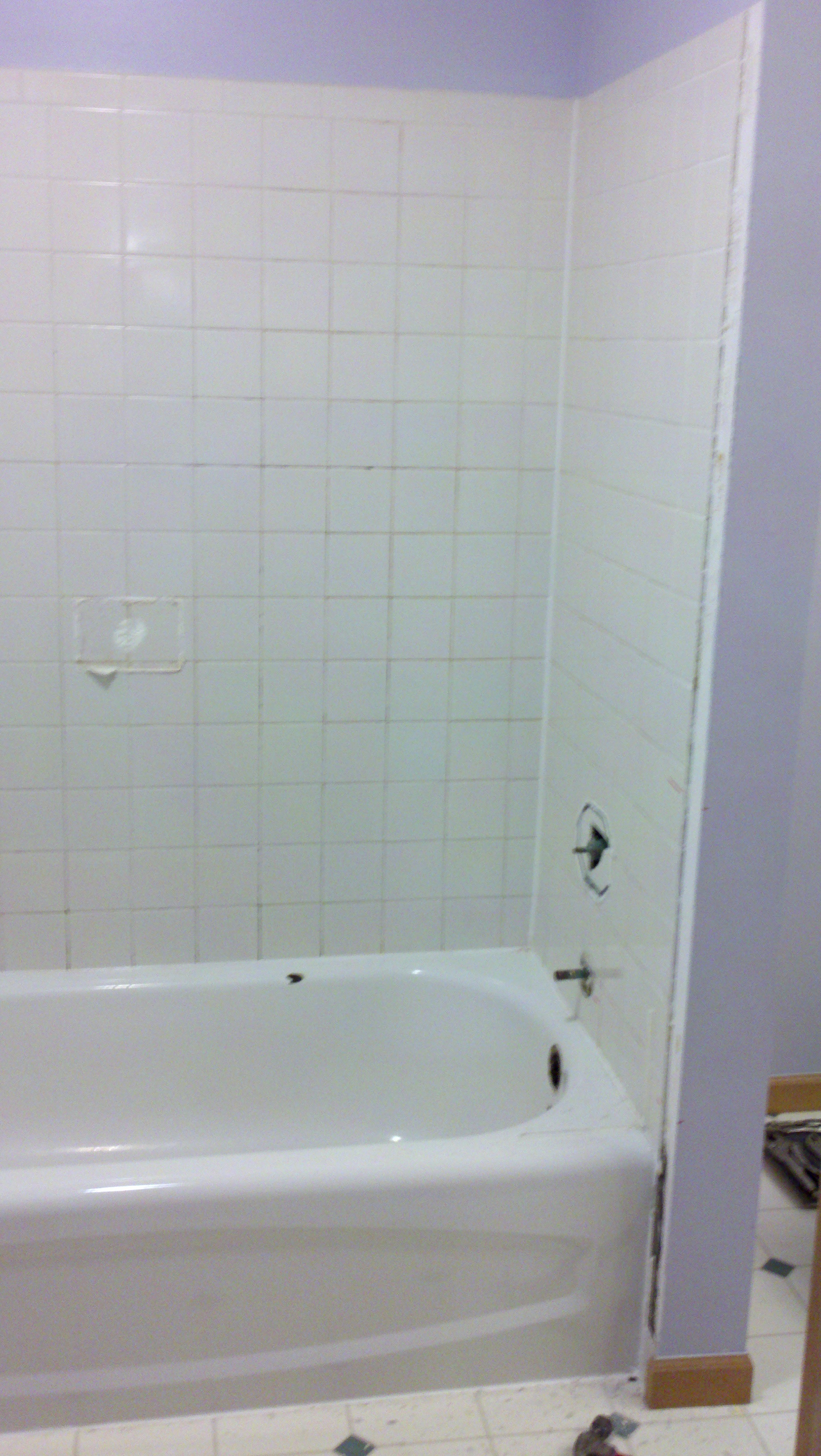

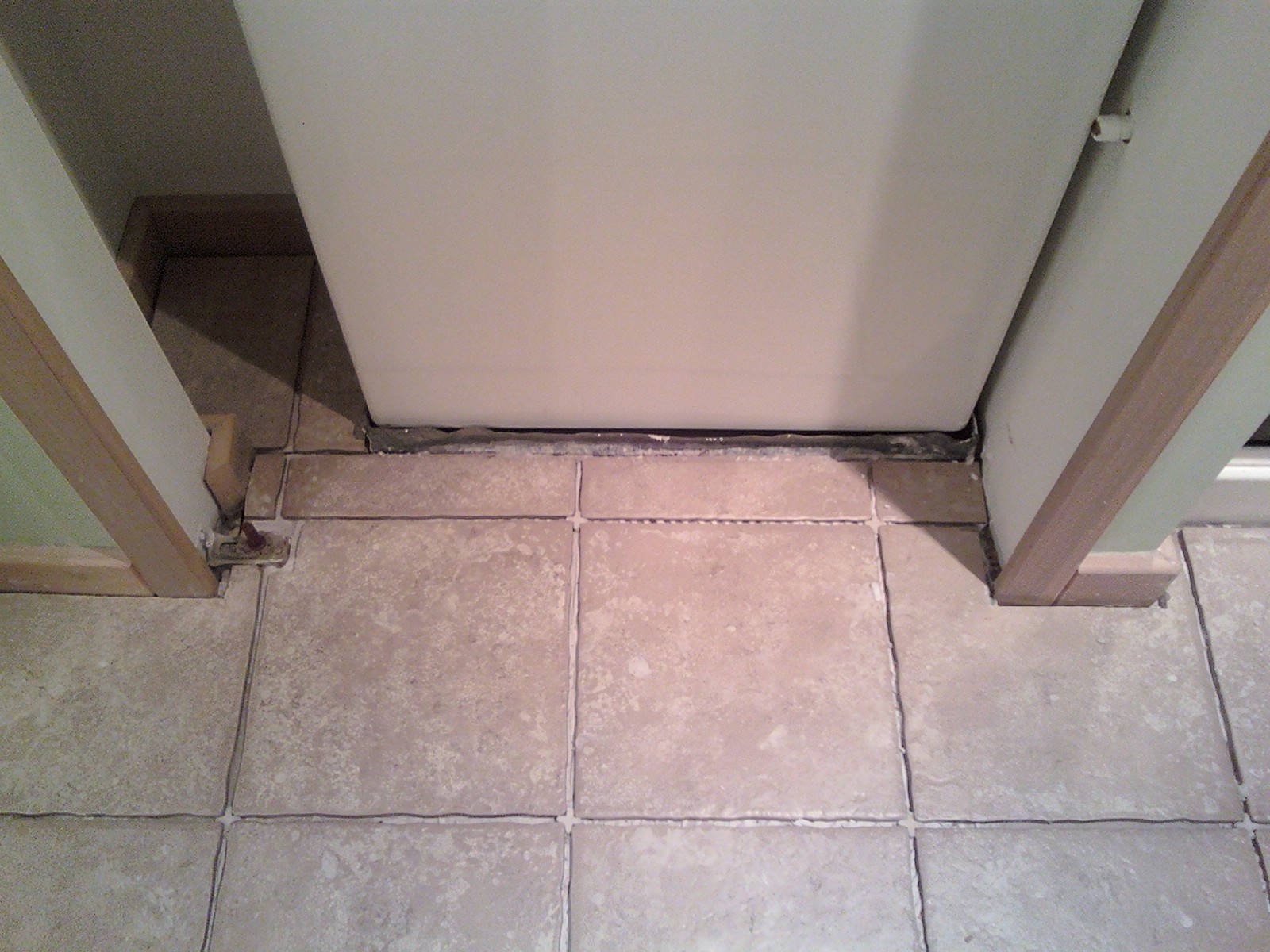

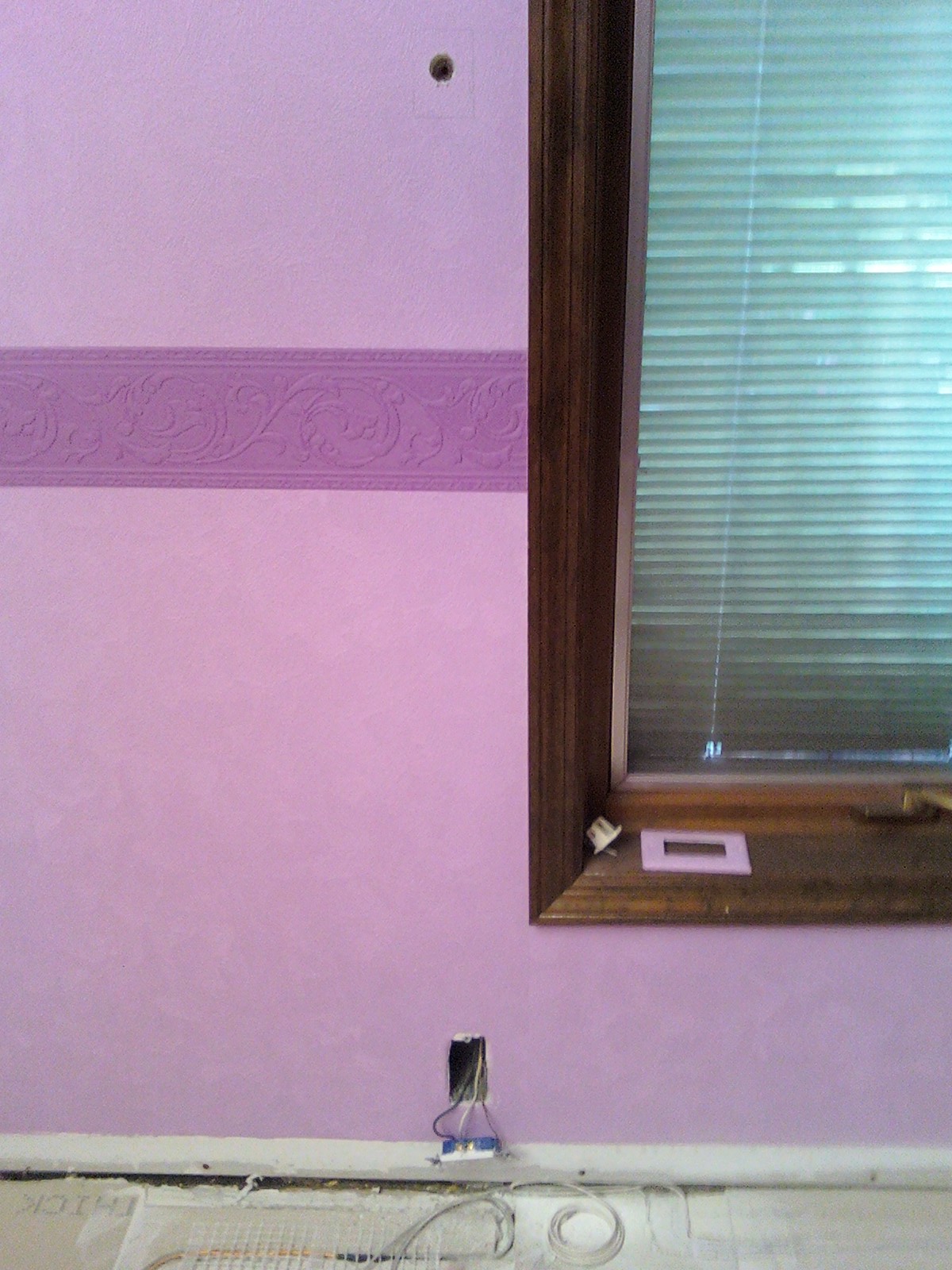

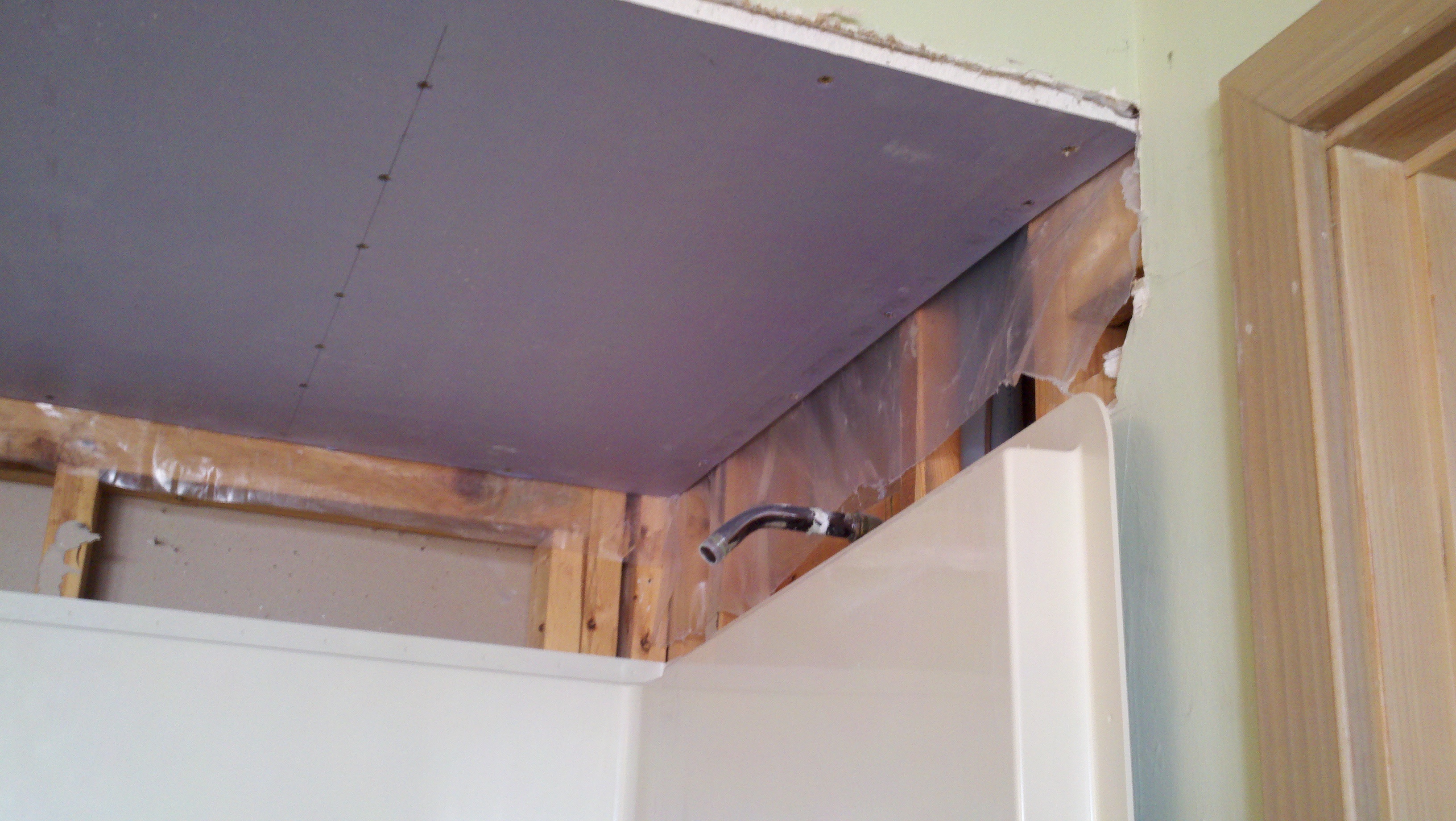

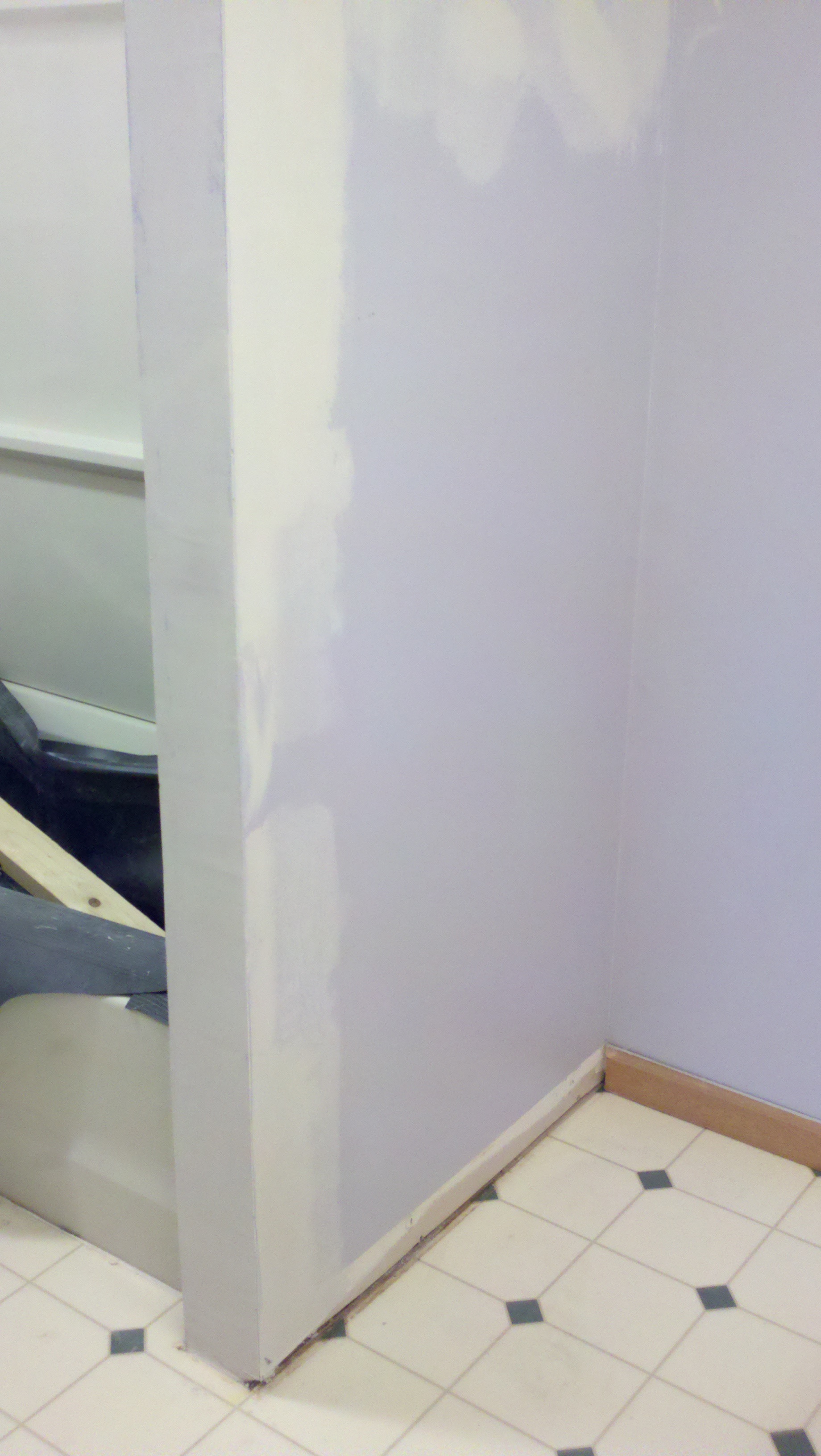

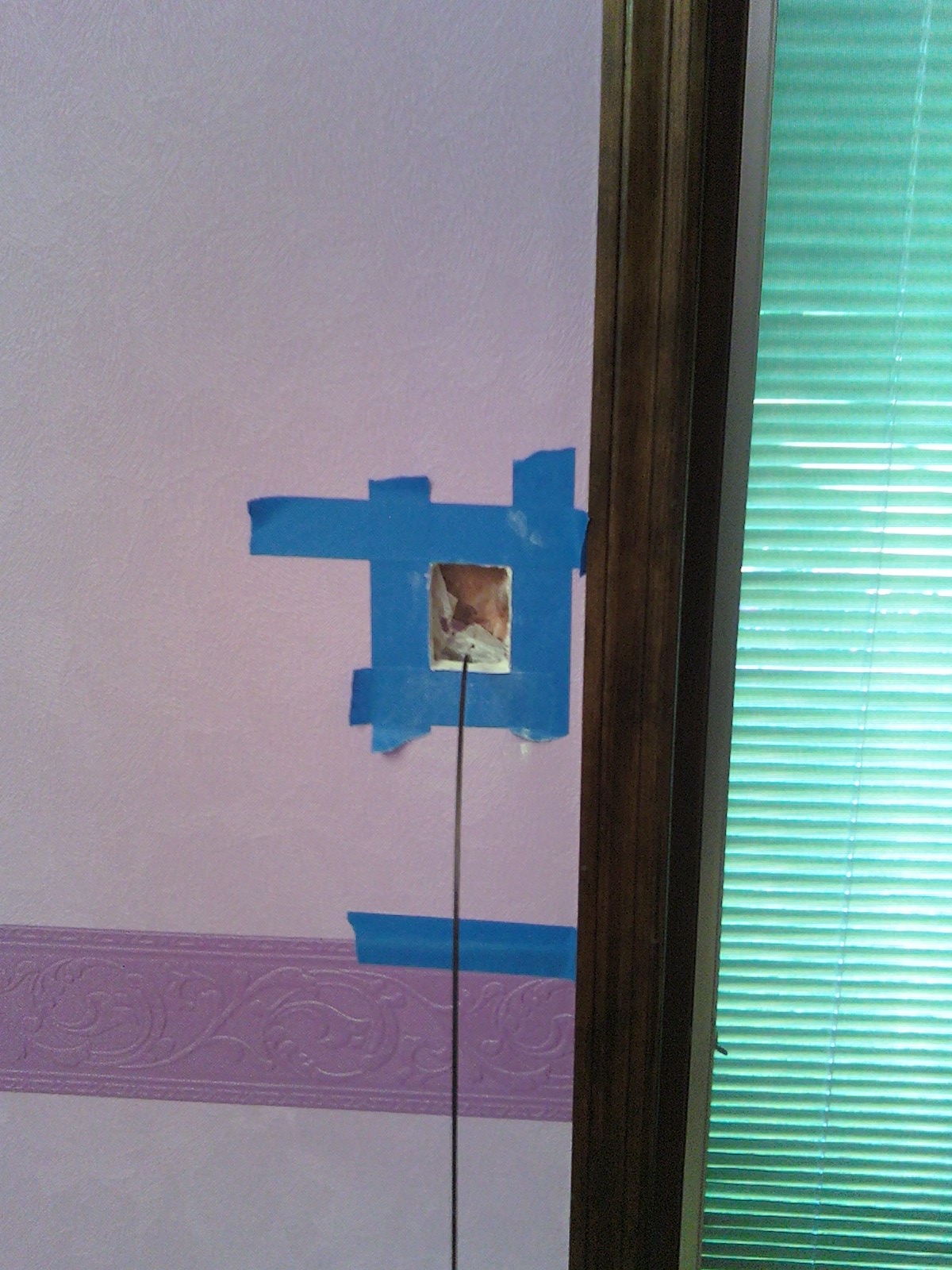

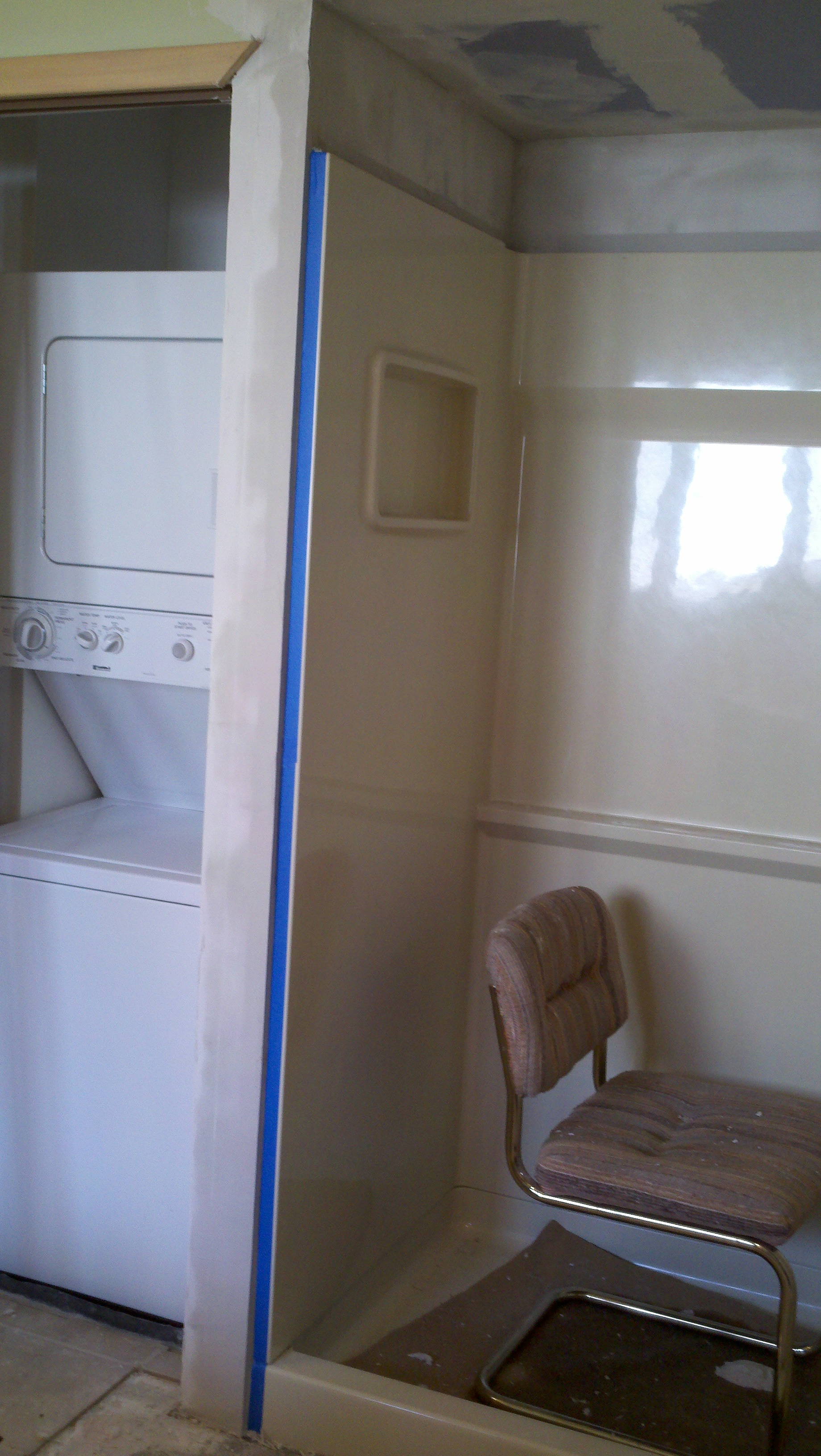

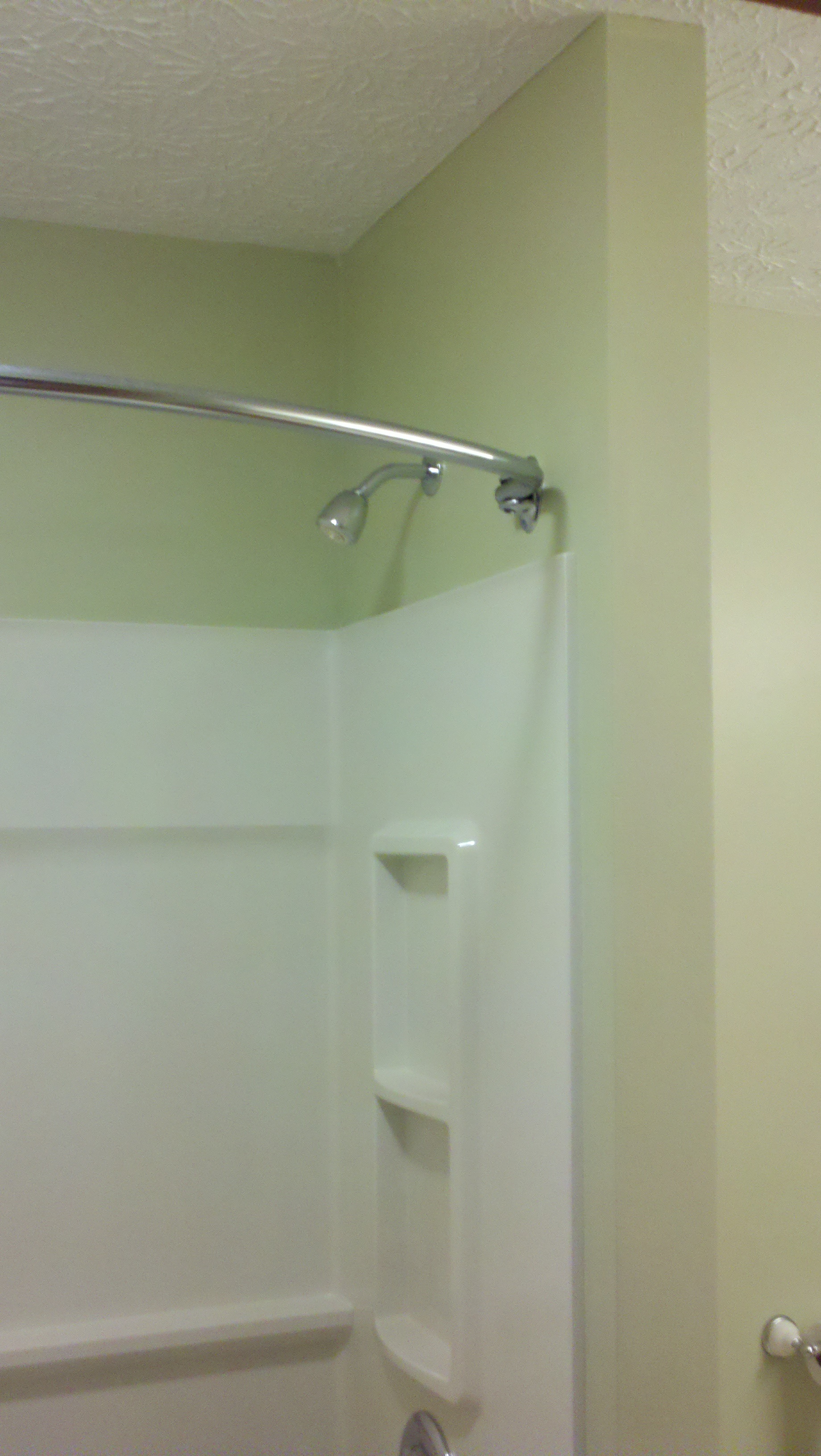

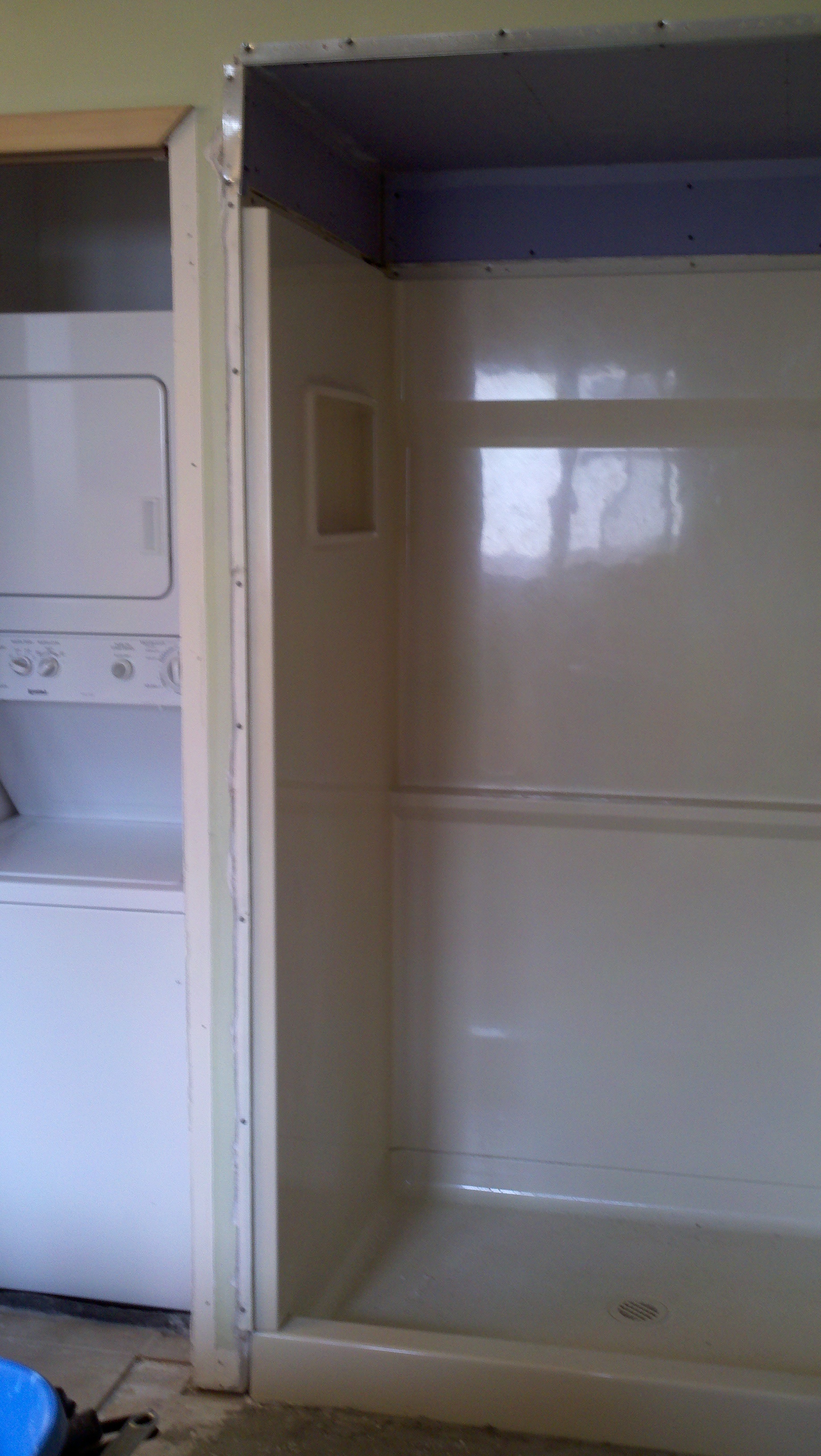

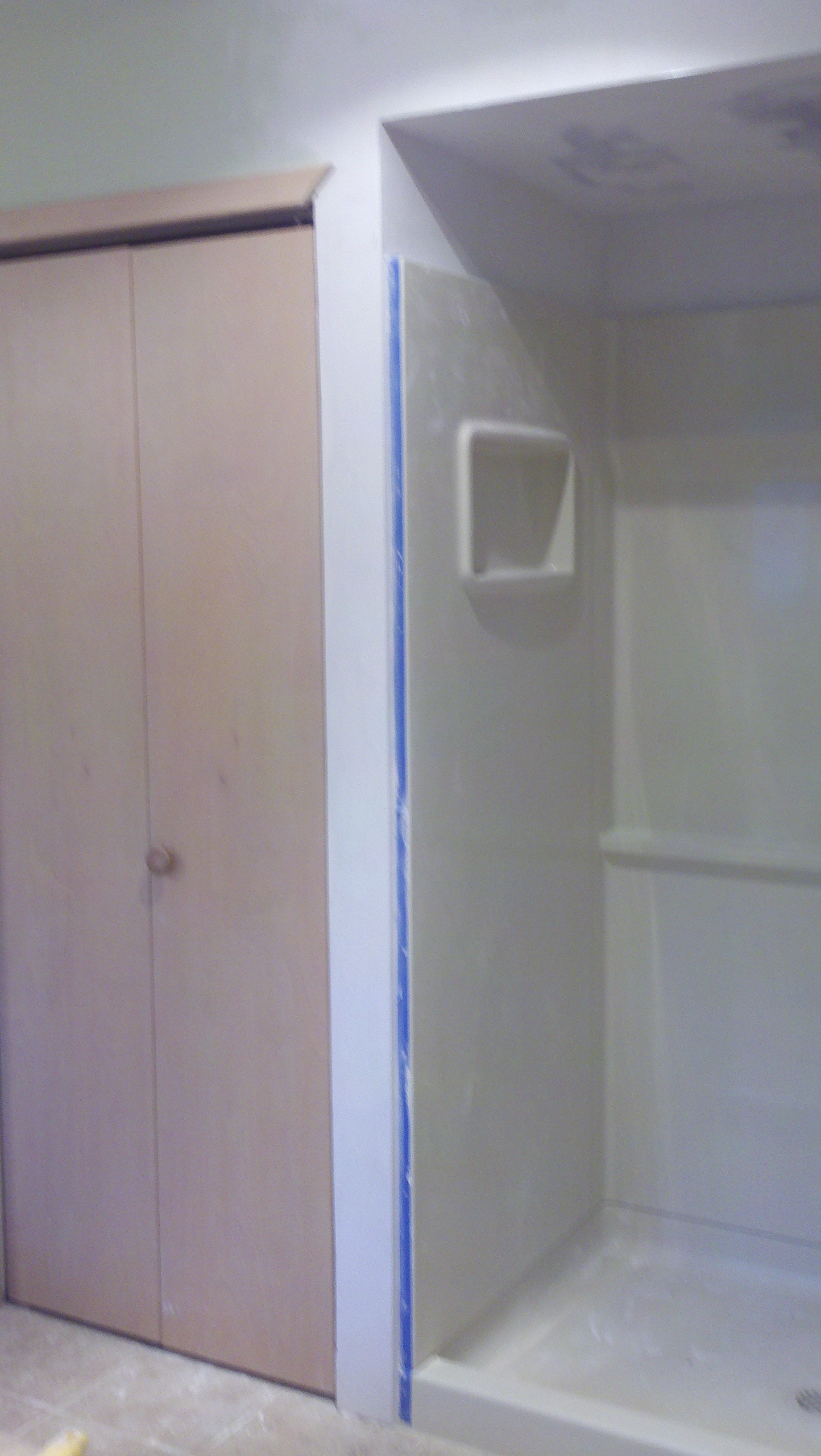

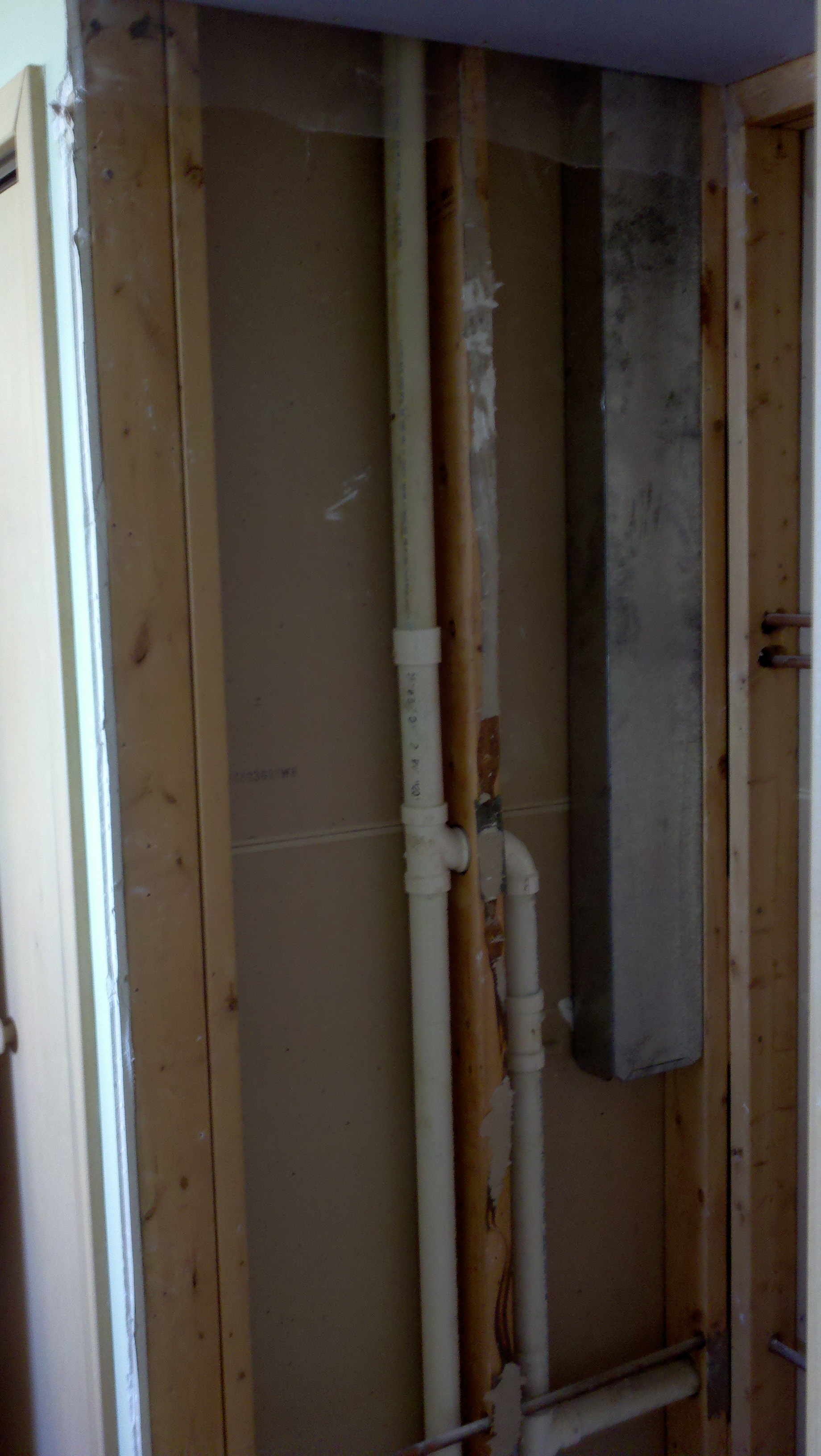

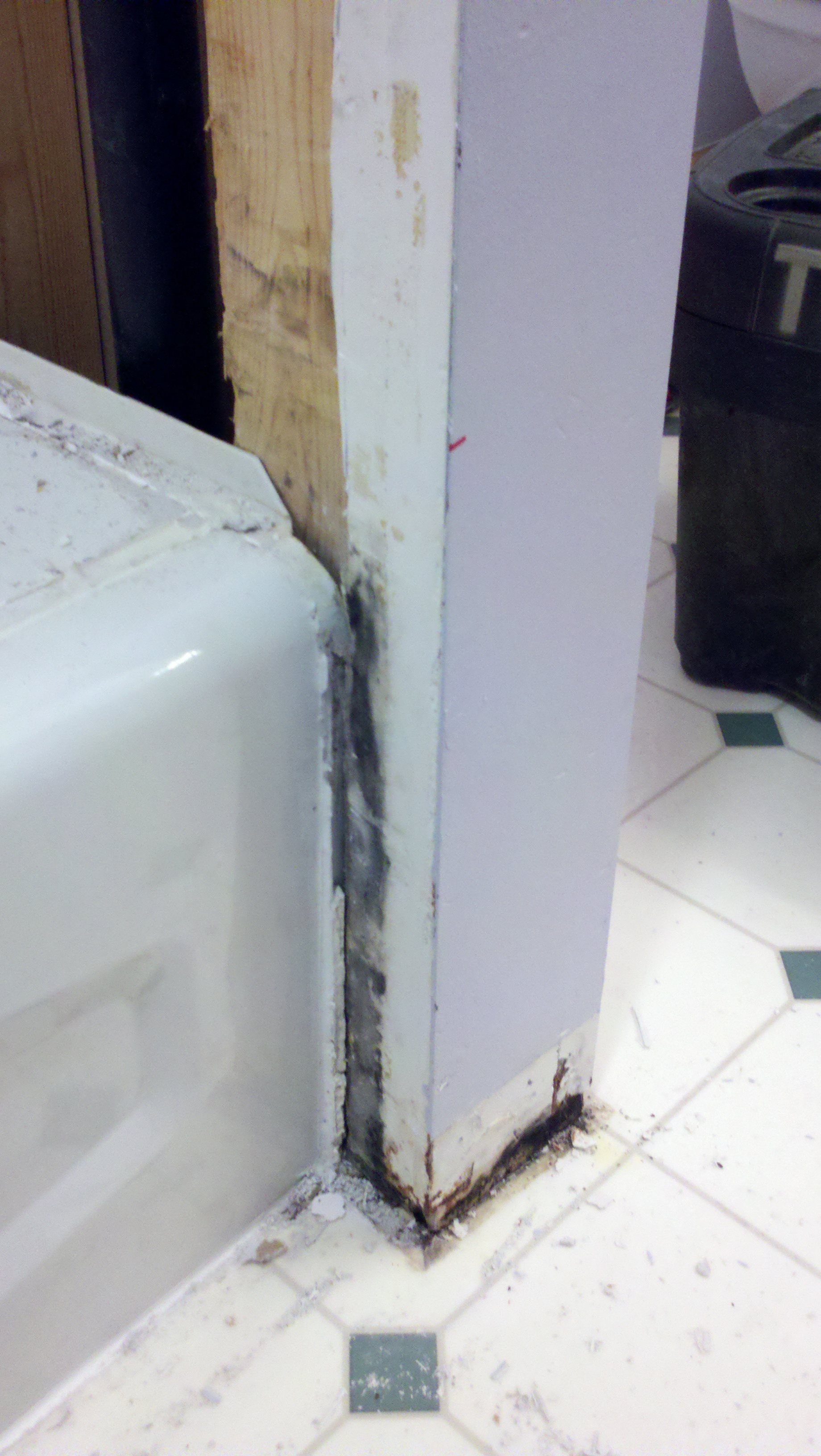

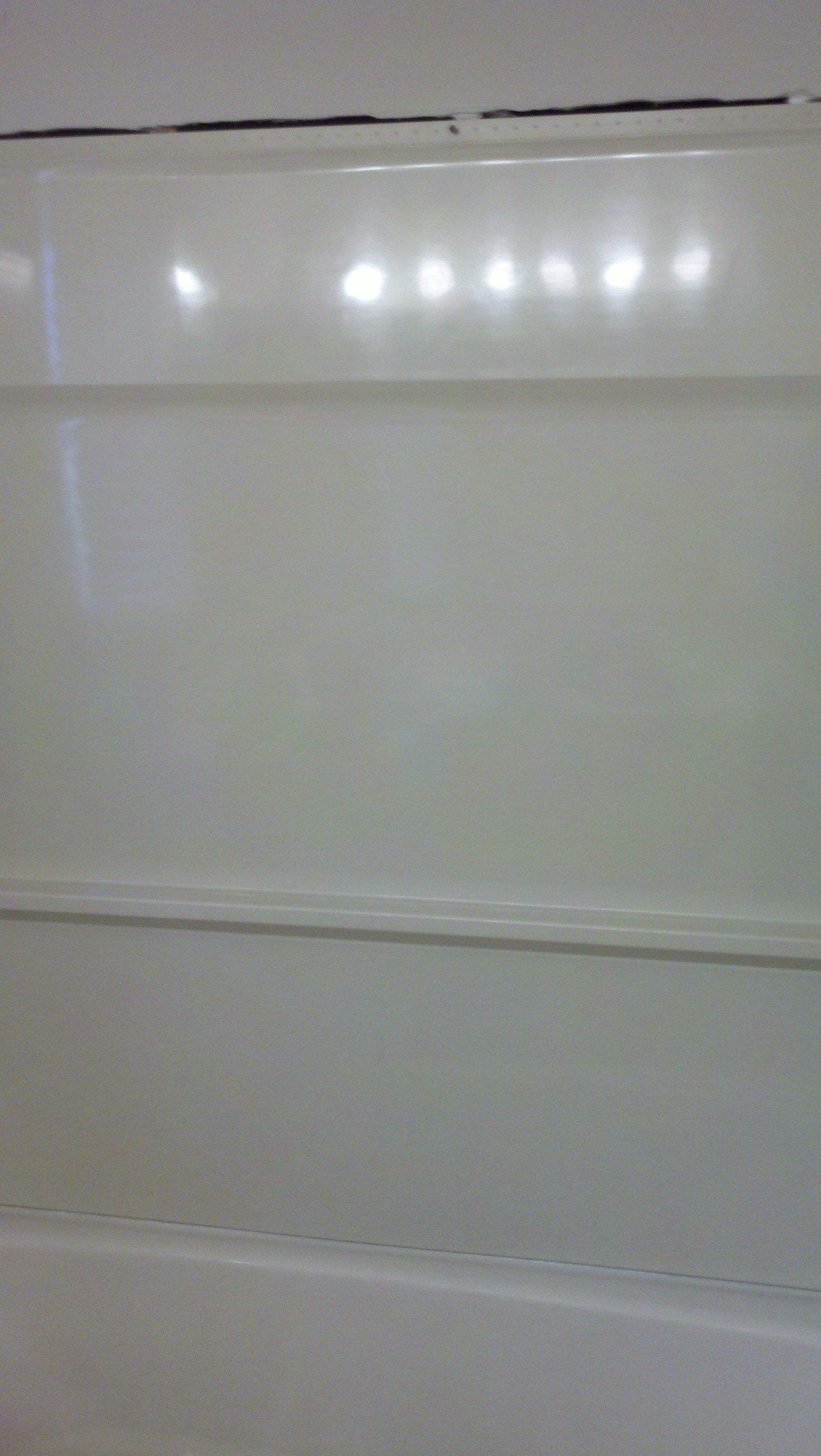

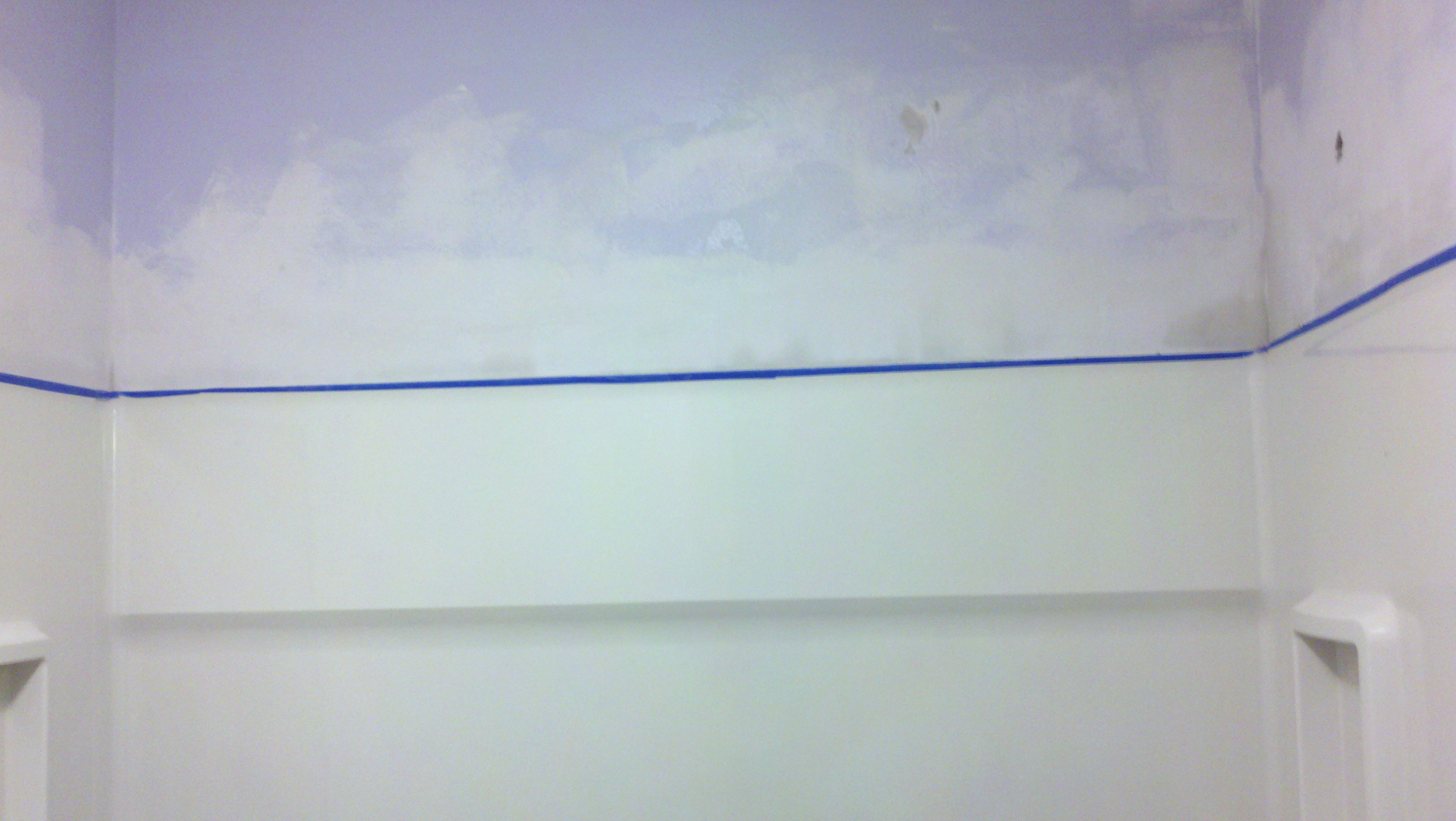

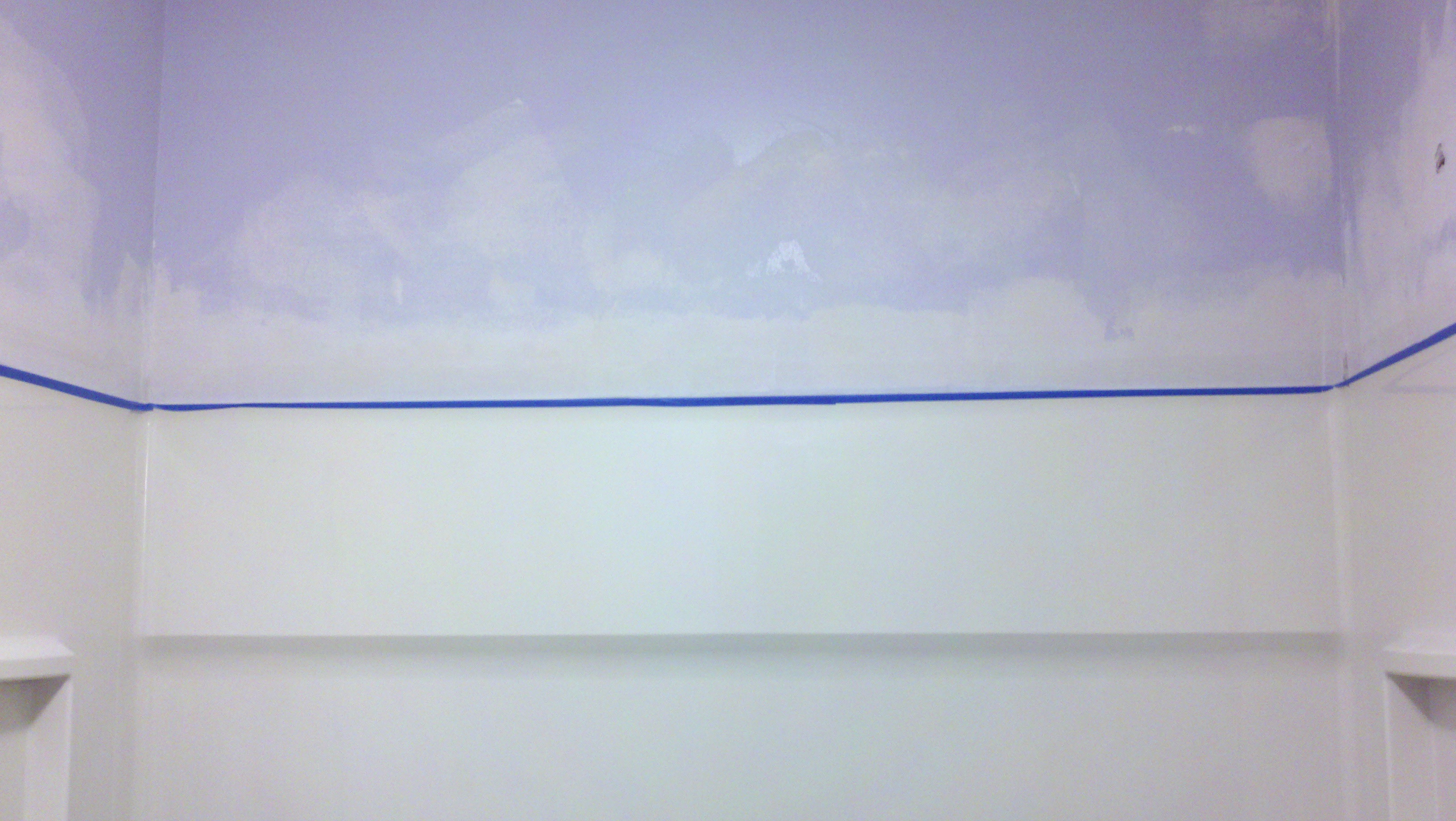

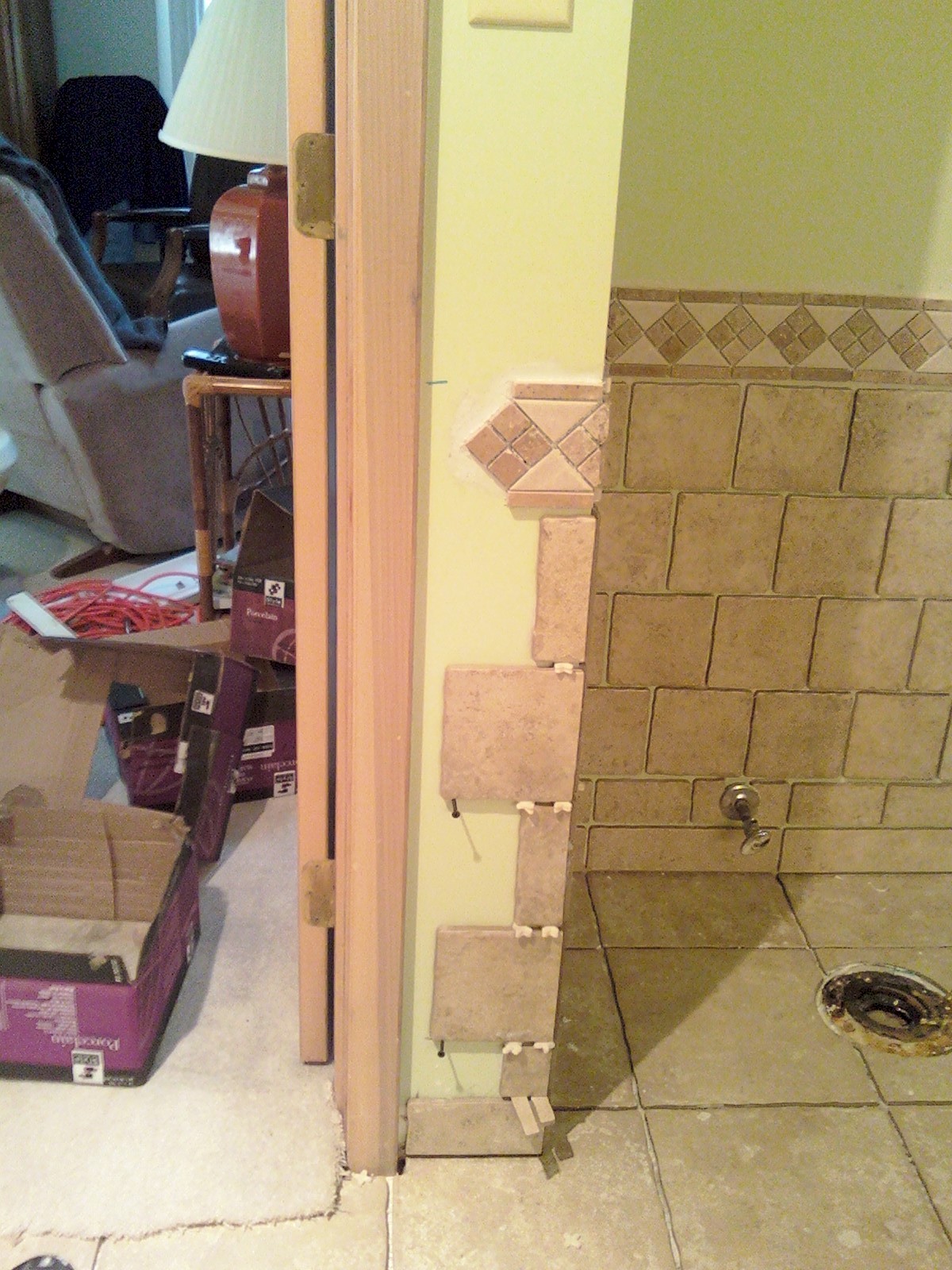

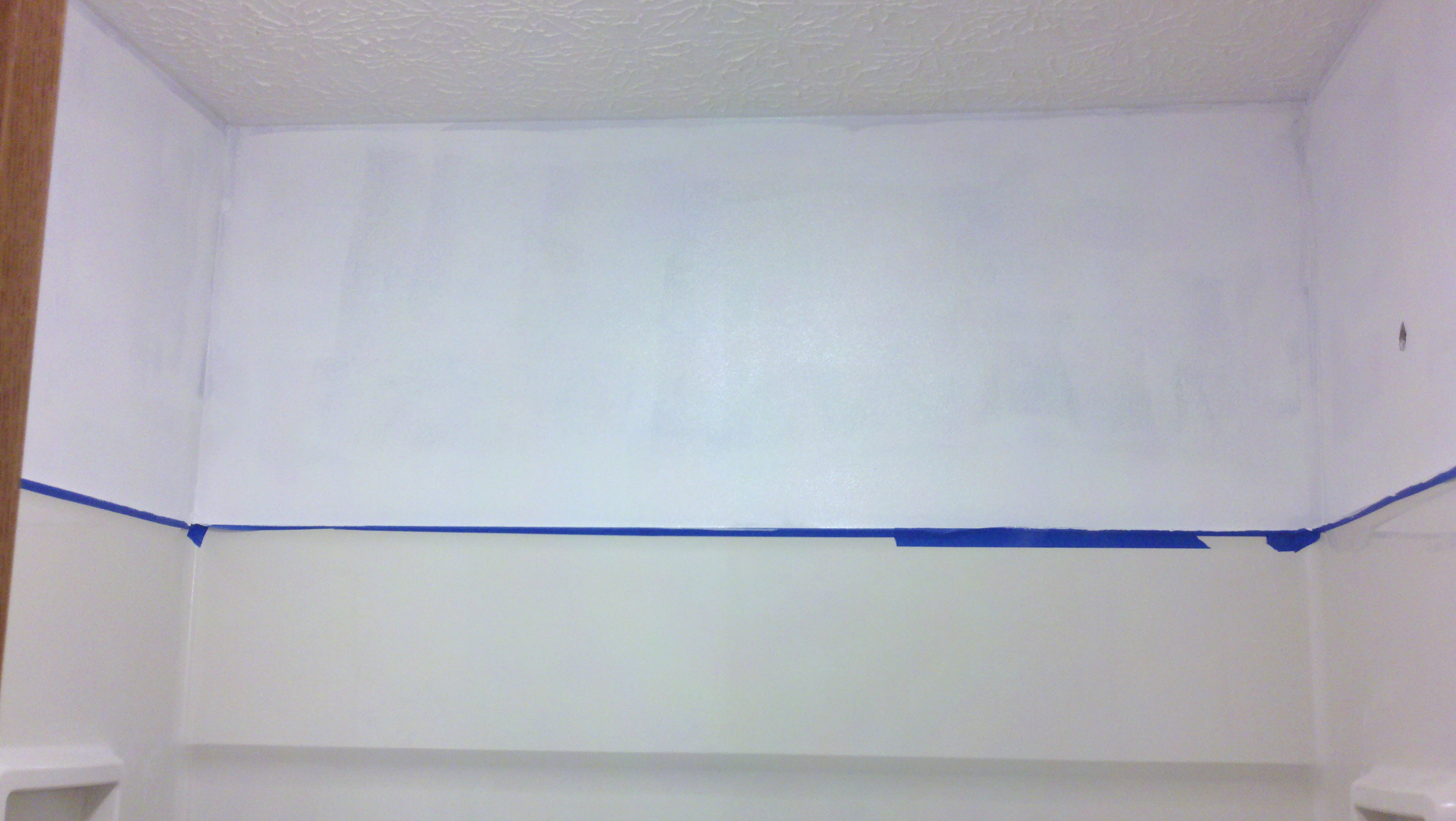

Second Bathroom Shower Wall Removal & Installation, ExactTemp Thermostatic Faucet Installation, & Paint Walls |

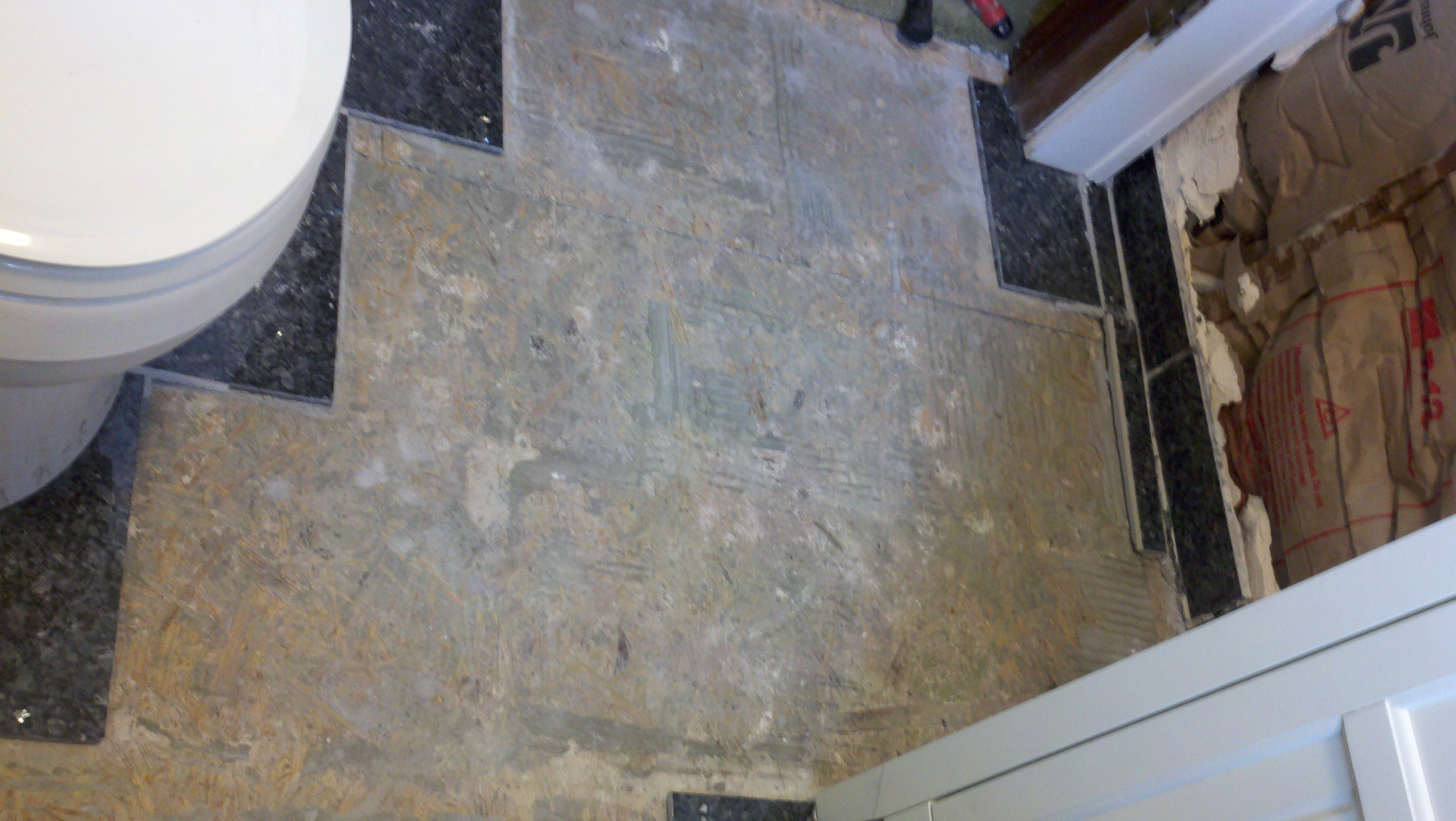

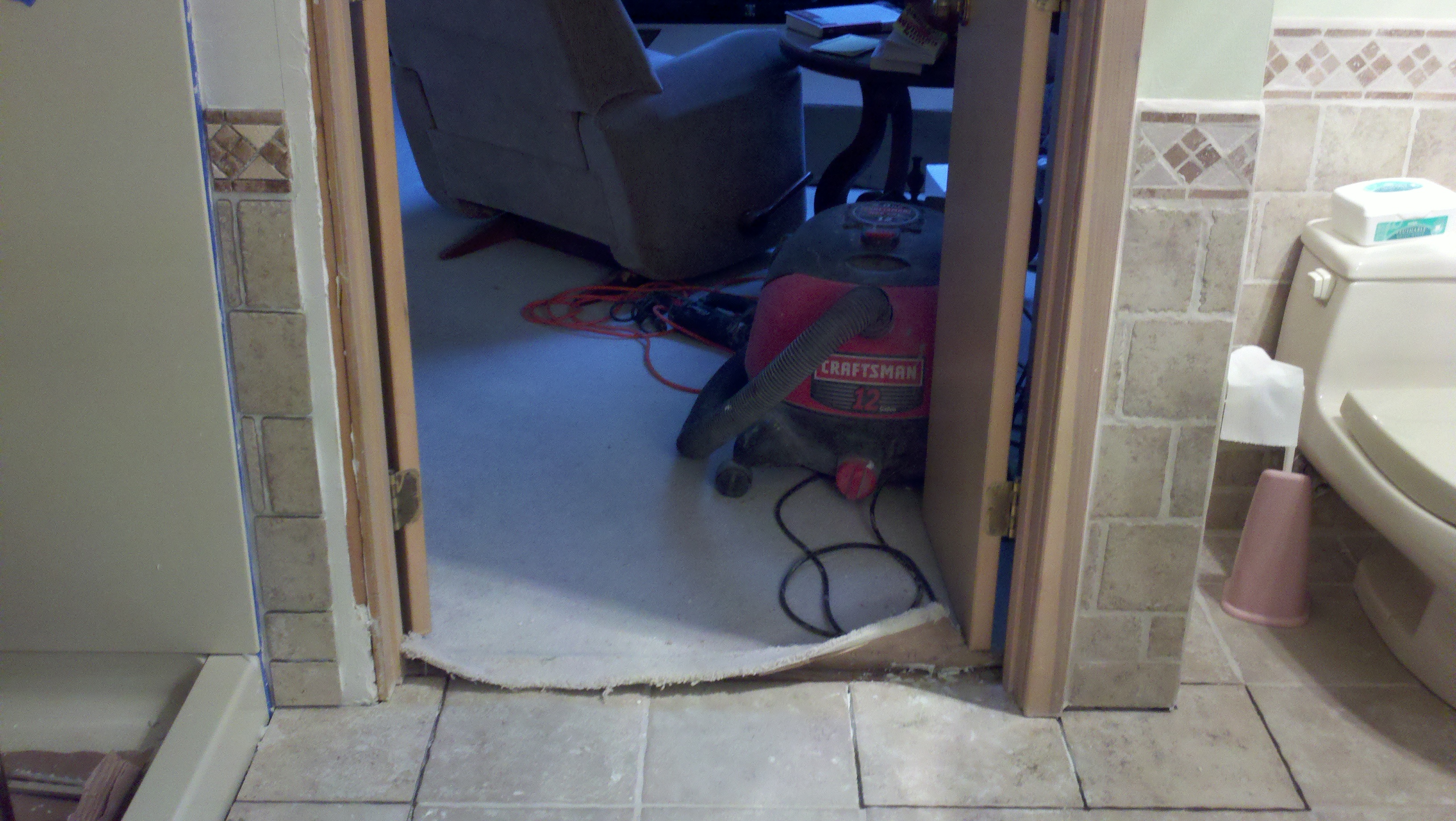

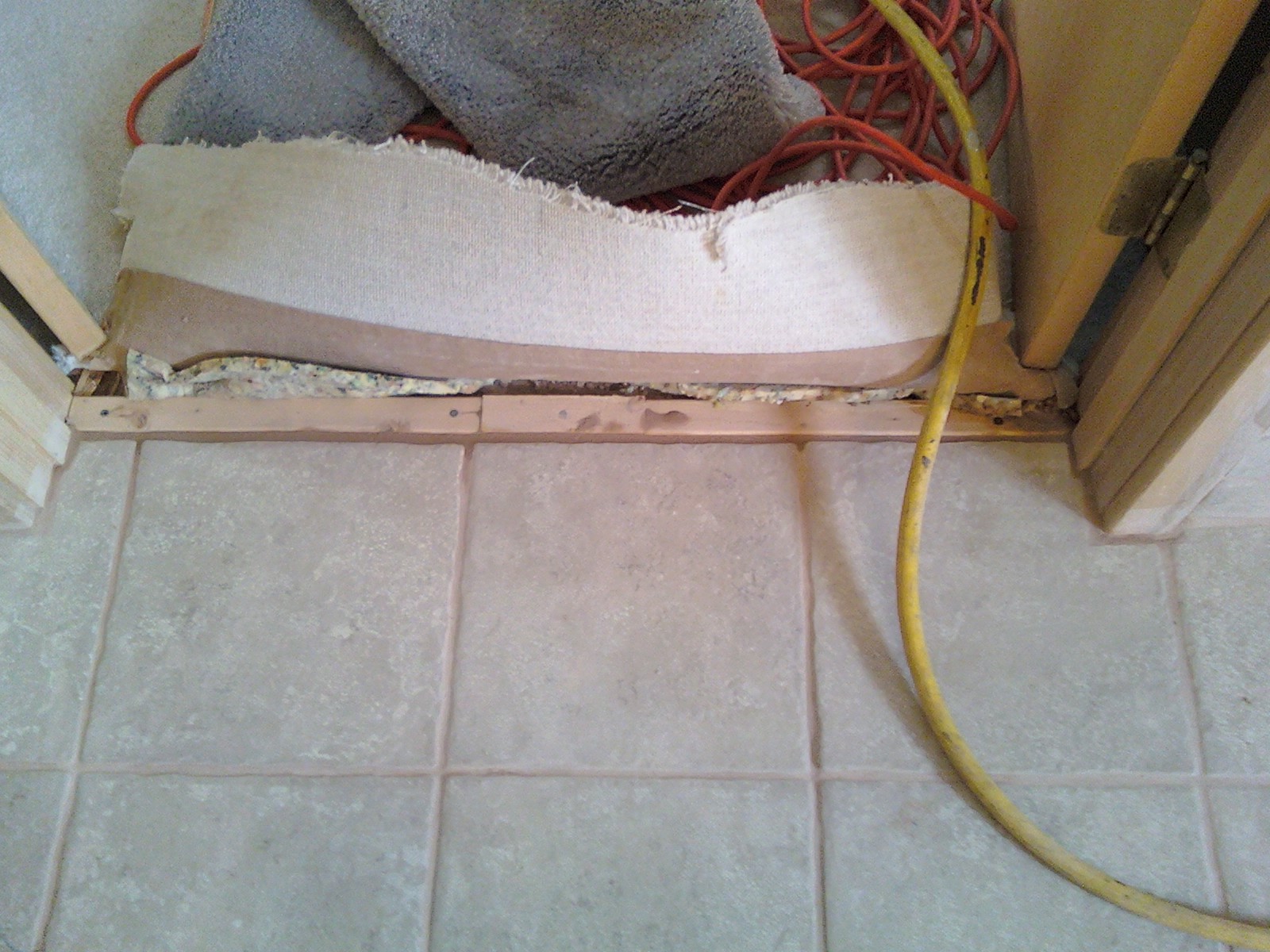

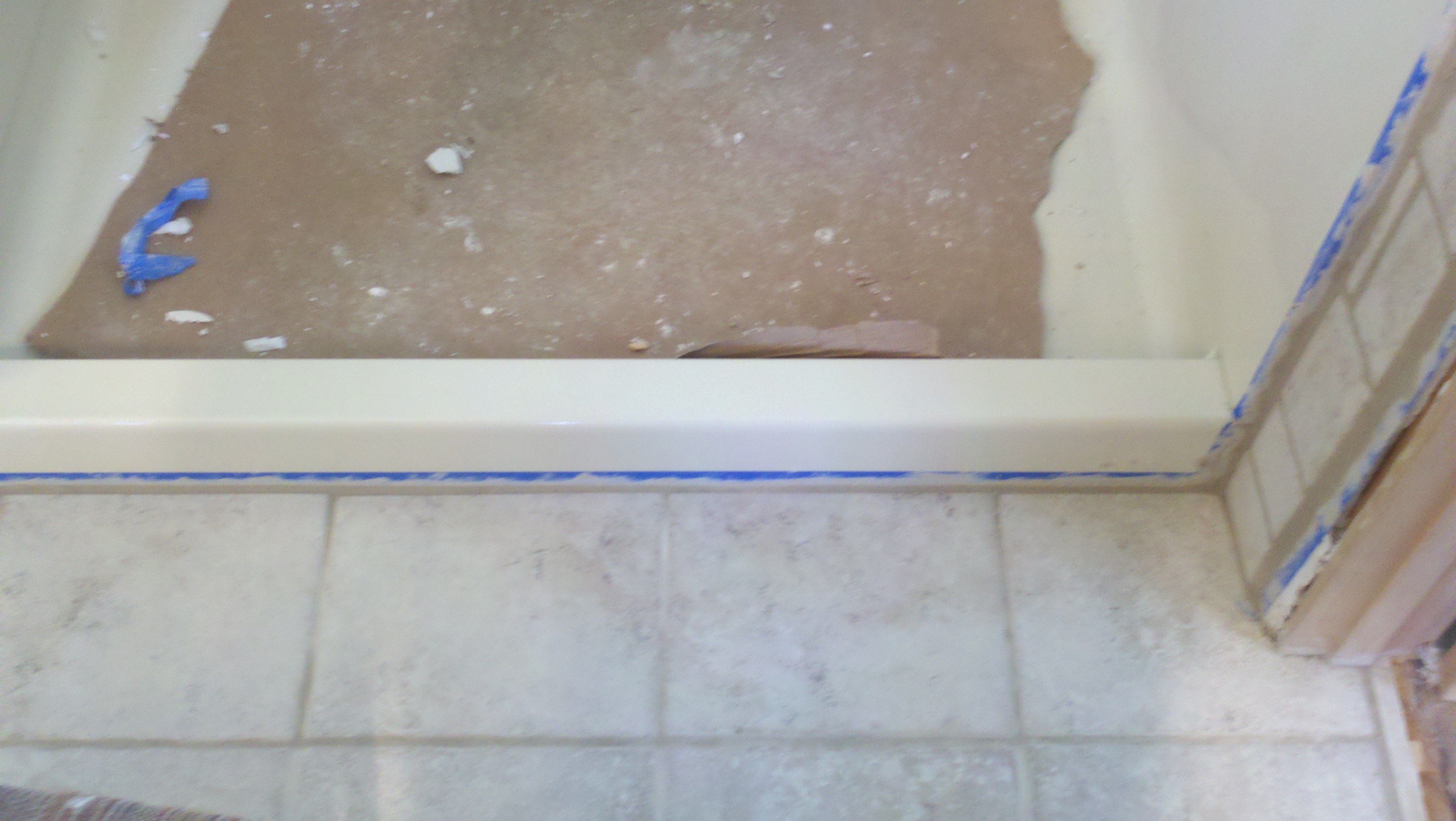

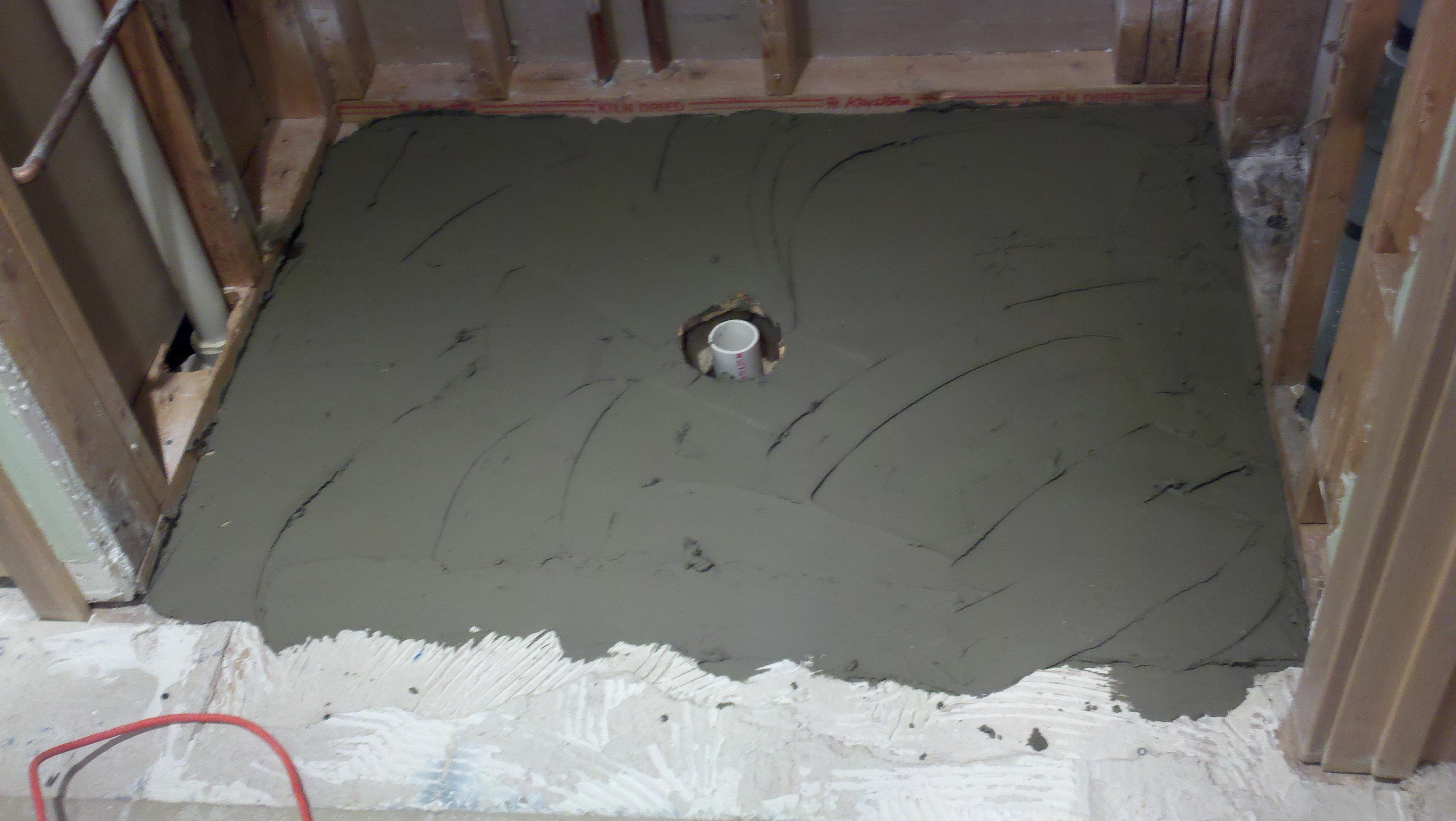

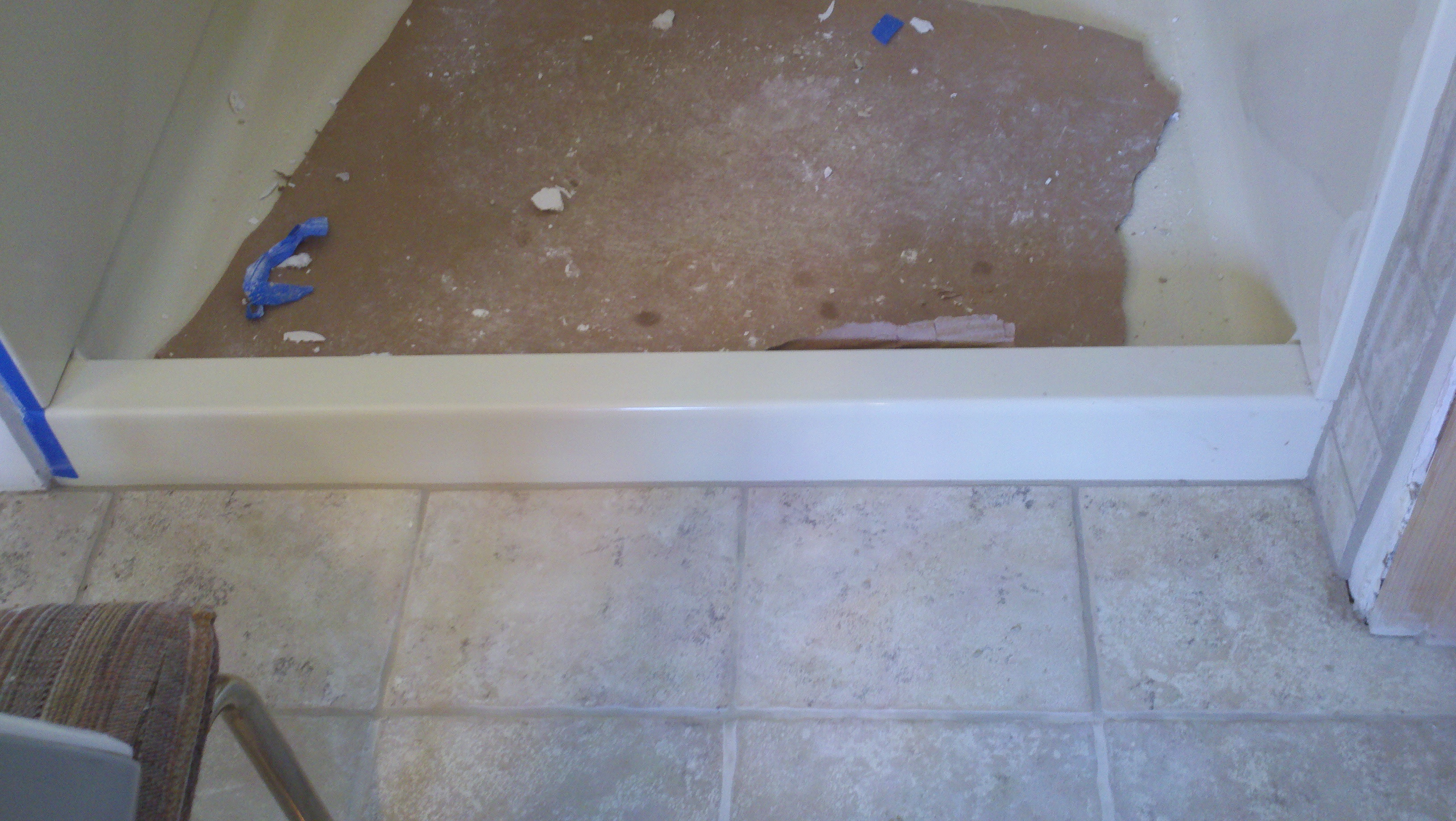

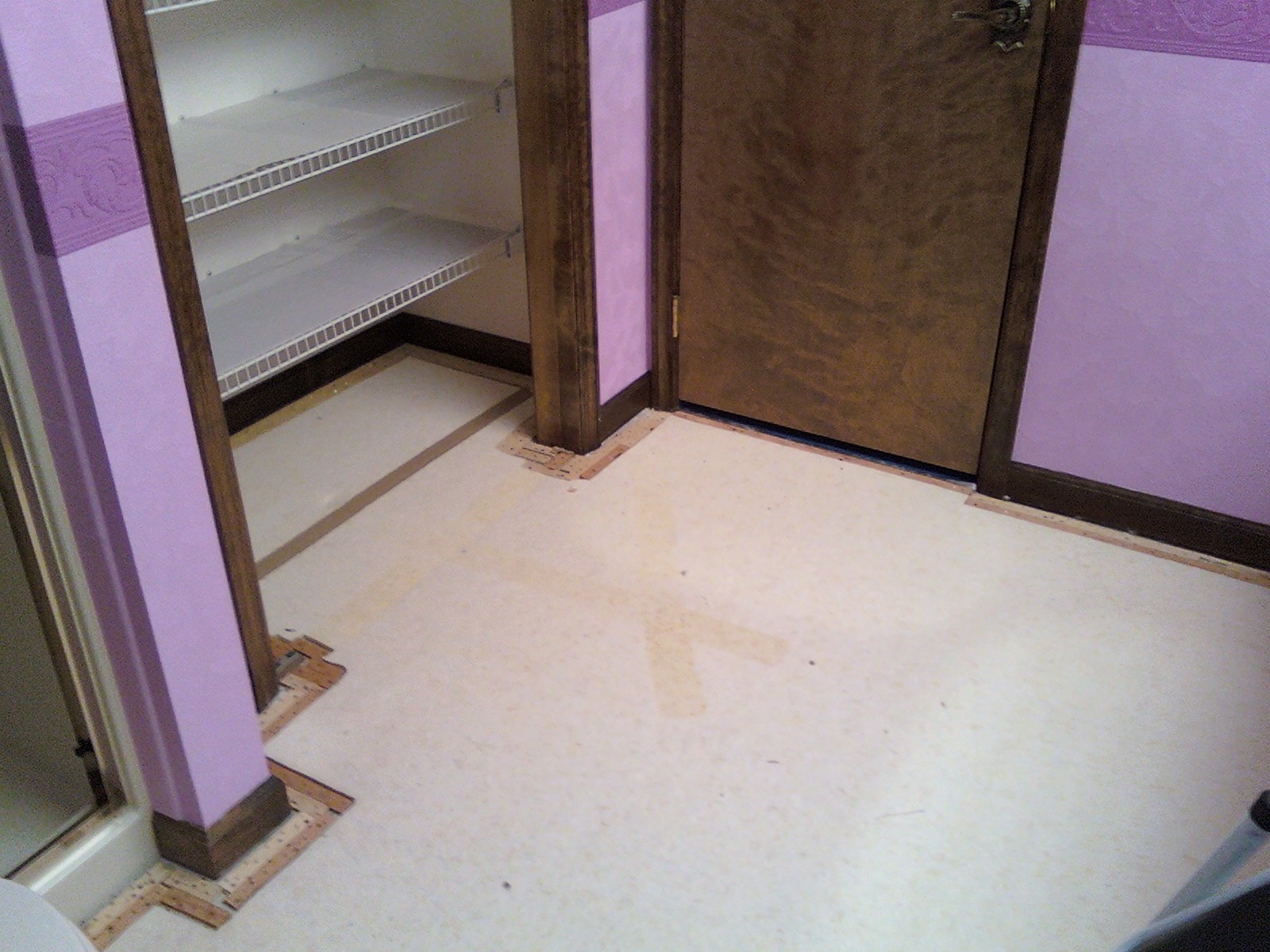

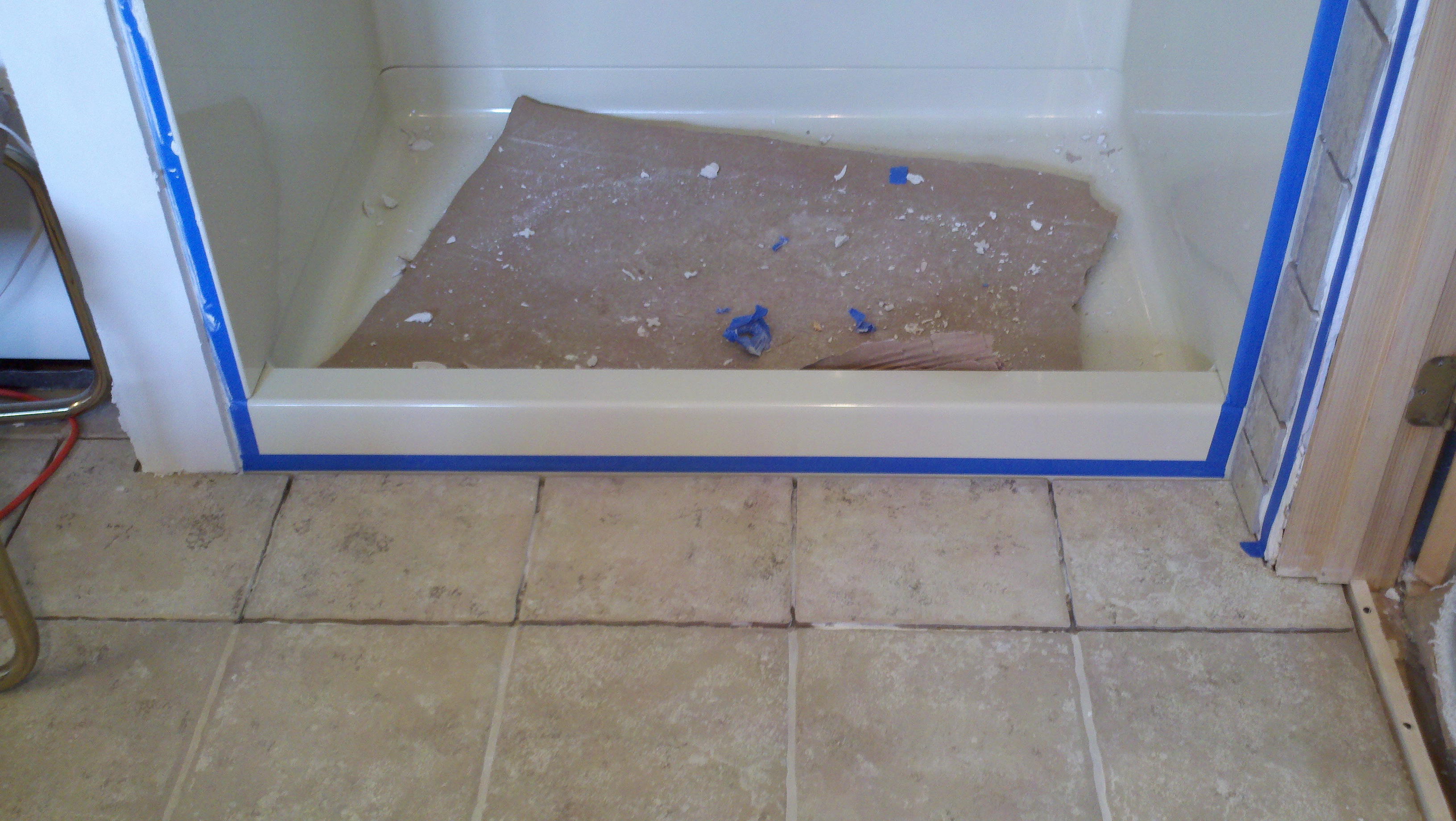

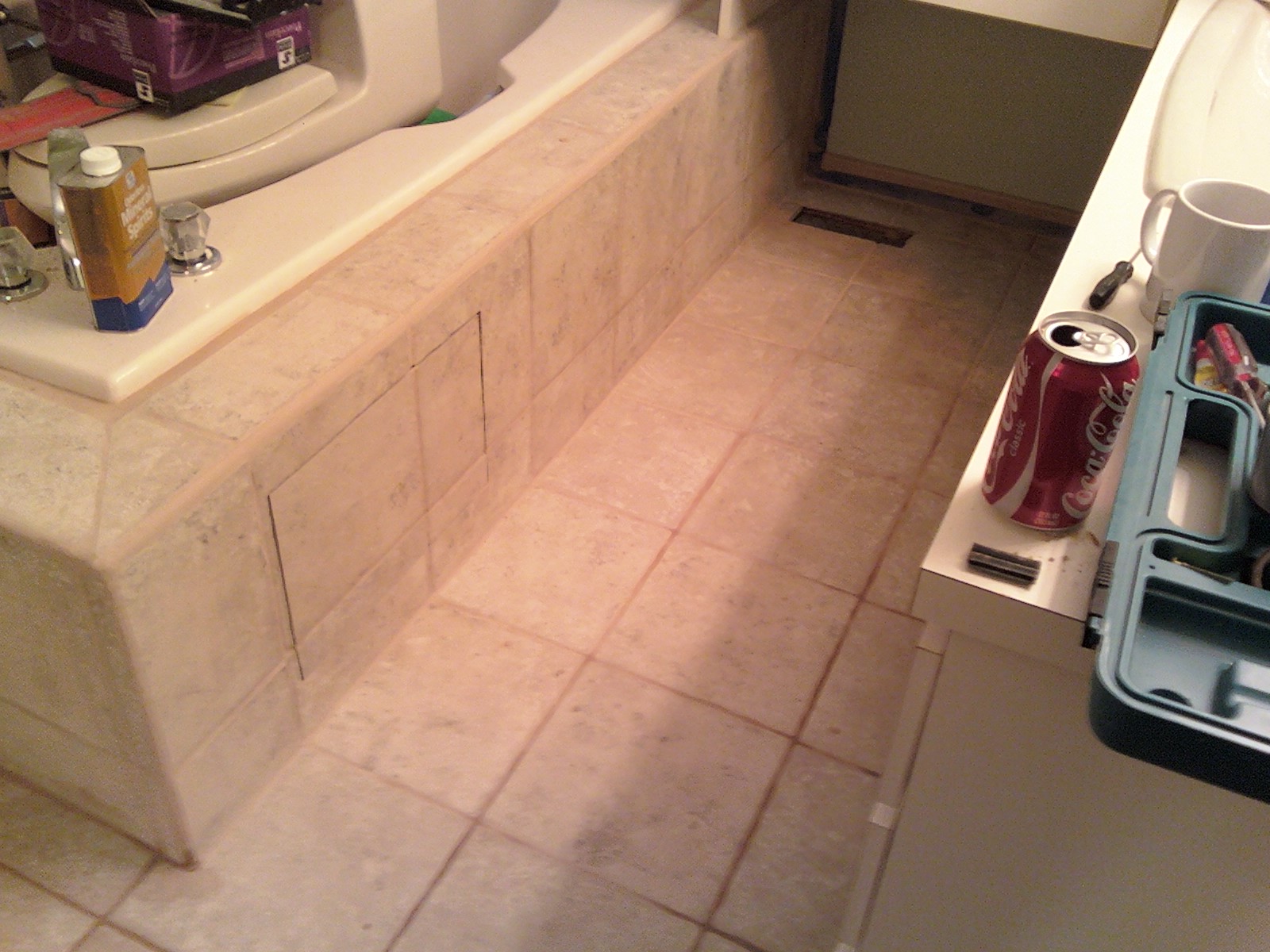

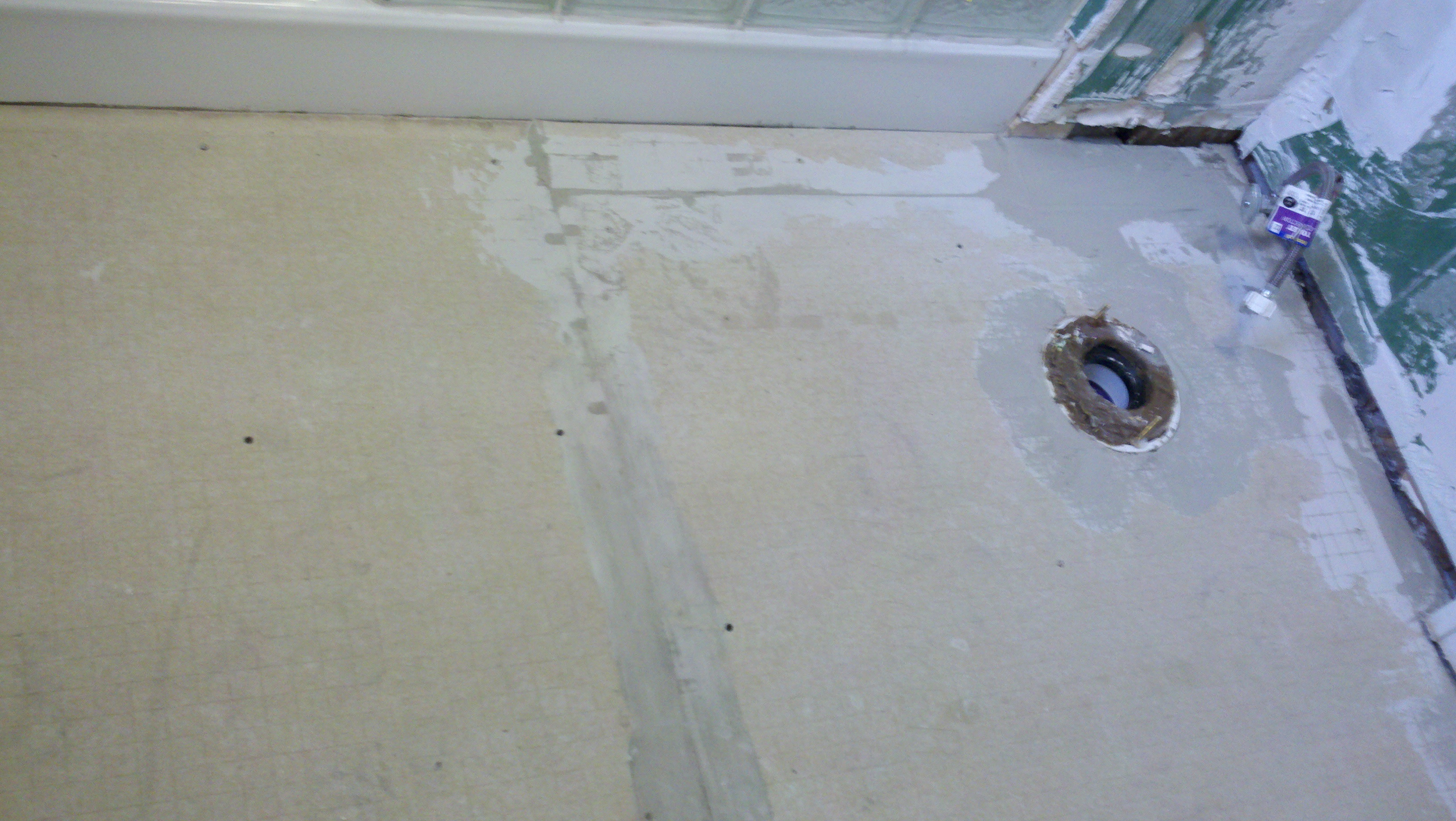

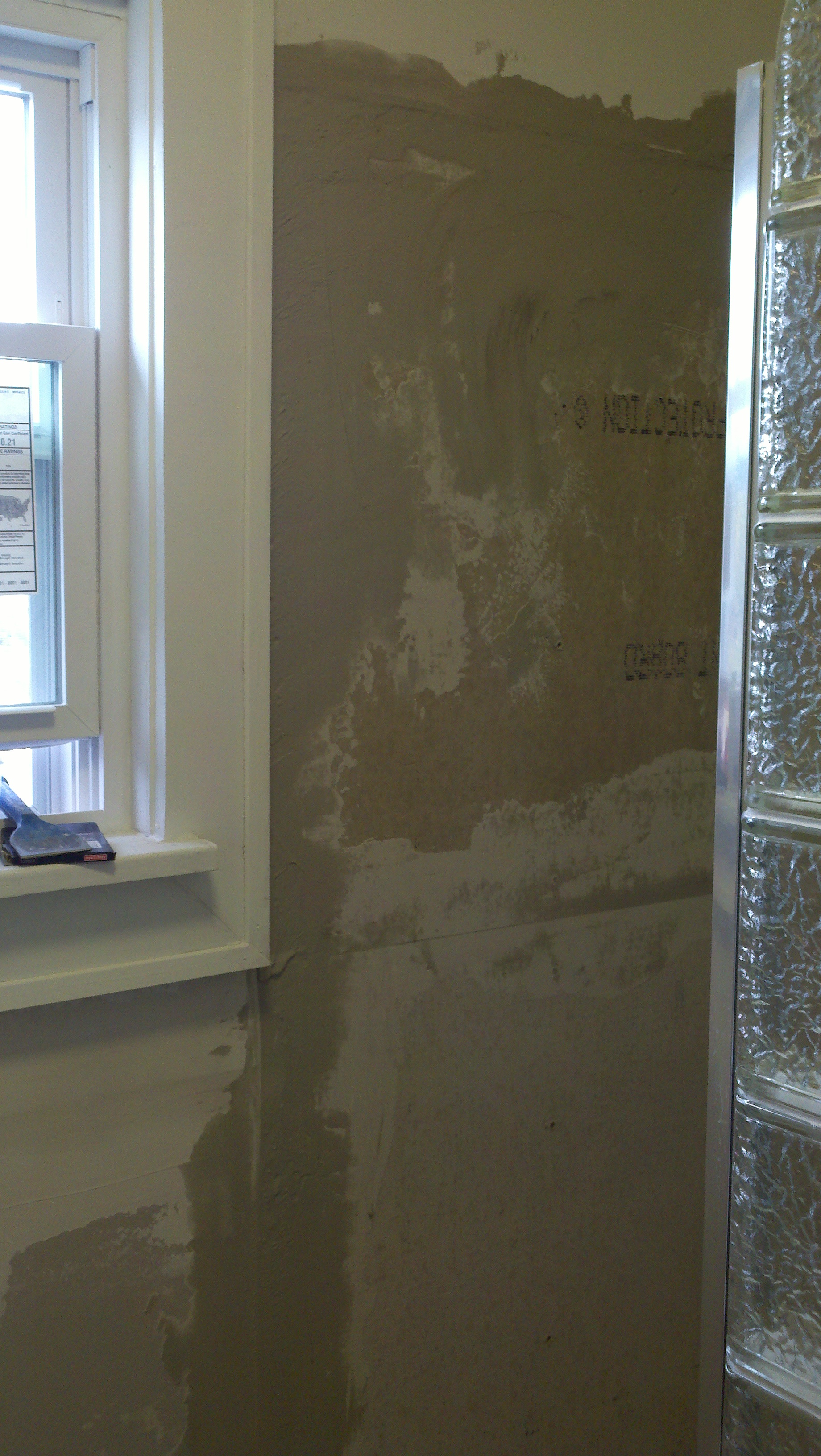

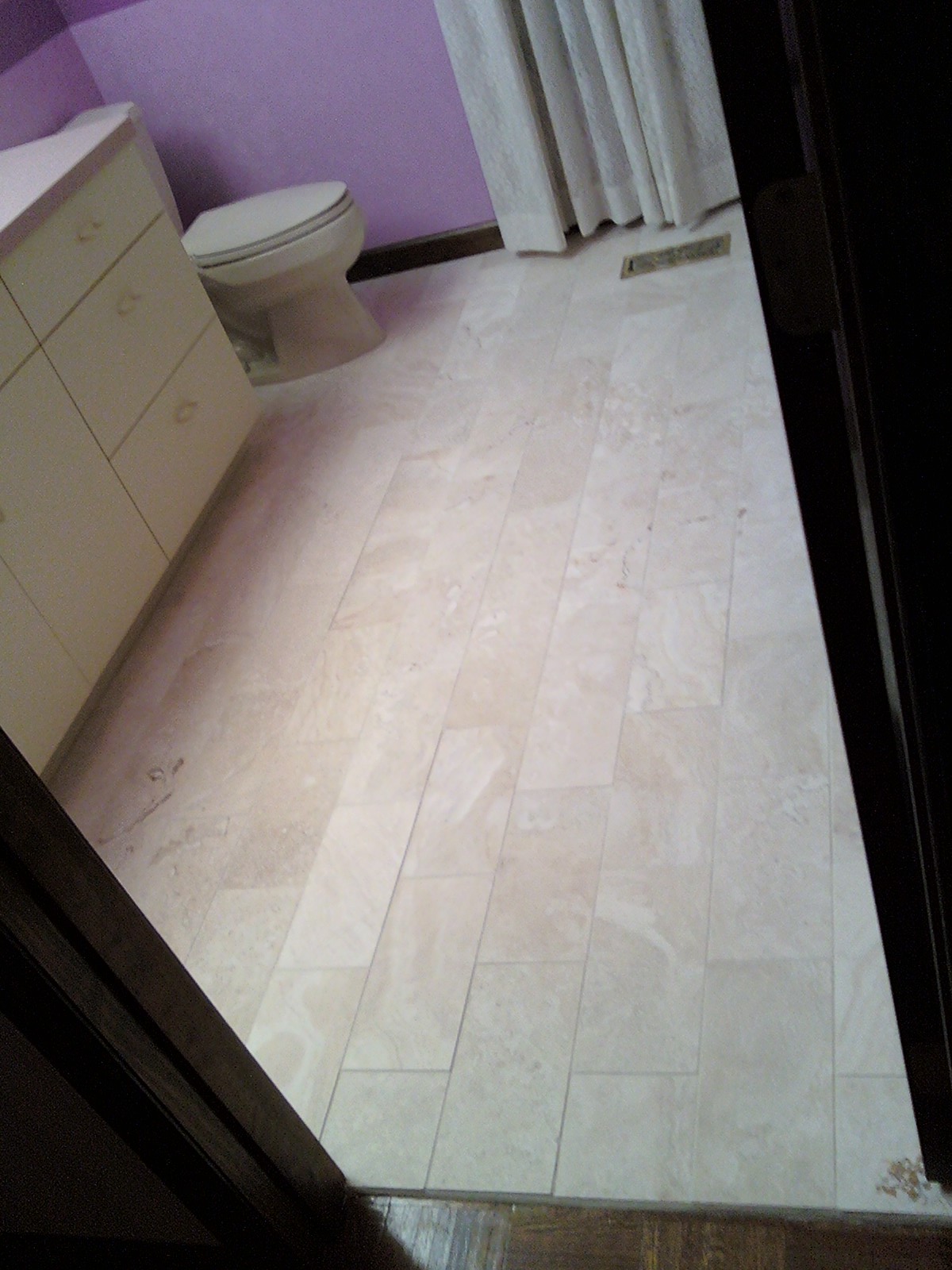

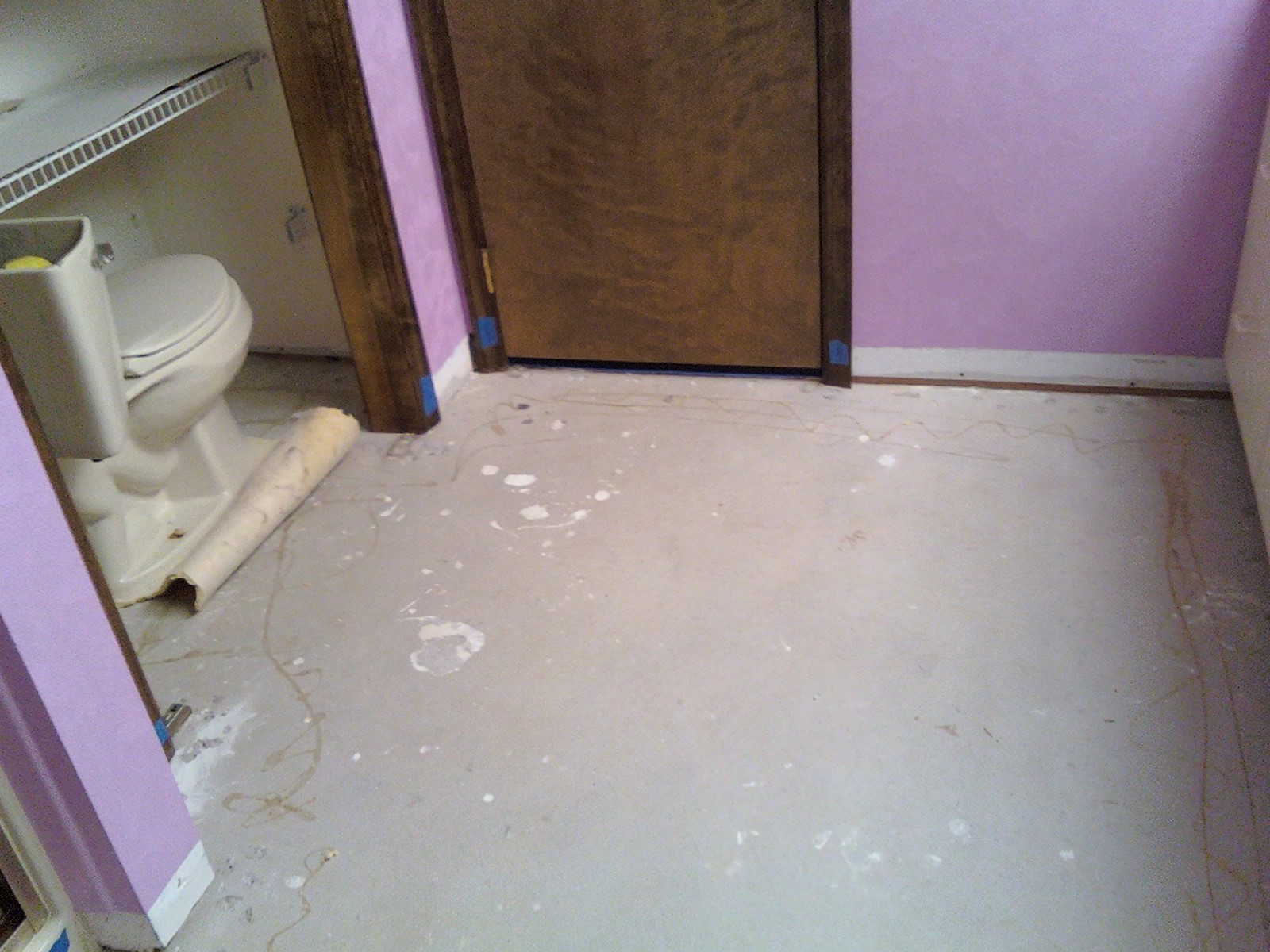

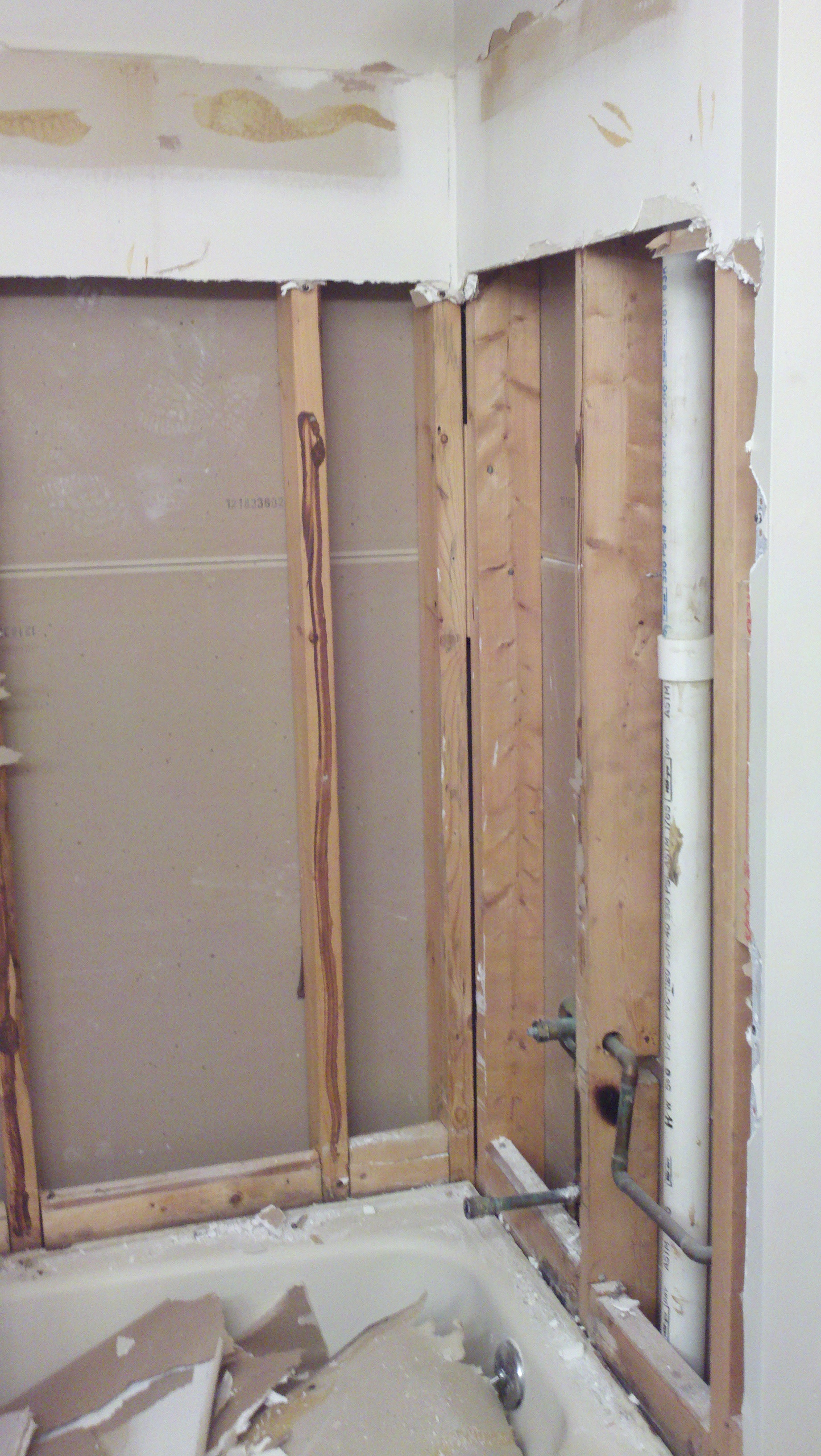

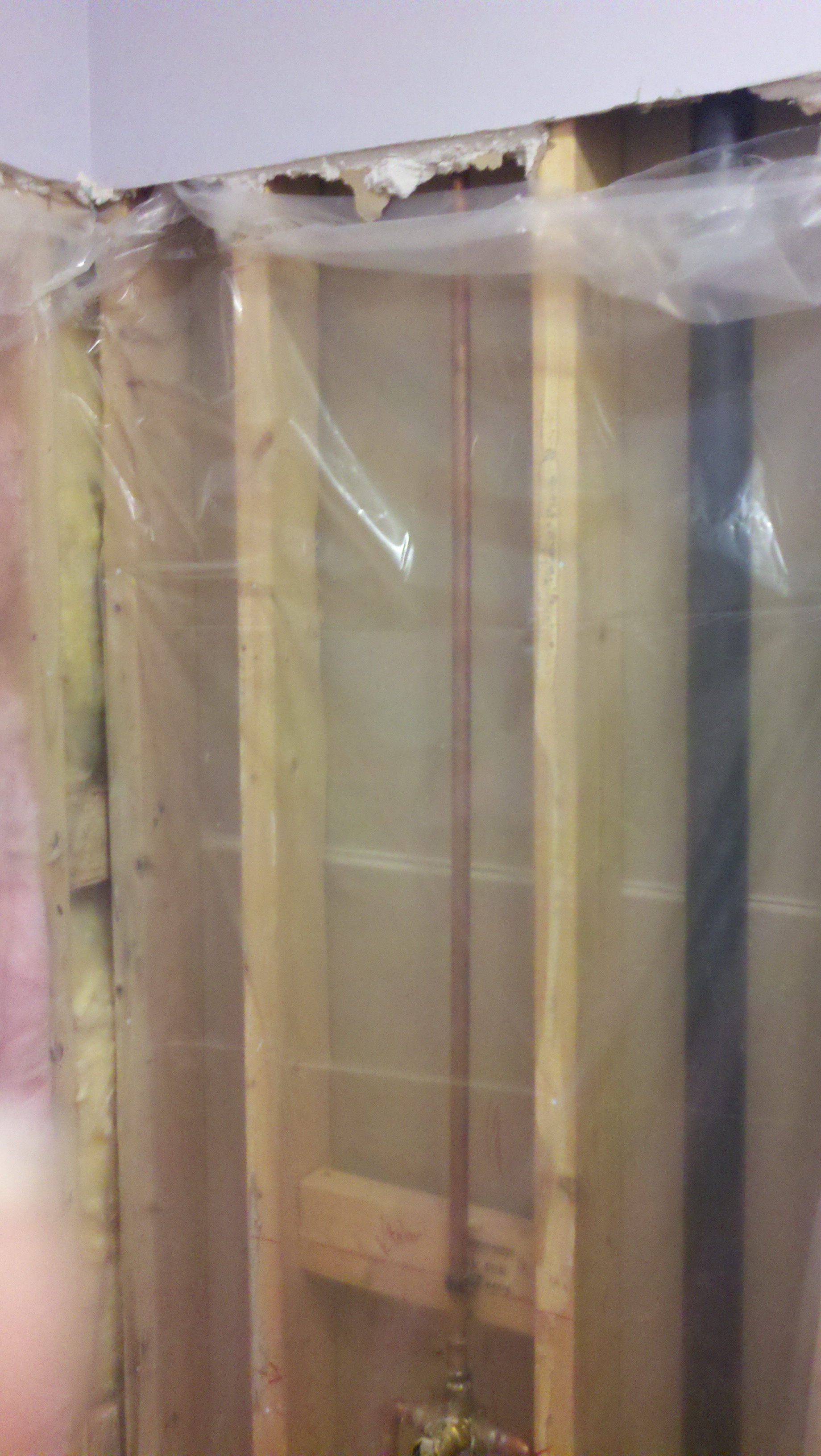

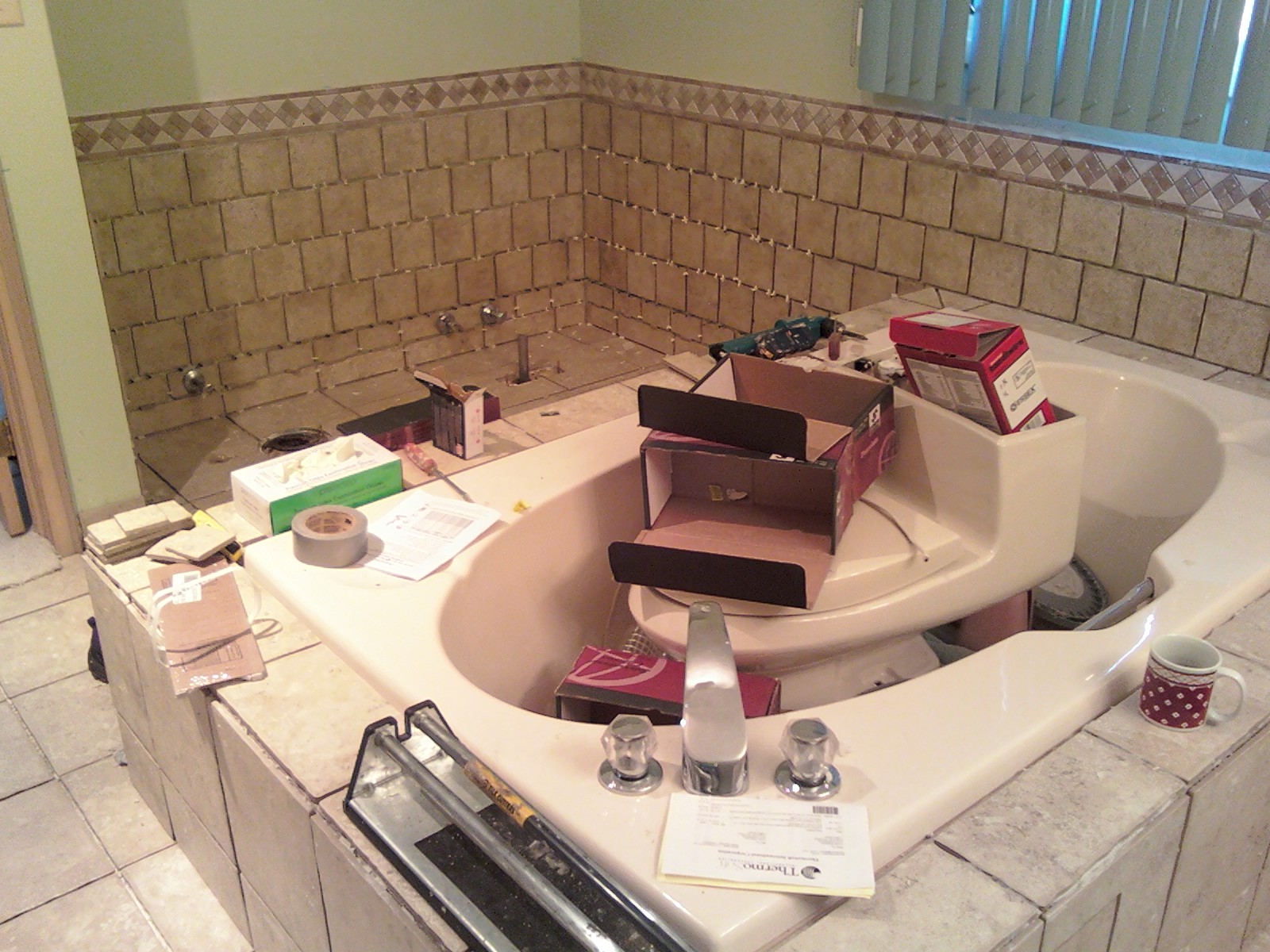

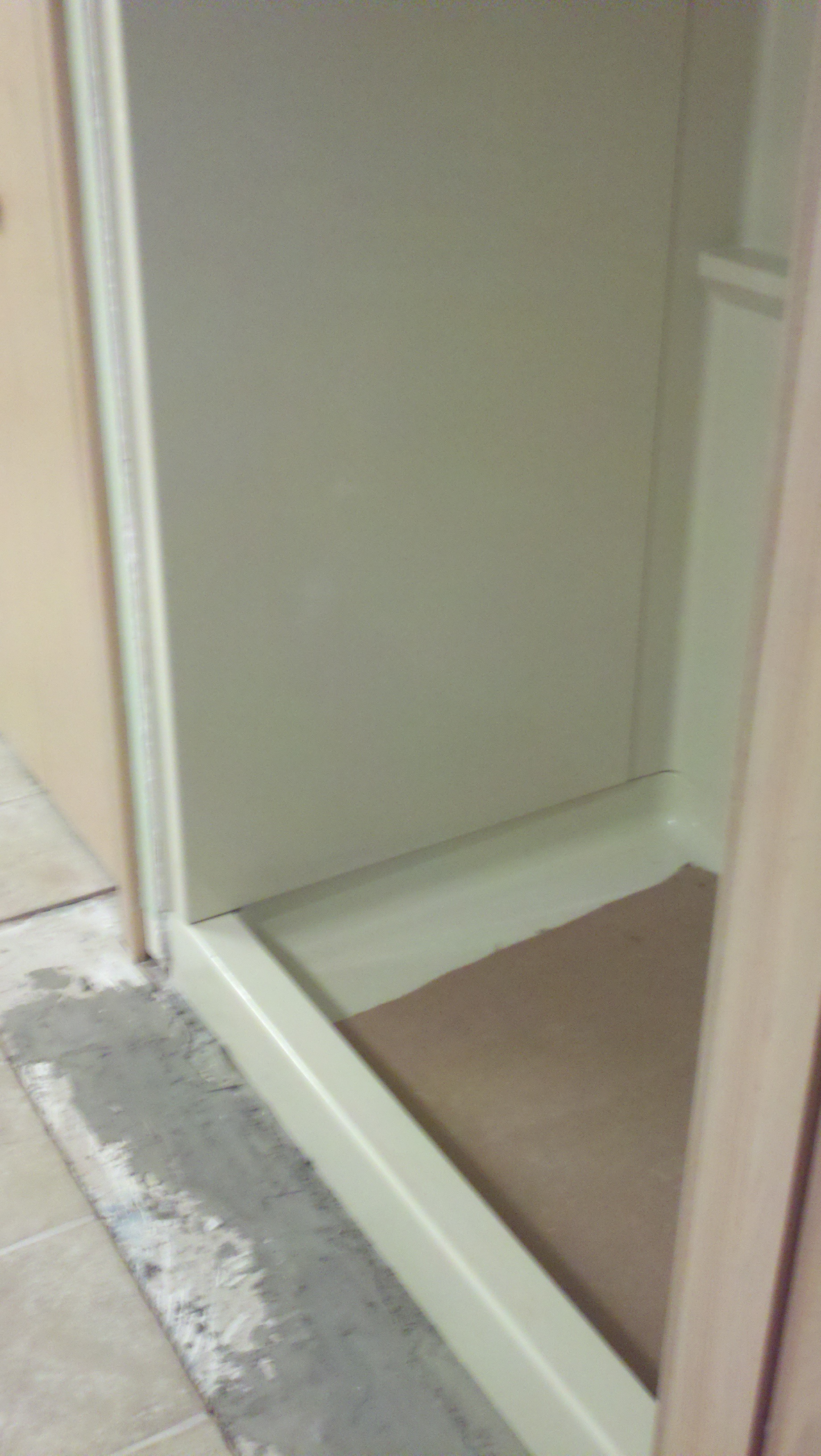

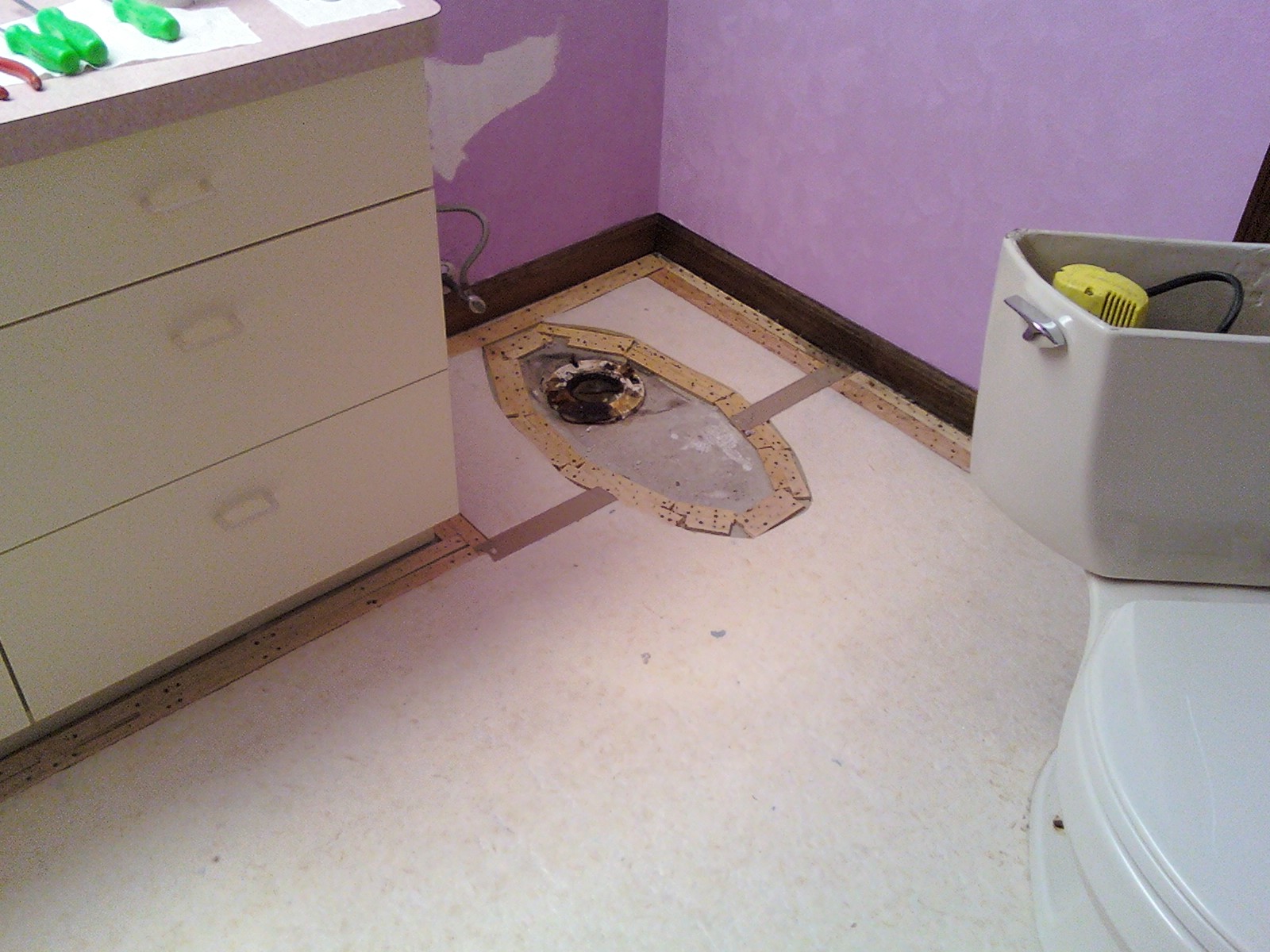

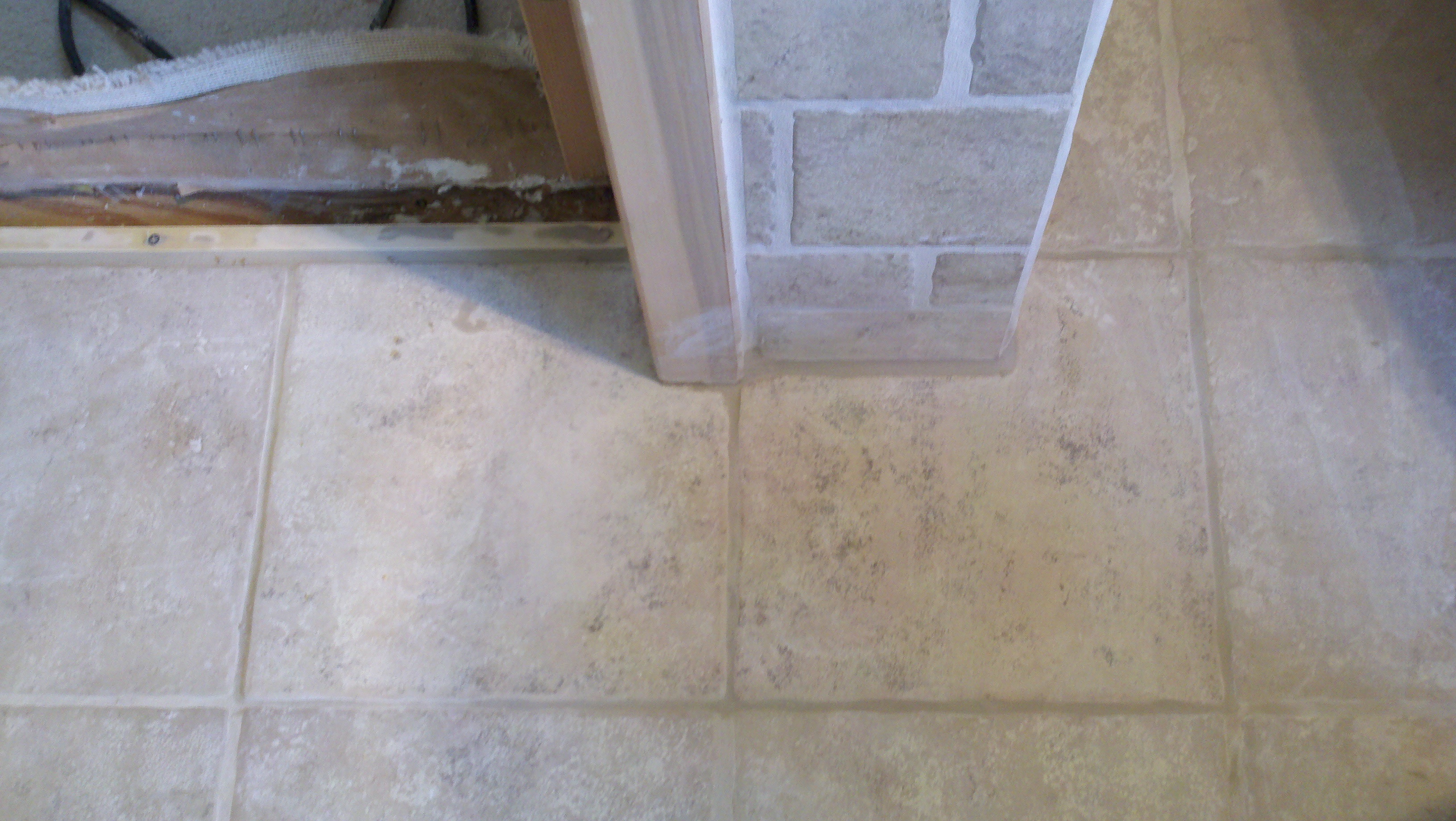

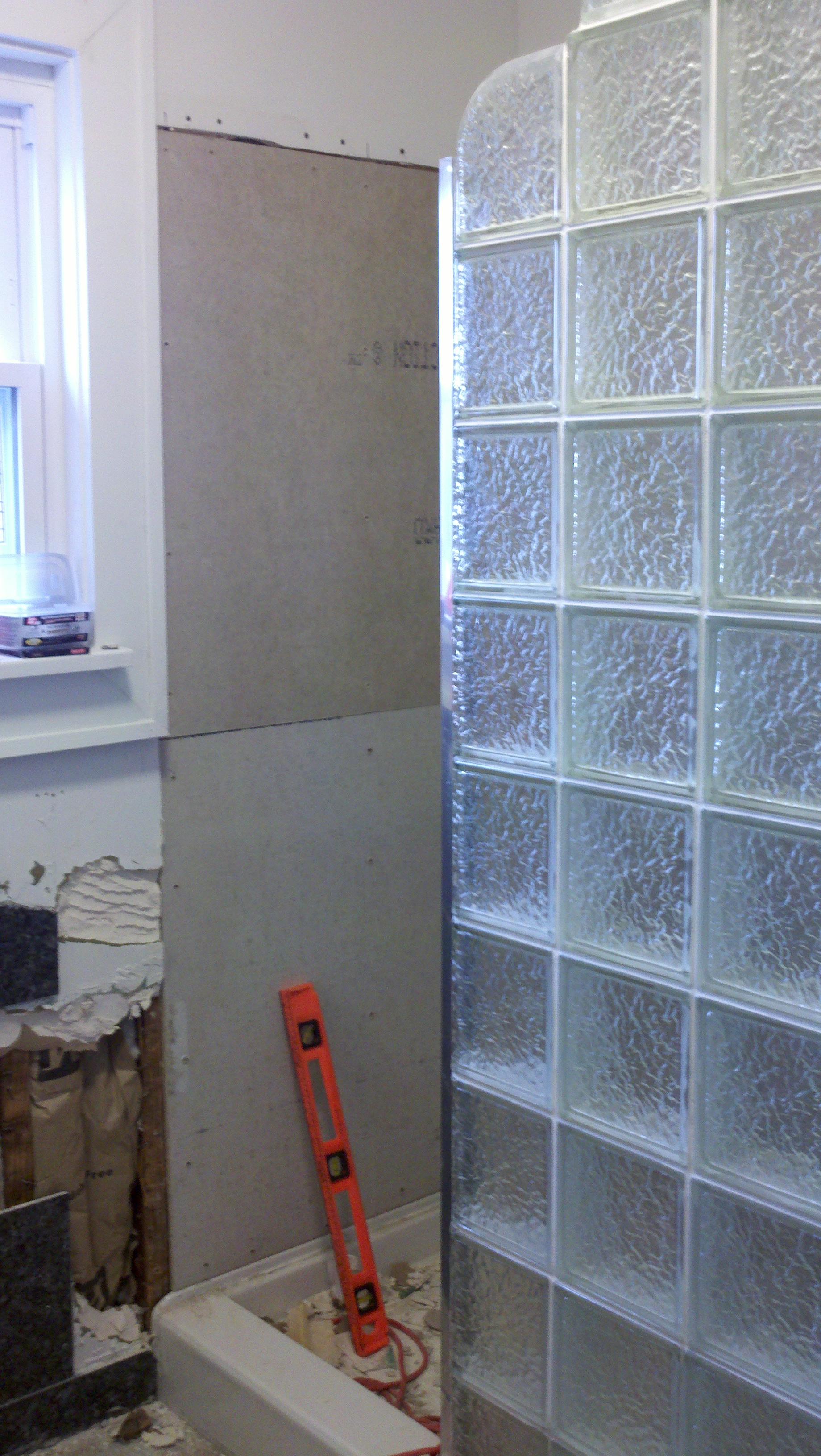

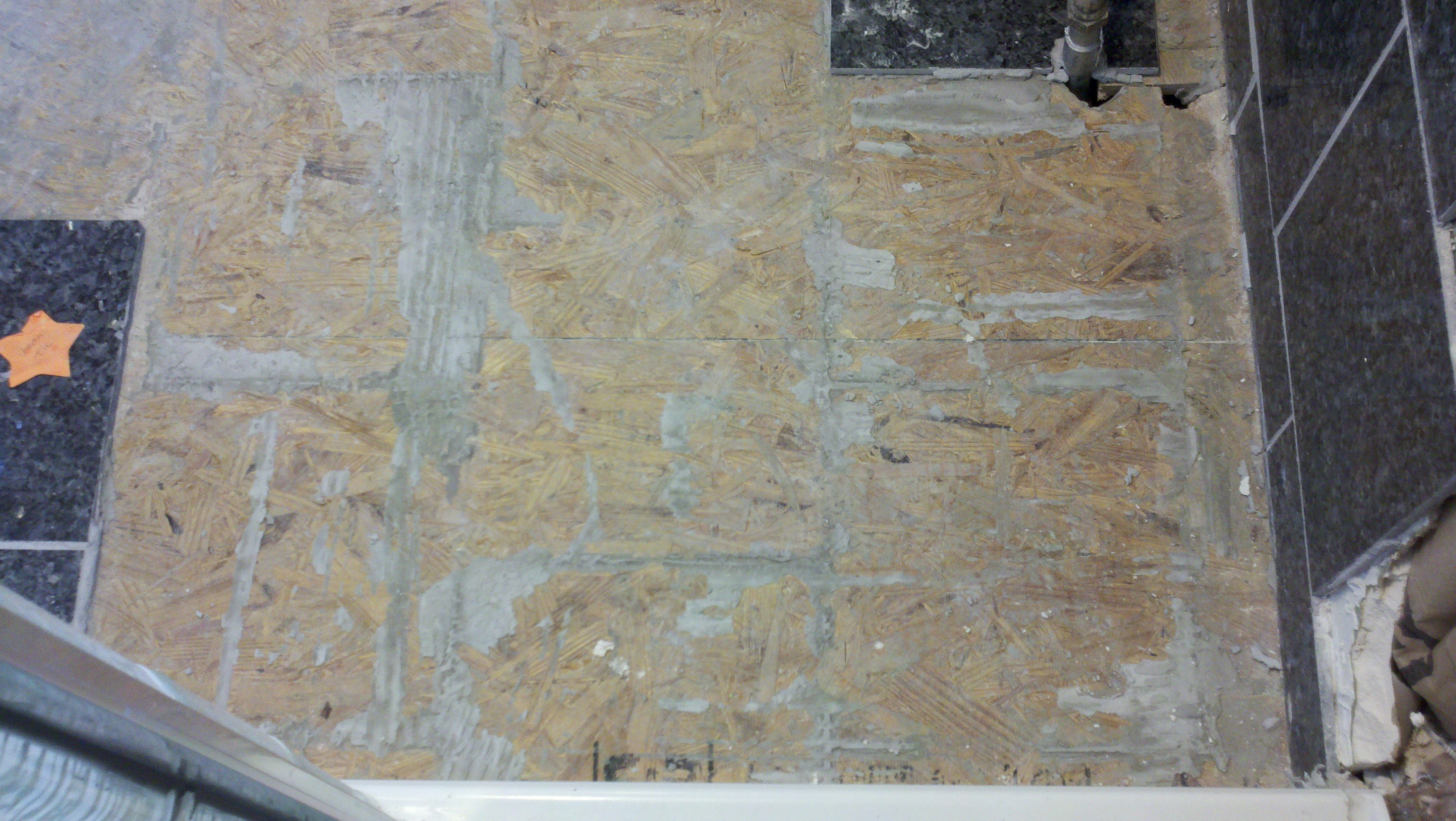

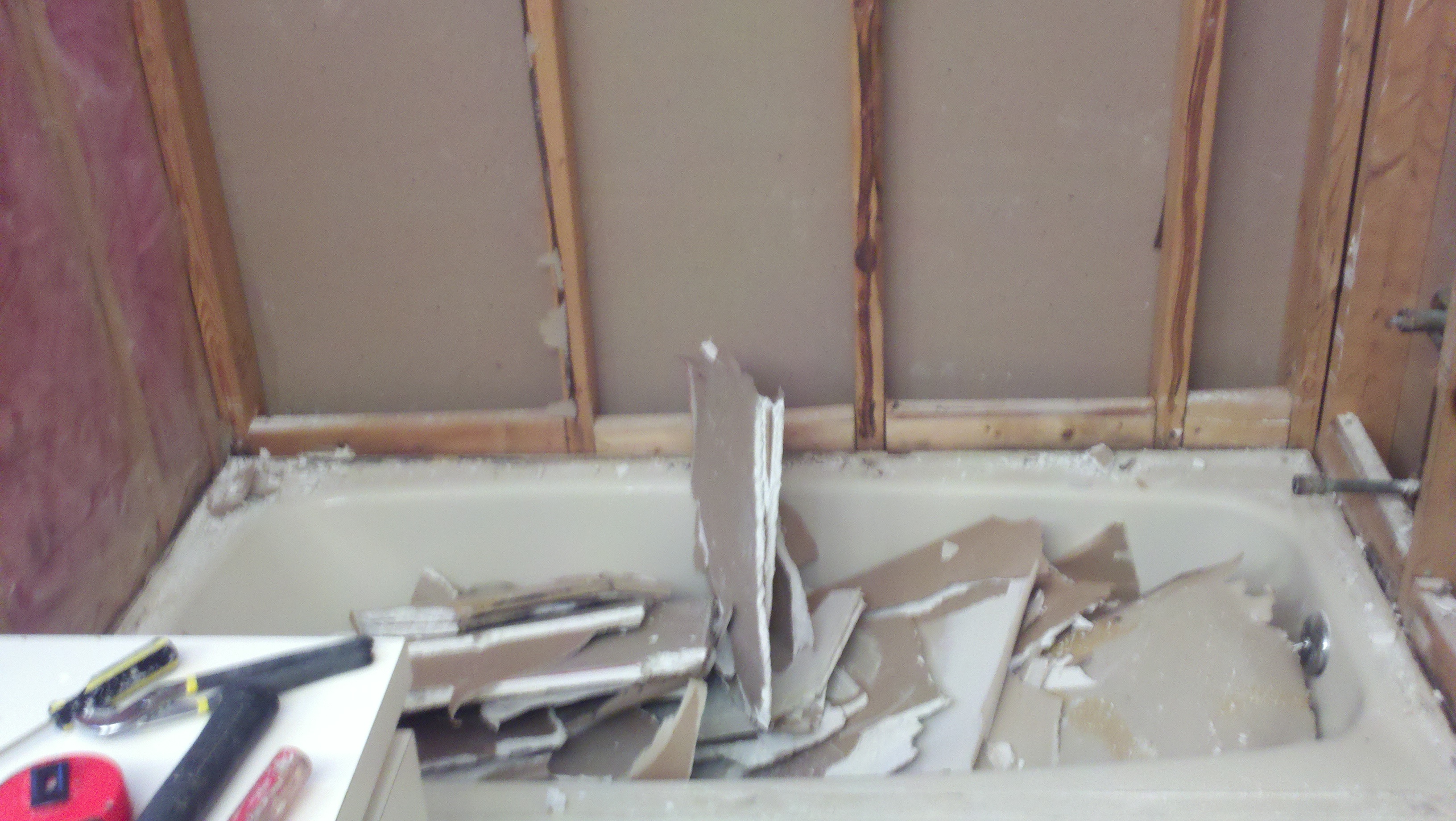

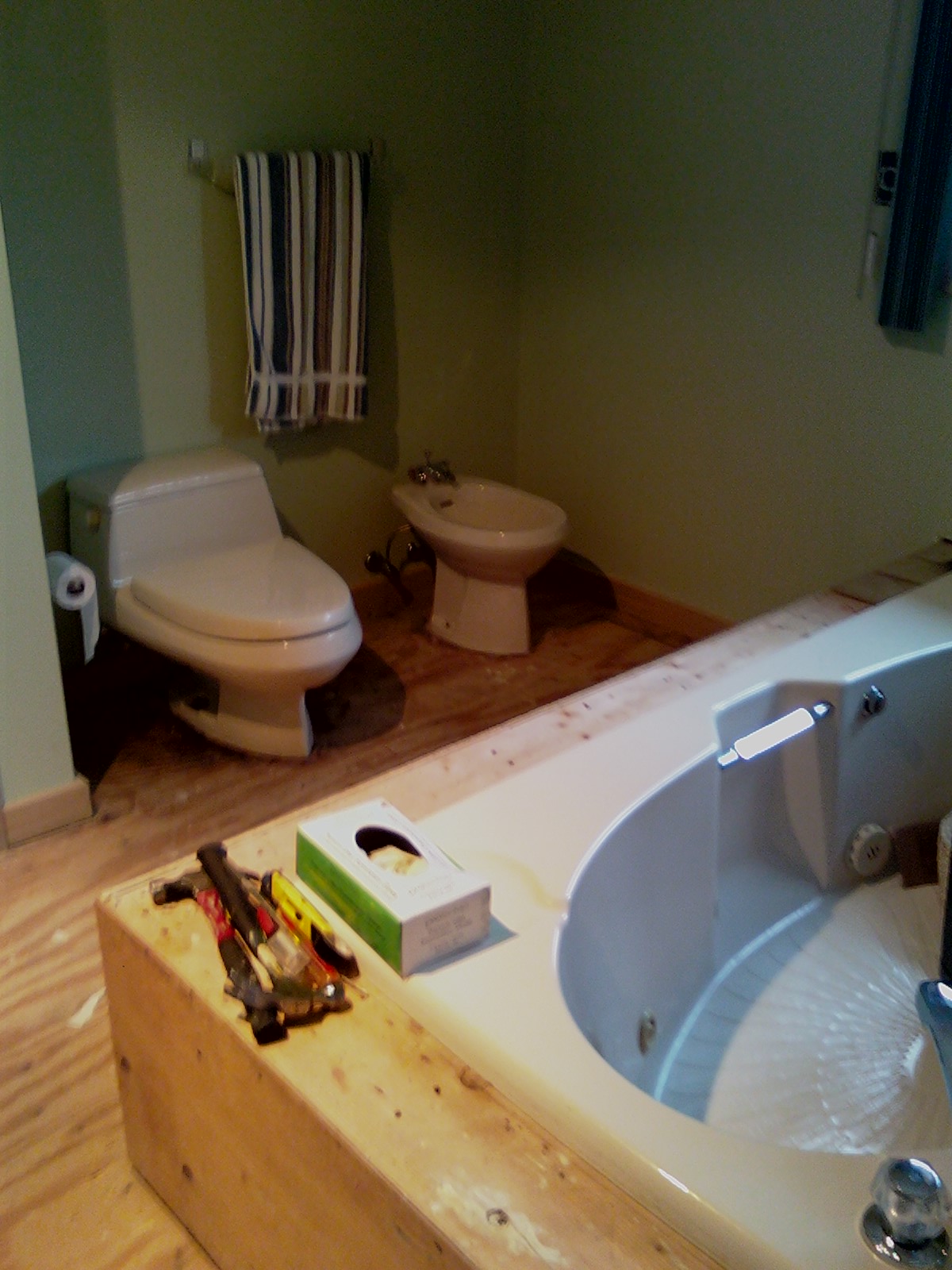

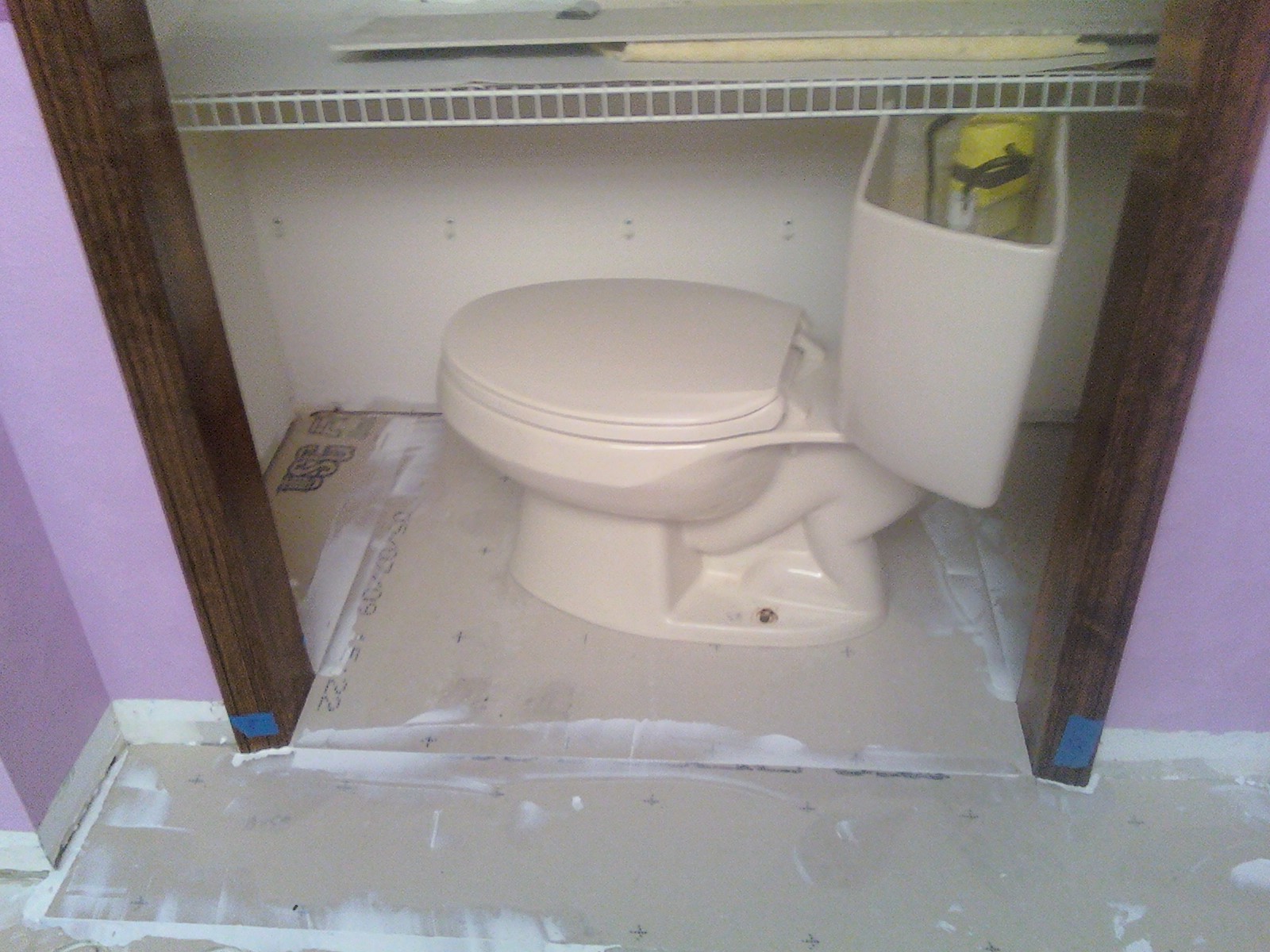

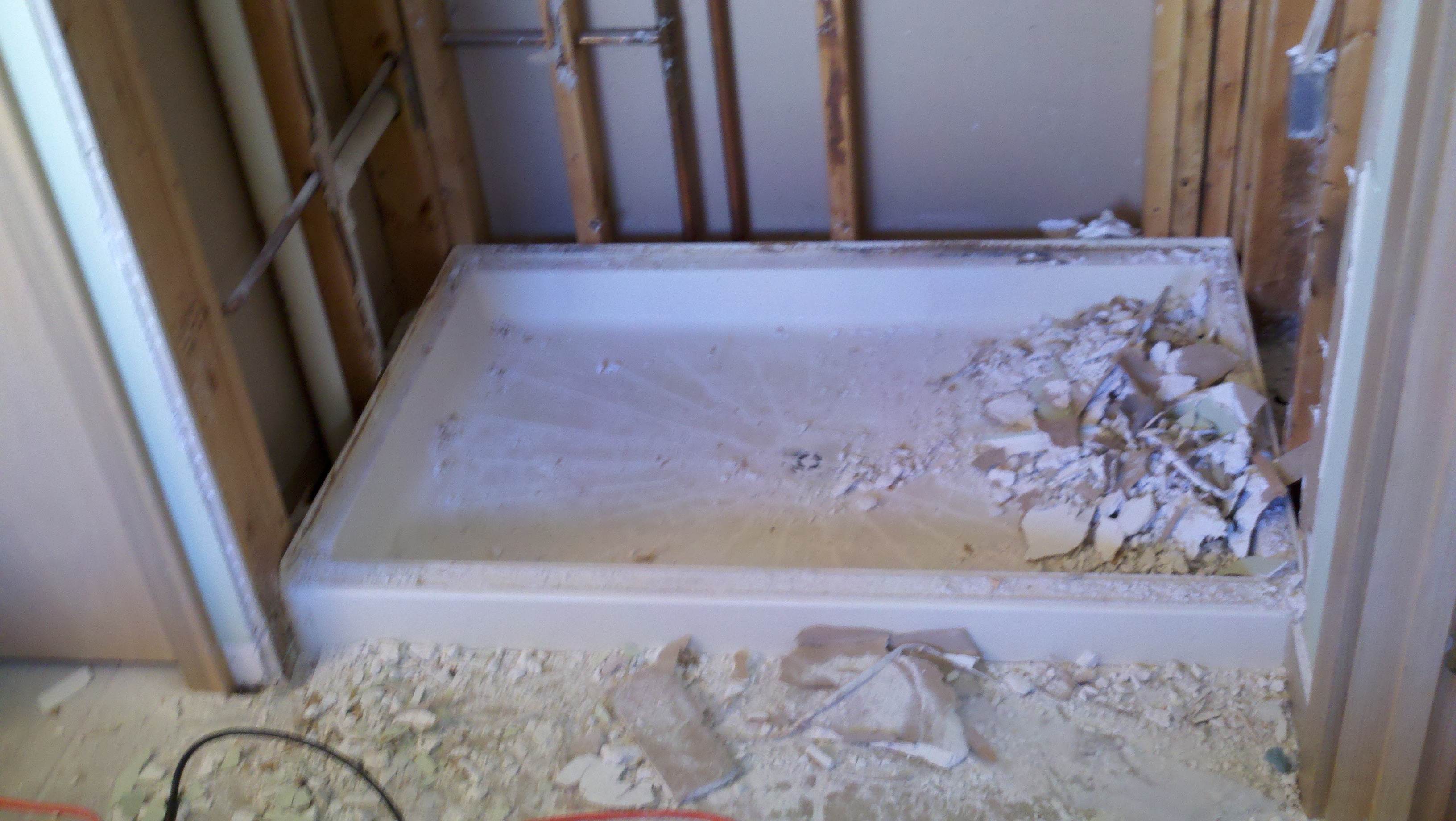

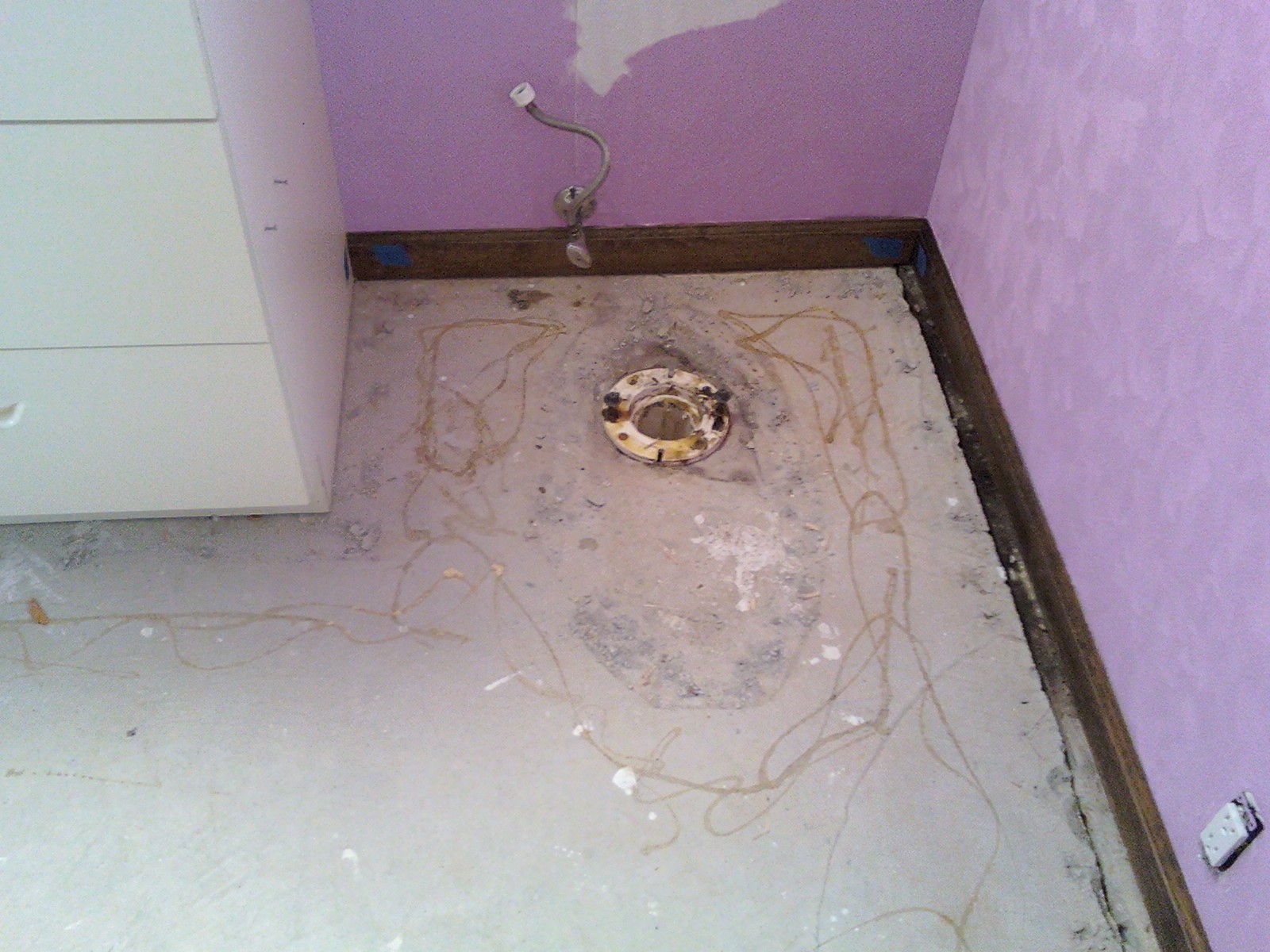

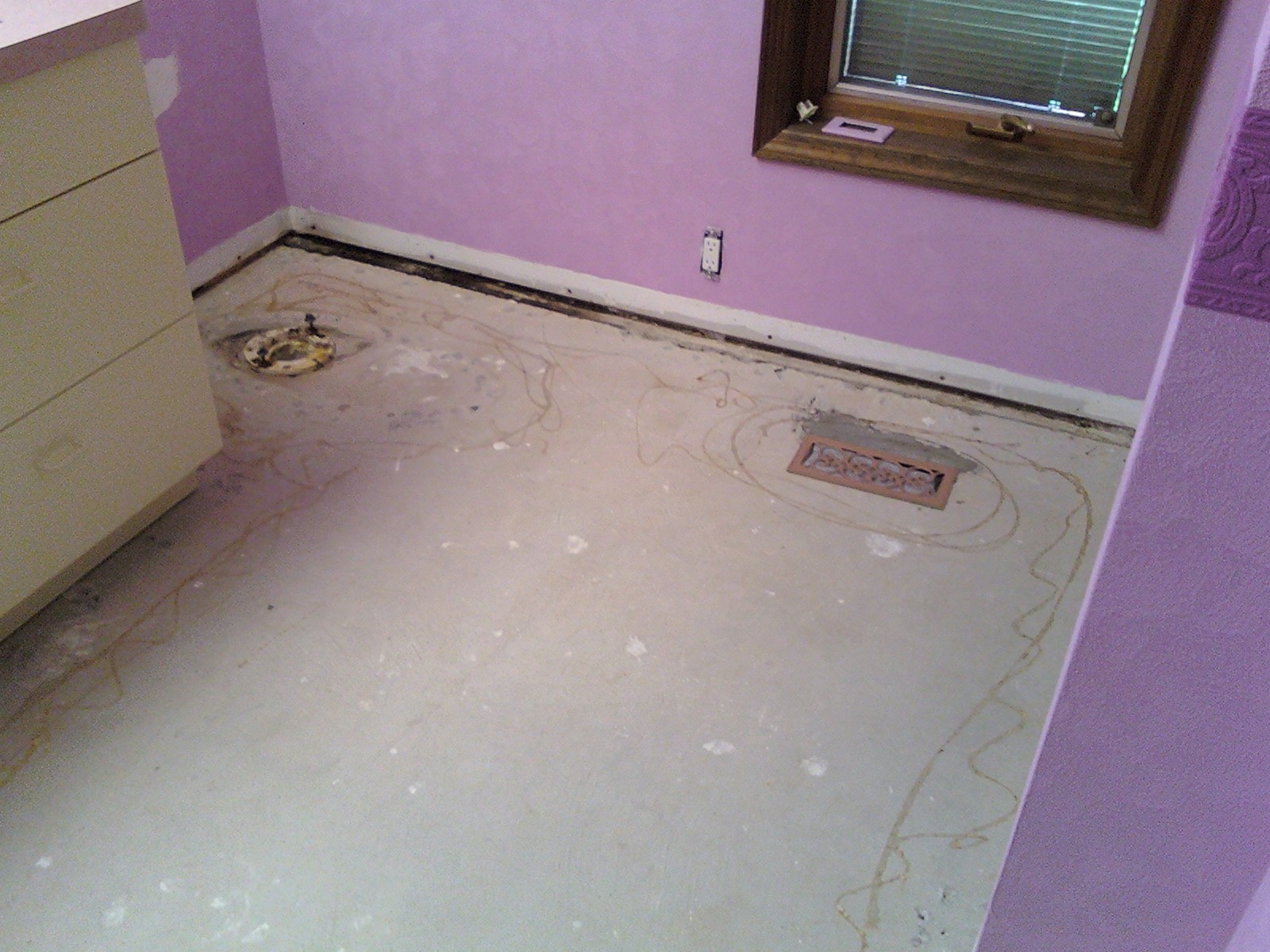

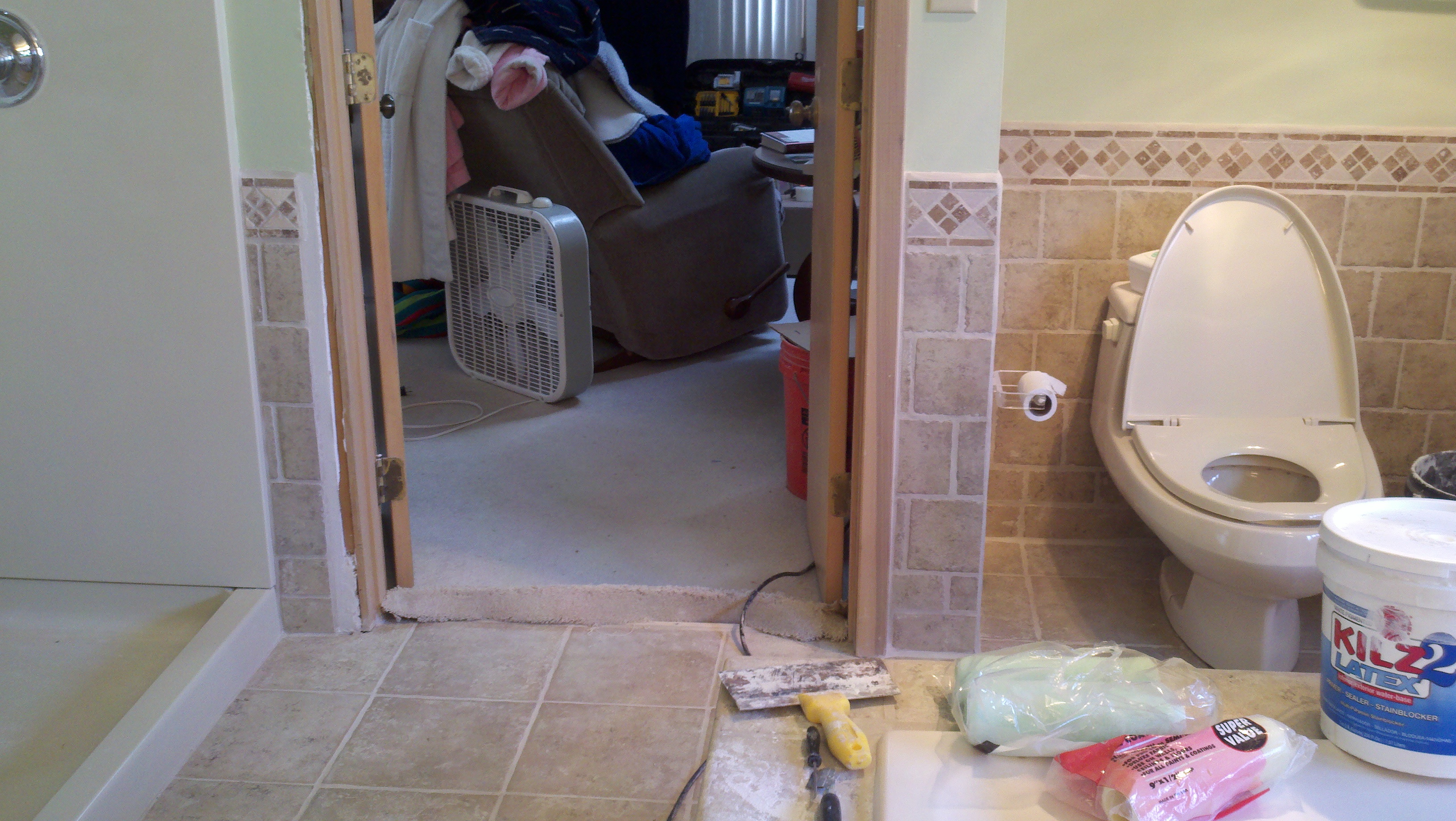

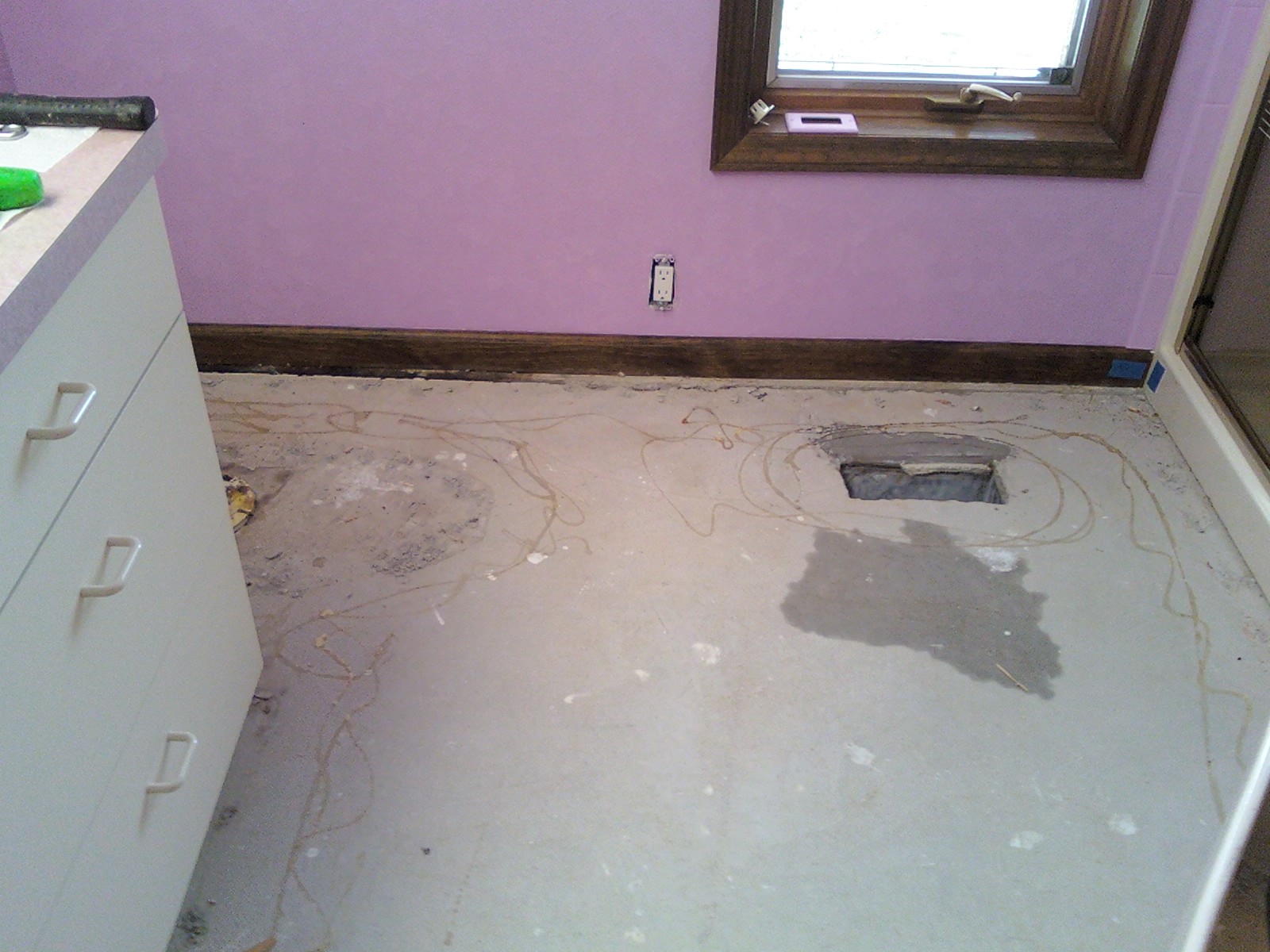

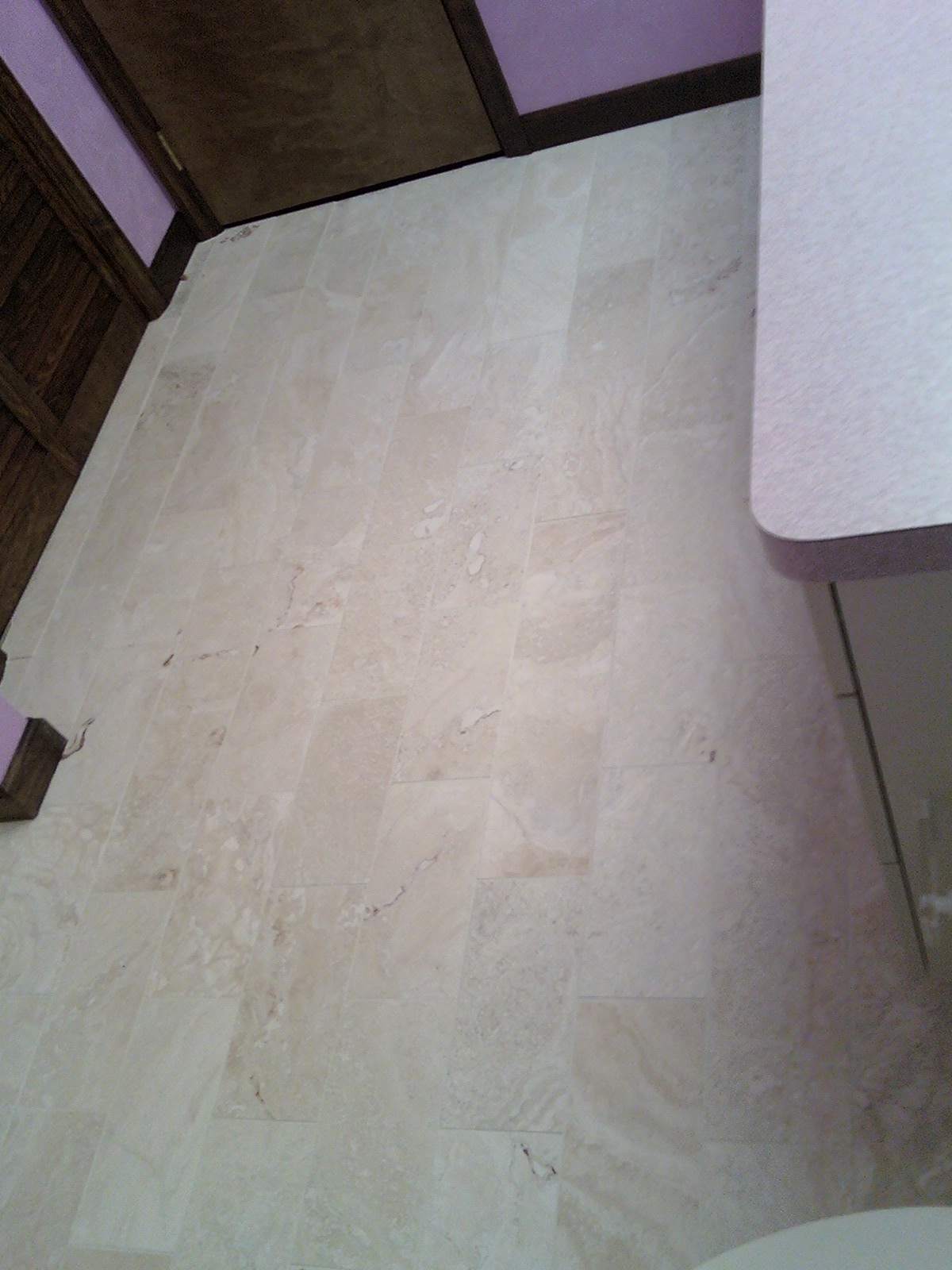

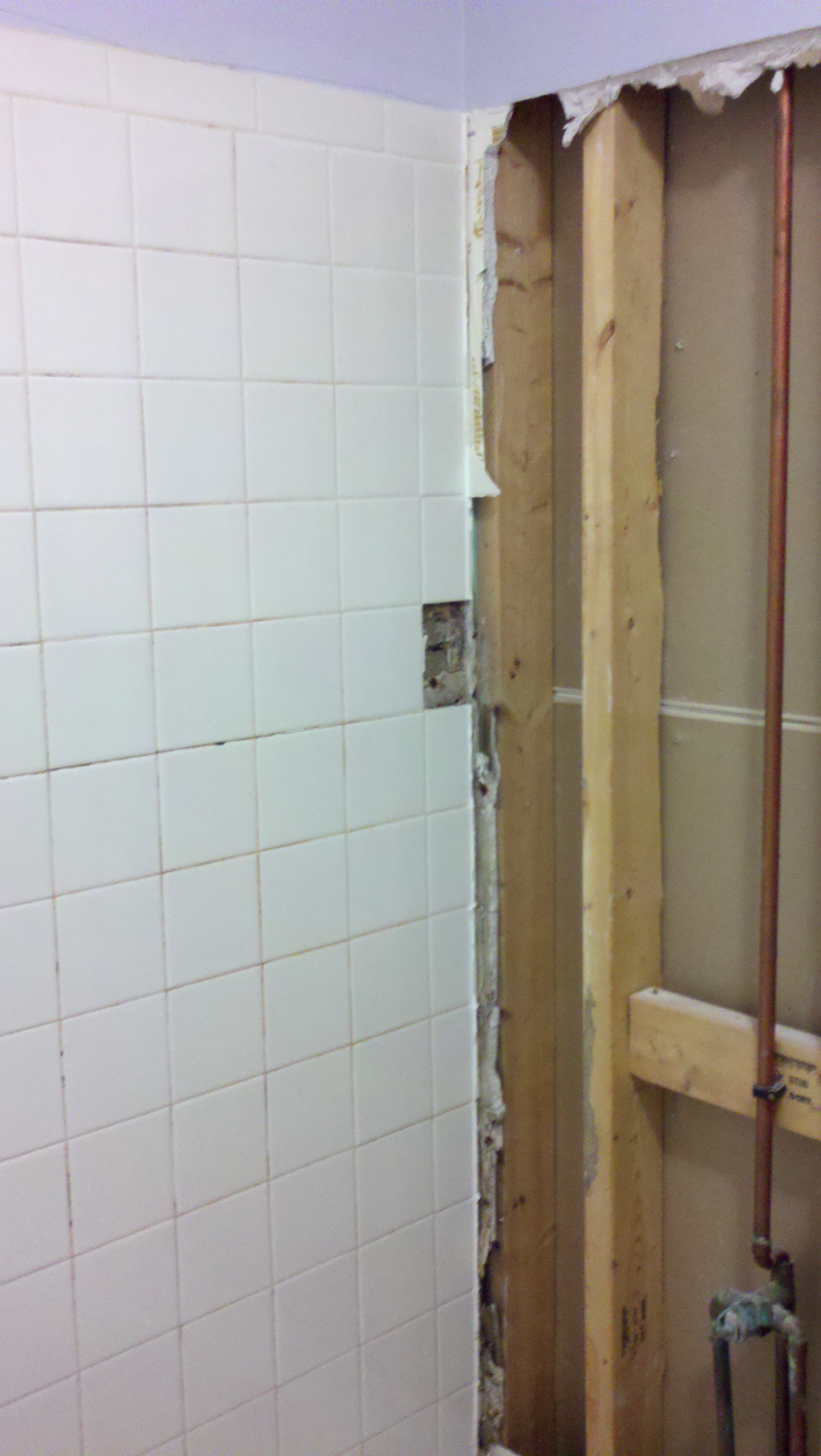

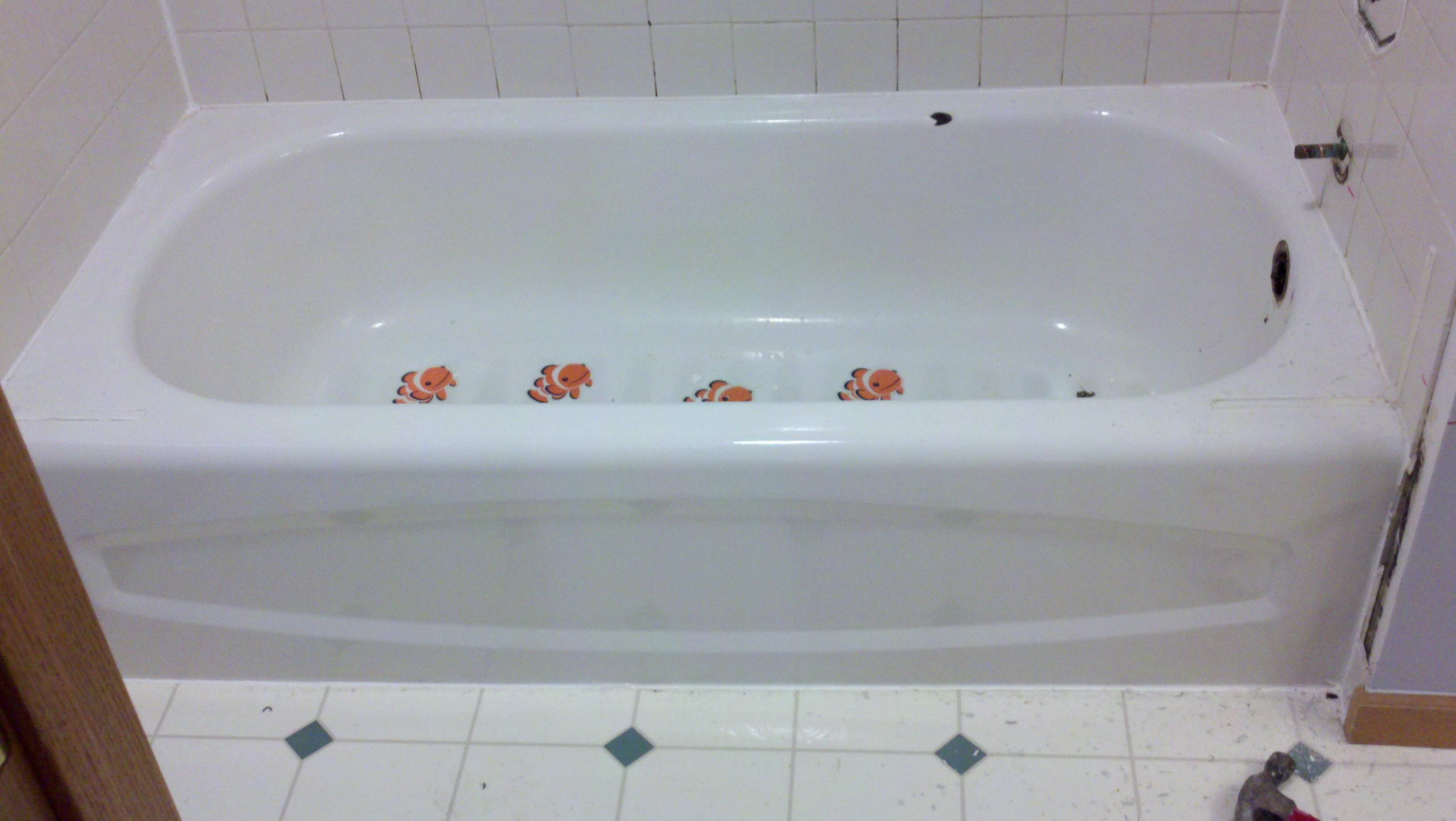

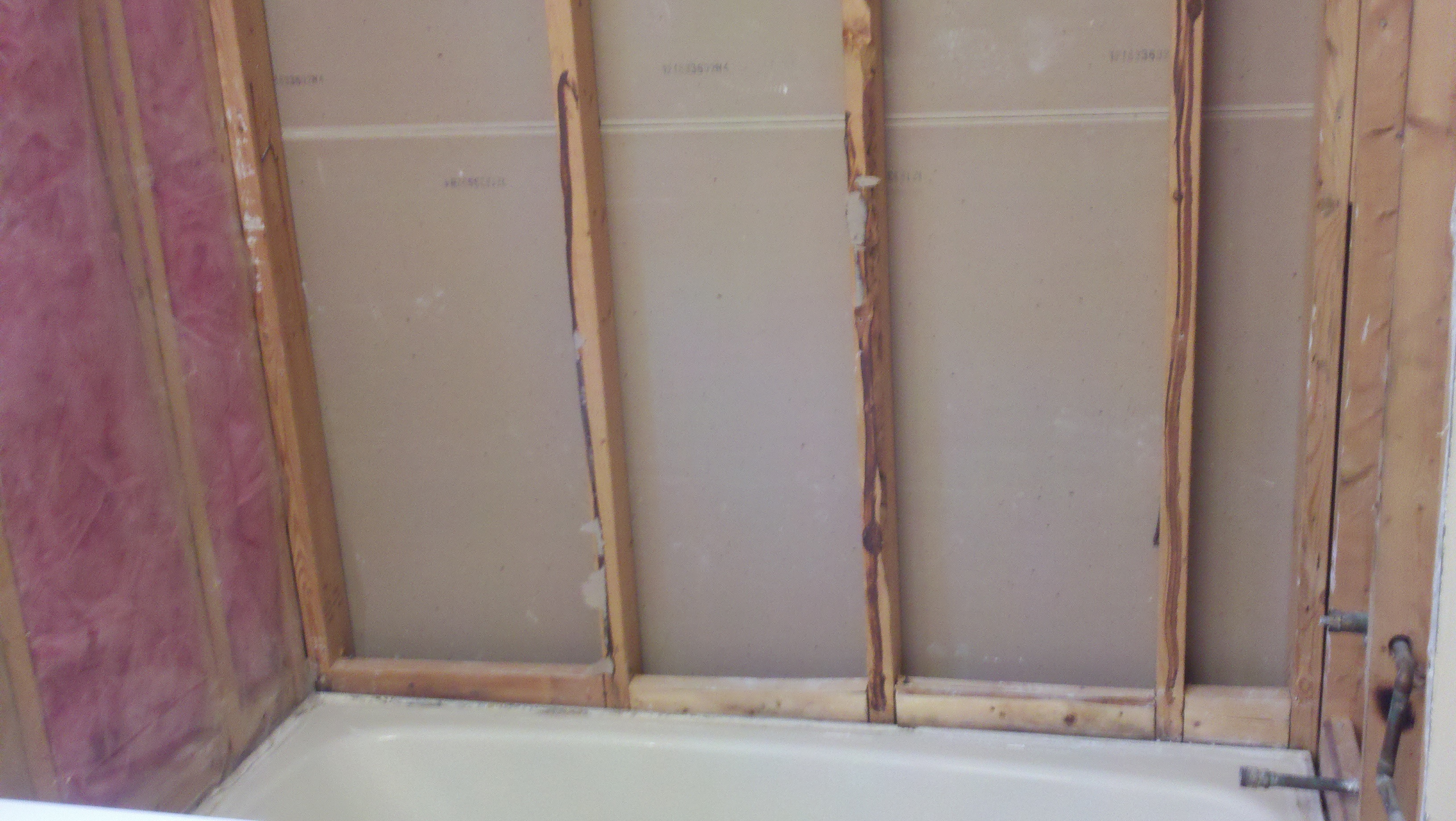

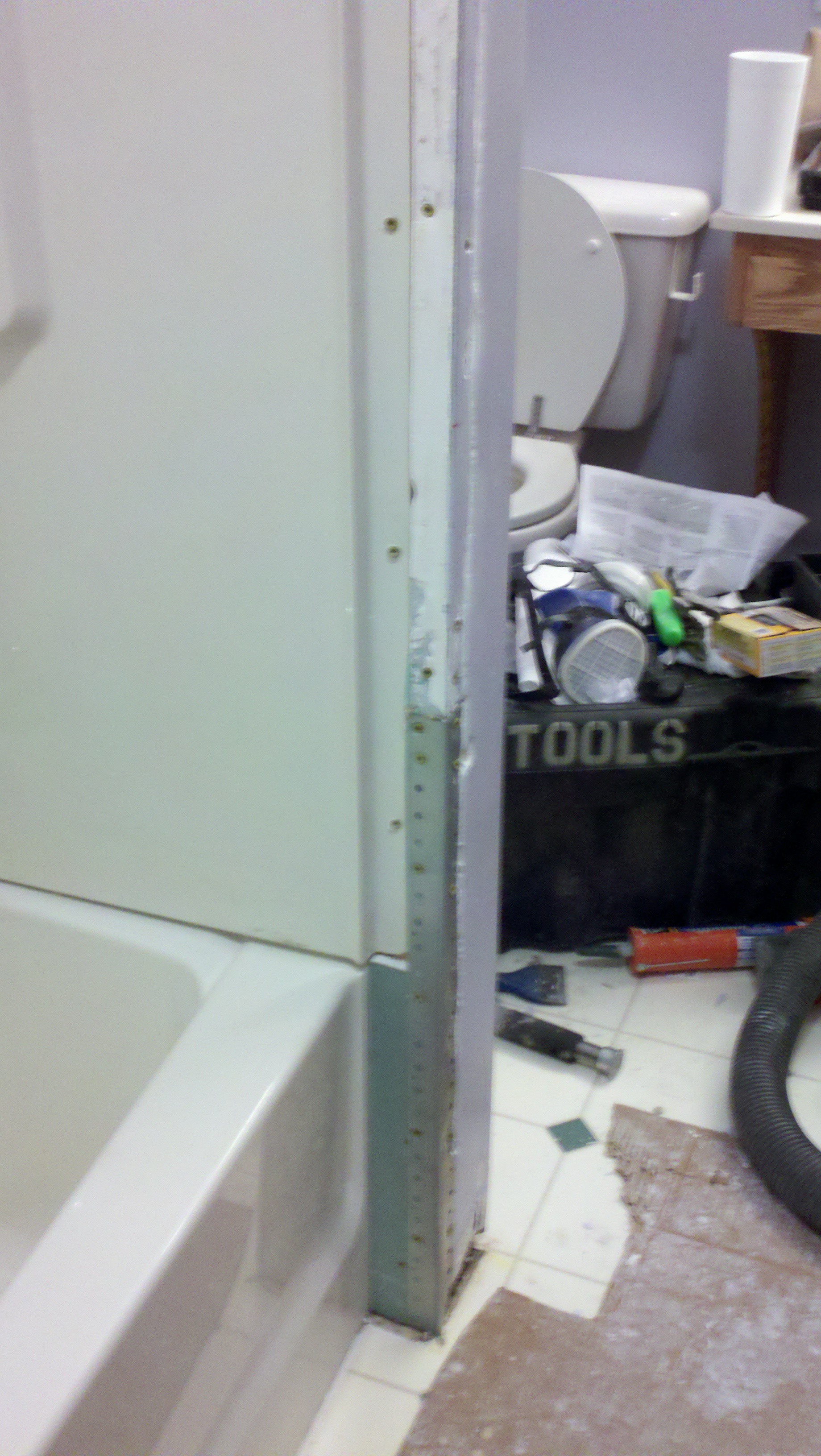

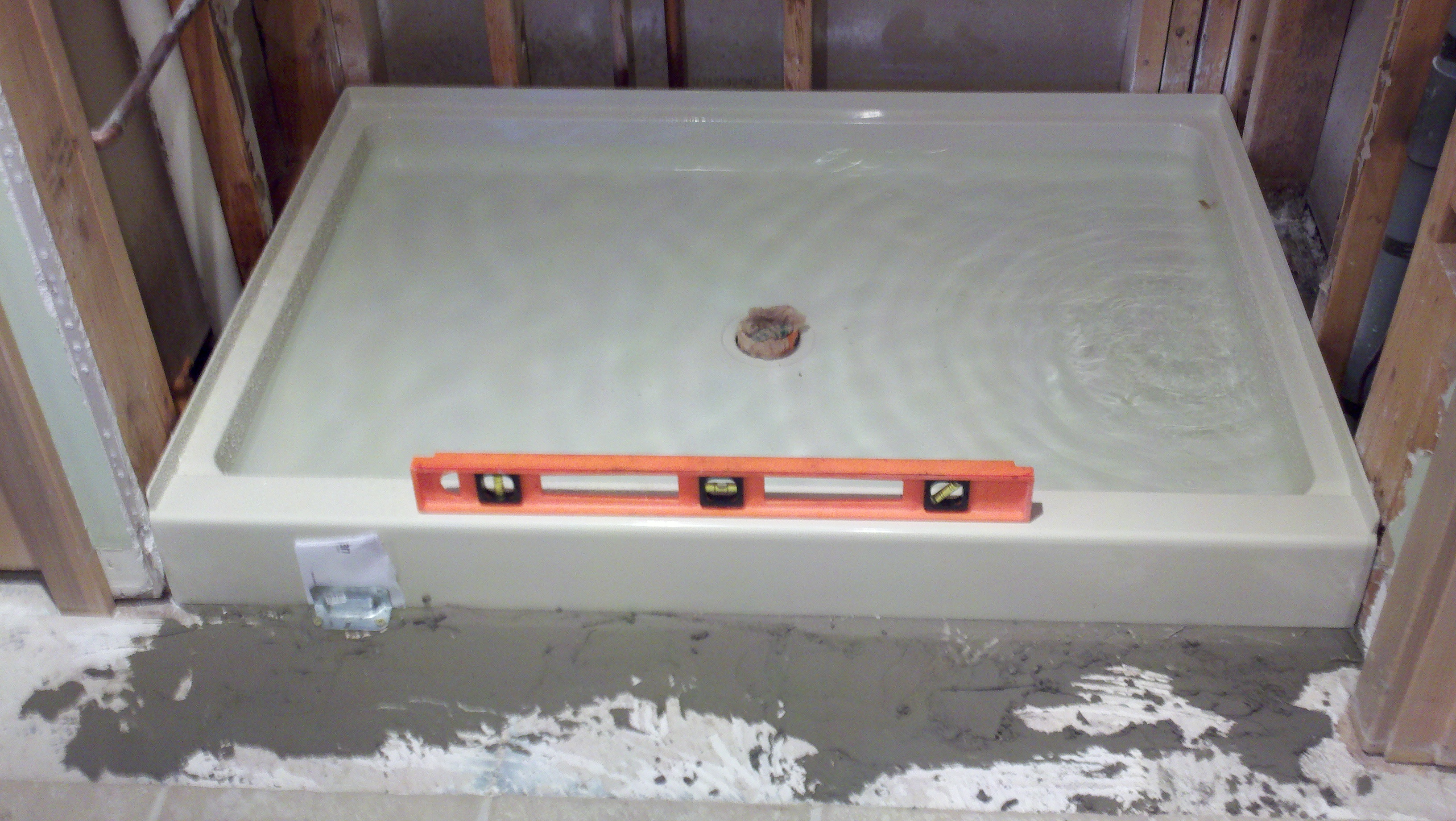

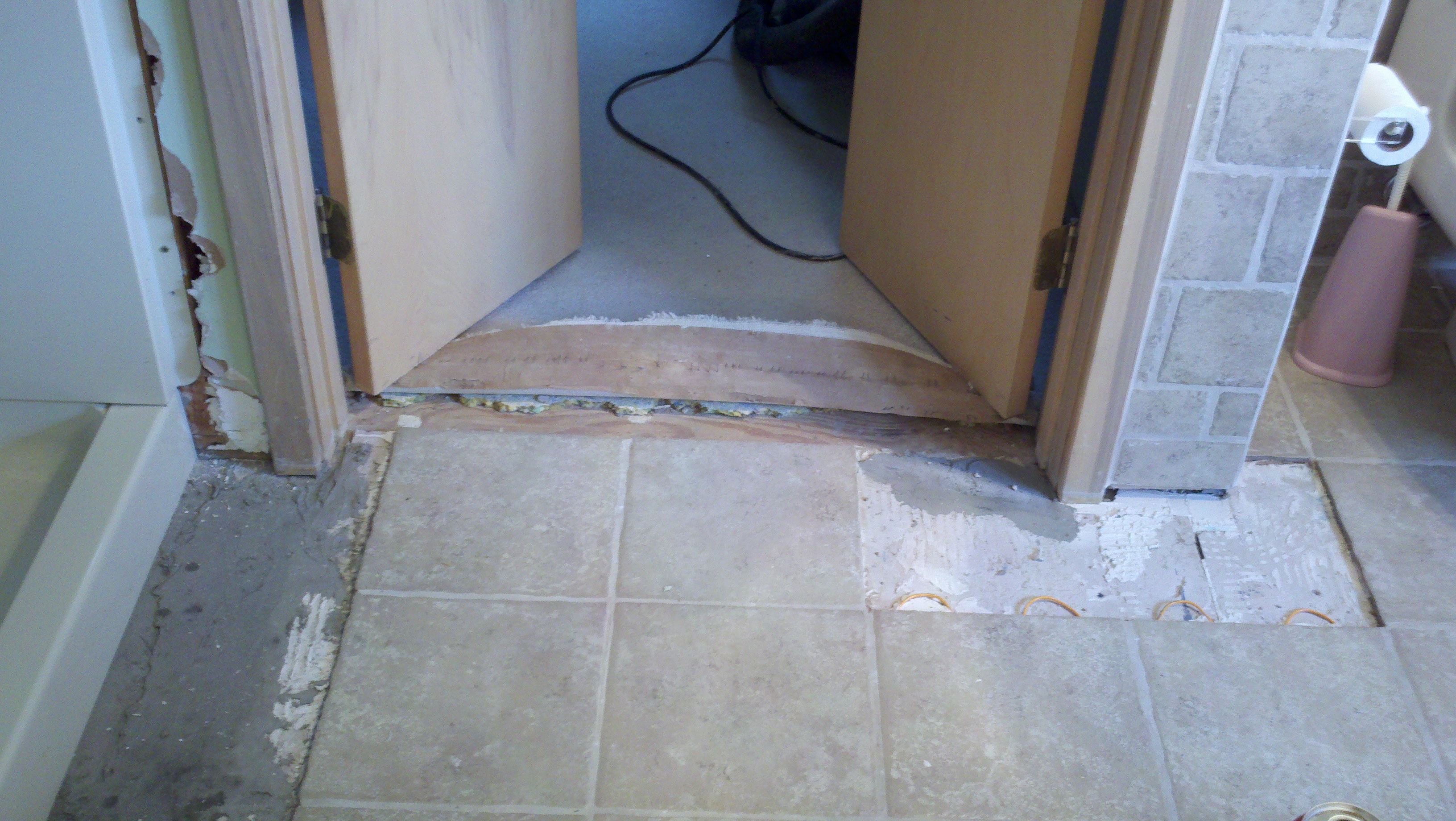

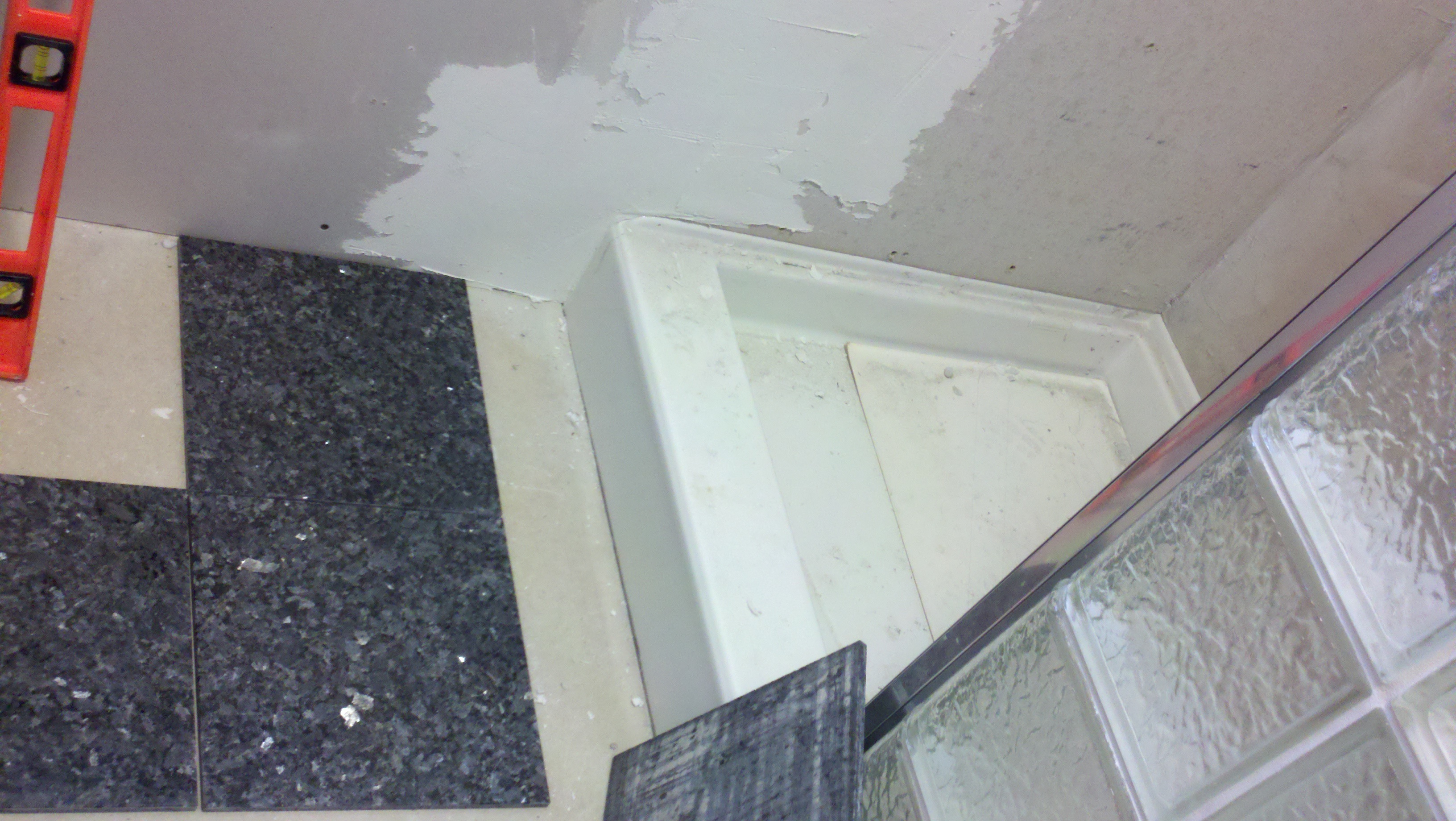

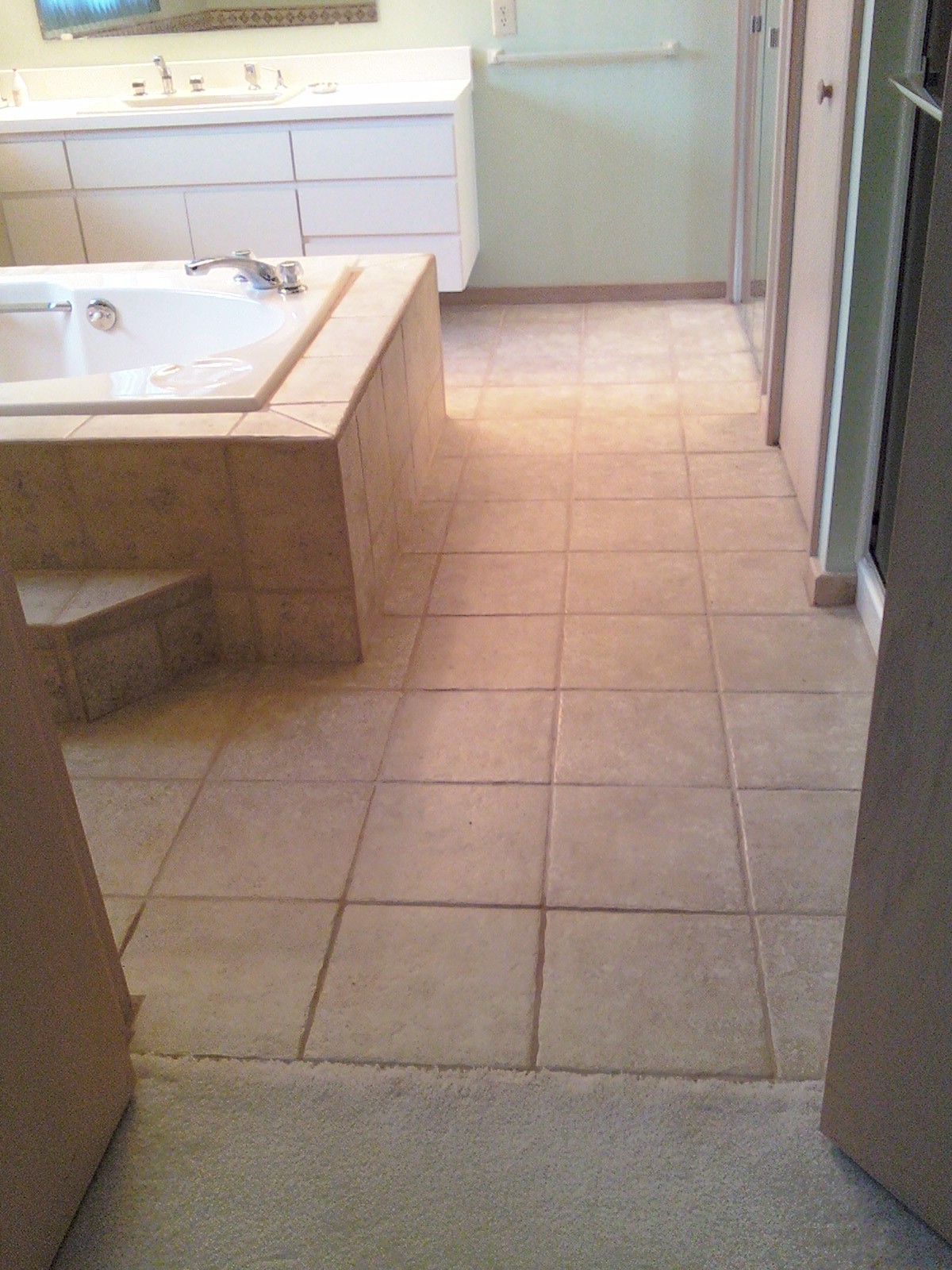

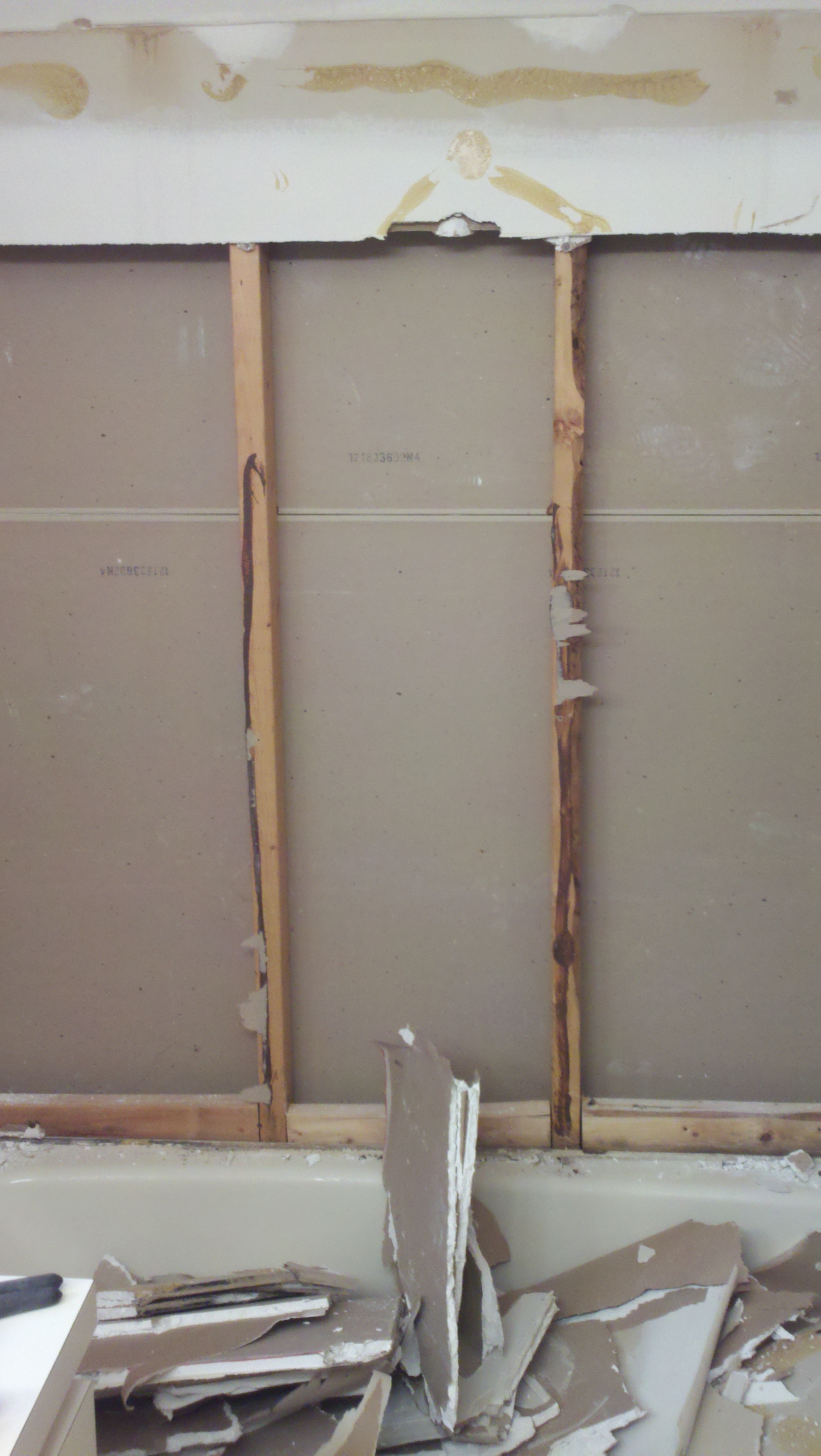

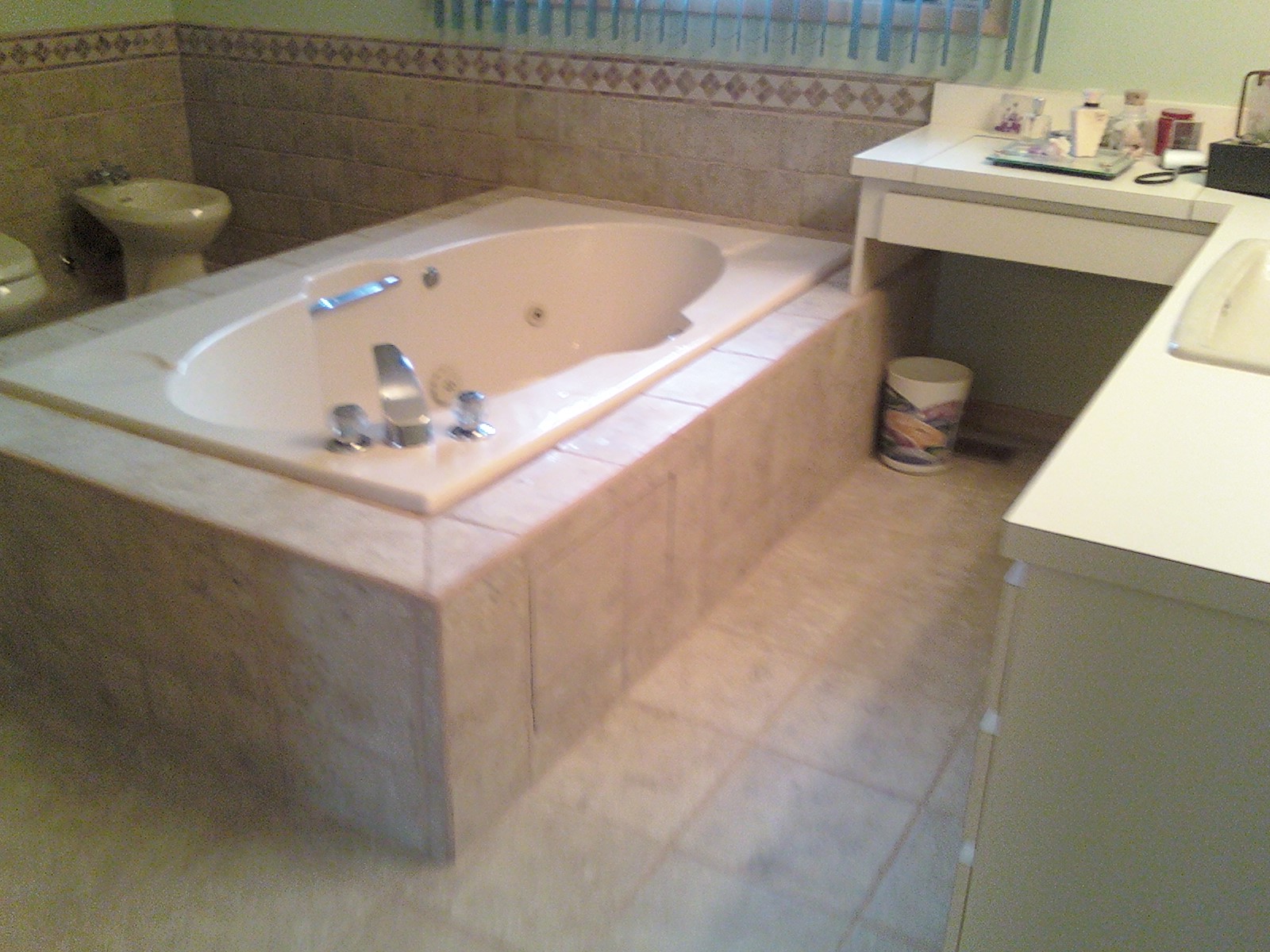

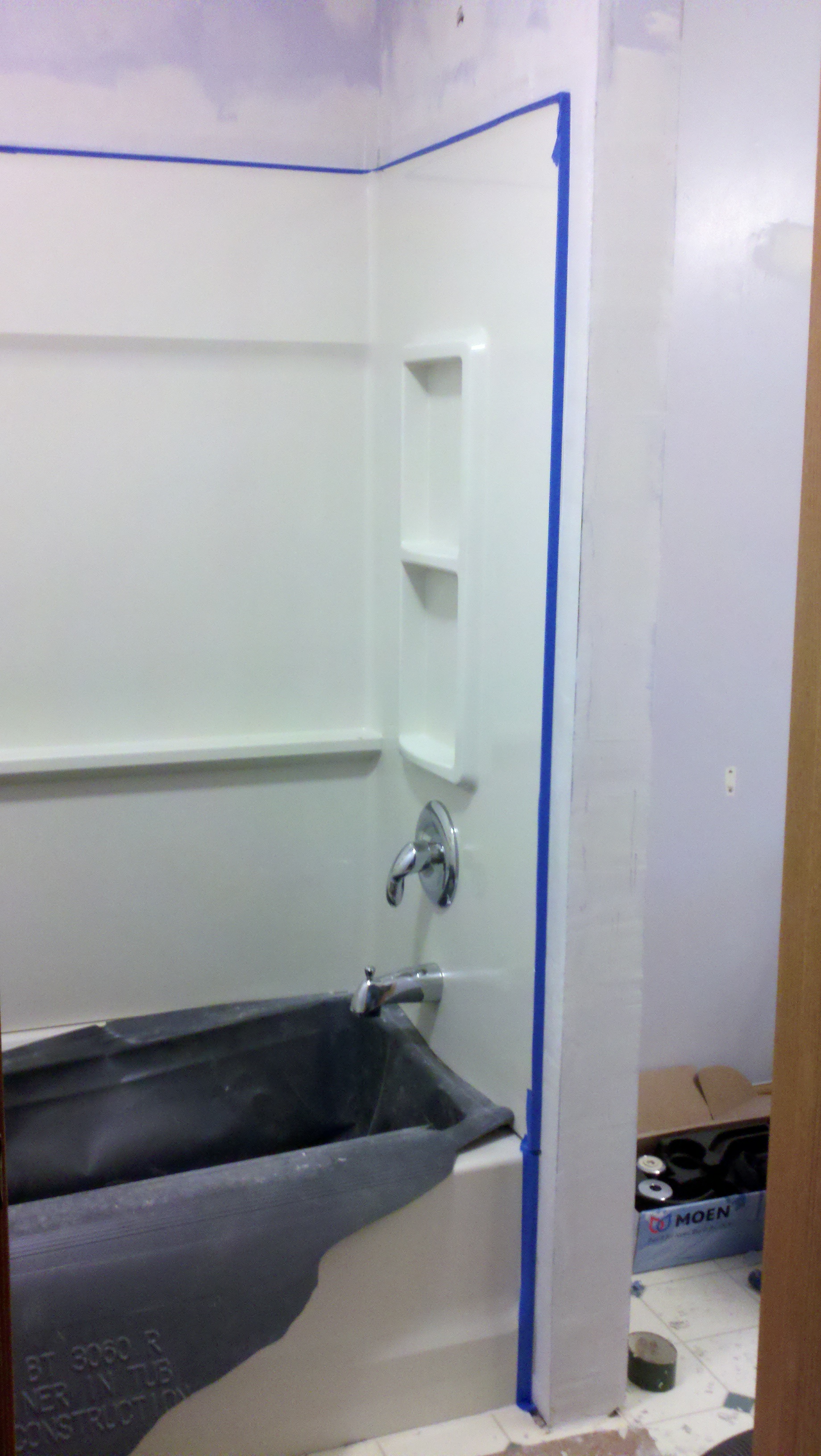

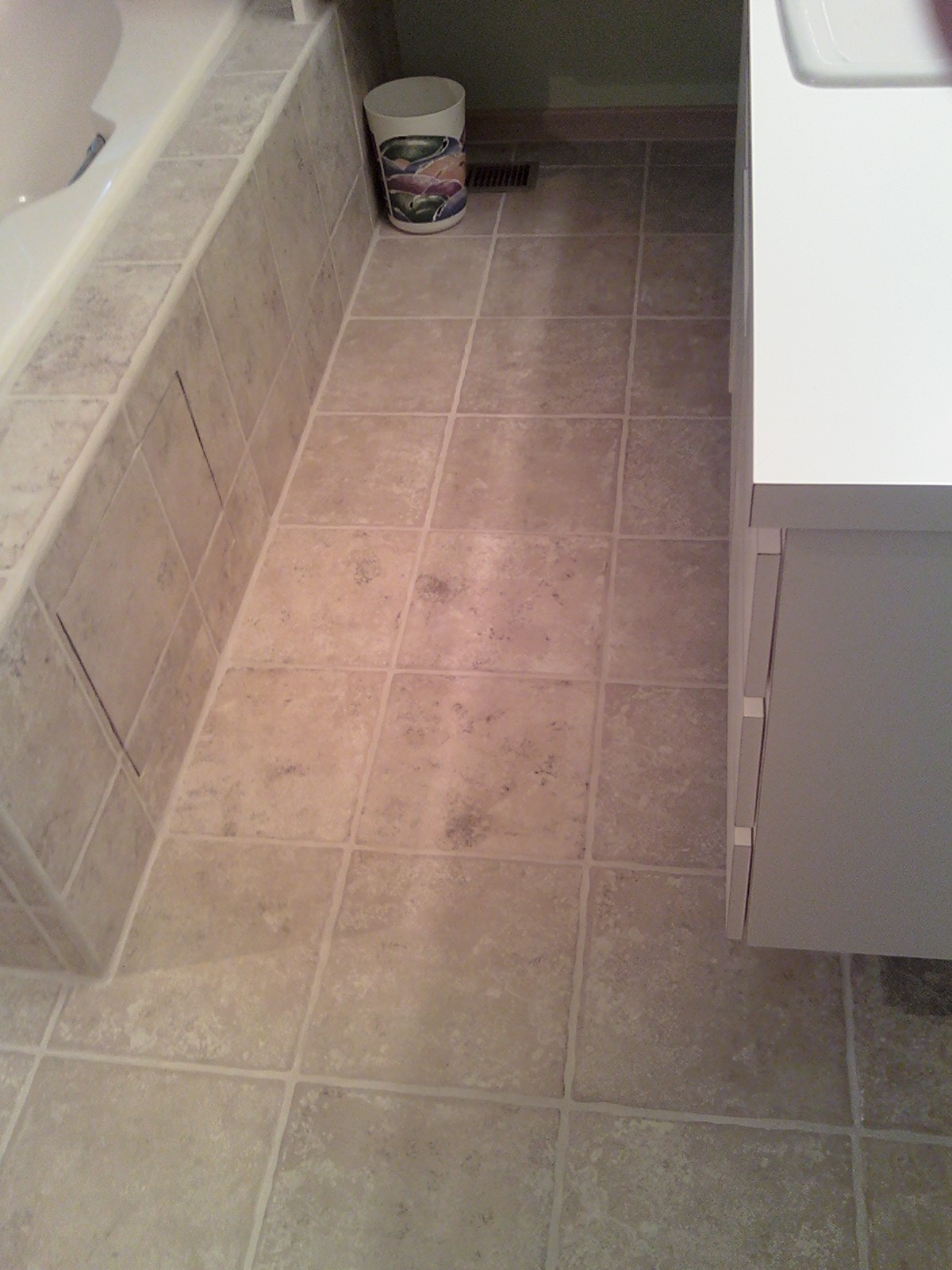

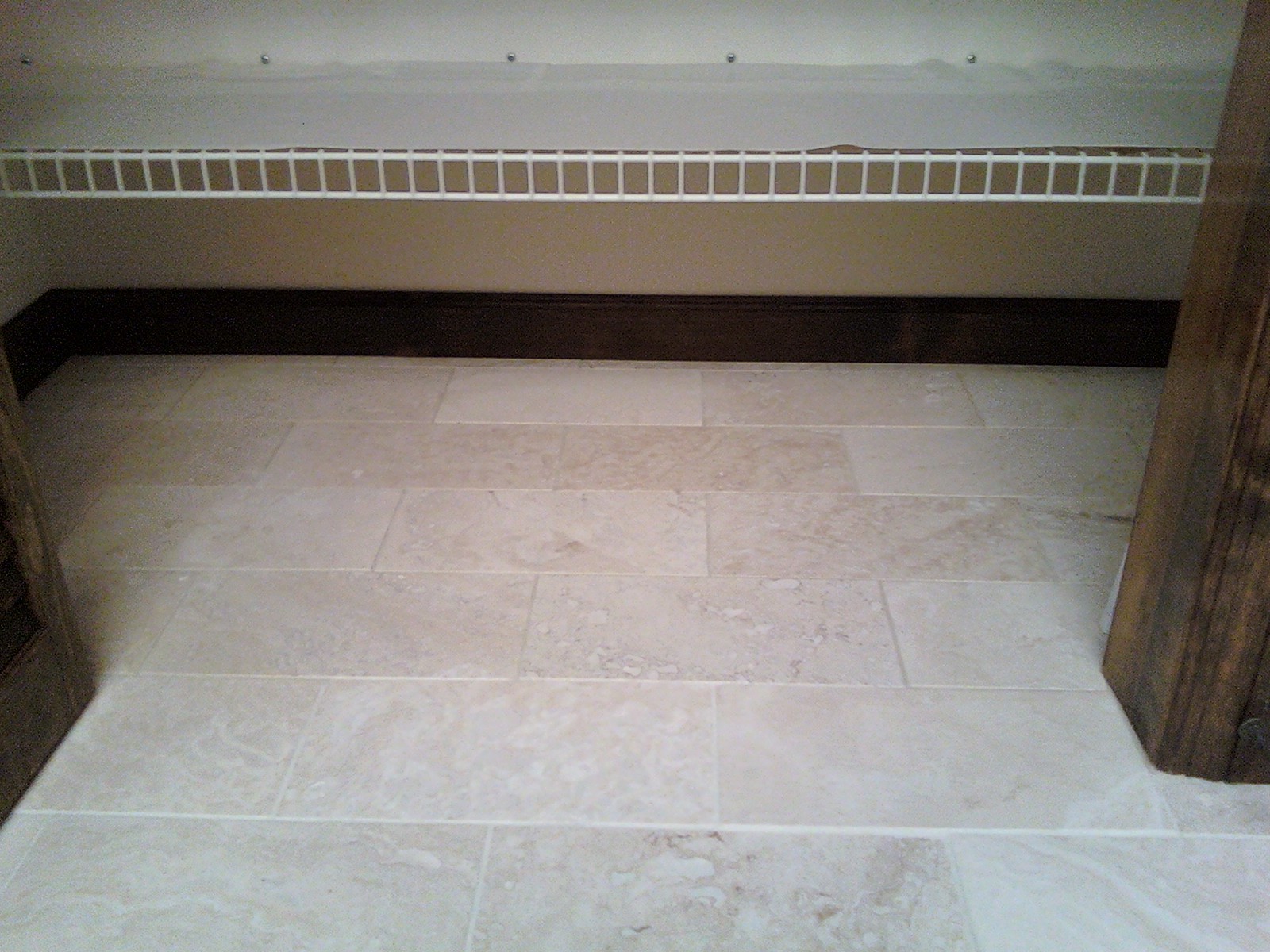

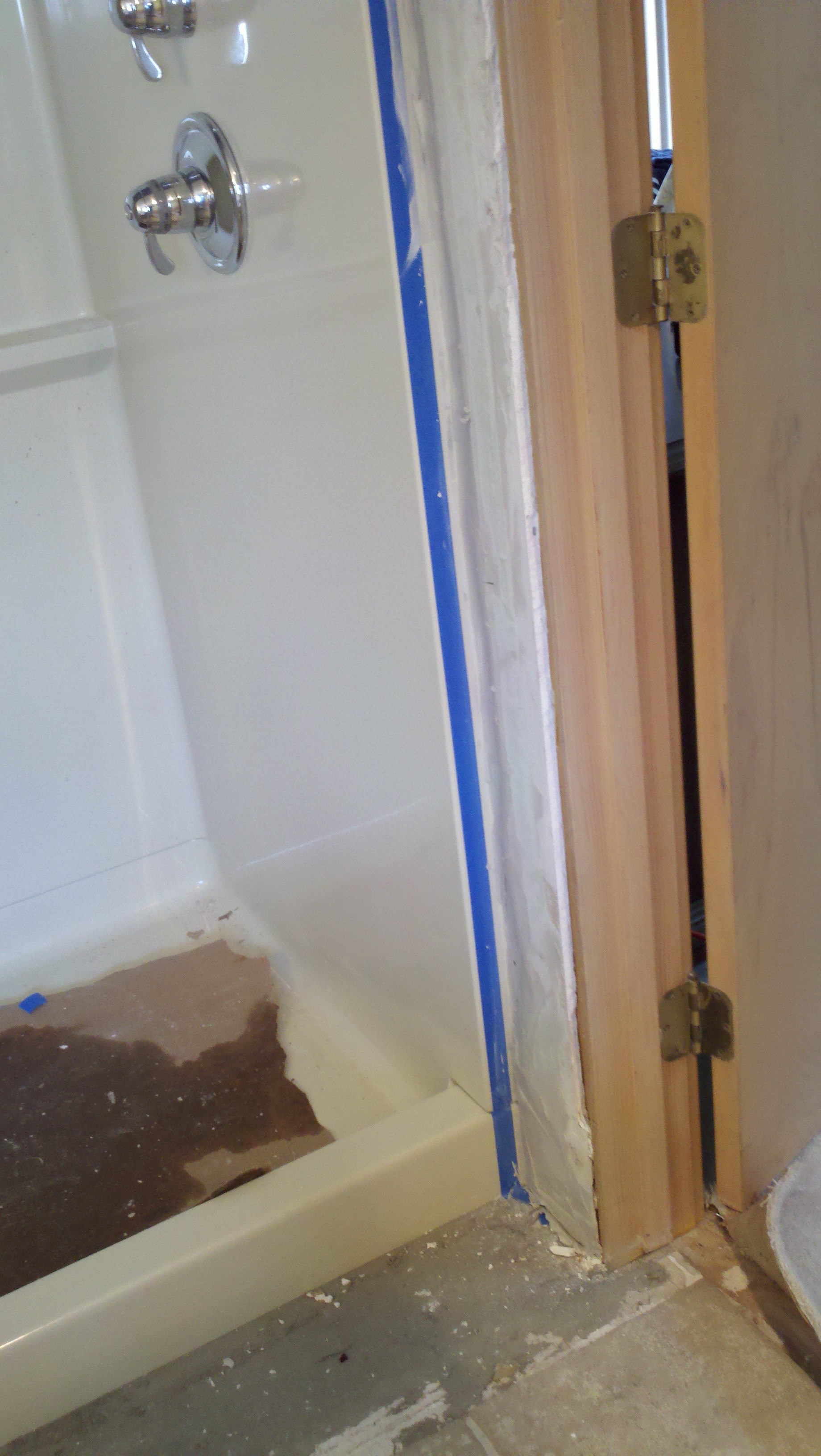

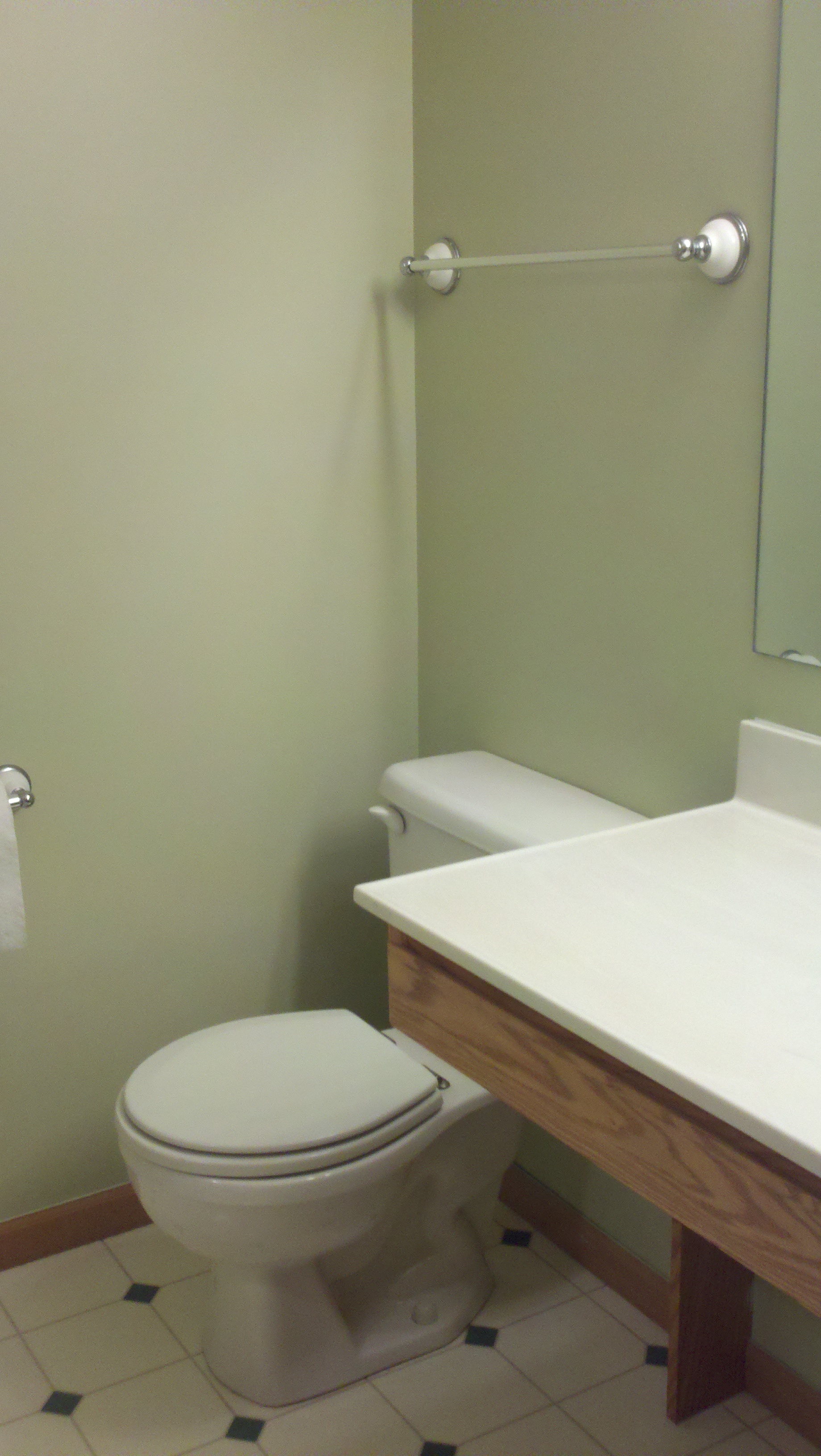

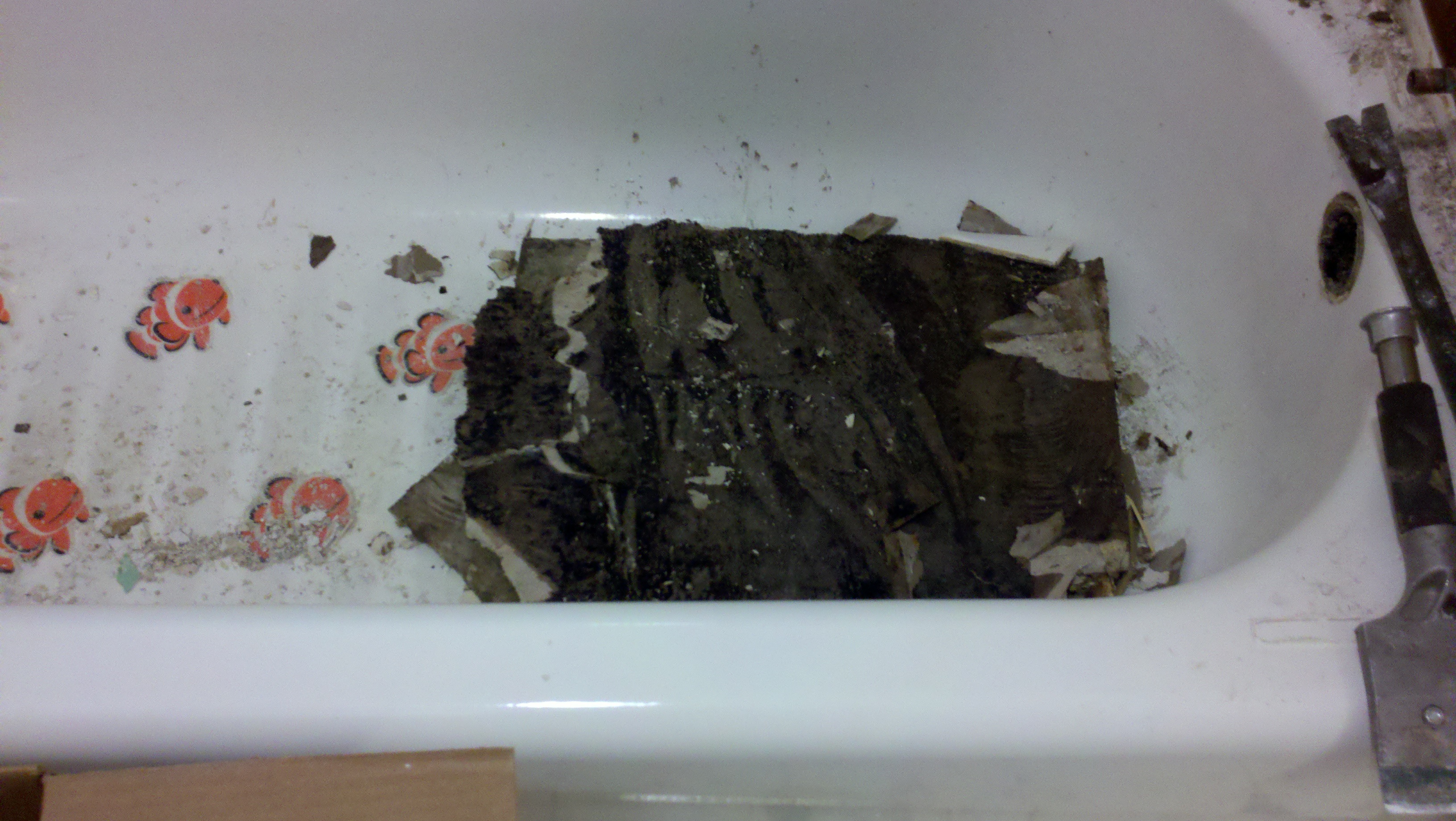

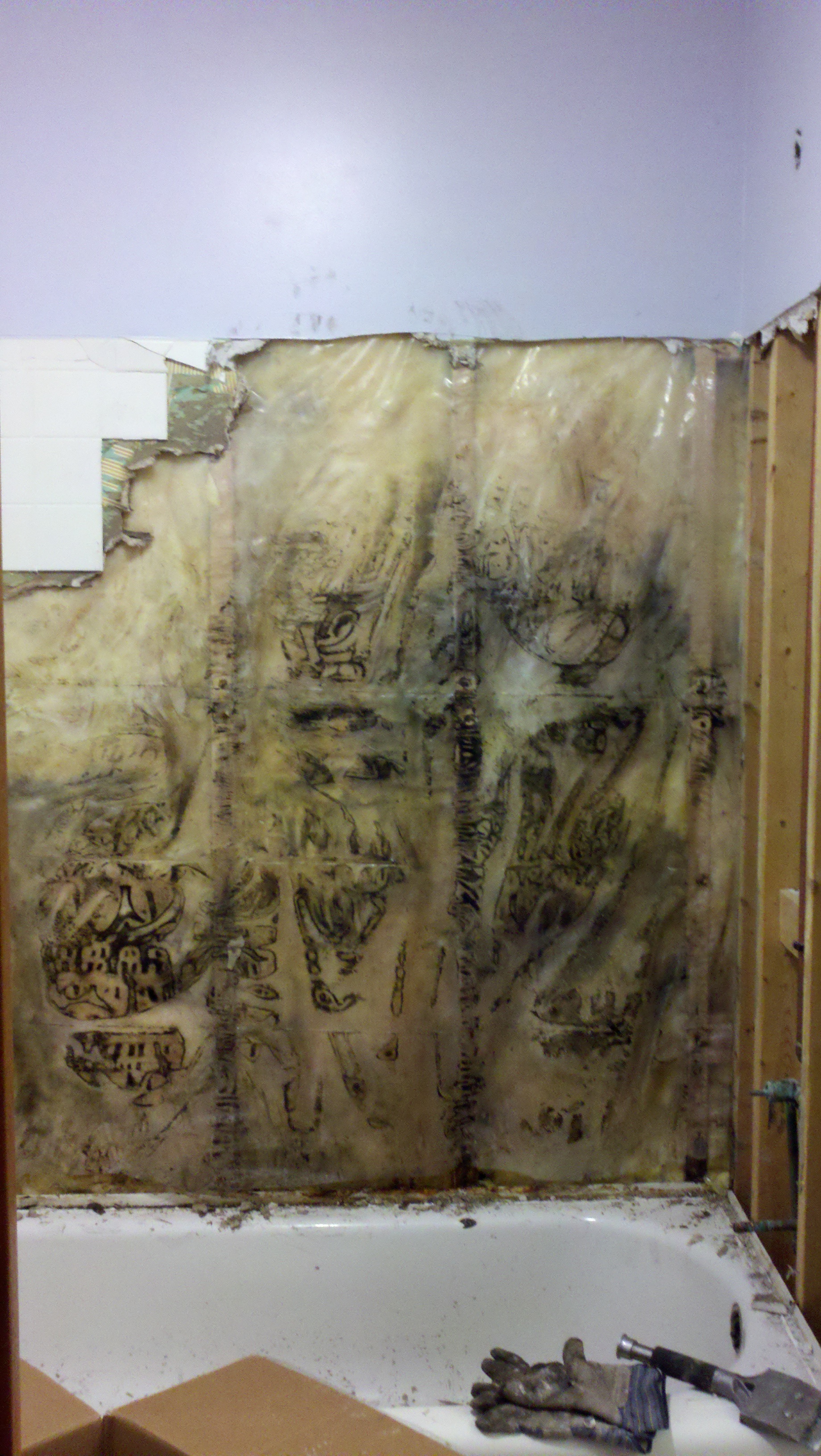

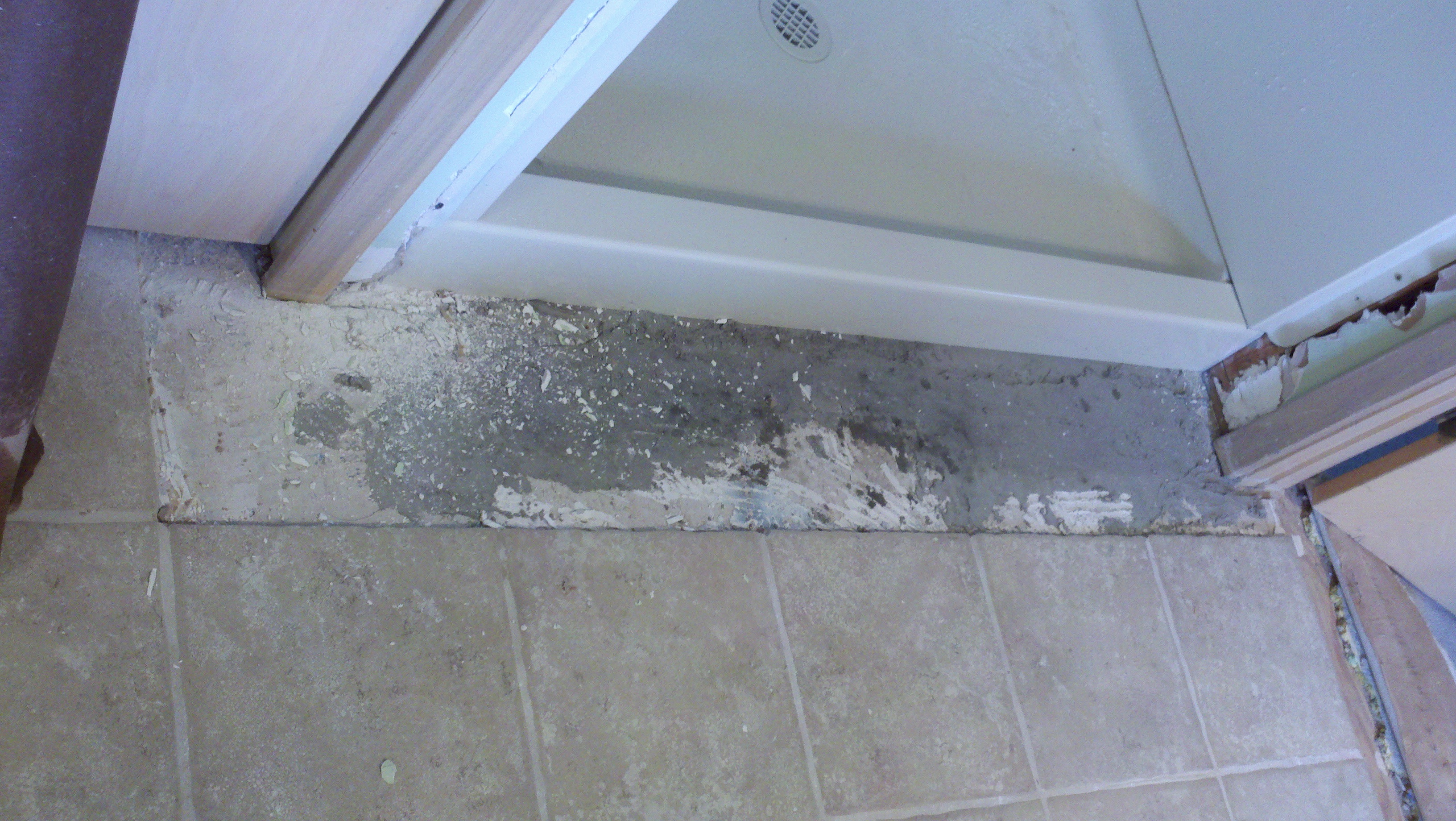

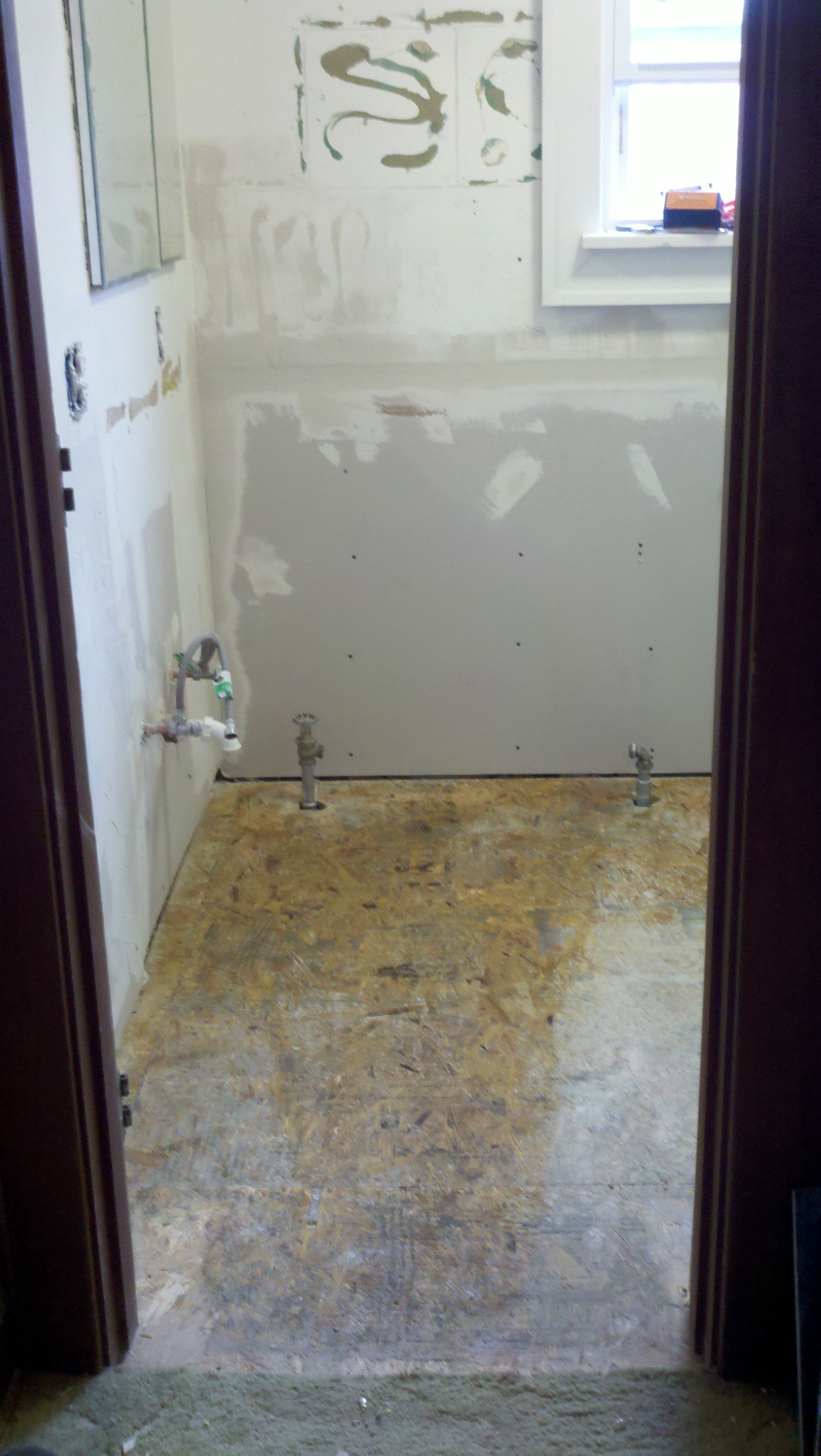

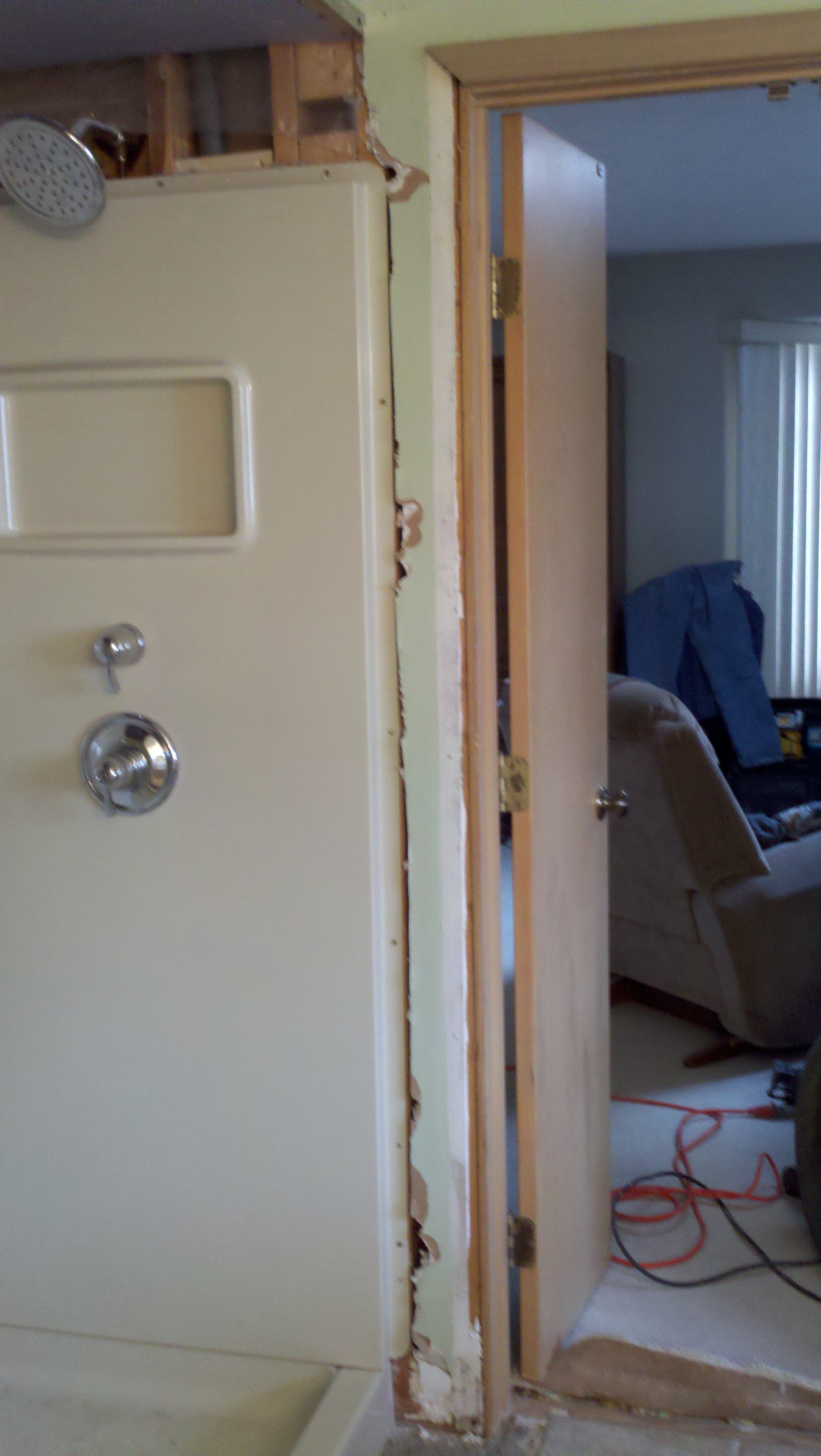

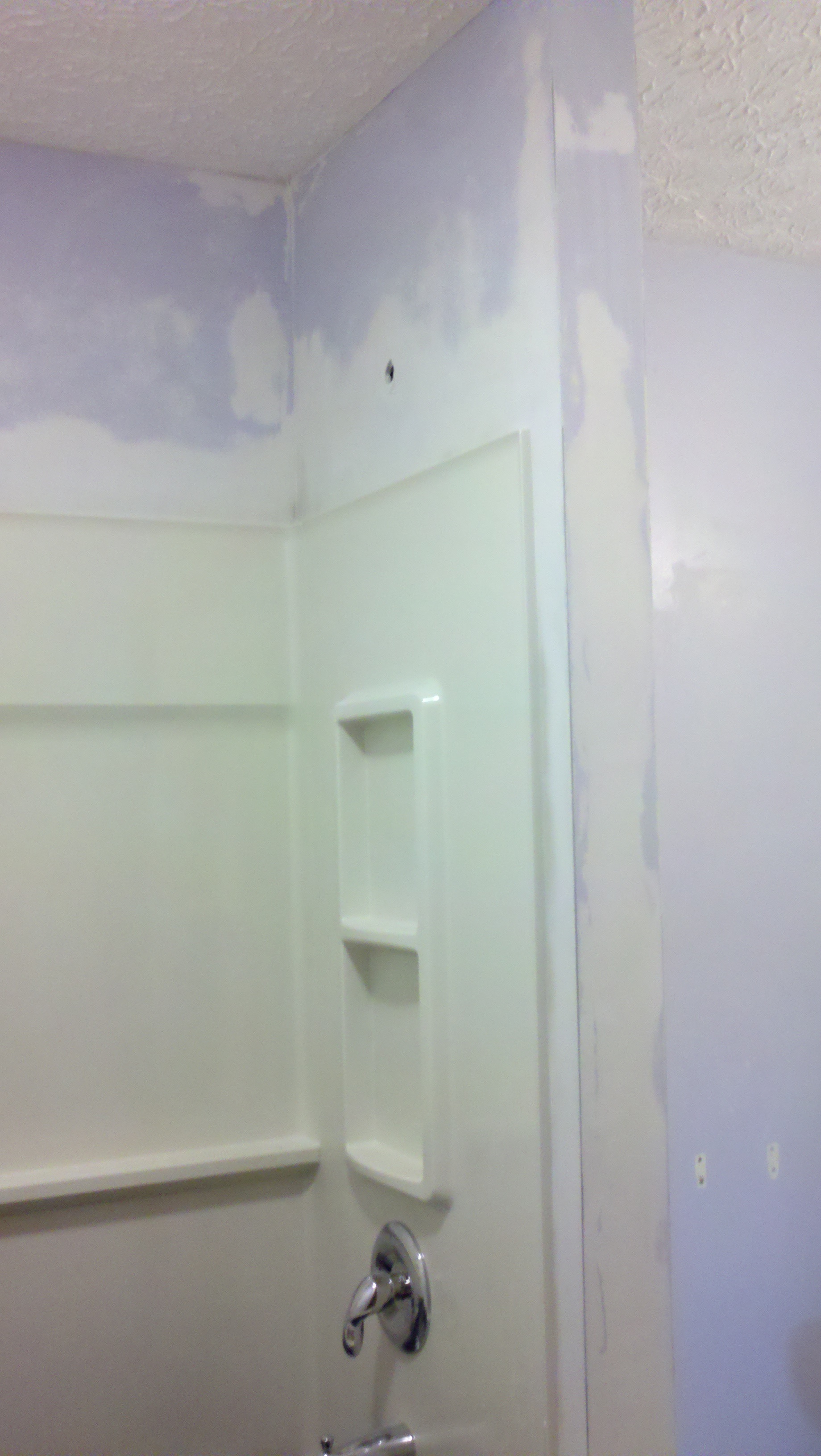

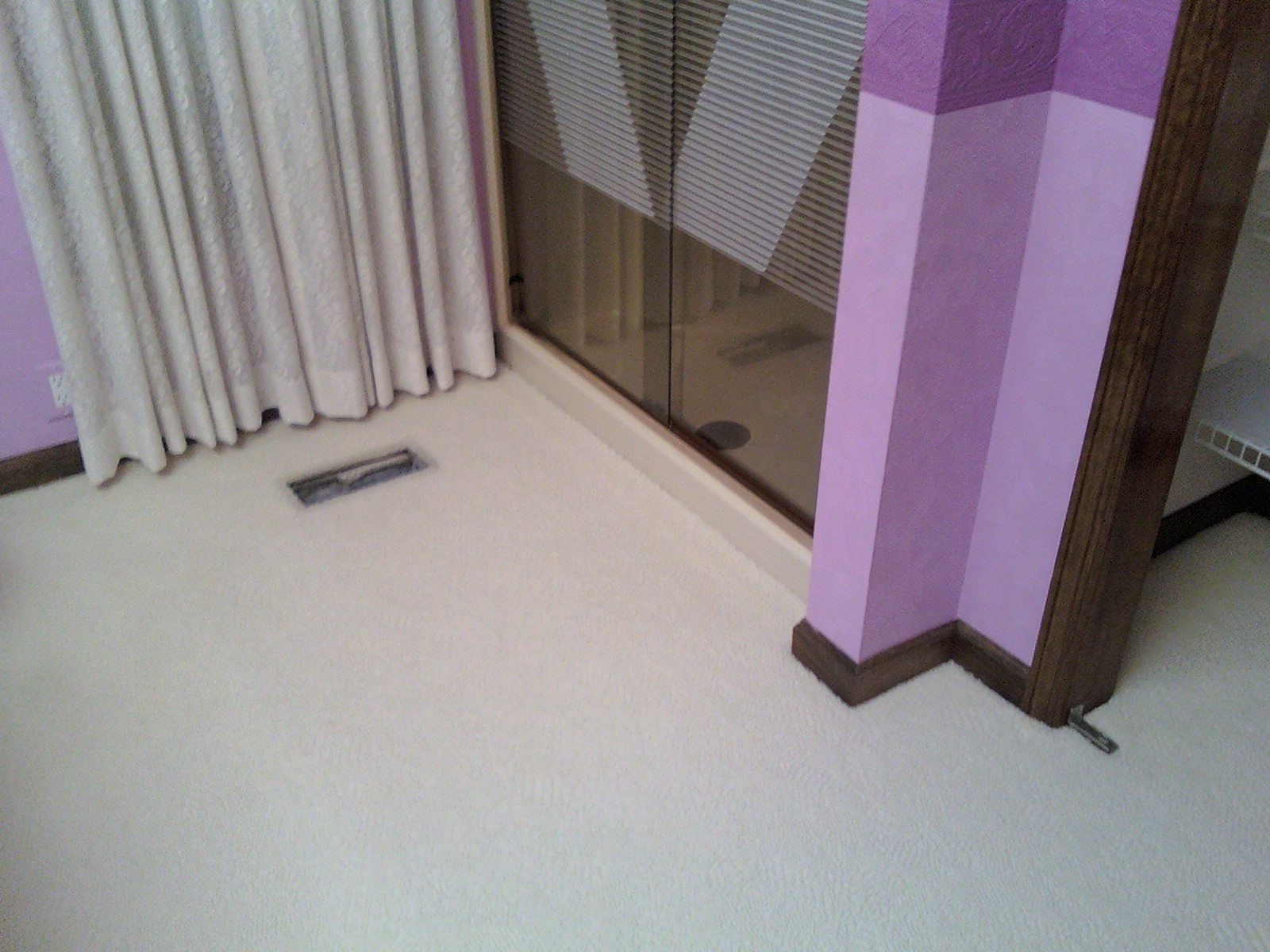

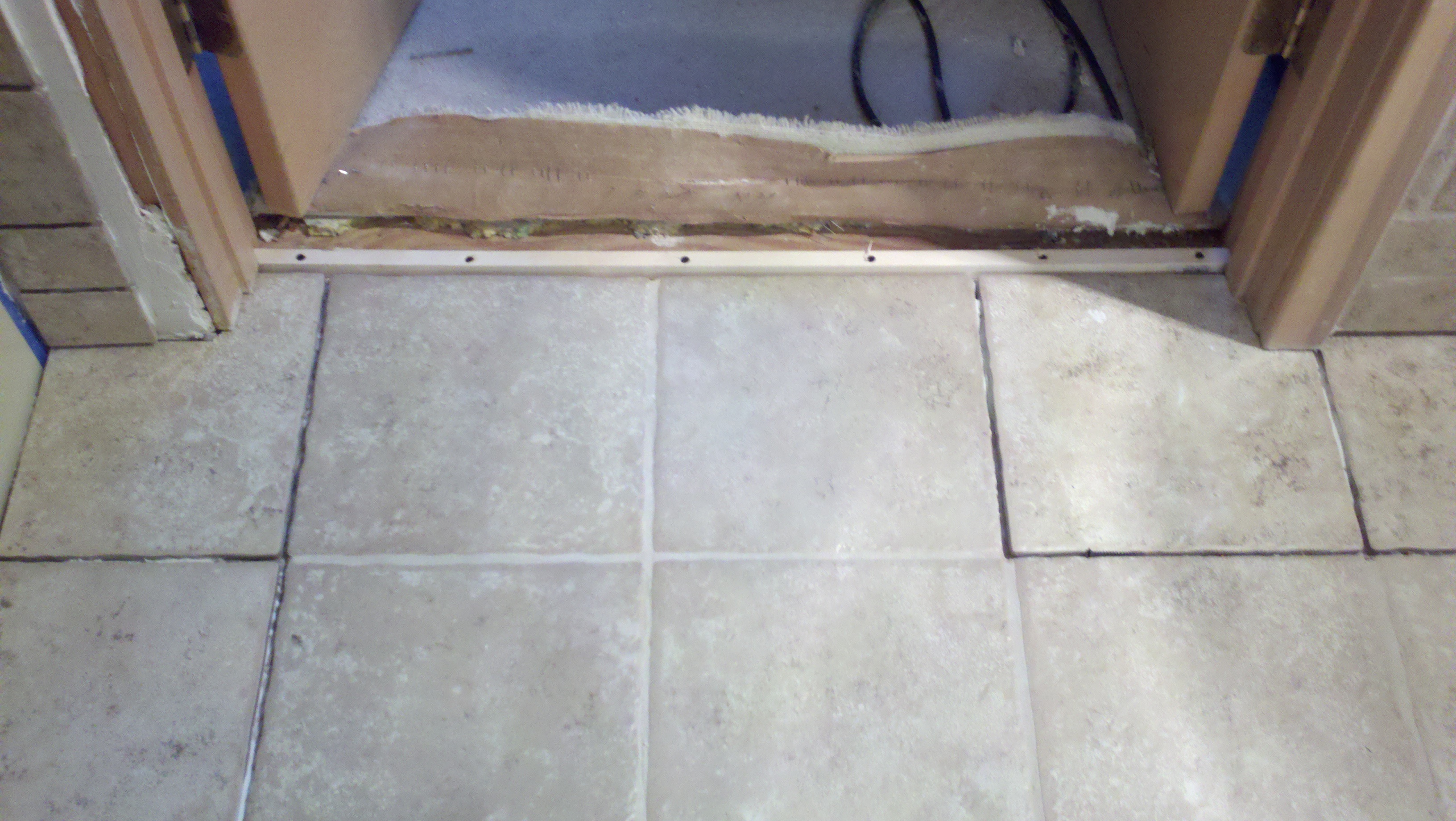

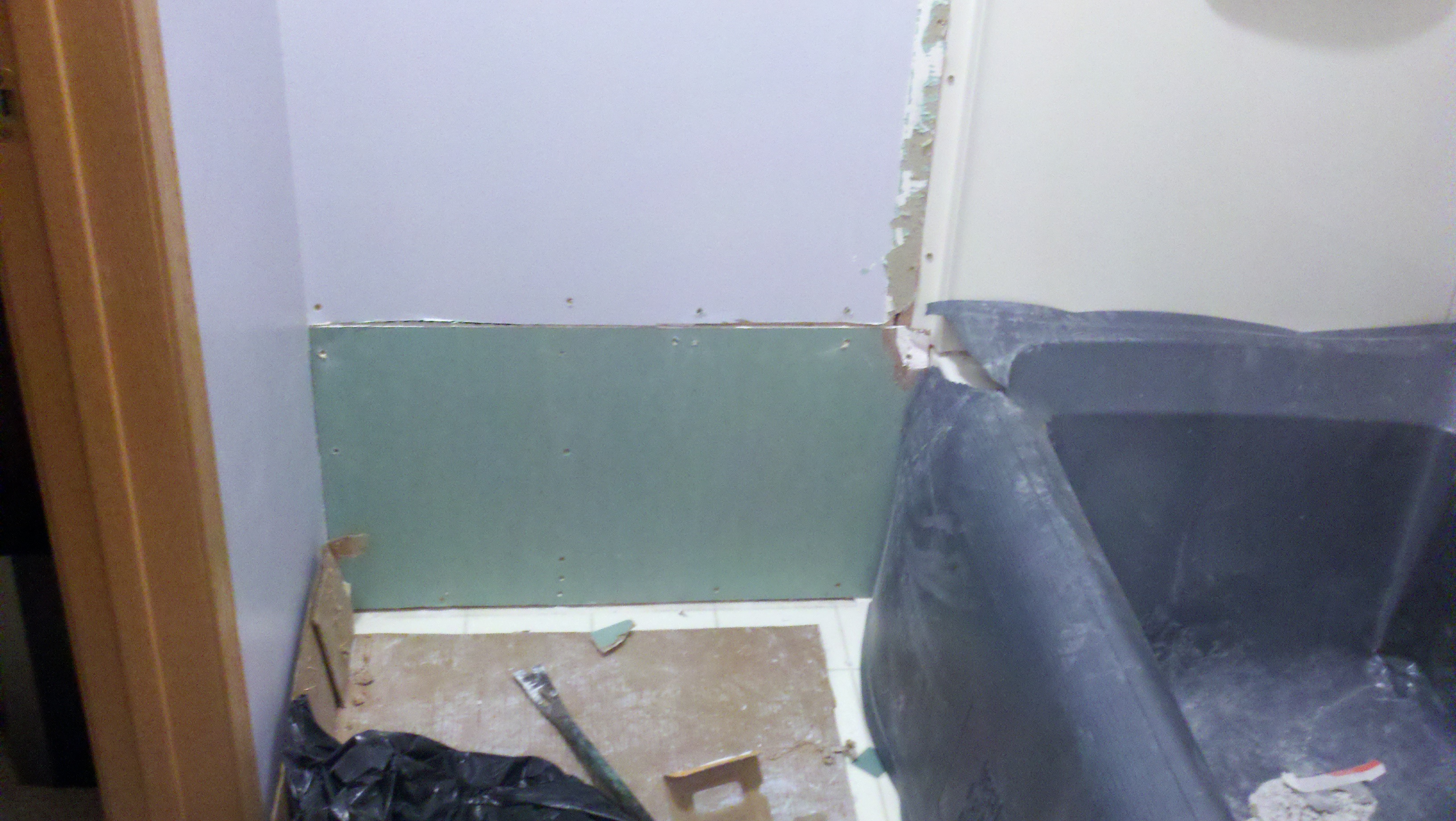

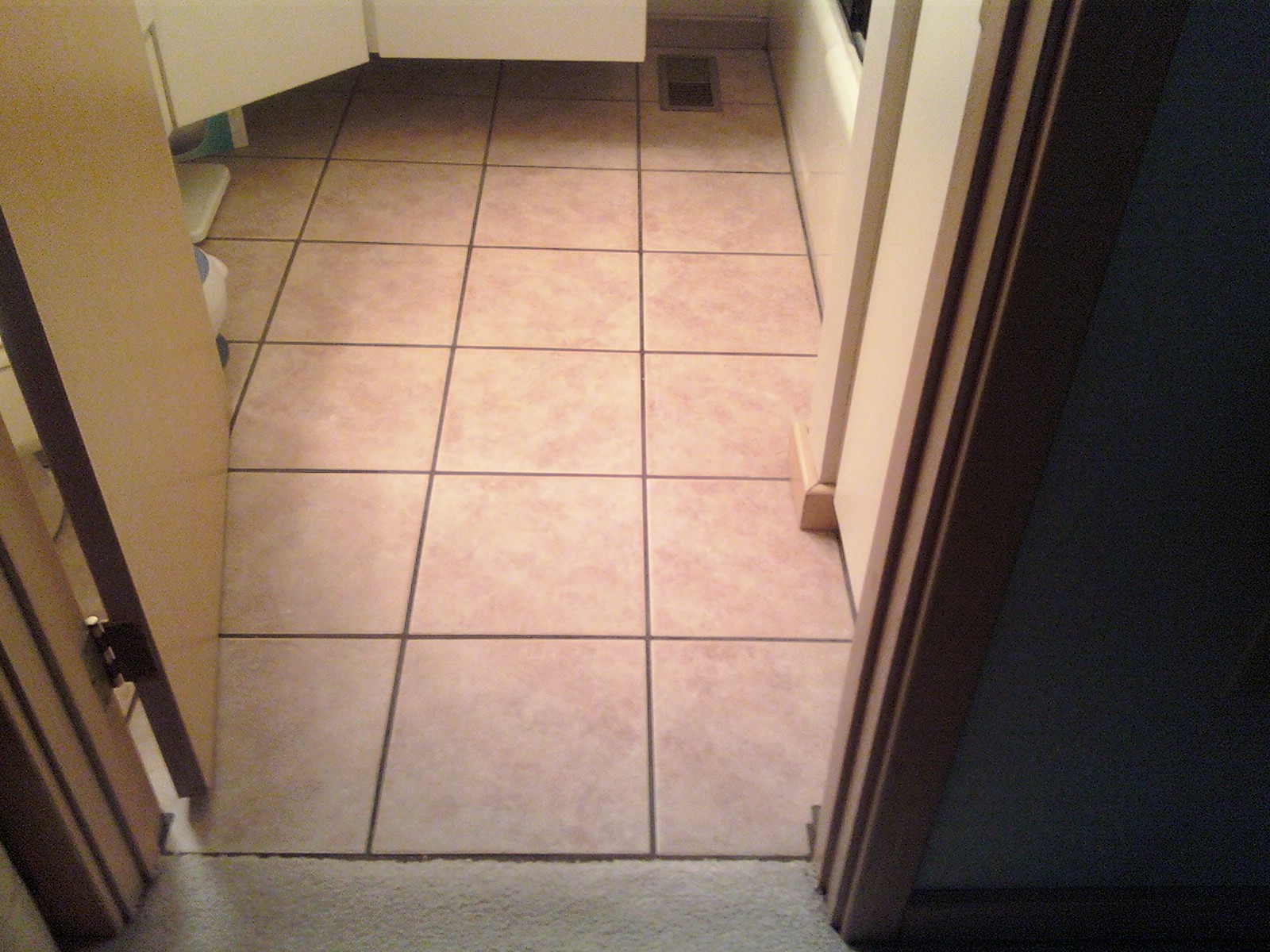

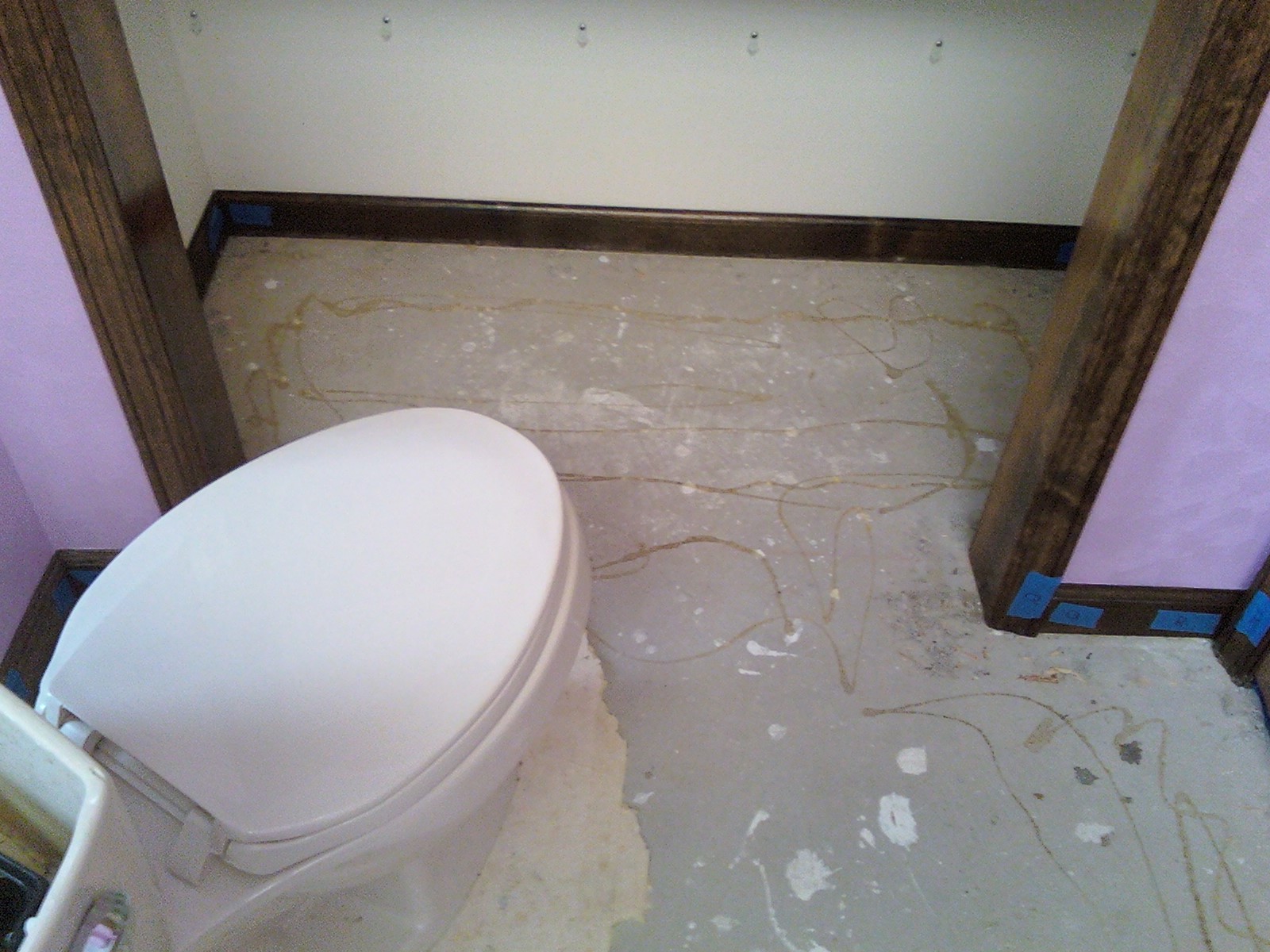

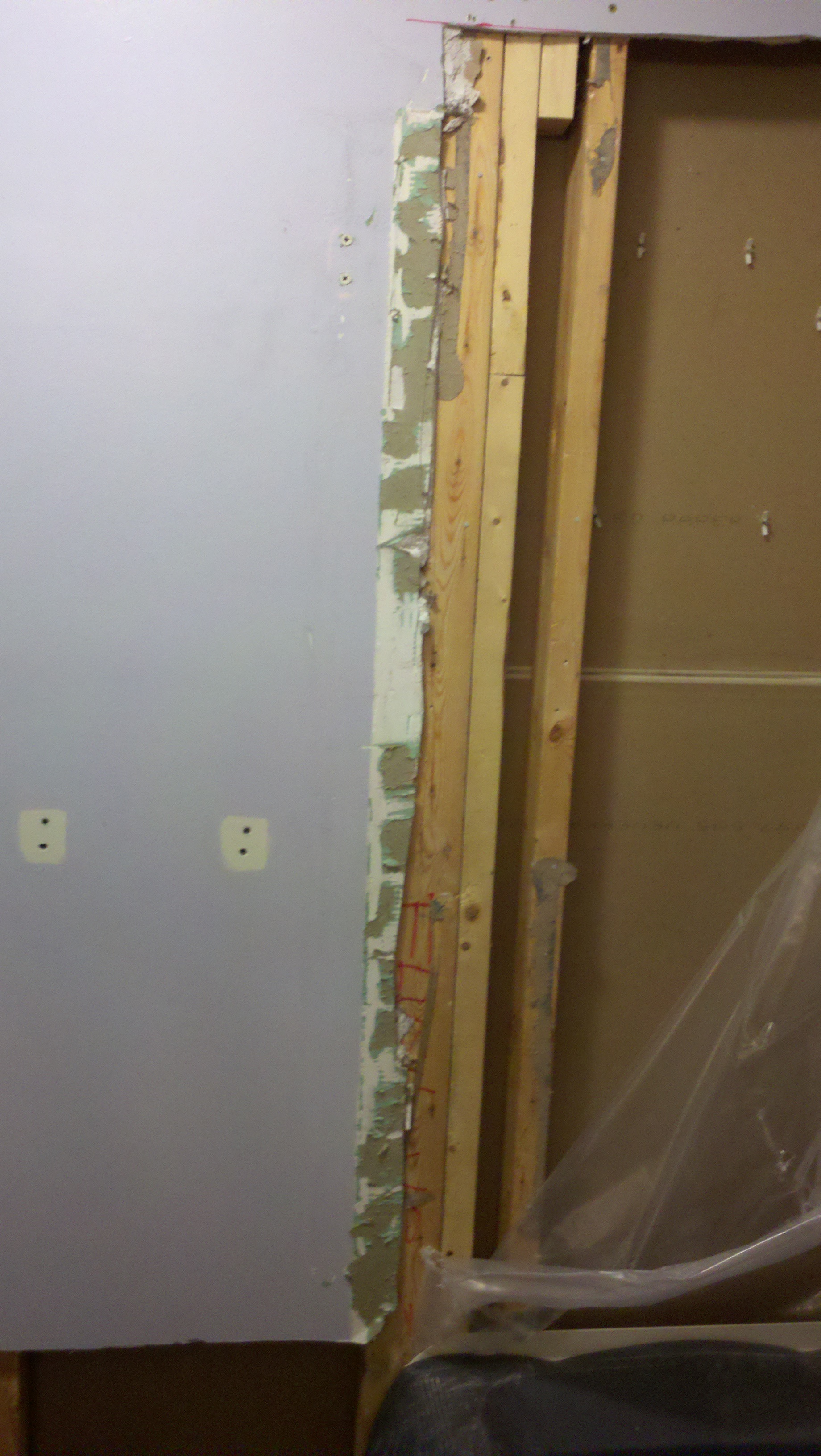

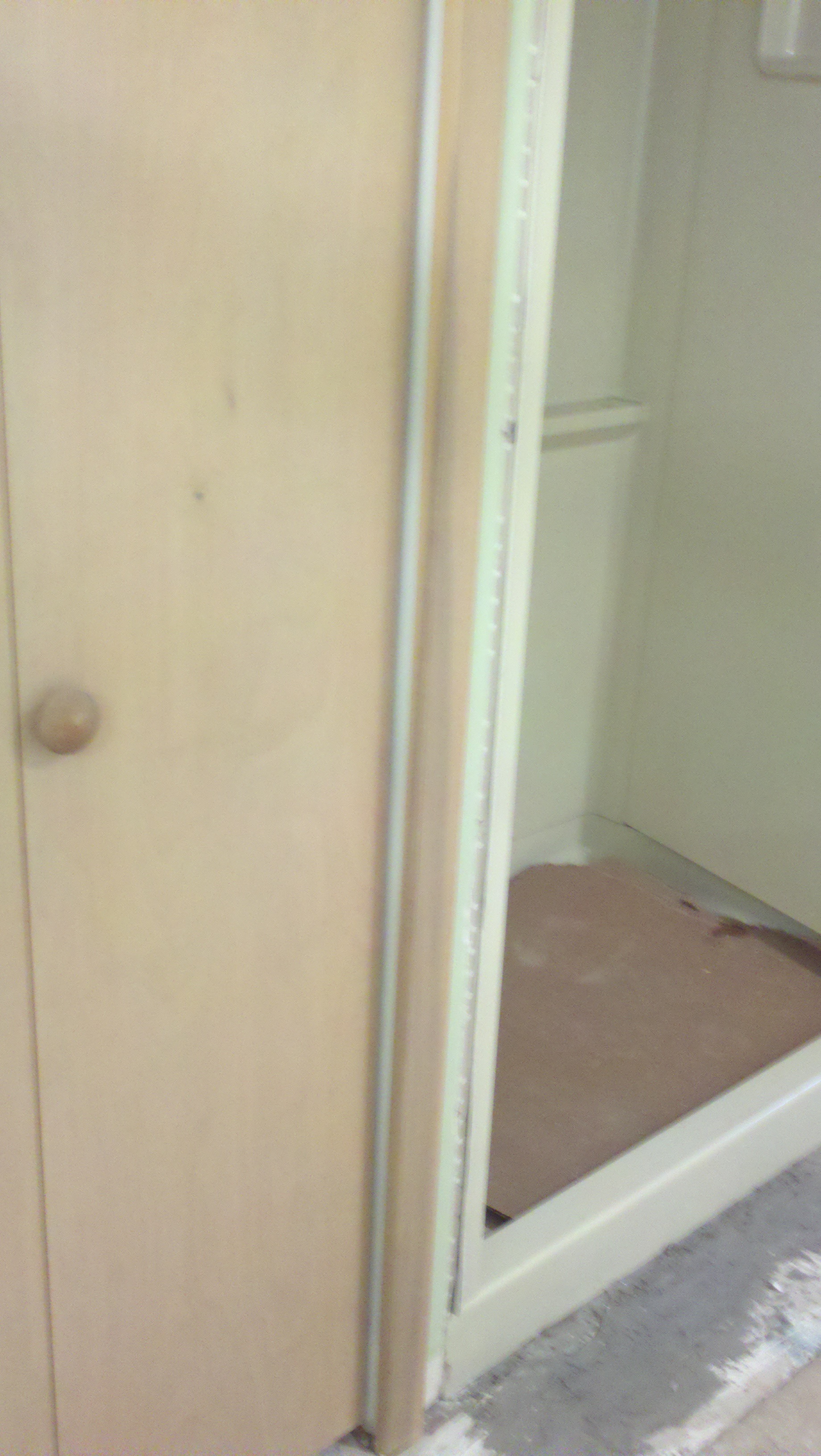

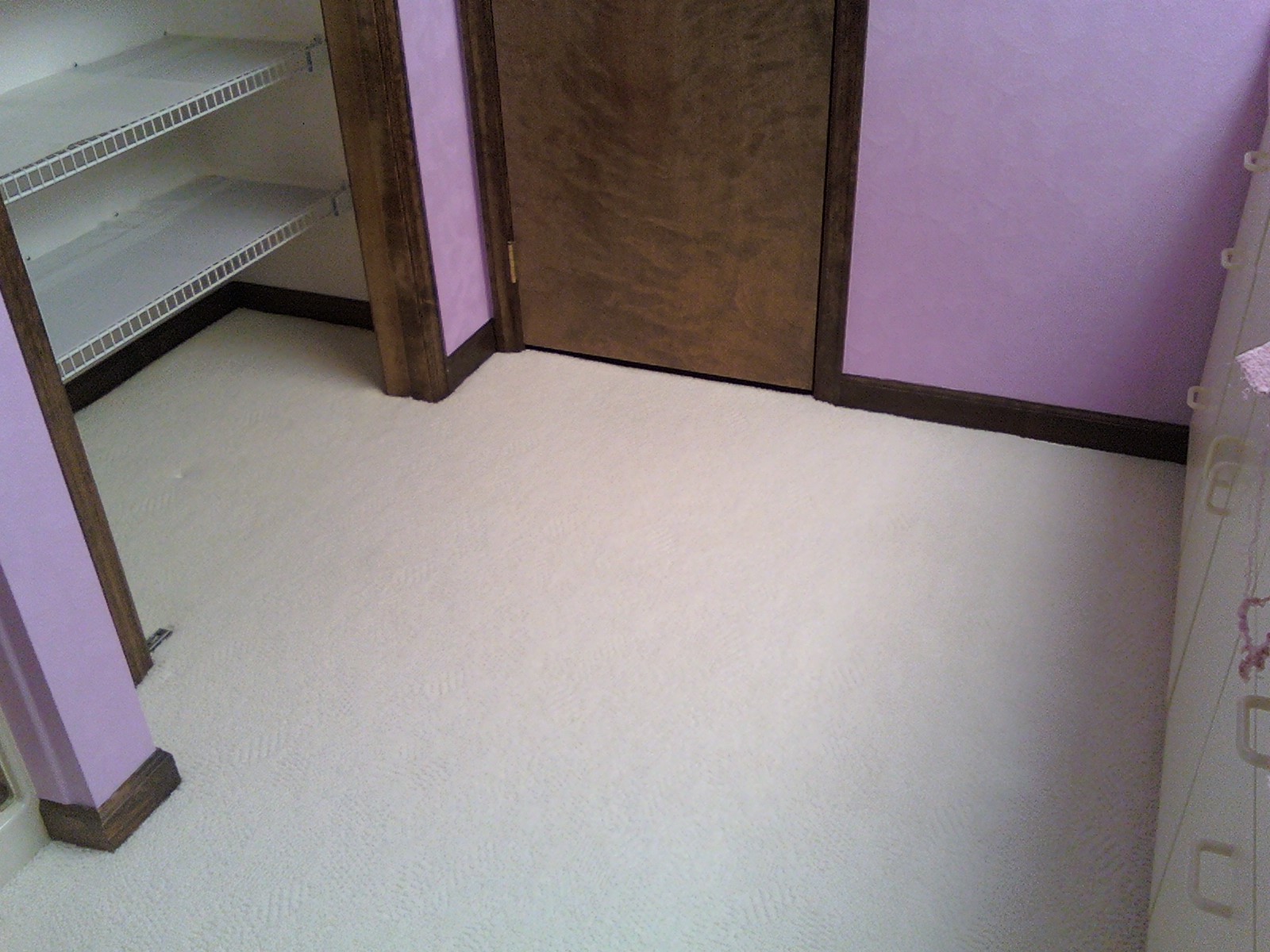

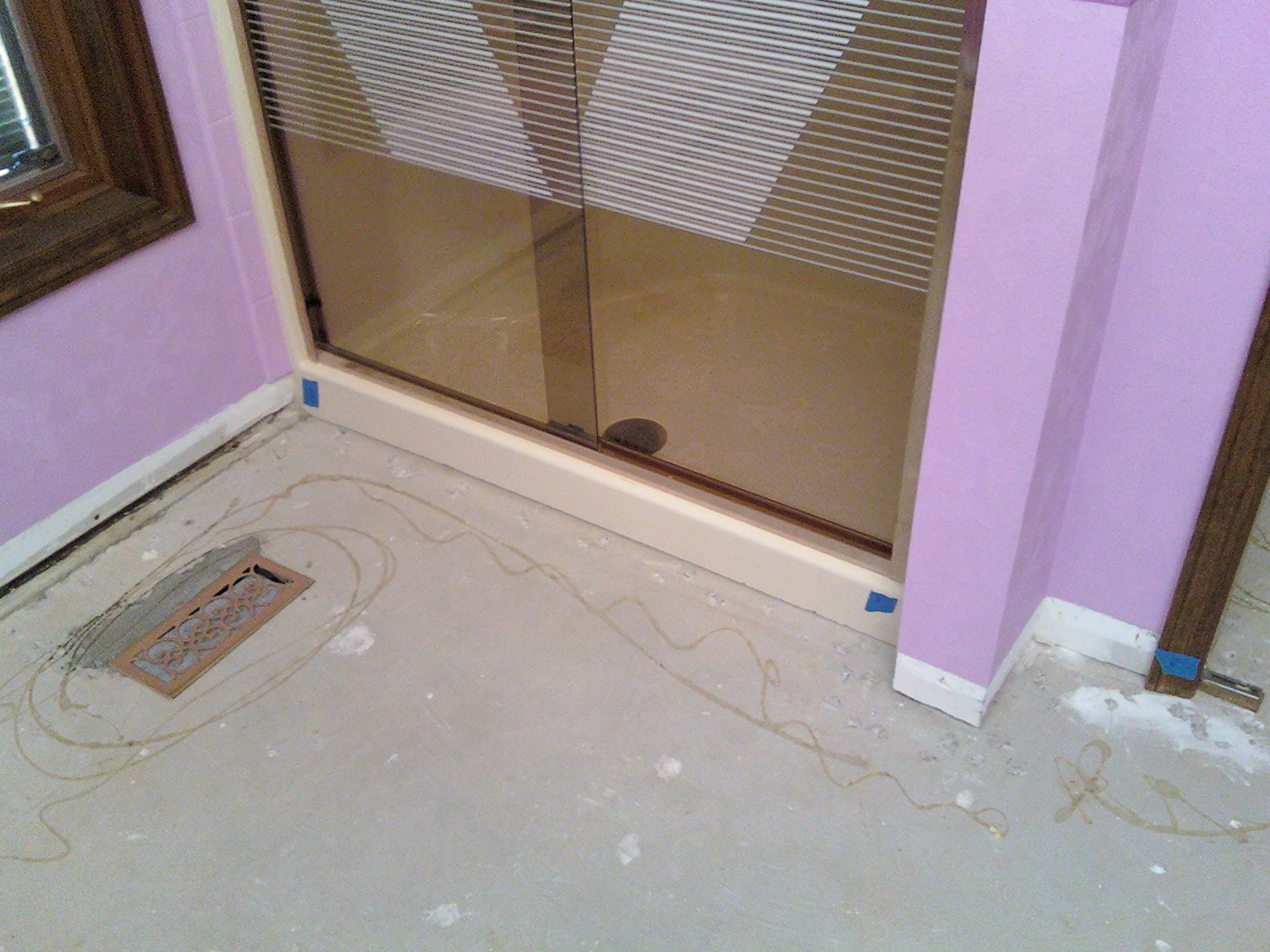

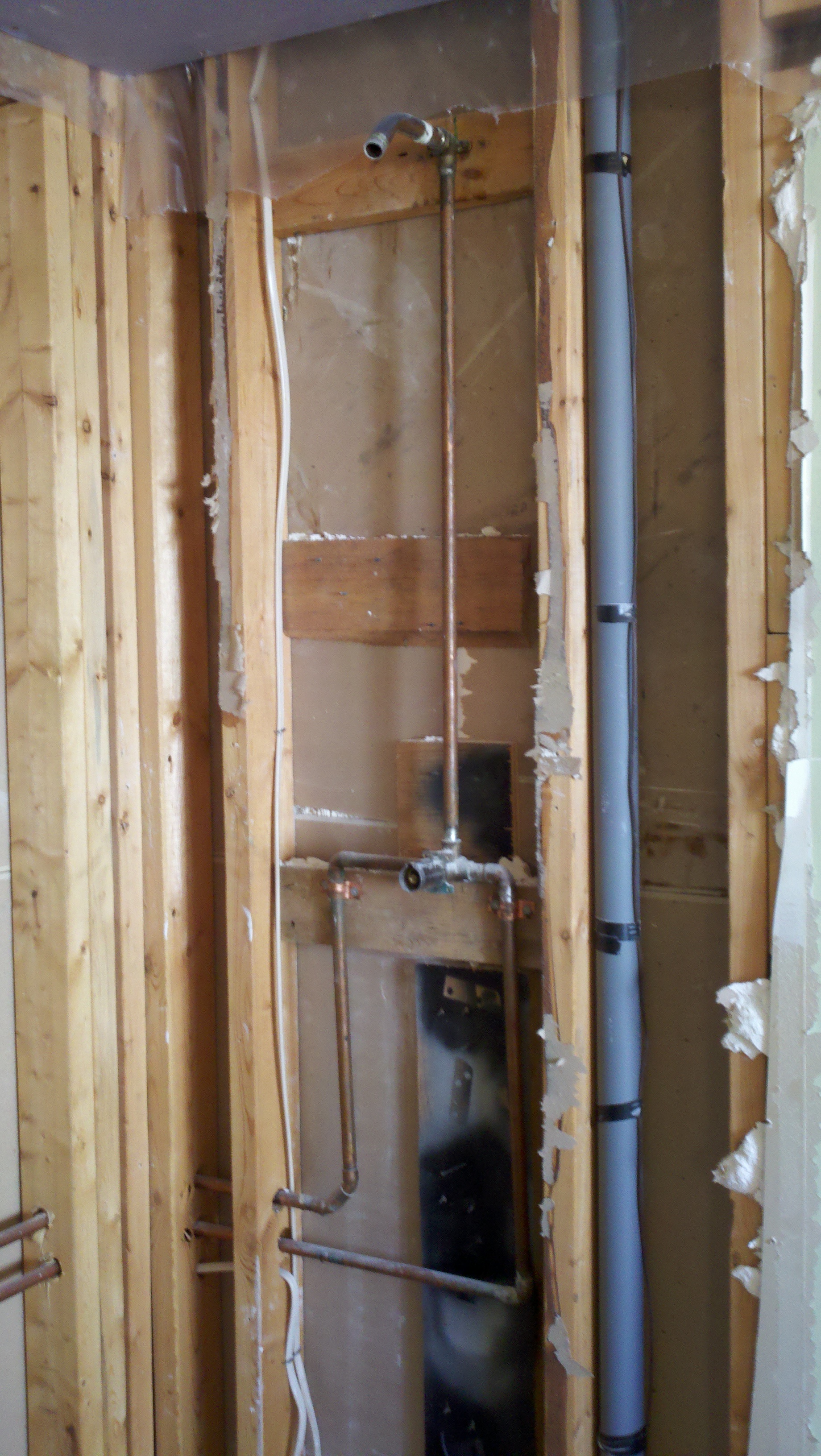

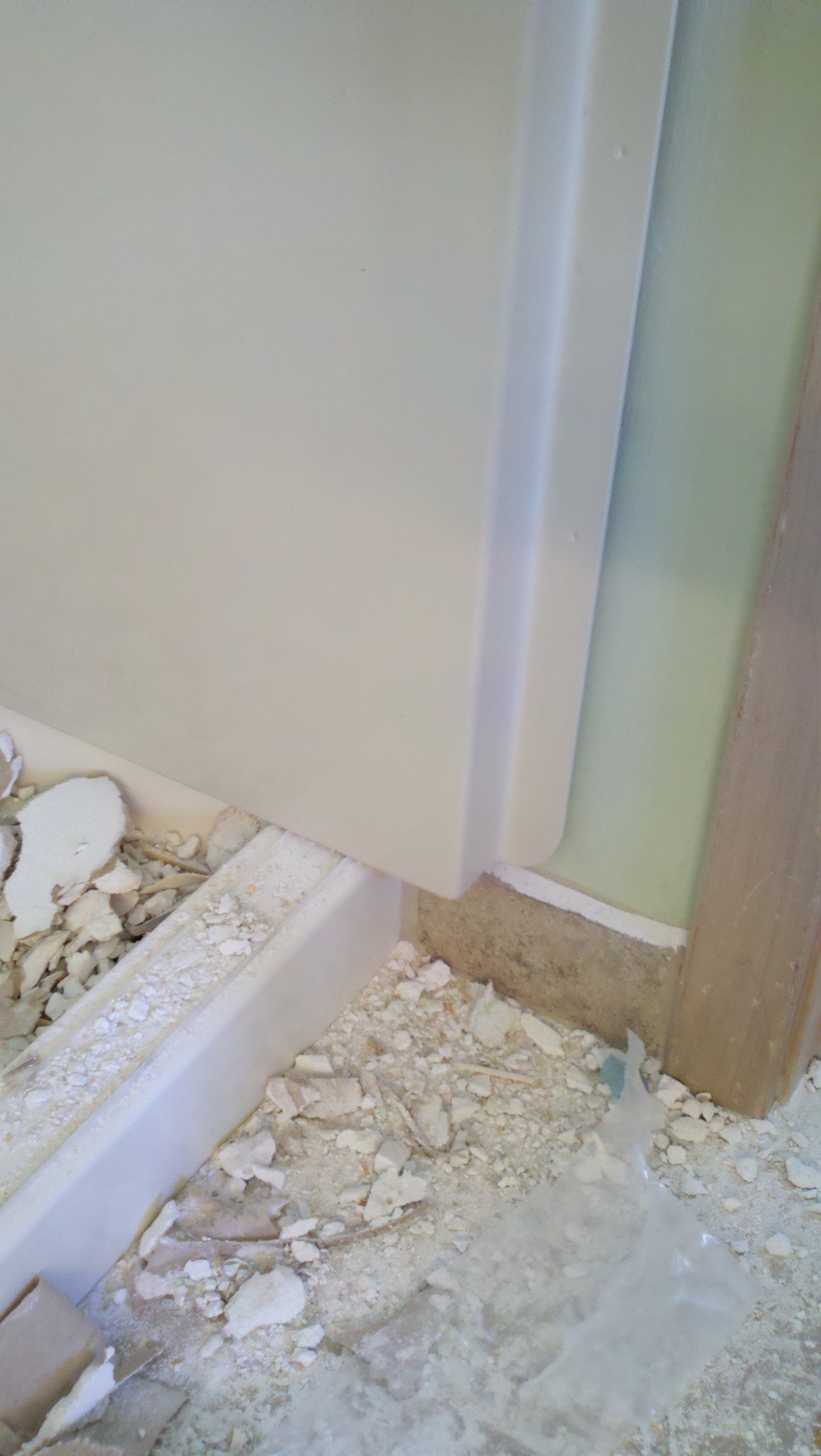

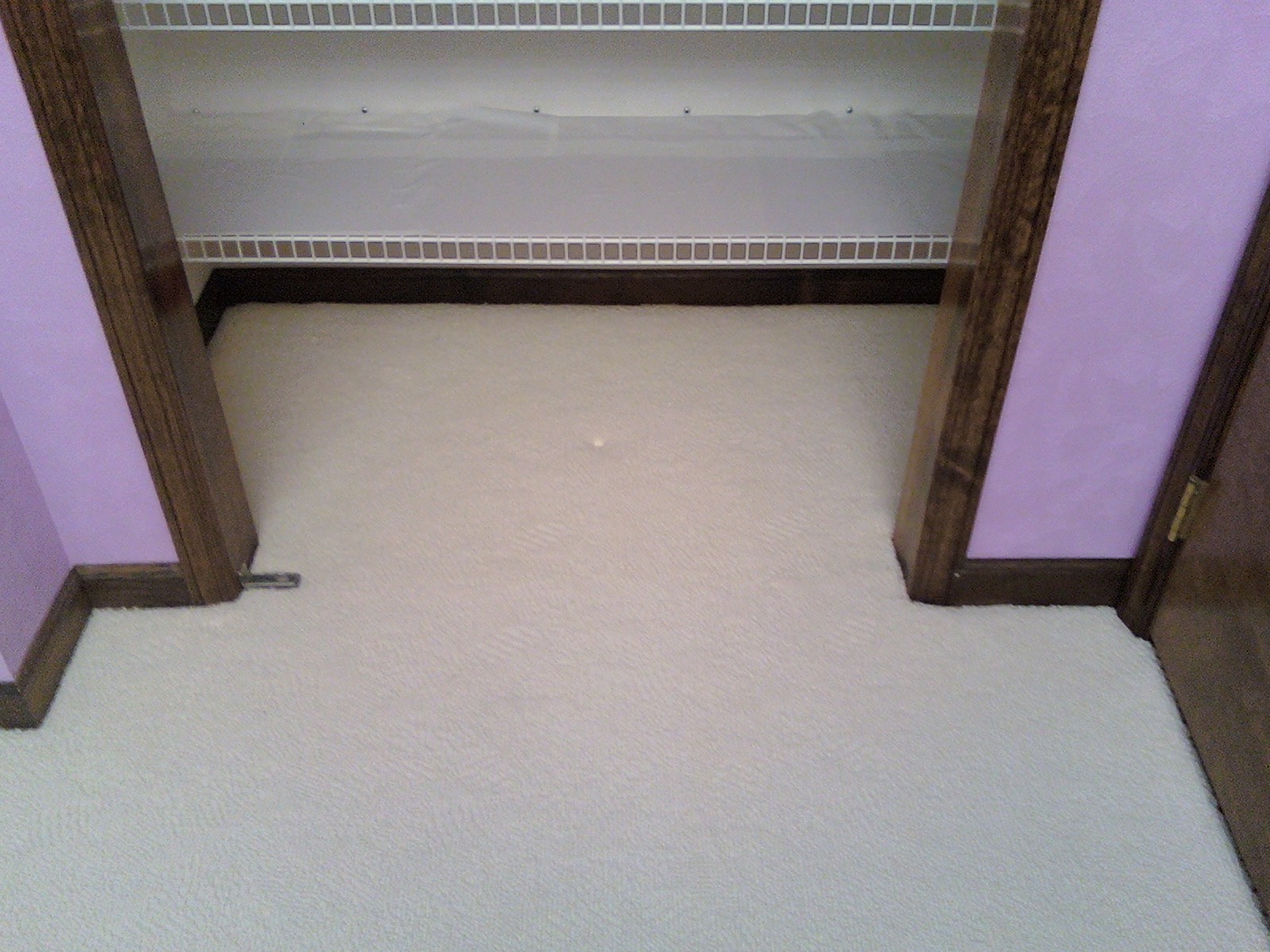

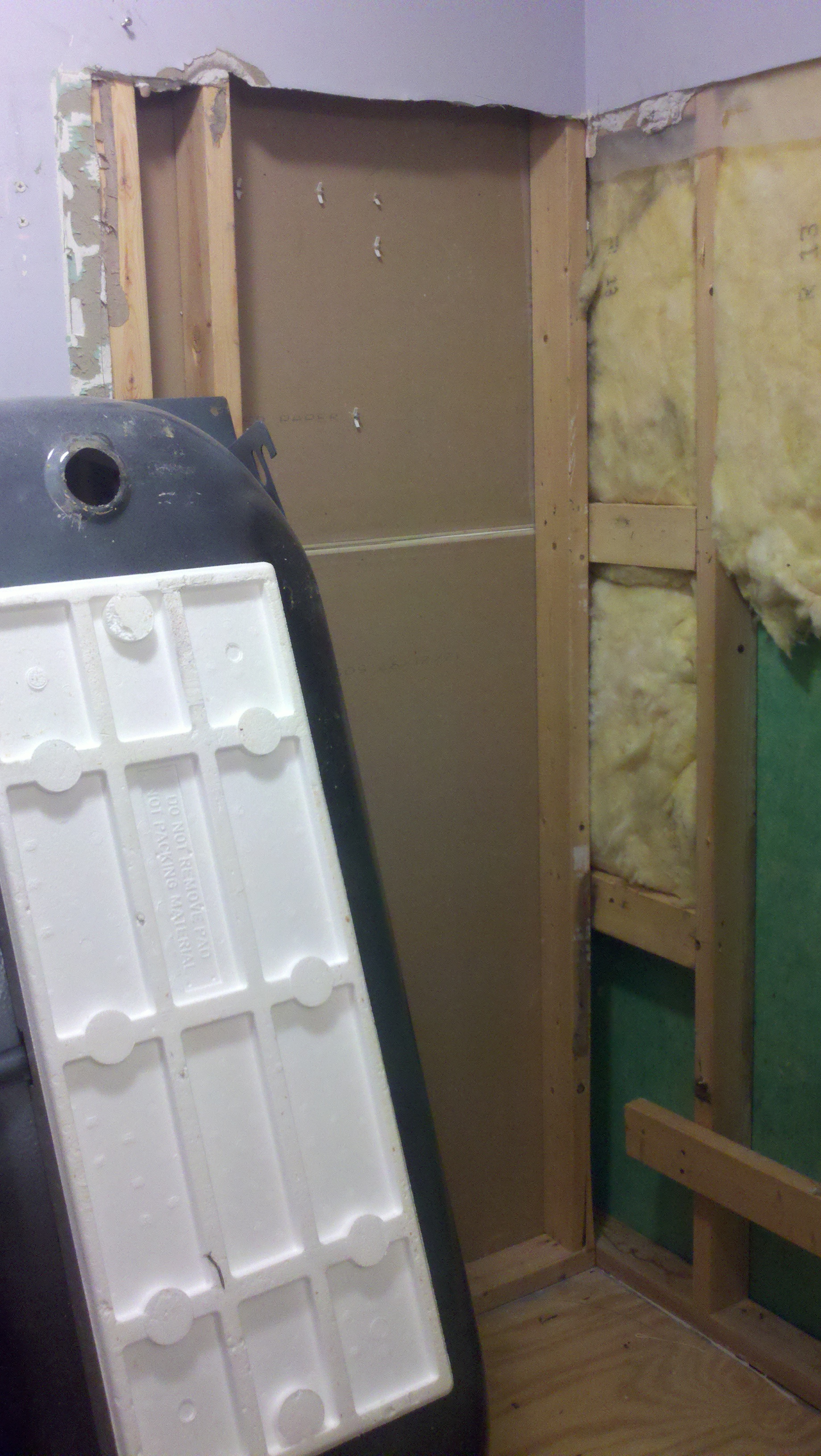

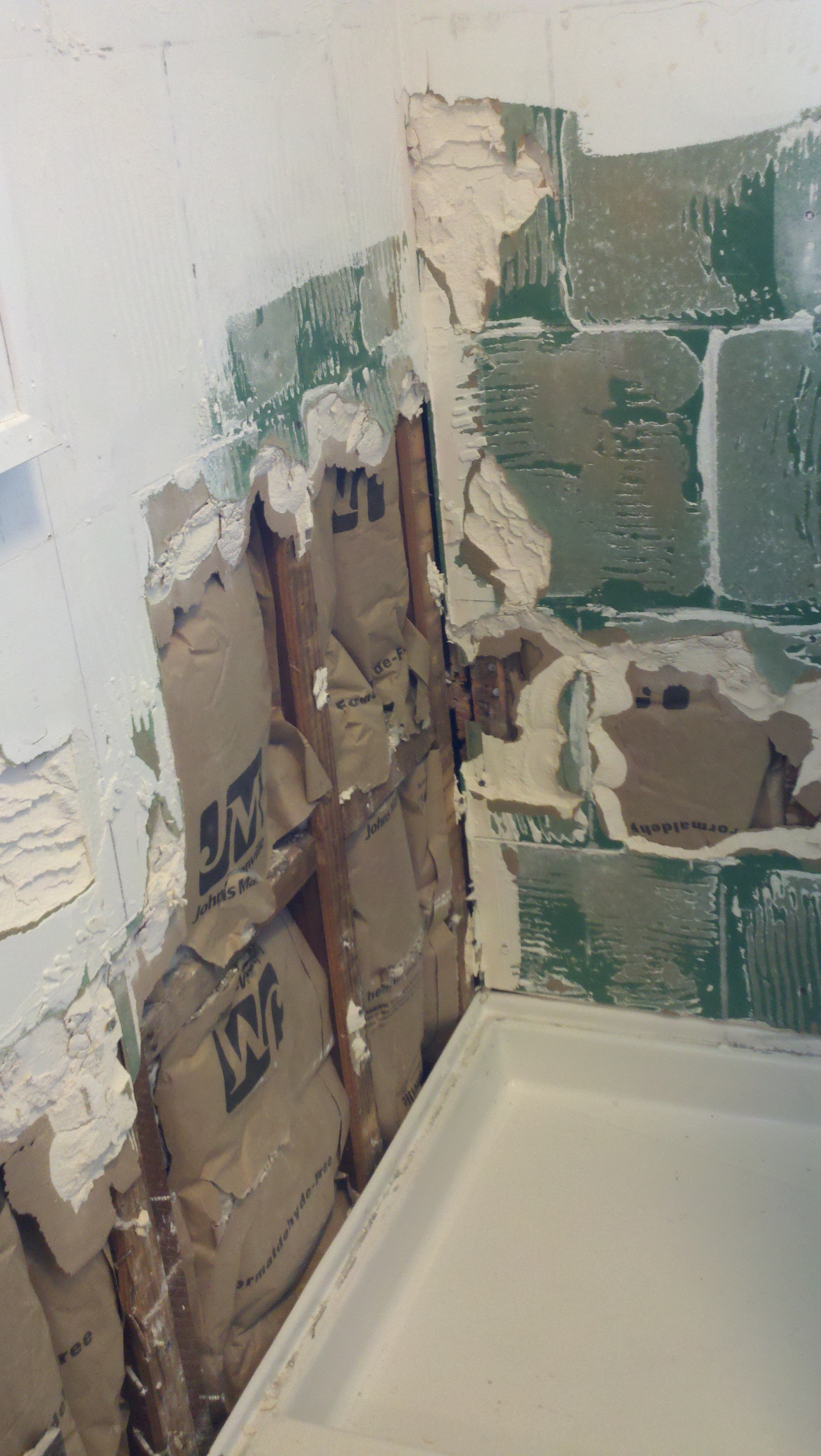

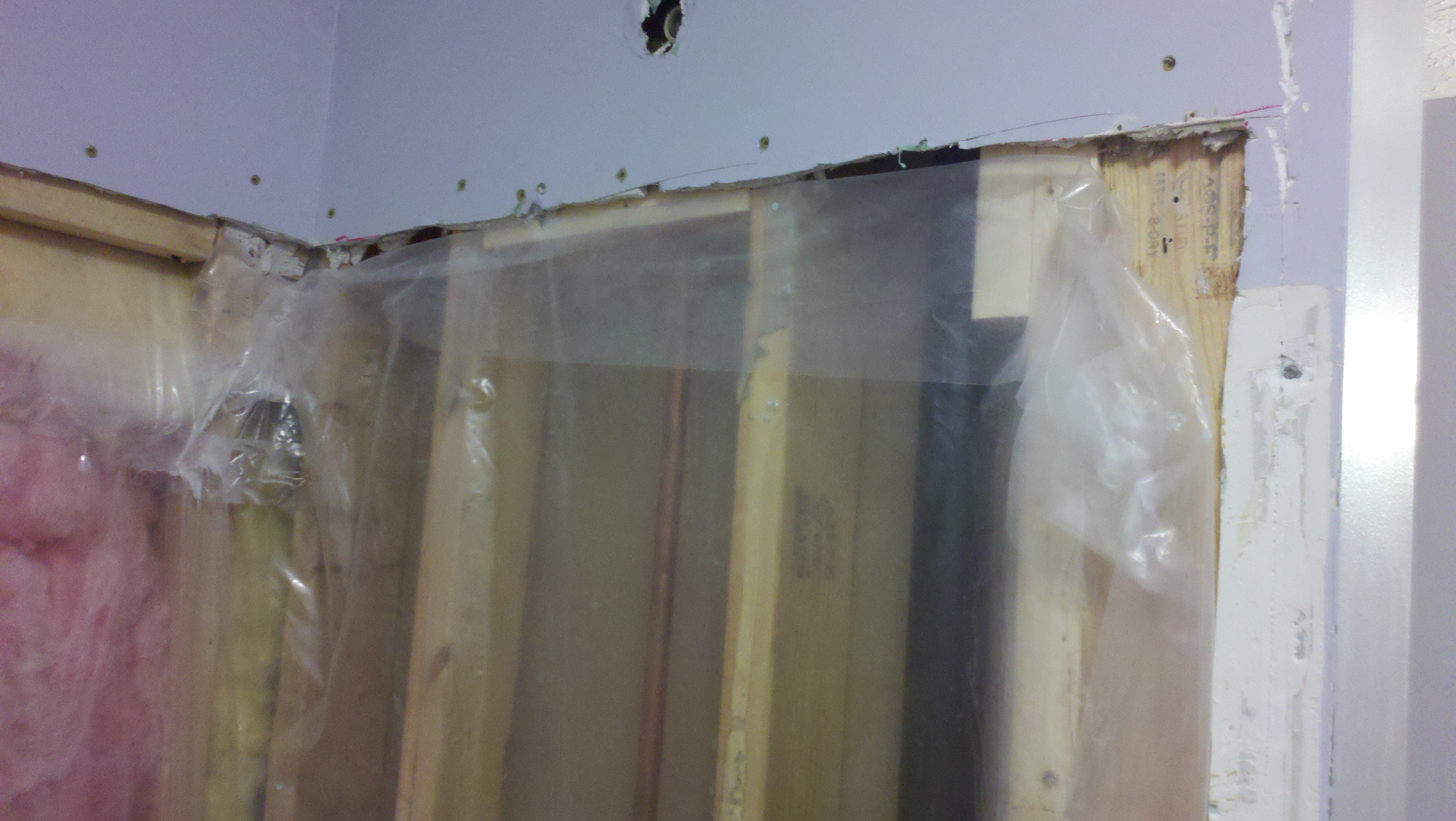

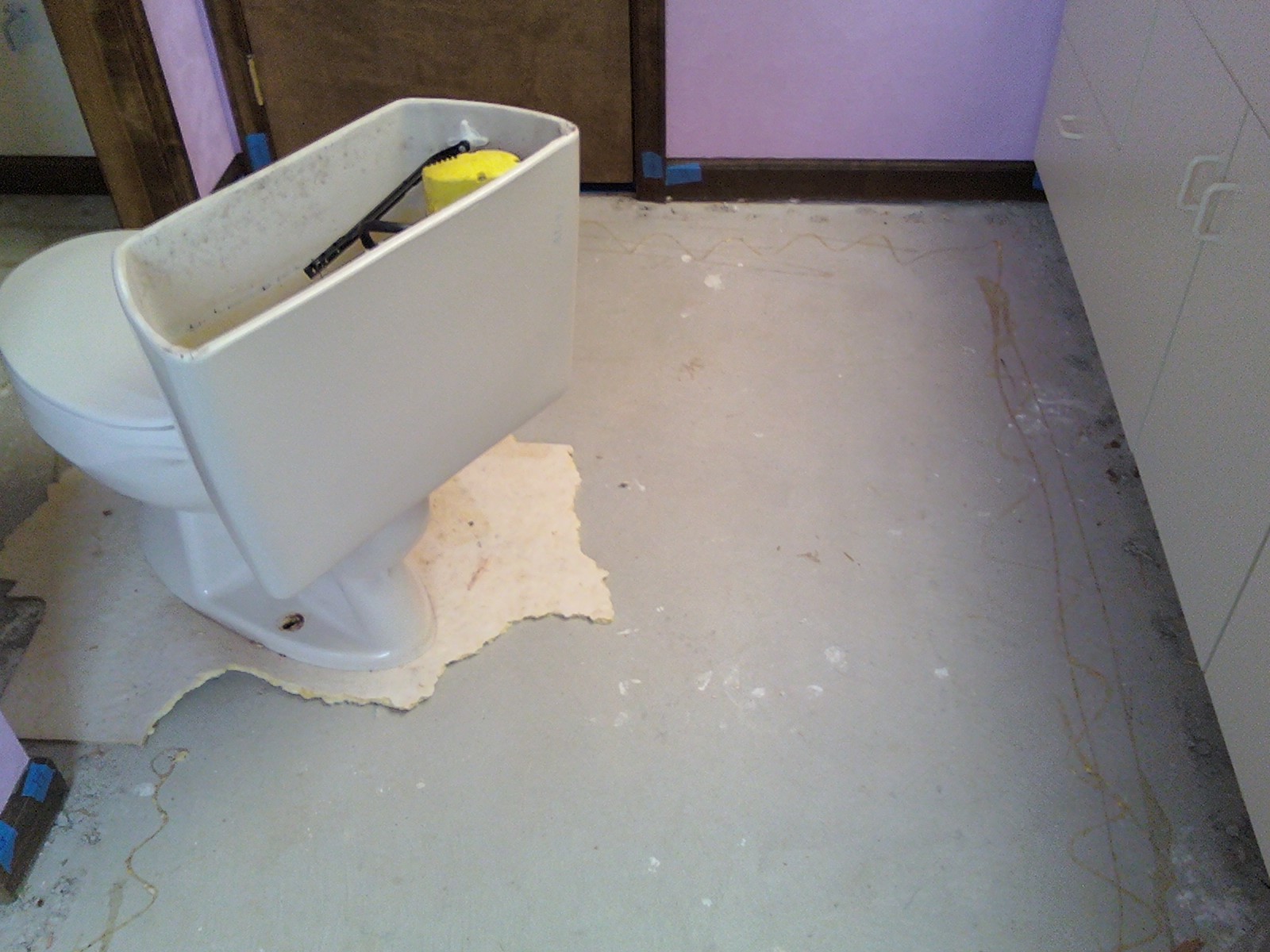

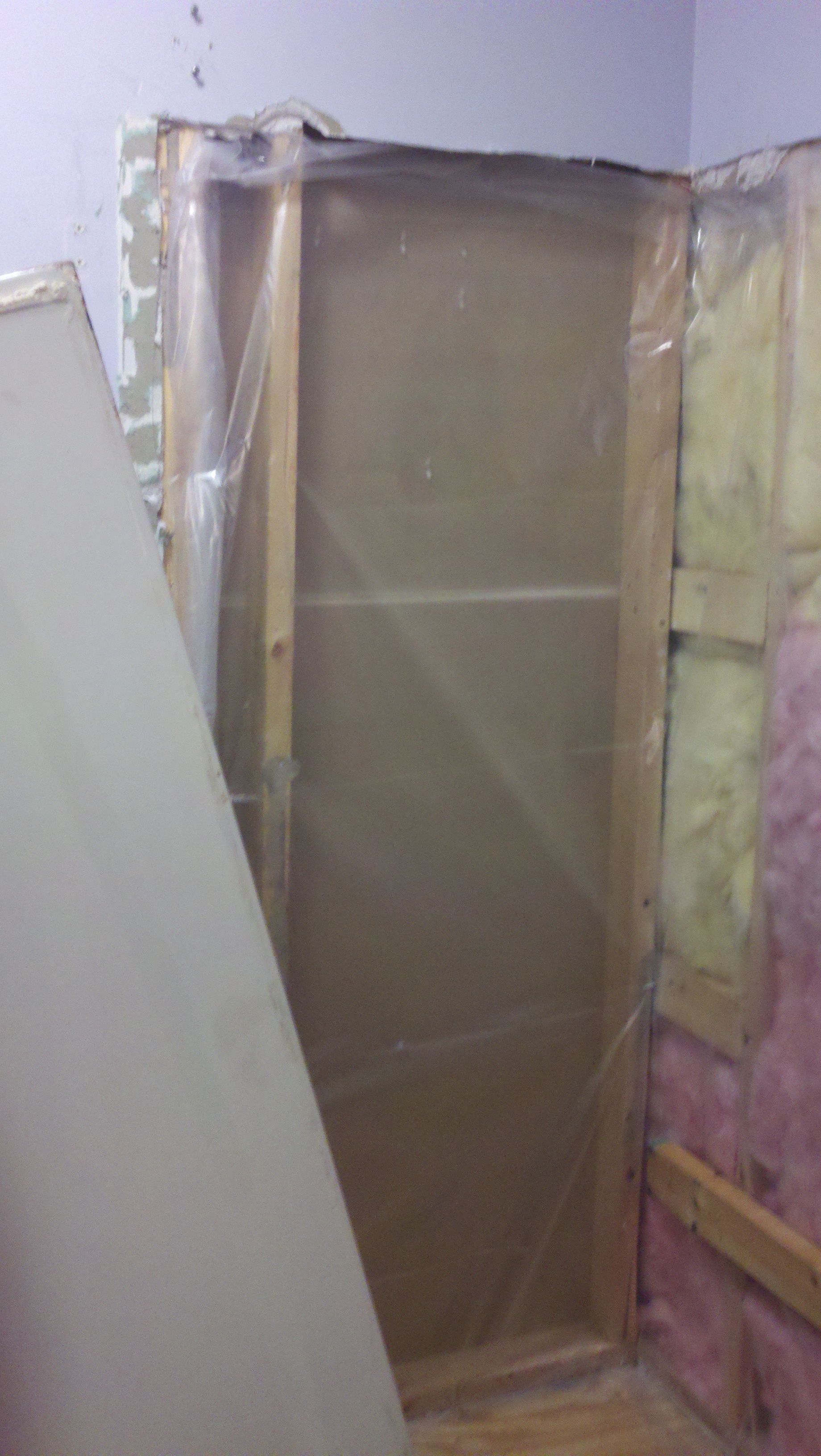

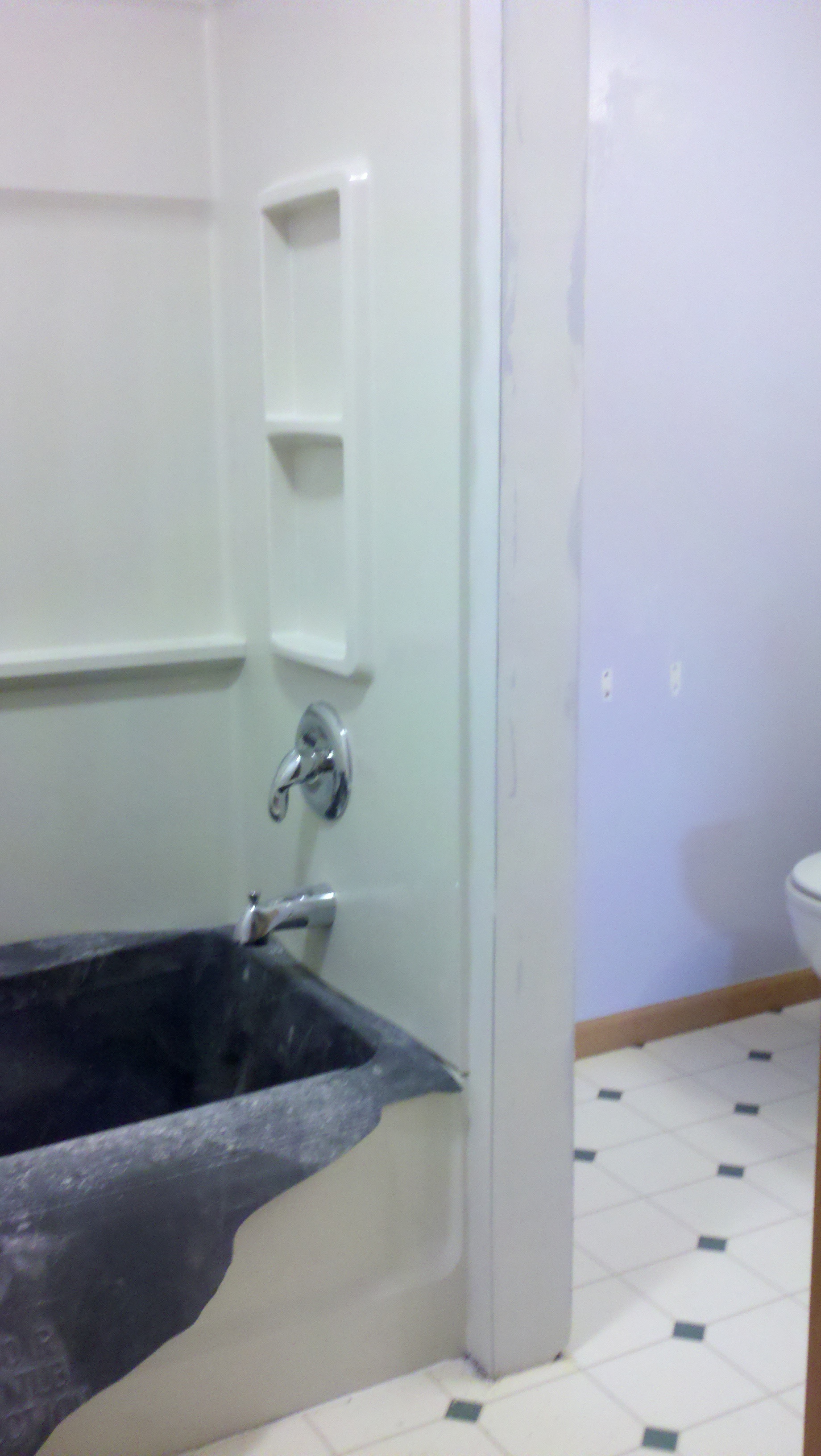

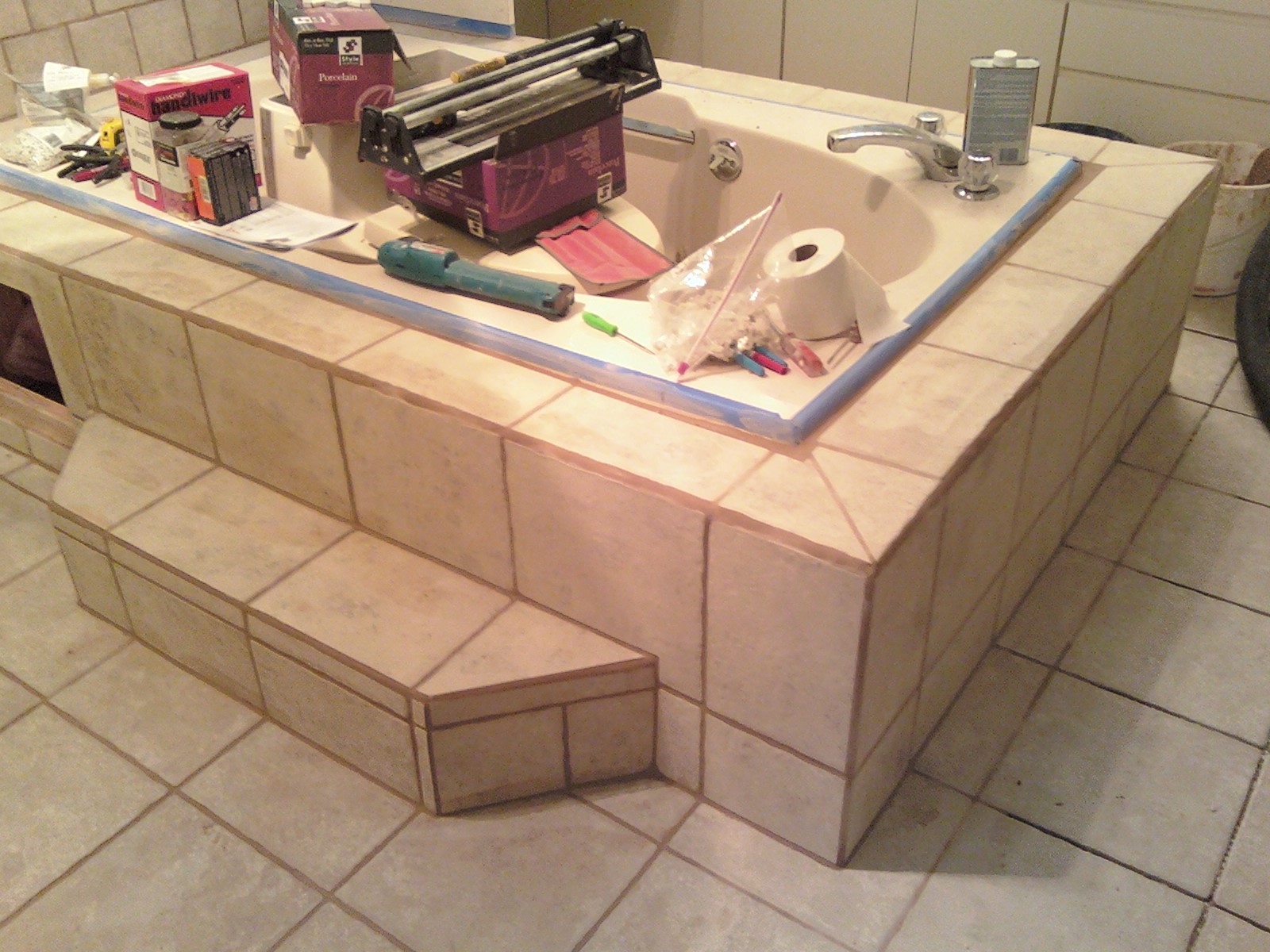

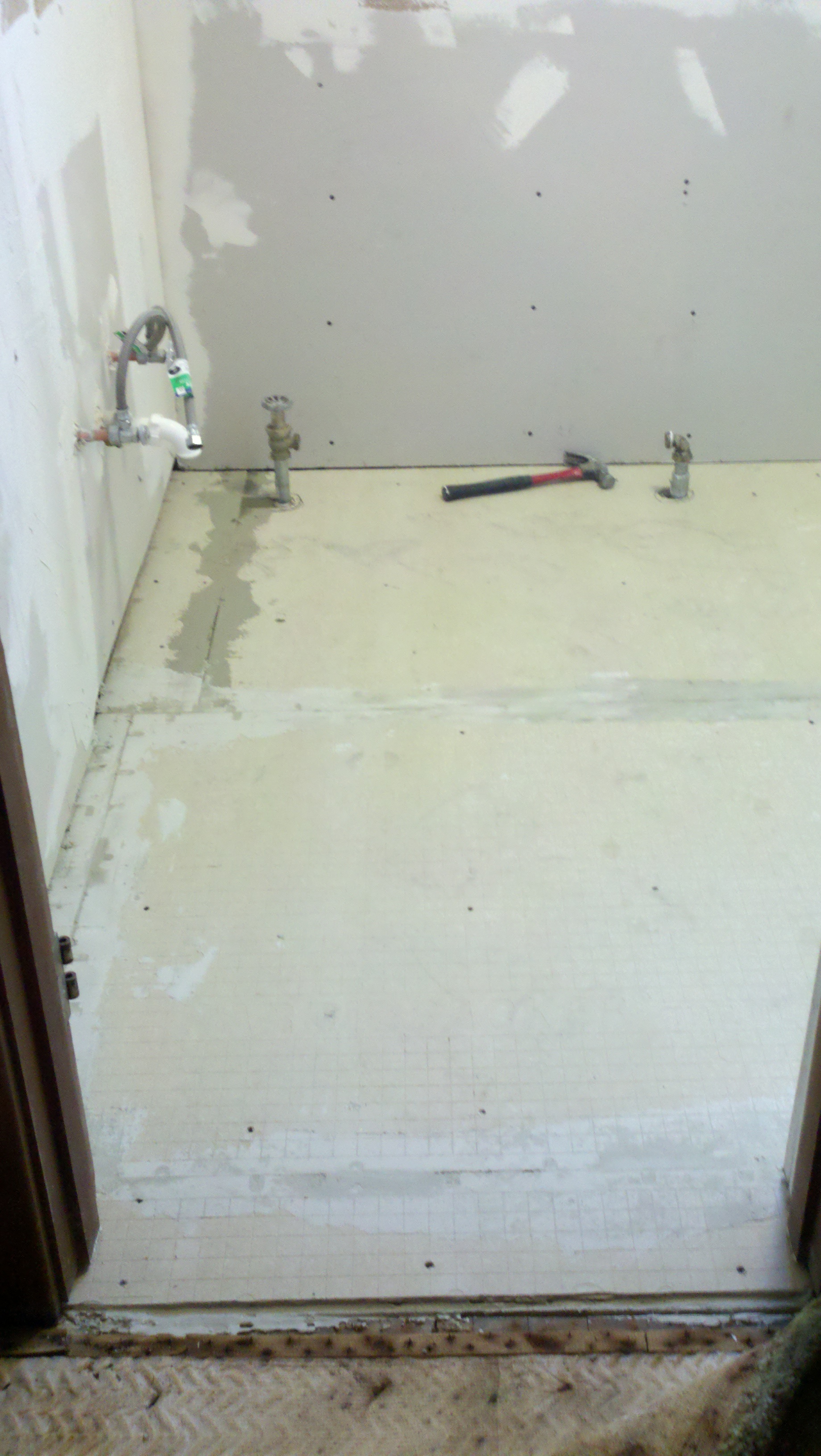

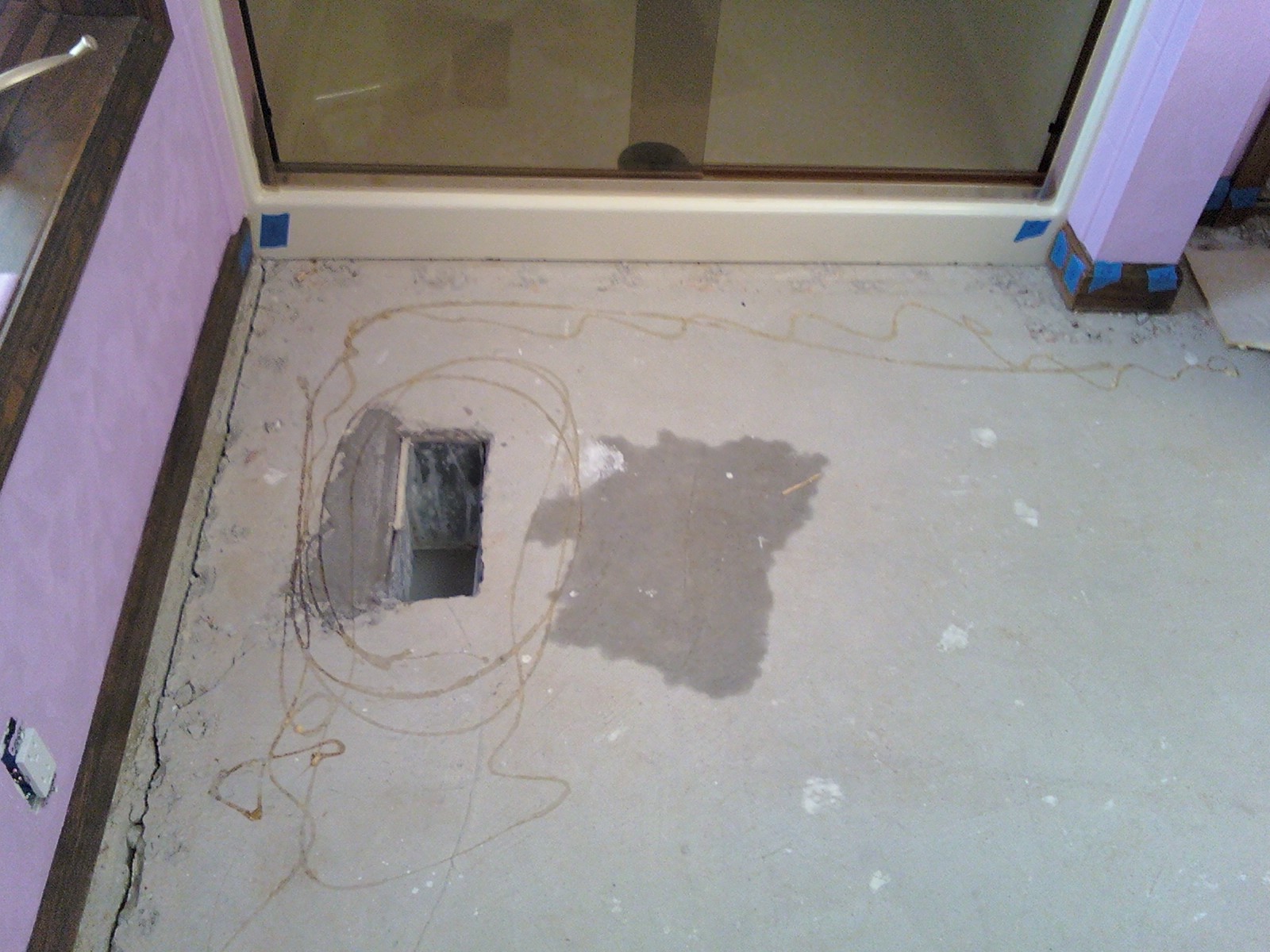

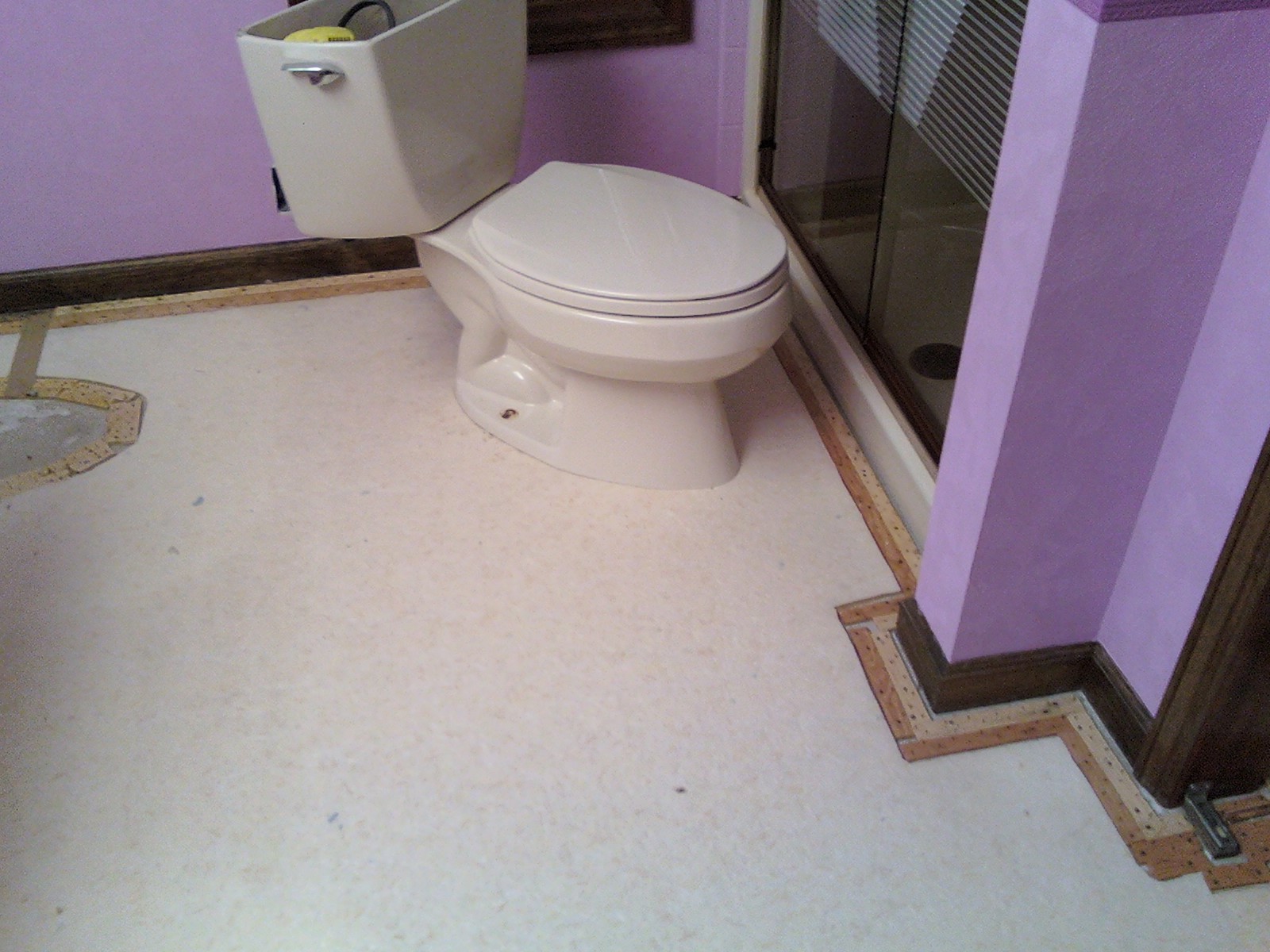

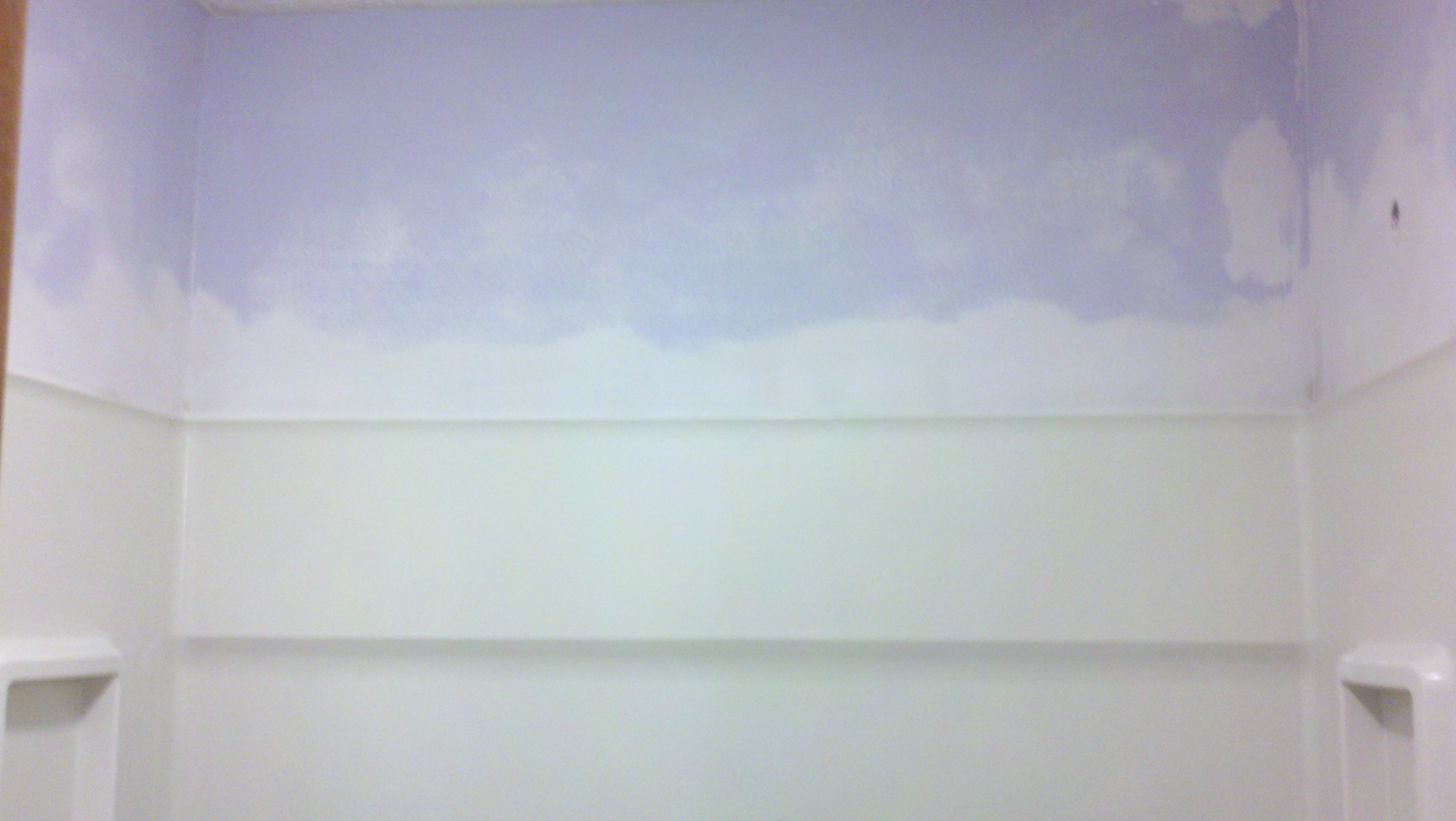

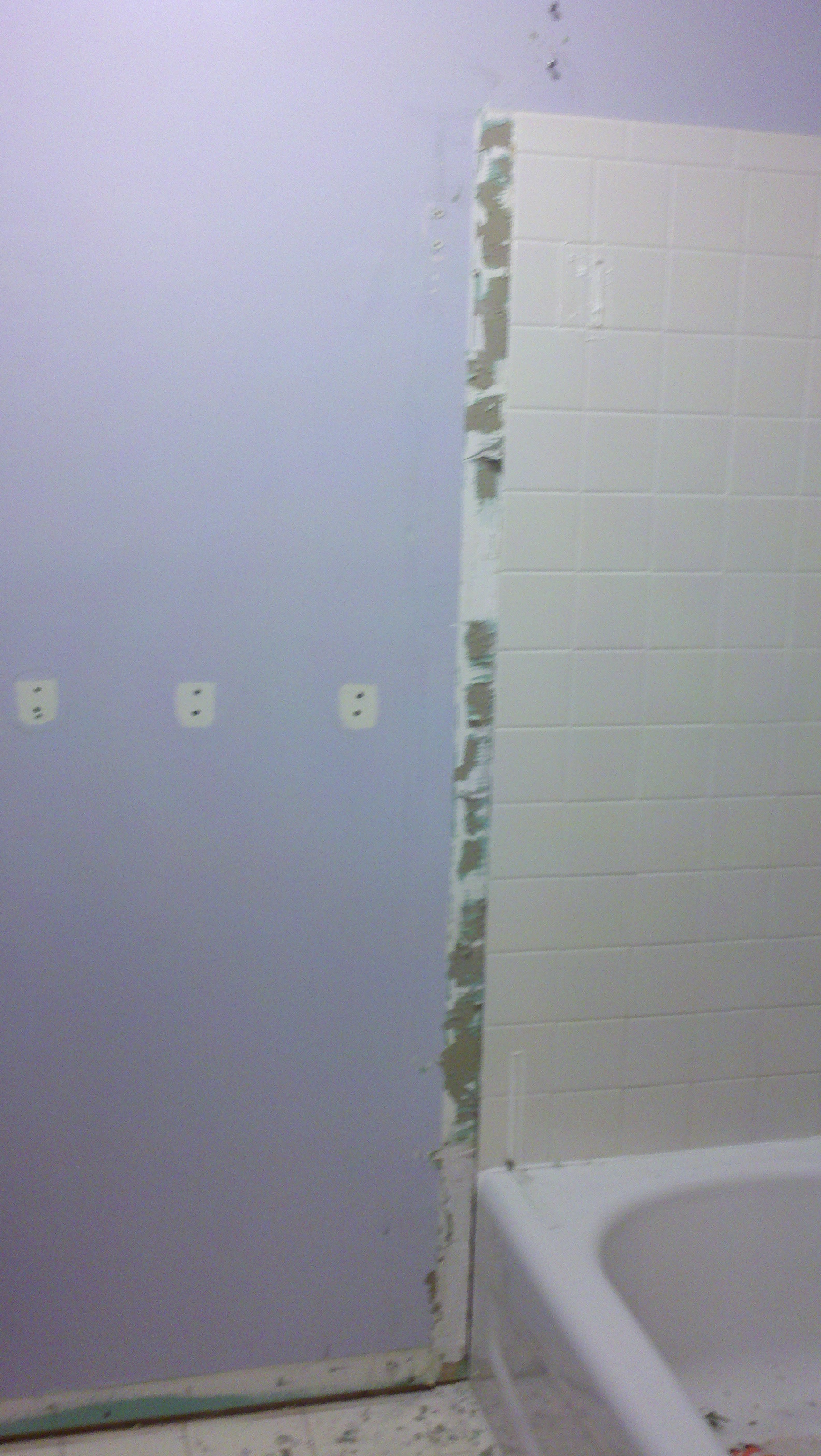

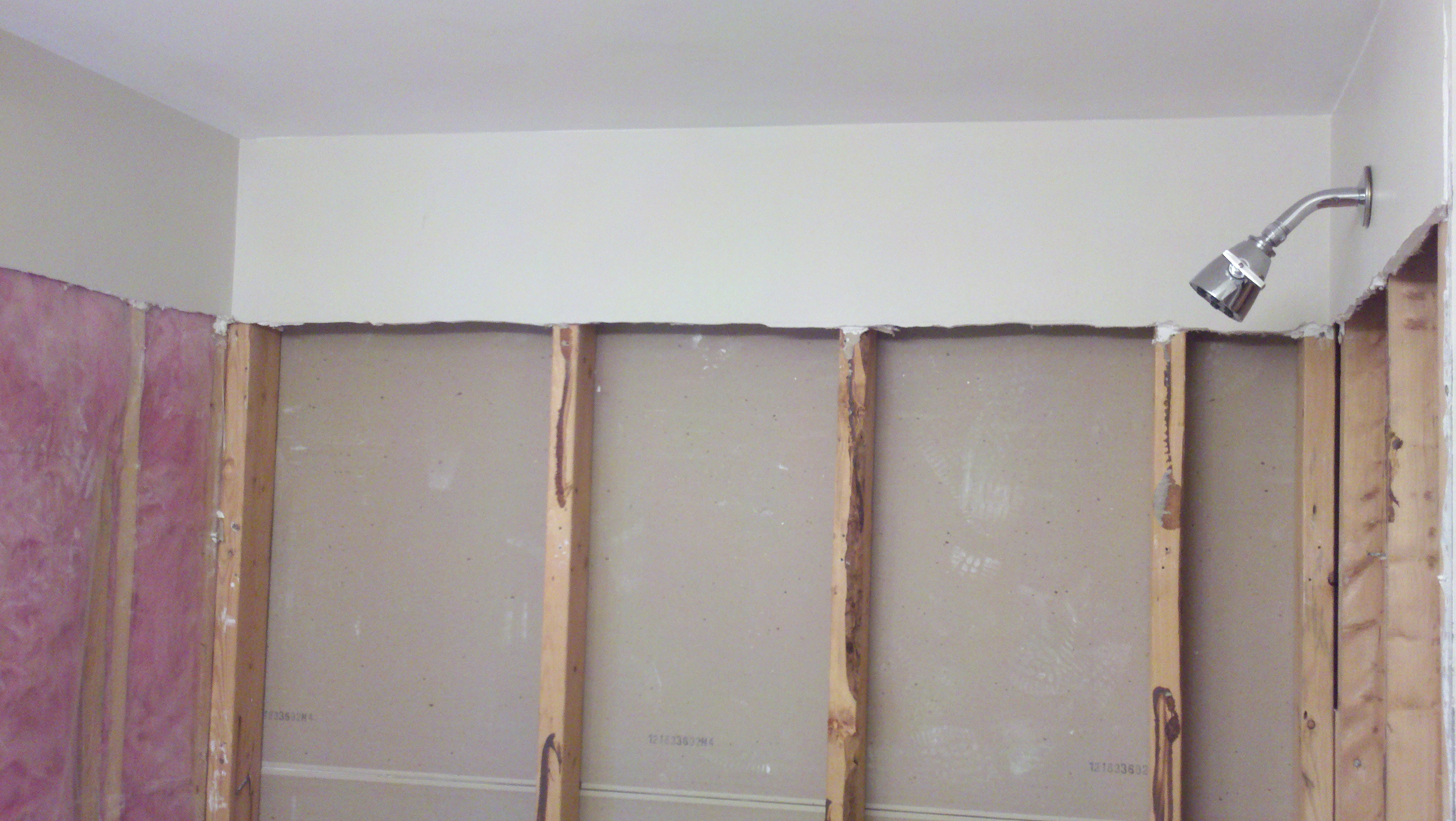

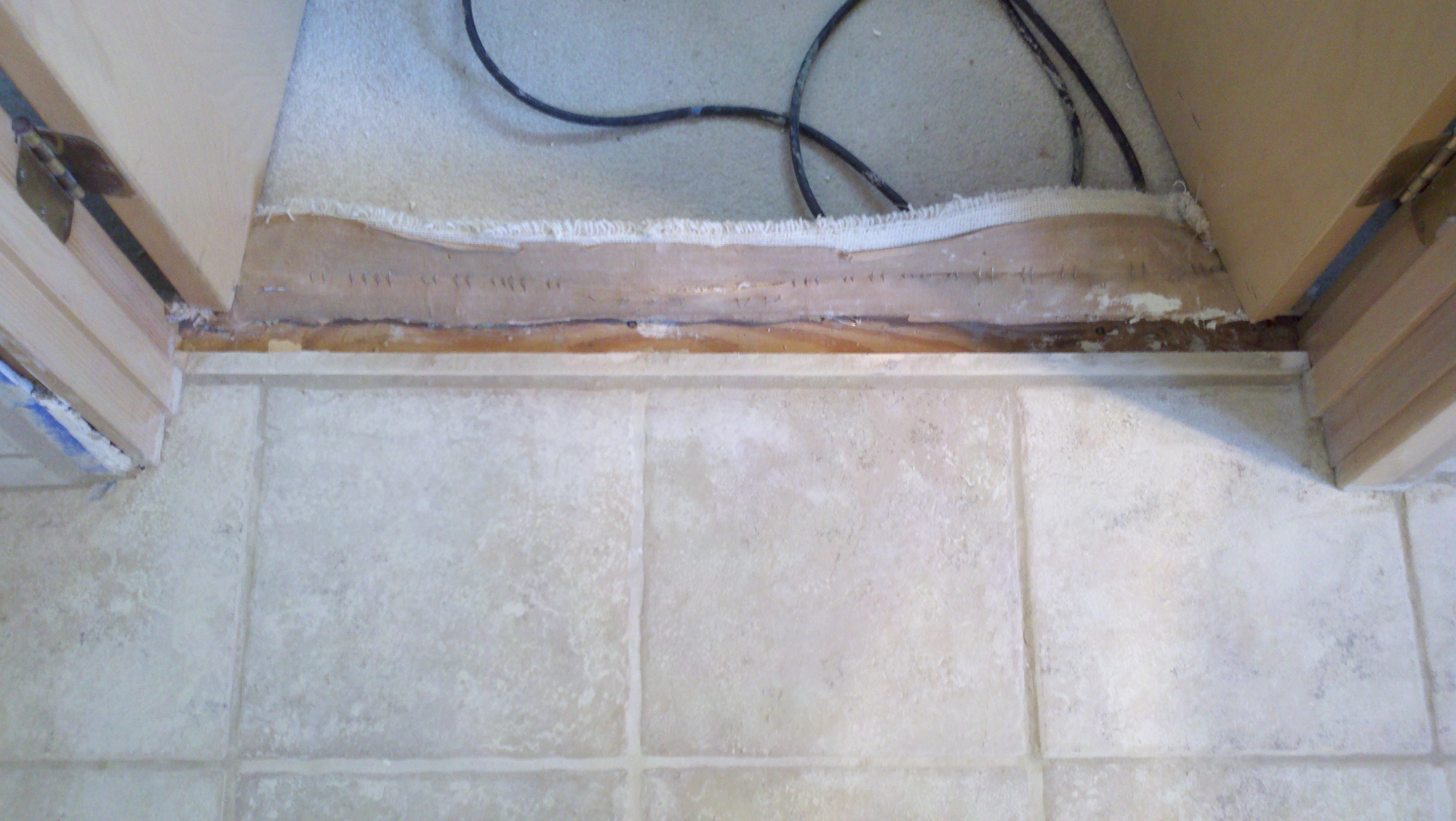

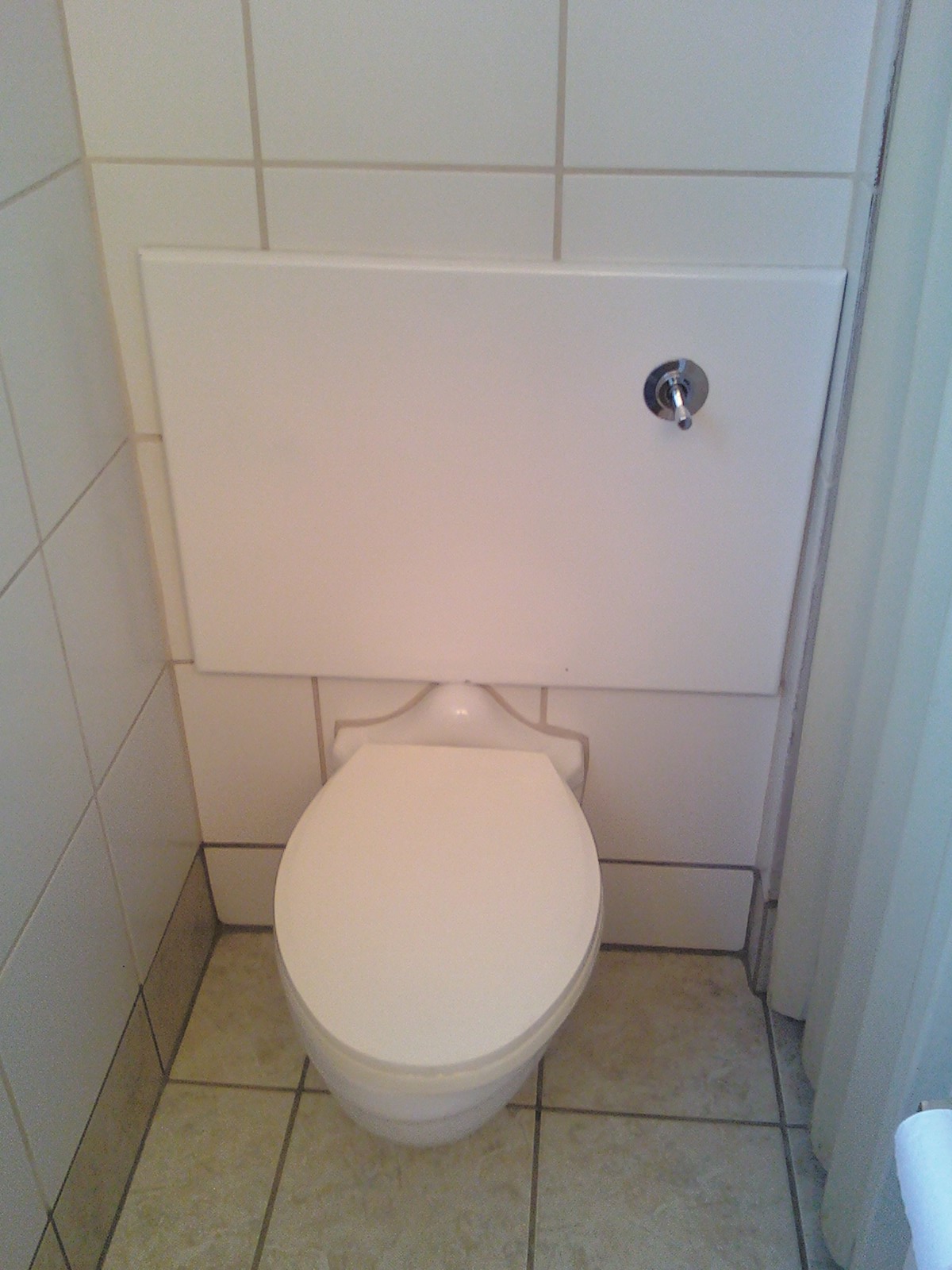

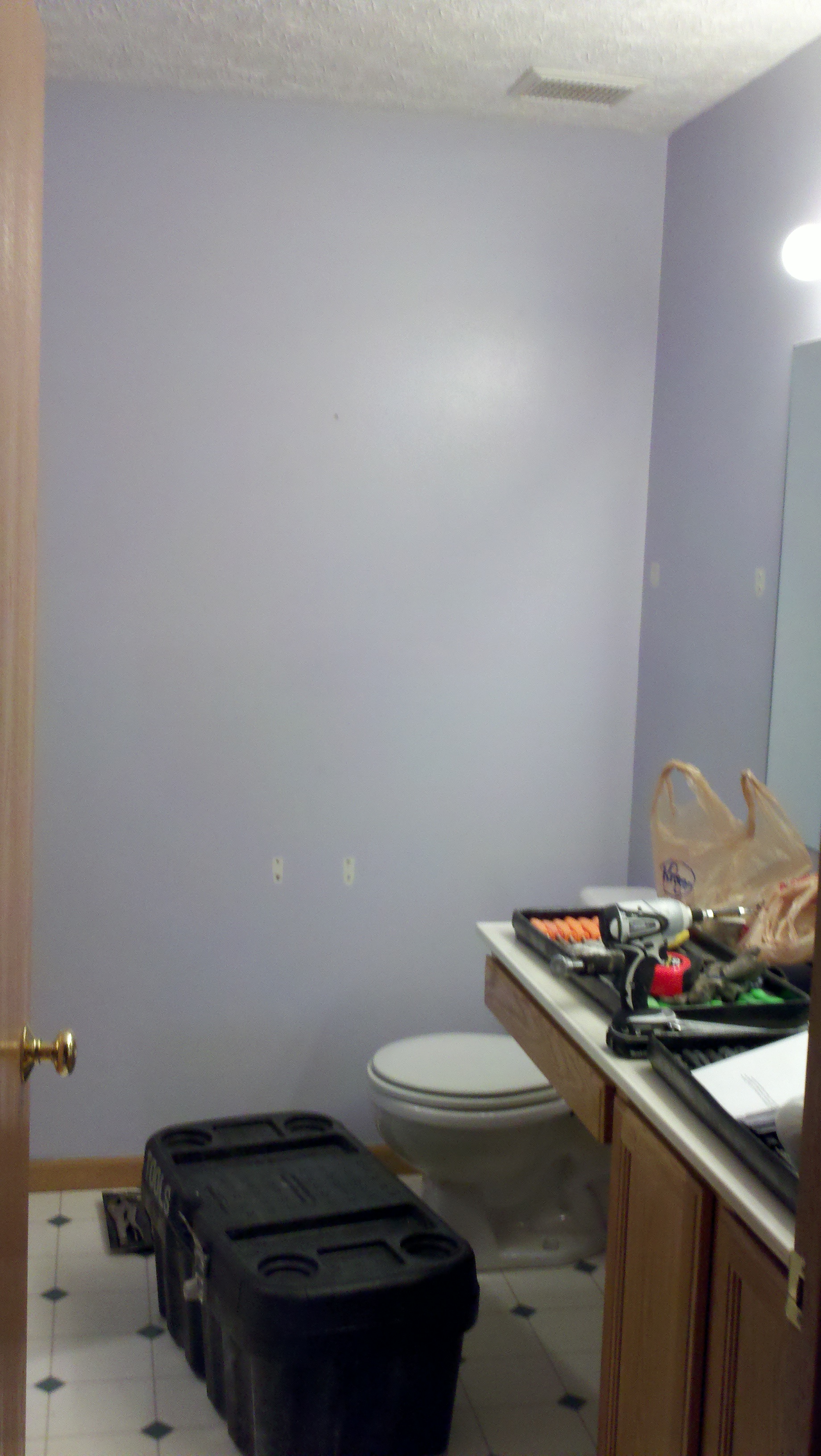

5137 Pebble Brook Drive Electric Floor Heat & Tile Installation Tile and electric heat was a product that Stanley & Carolyn Matthews desired to be installed in her master bathroom. The process consumed approximately 21 working days to complete. The installation method required numerous steps for tile laying preparation, process, and completion. Information and depictions are provided through a process of method explanation and product placement reference. Changing the bathroom floor to tile, from carpet, is a process that will prevent water absorption and stain tribulations. The pictures labeled one through three, shown below, provide depictions of the original floor, after removal of removal of the toilet, pad, doors, and carpet introduced a blank slate for the addition of heated coils and tile.

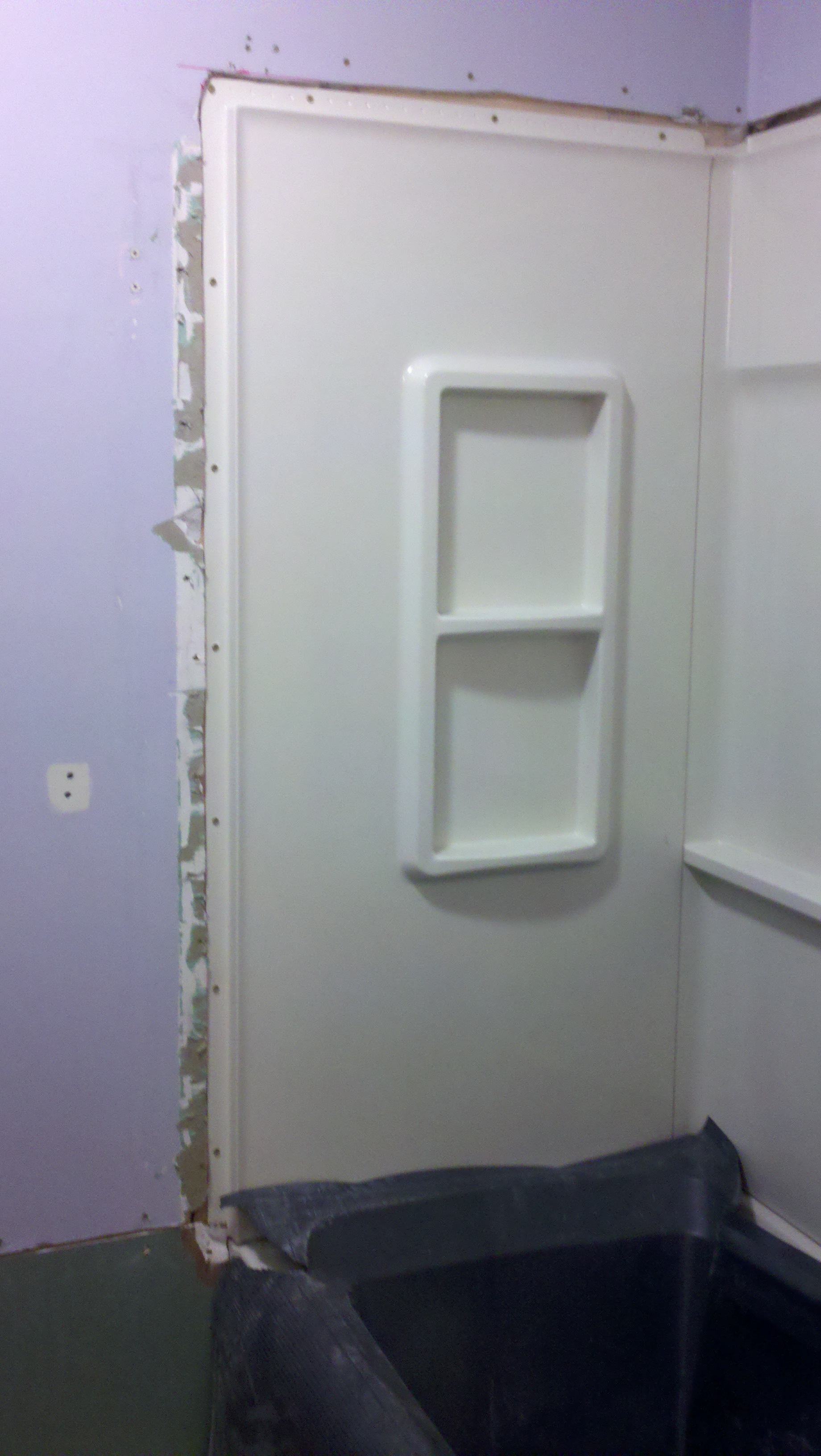

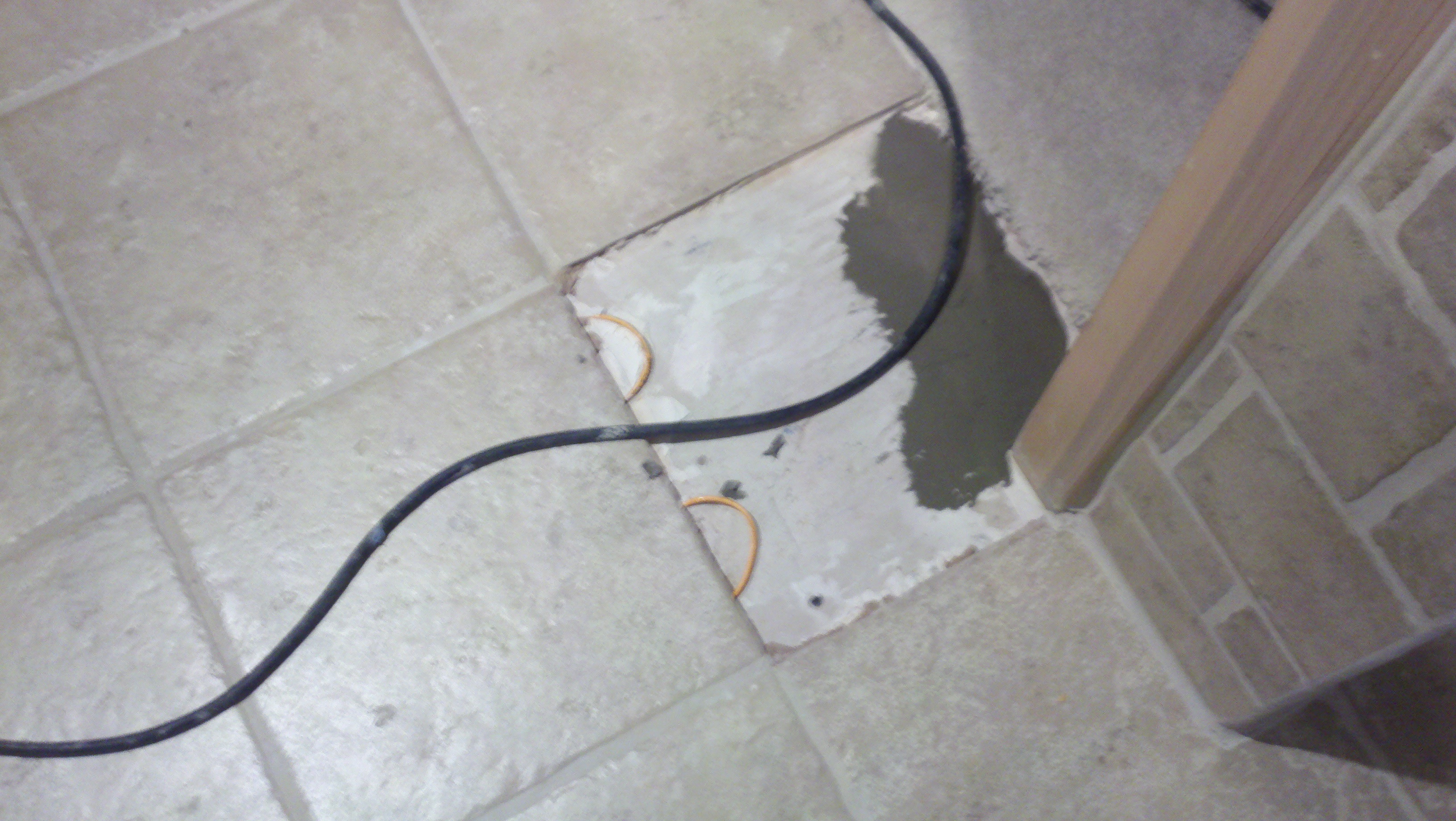

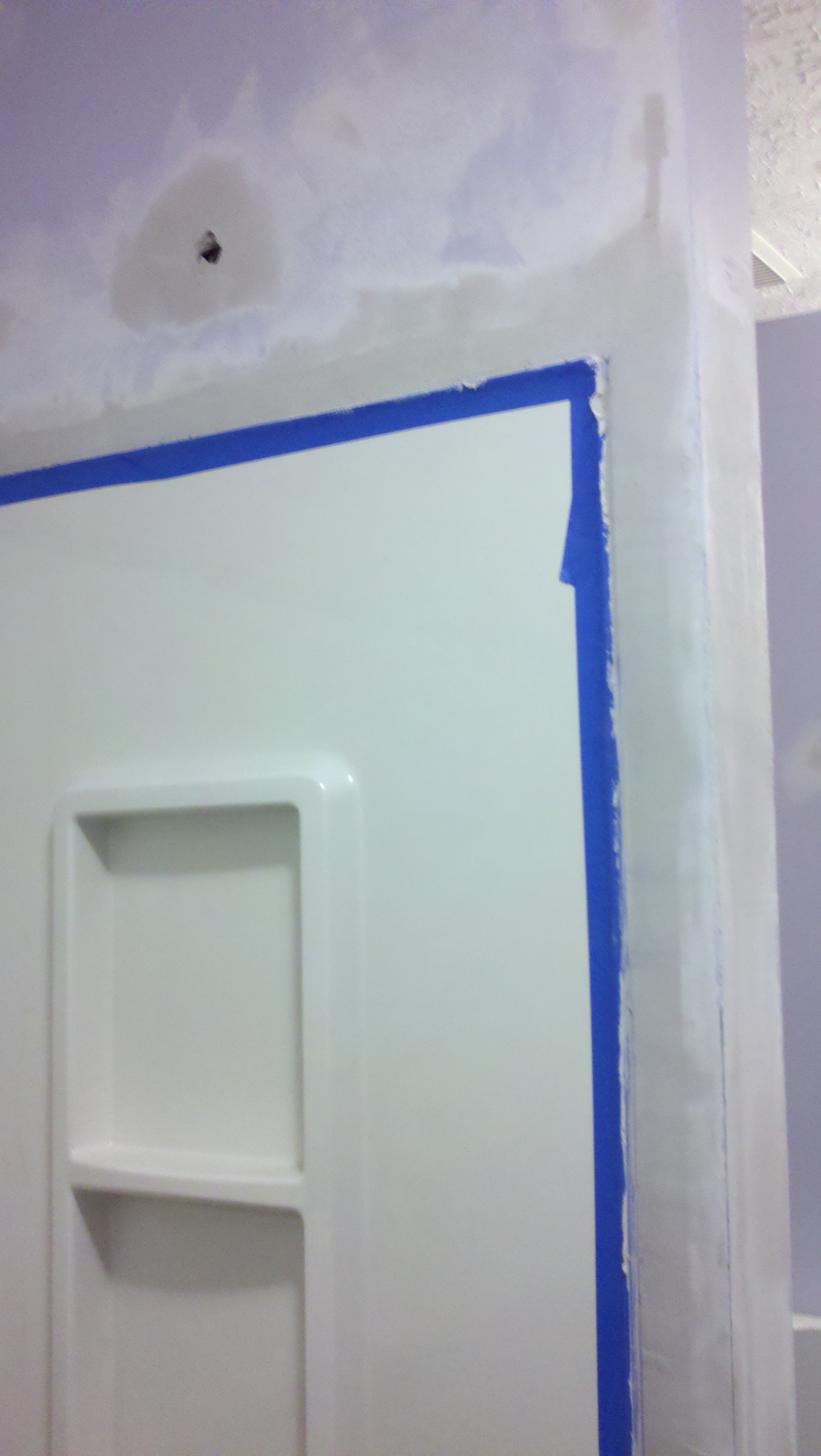

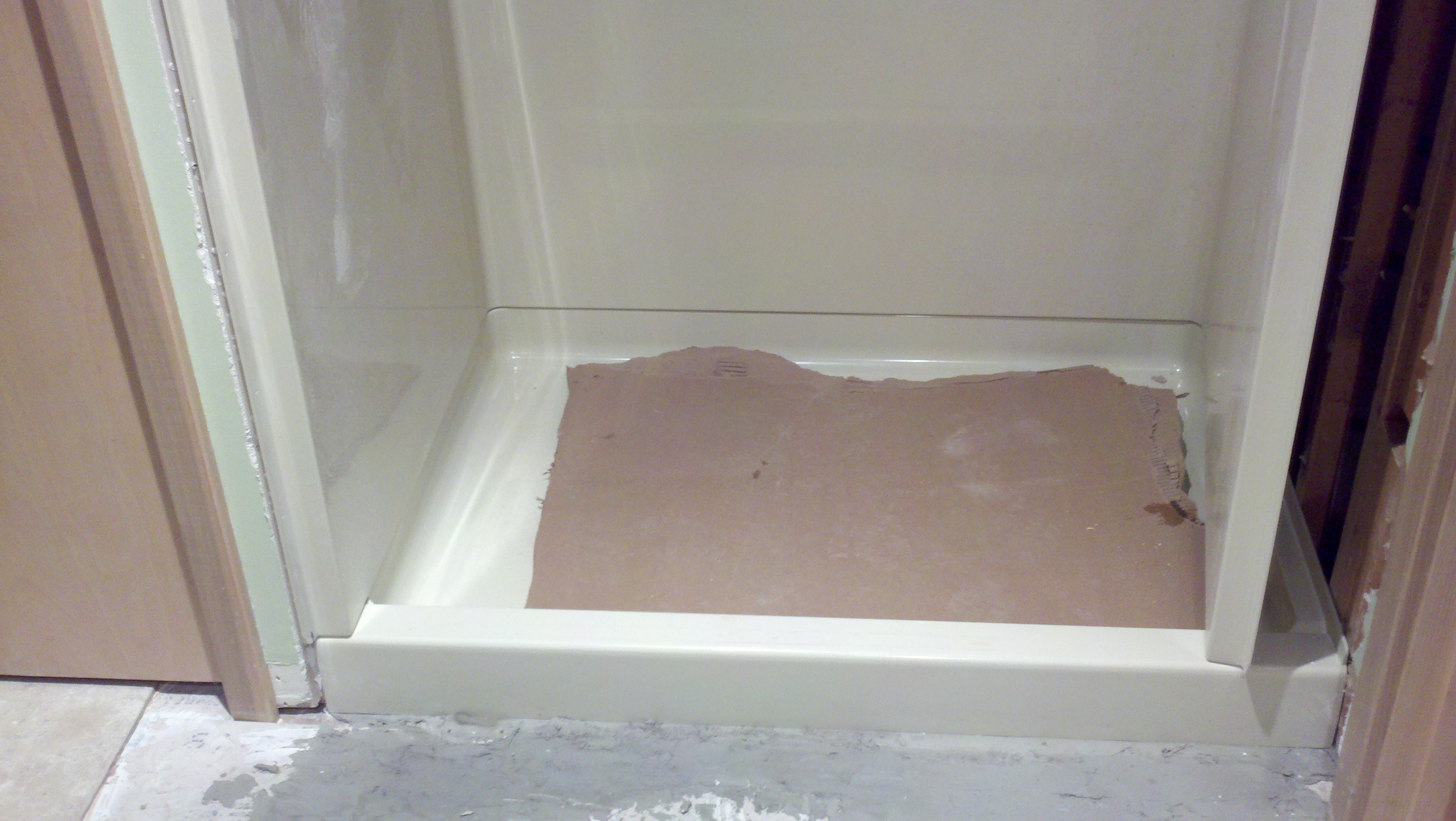

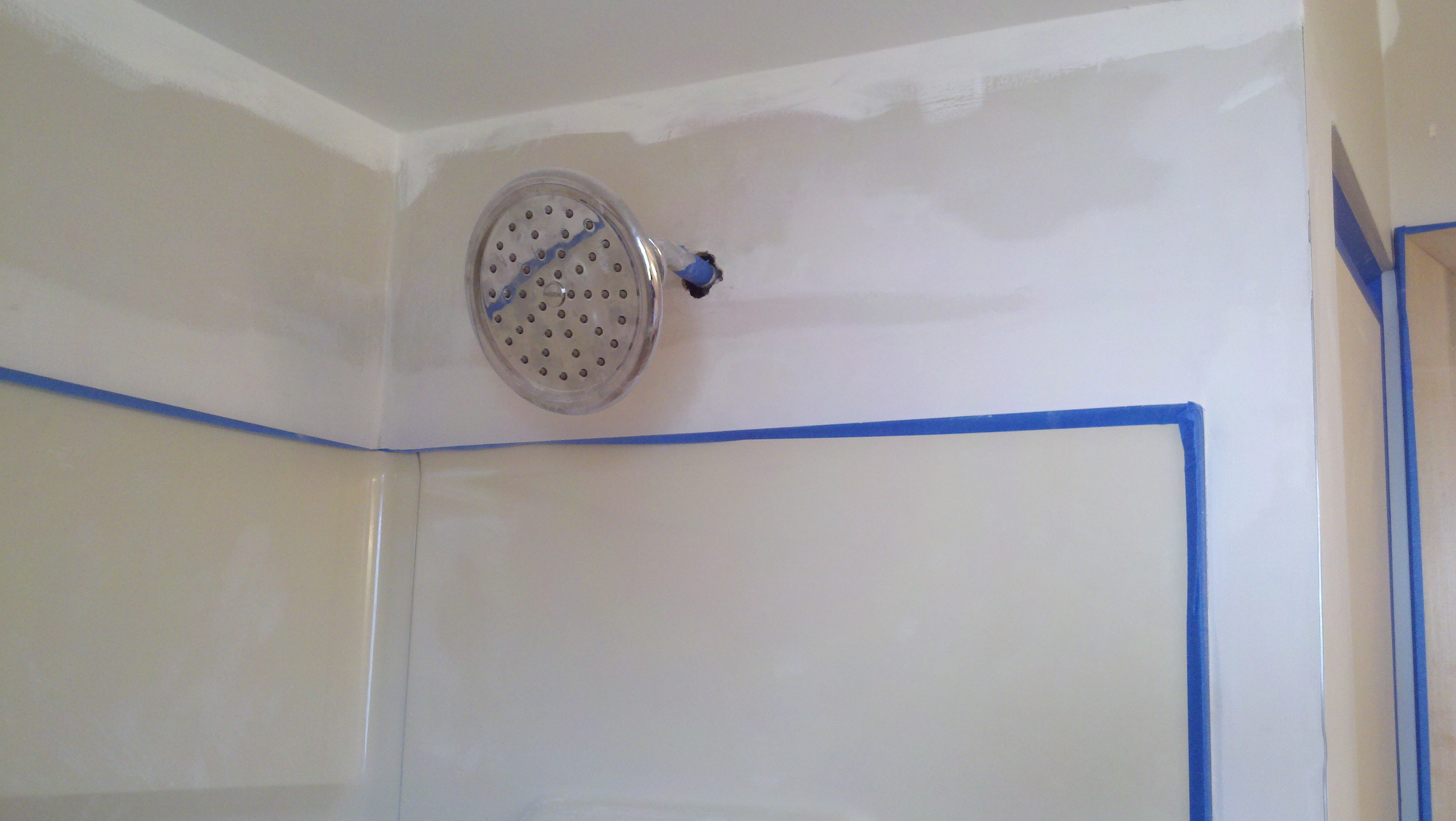

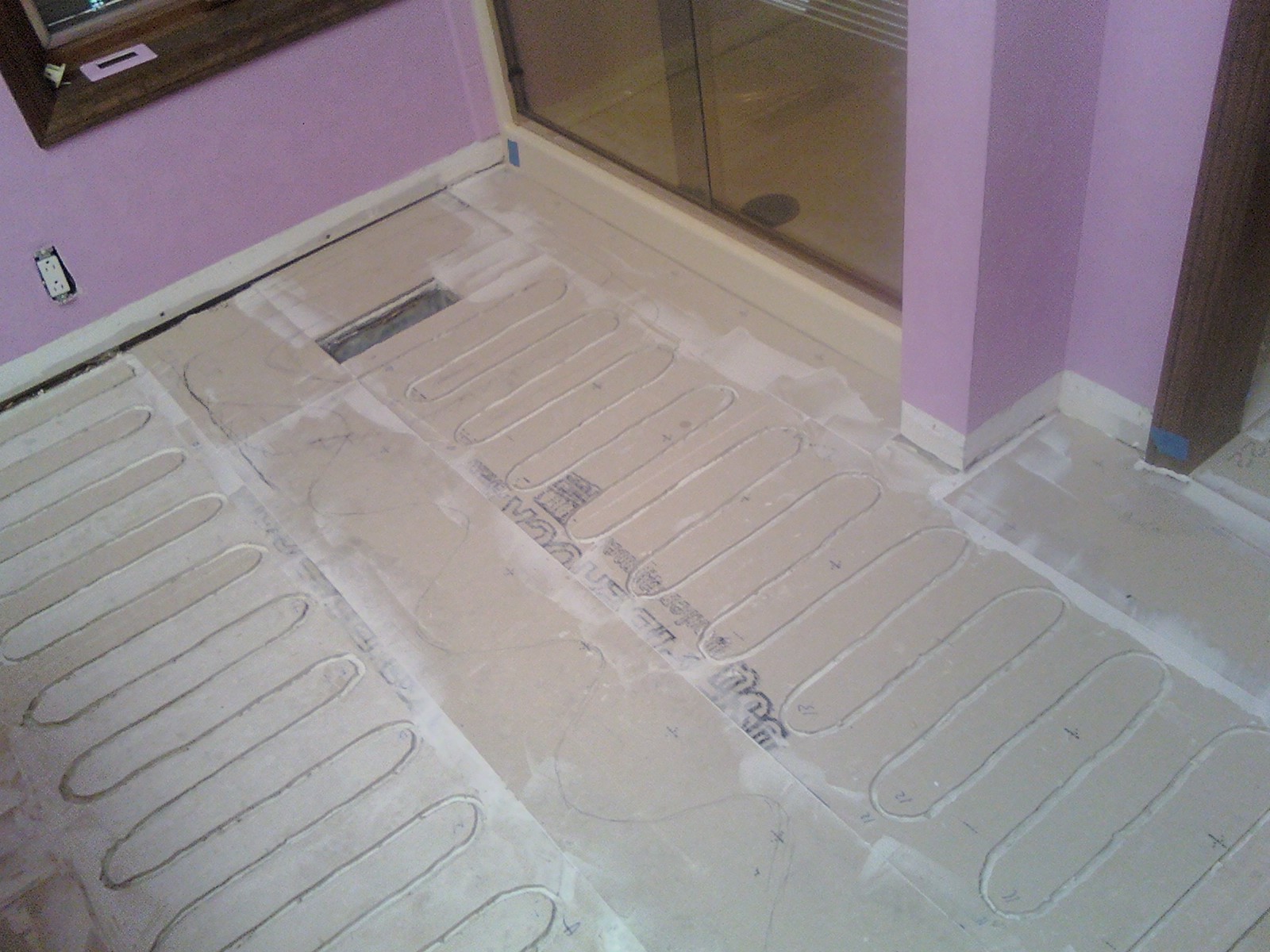

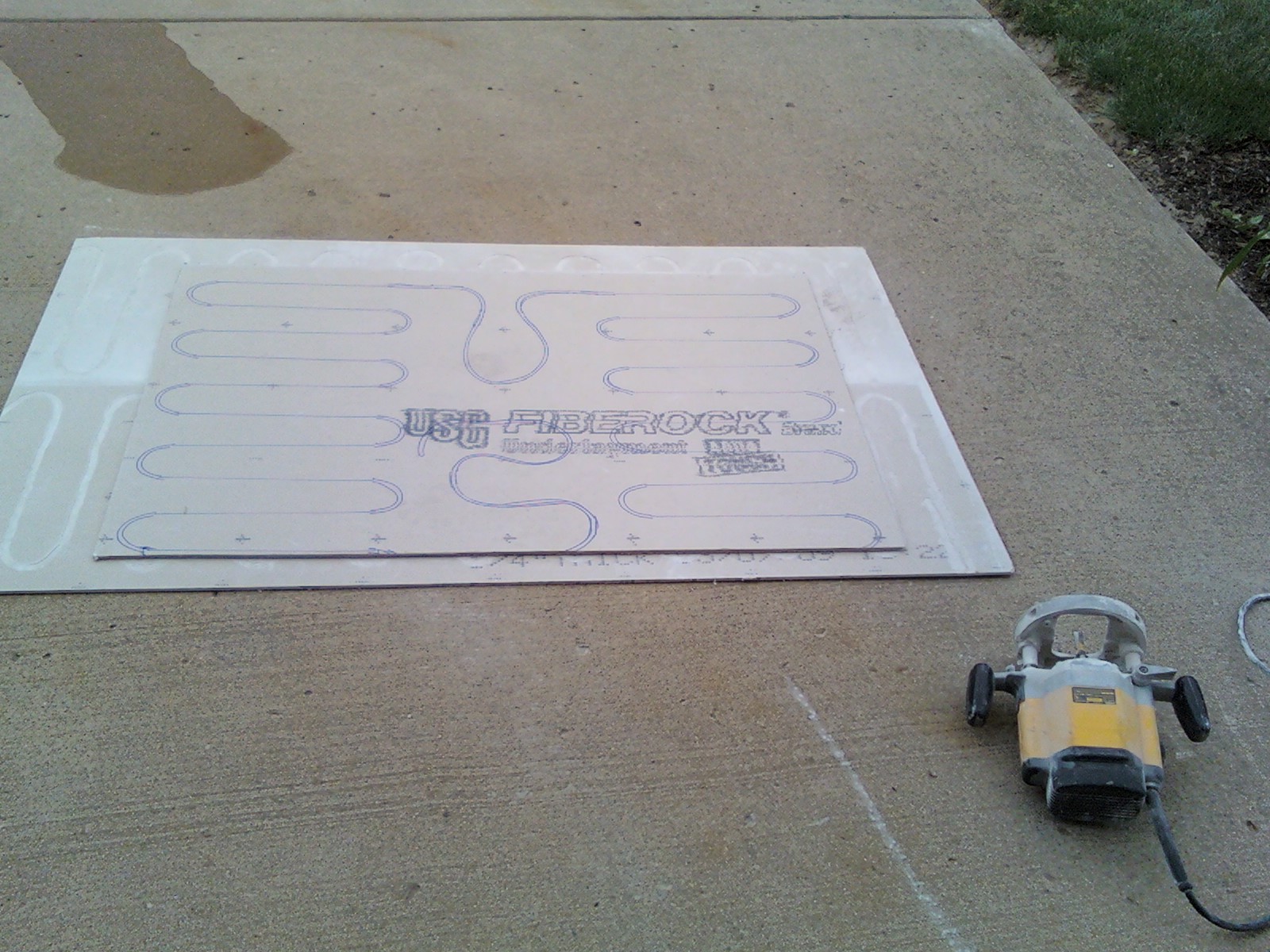

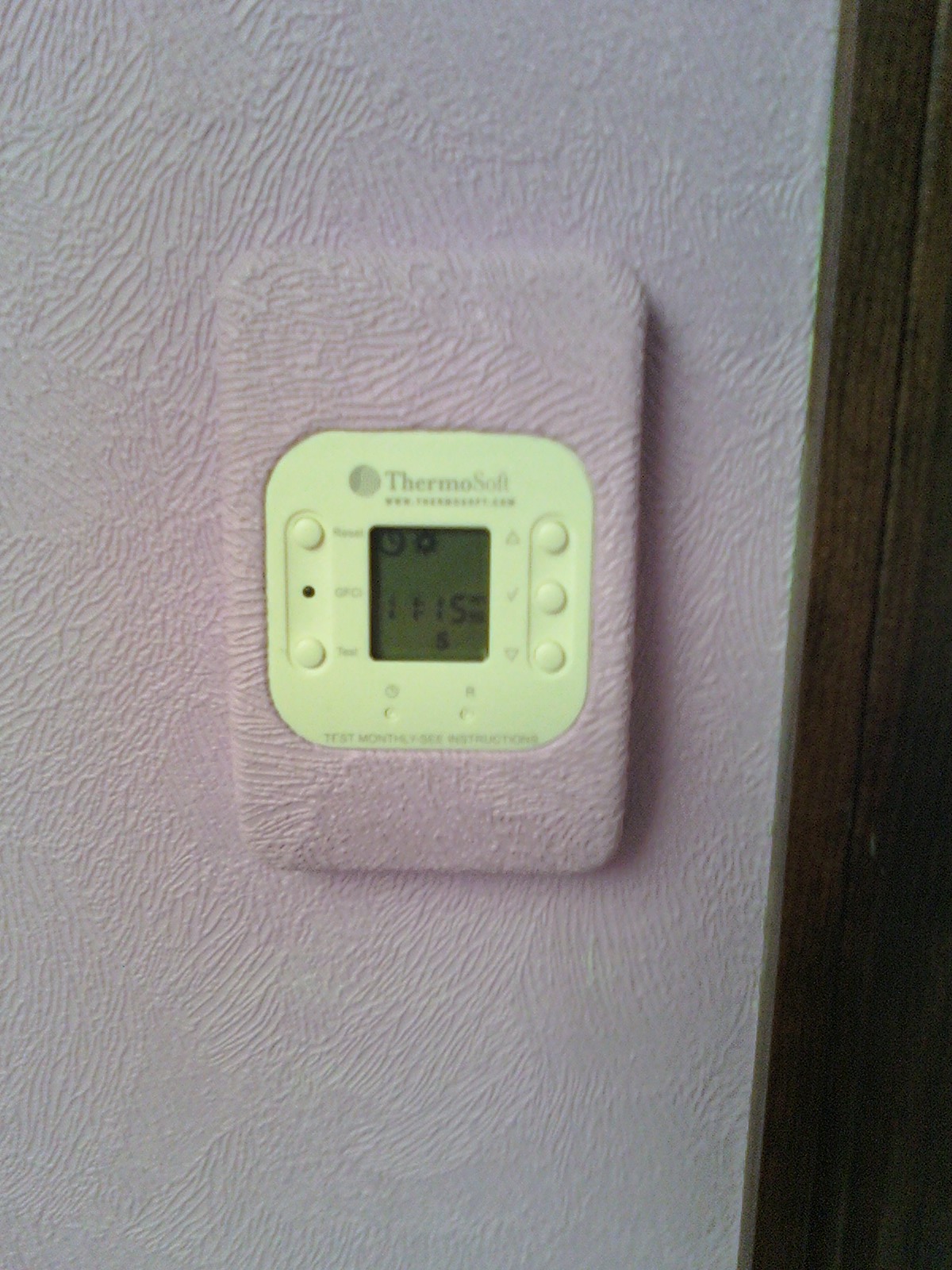

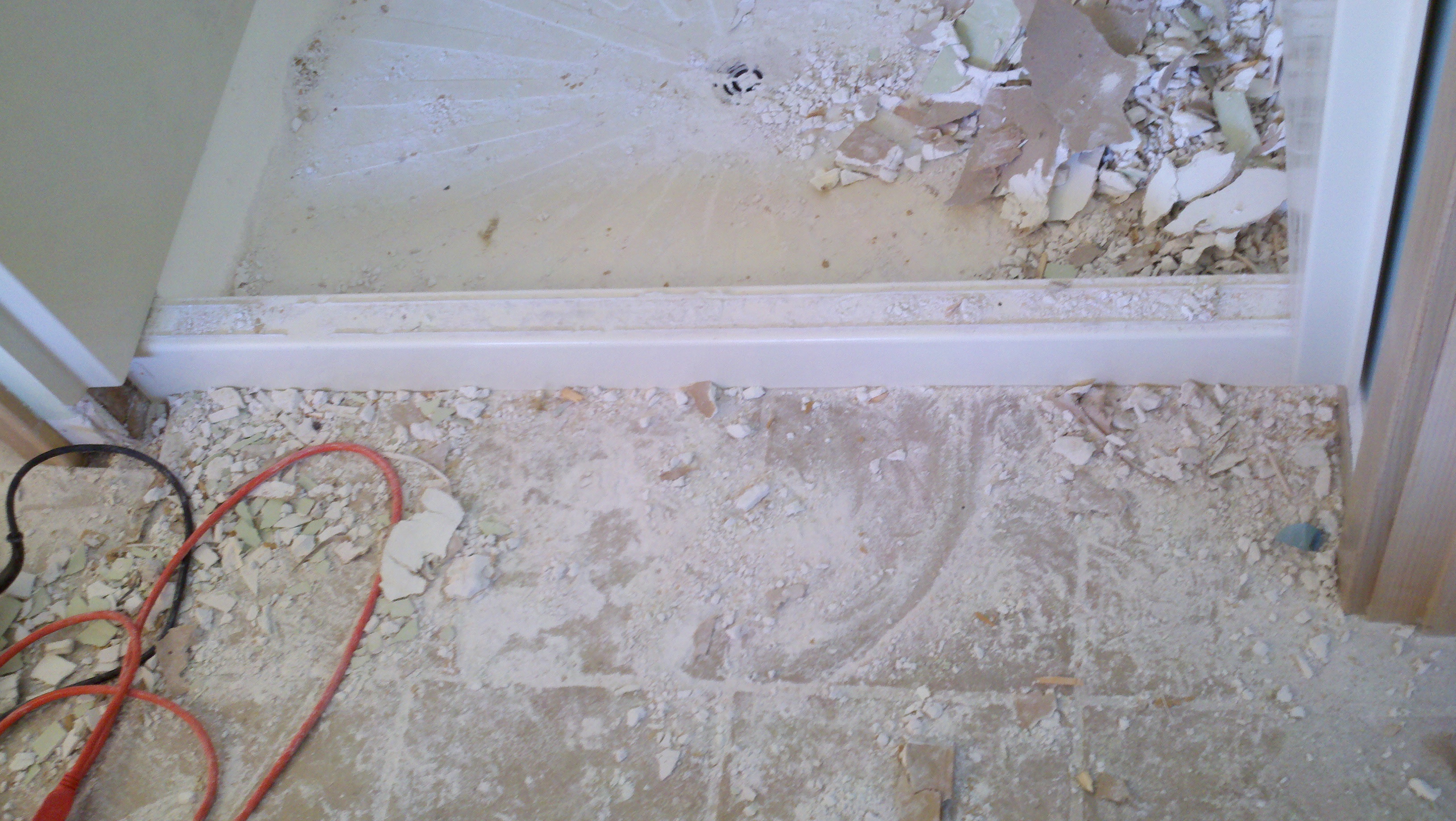

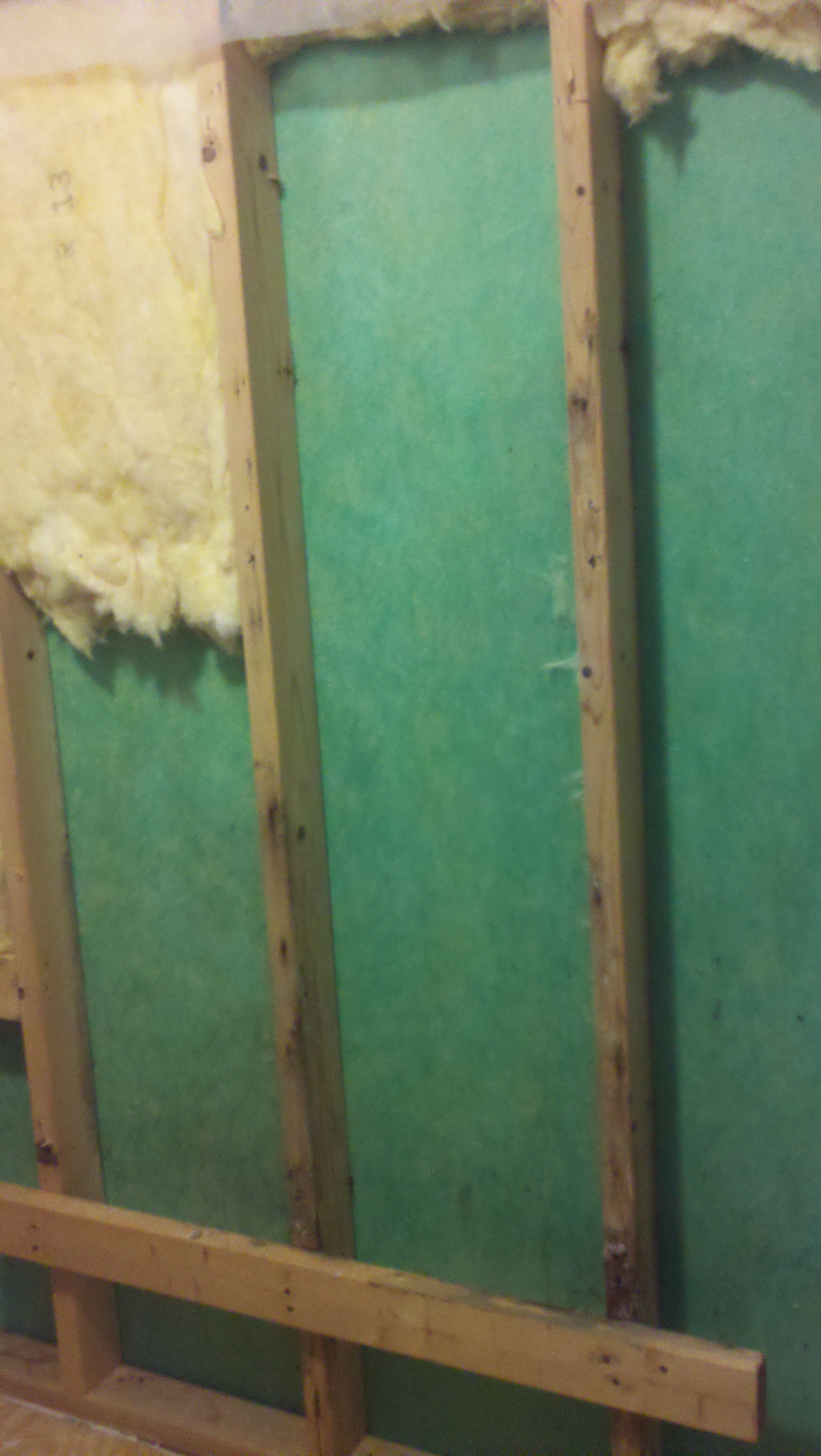

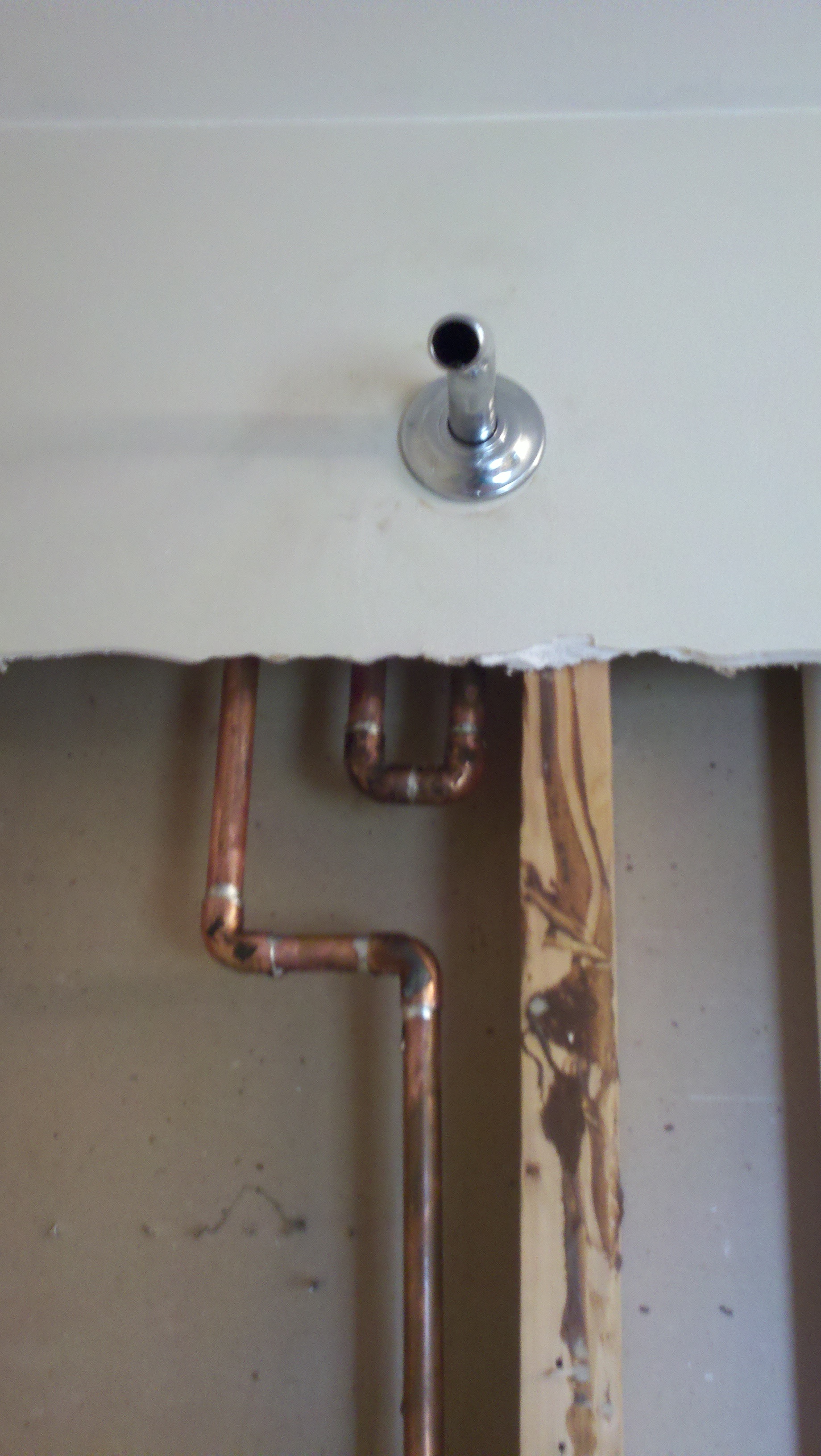

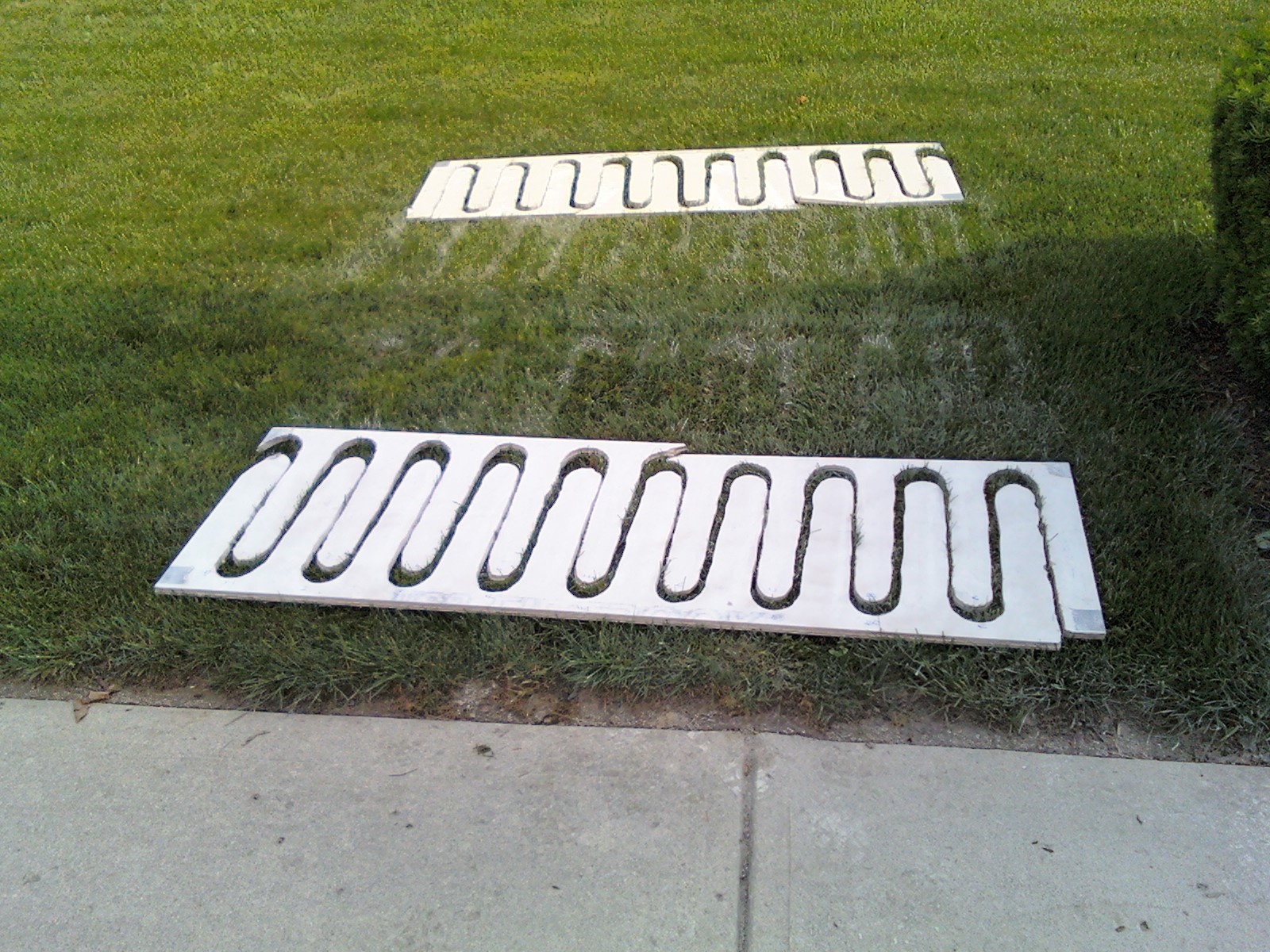

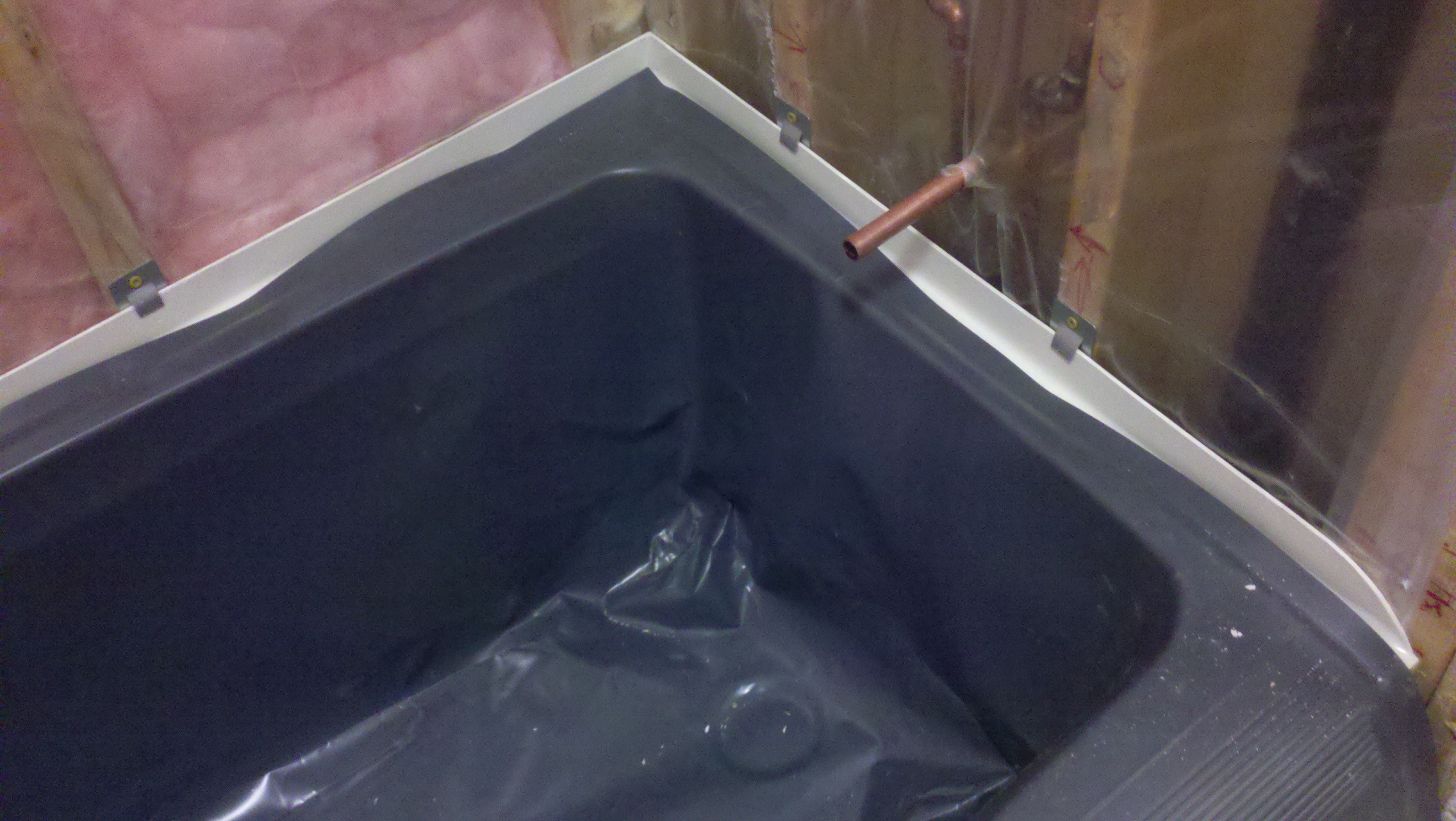

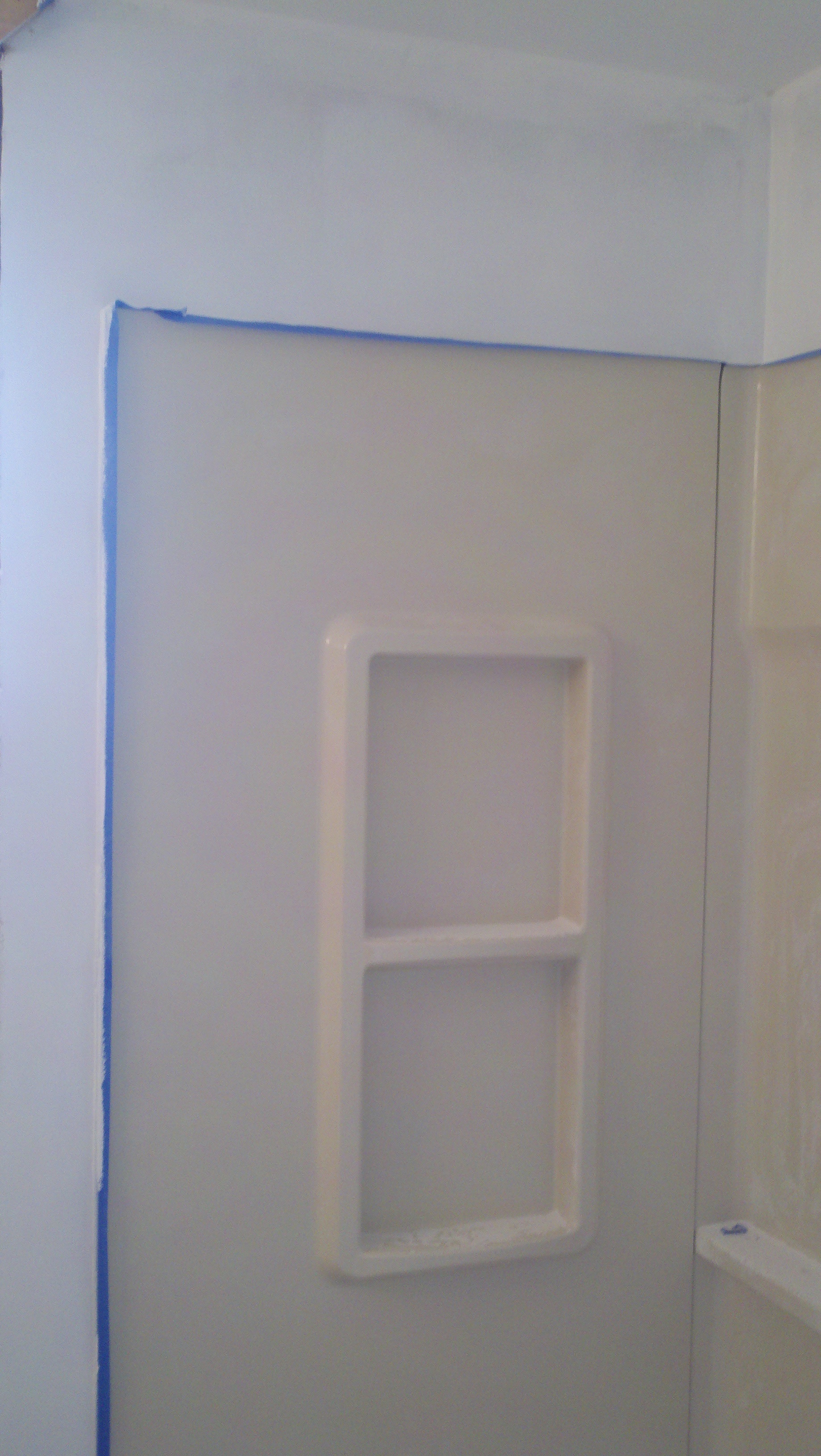

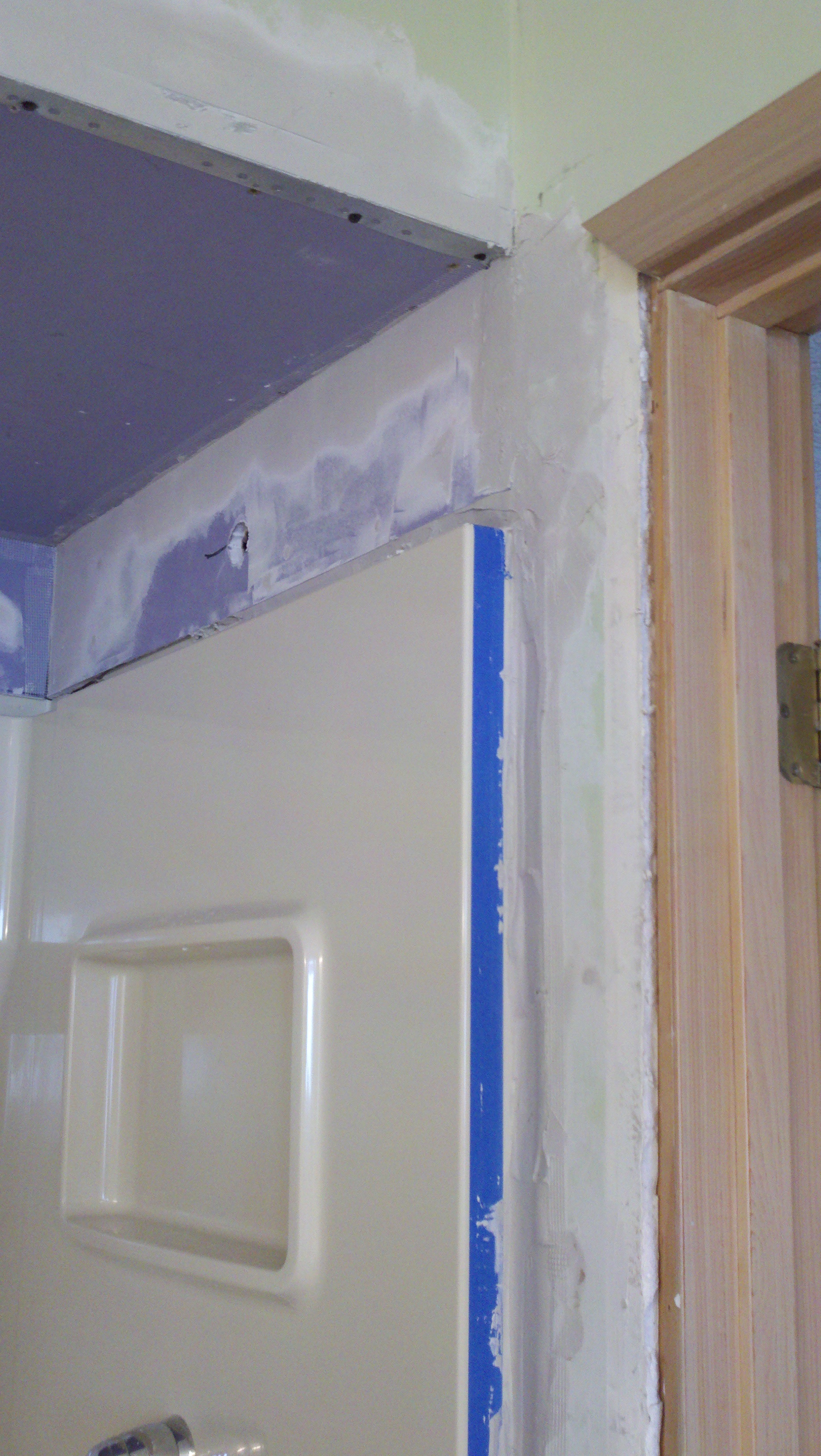

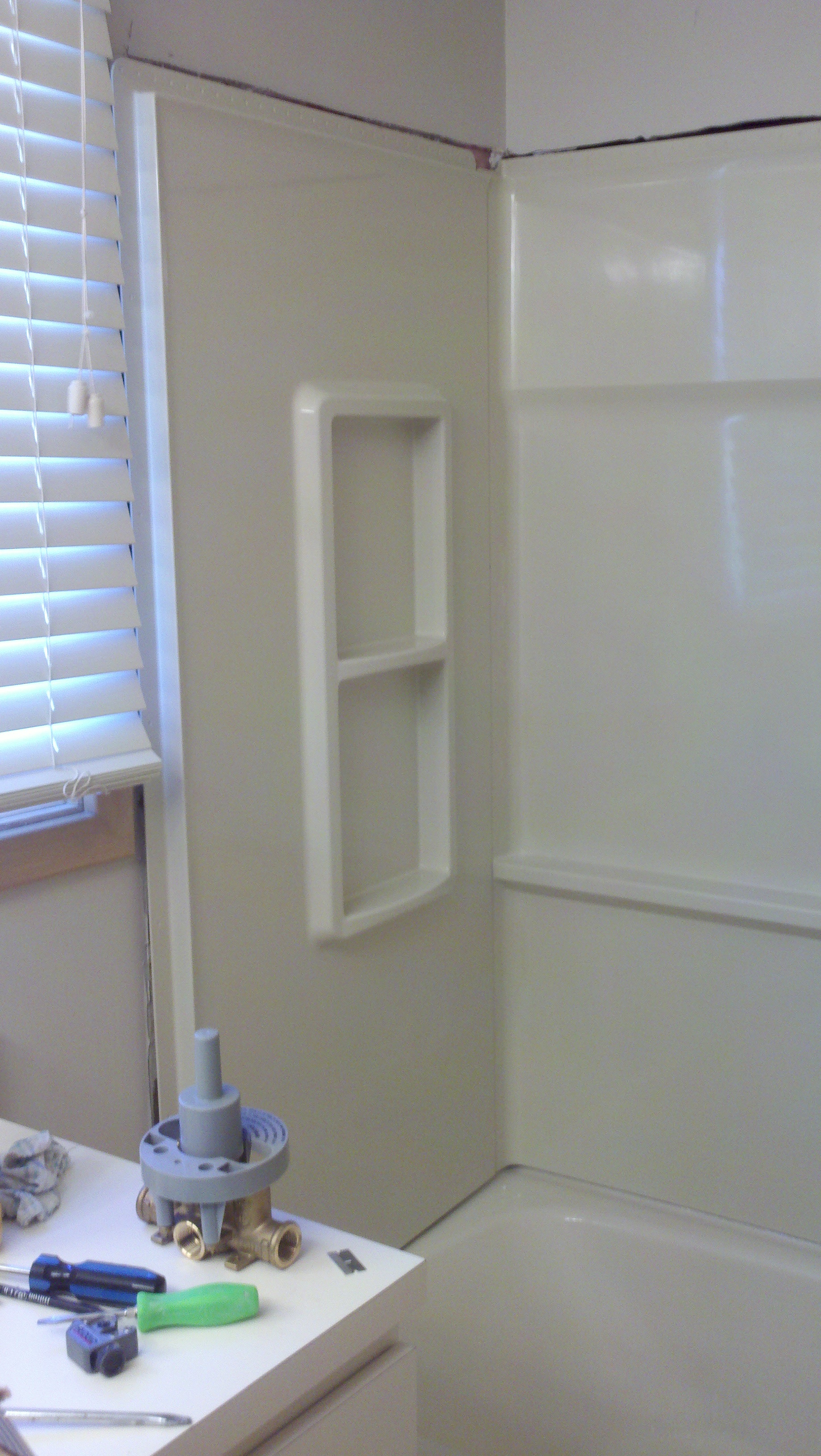

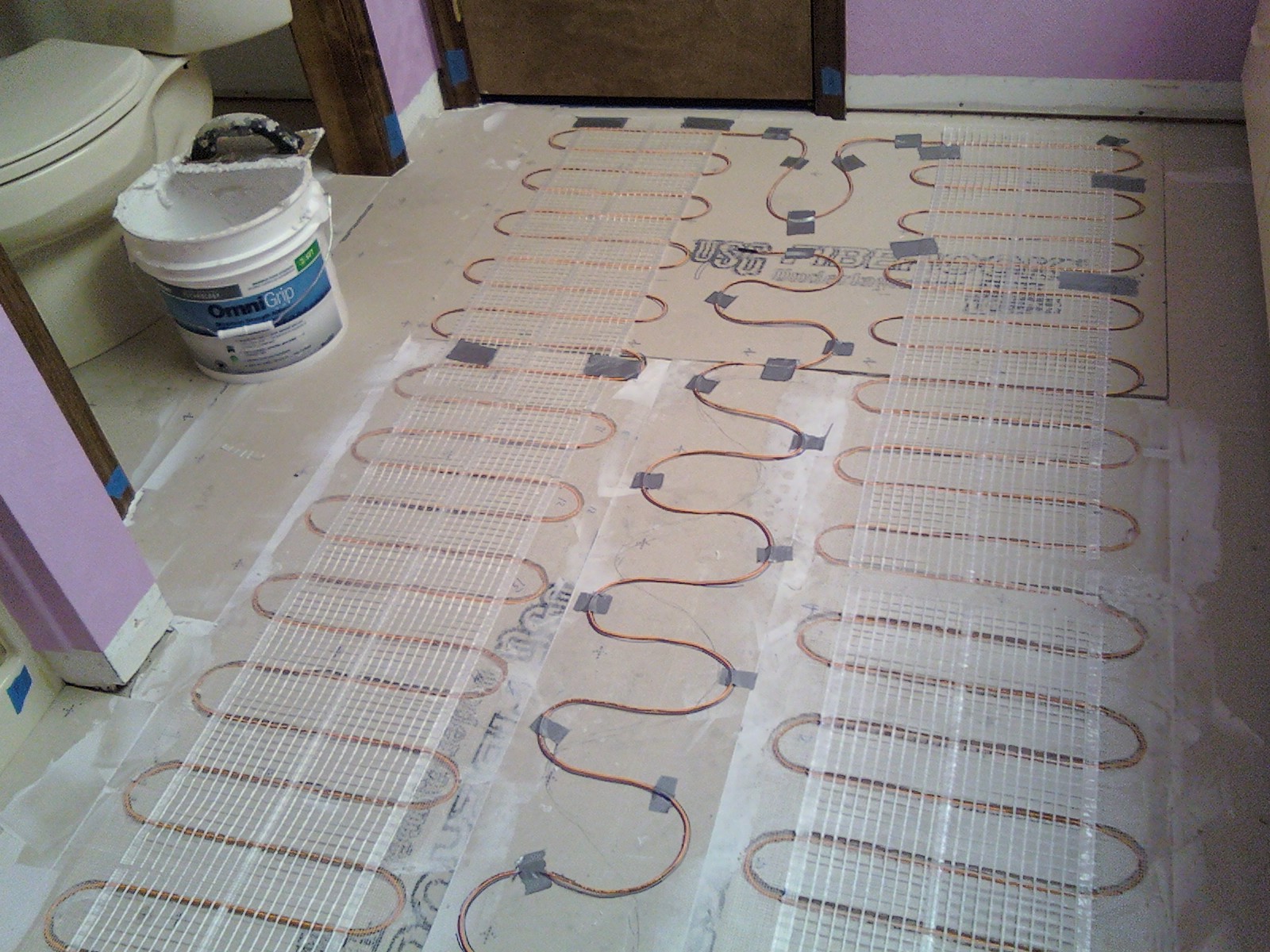

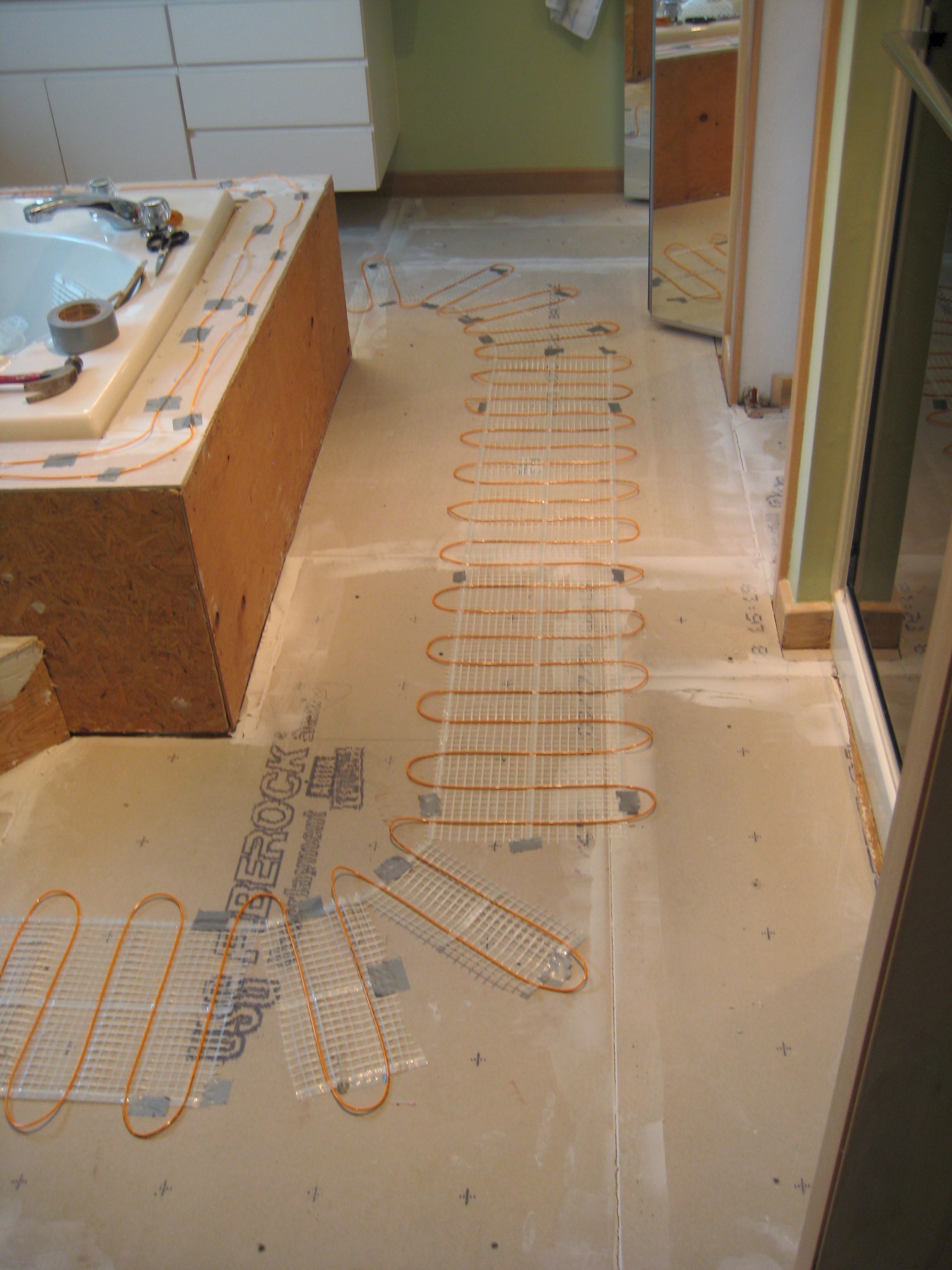

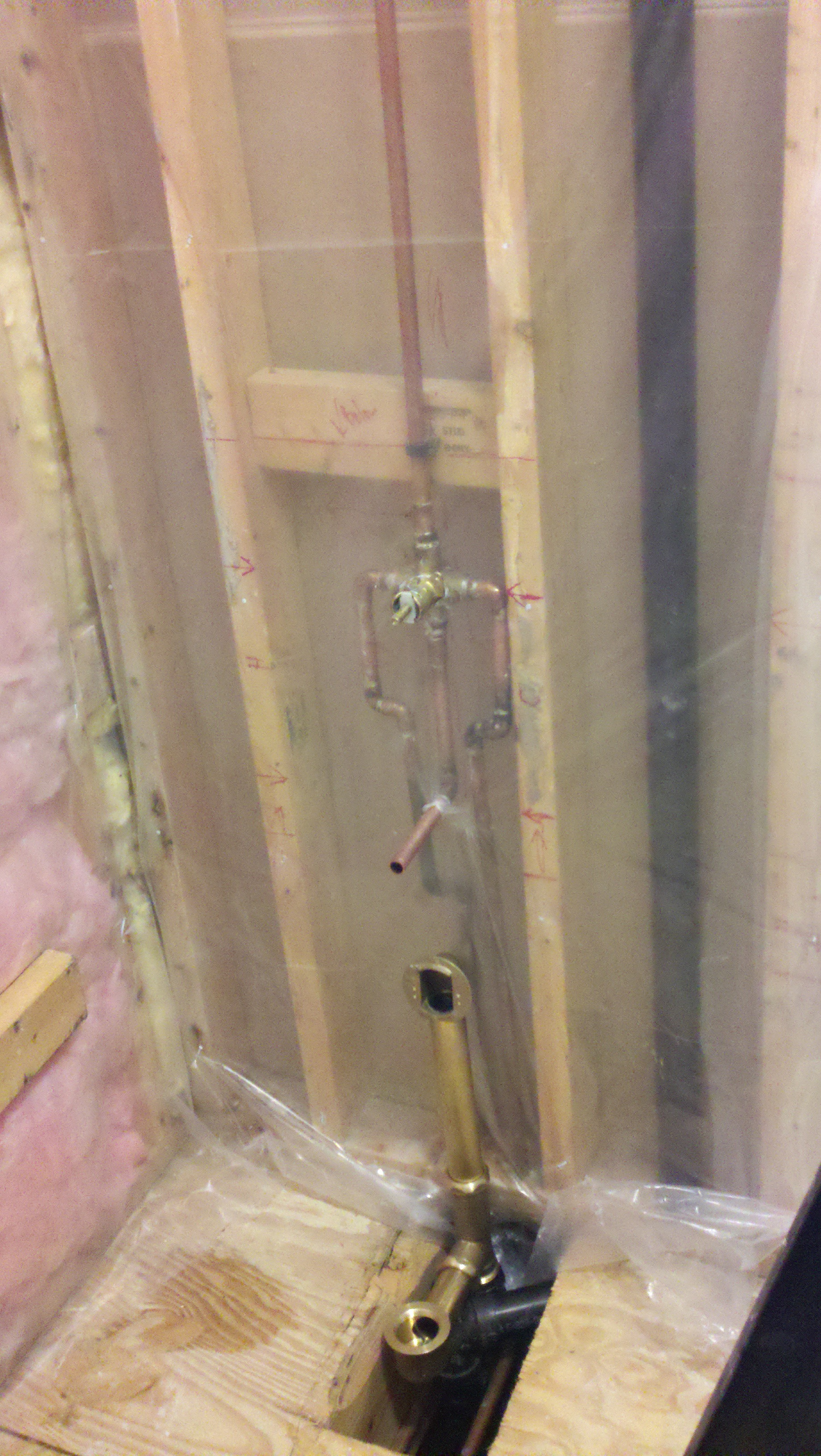

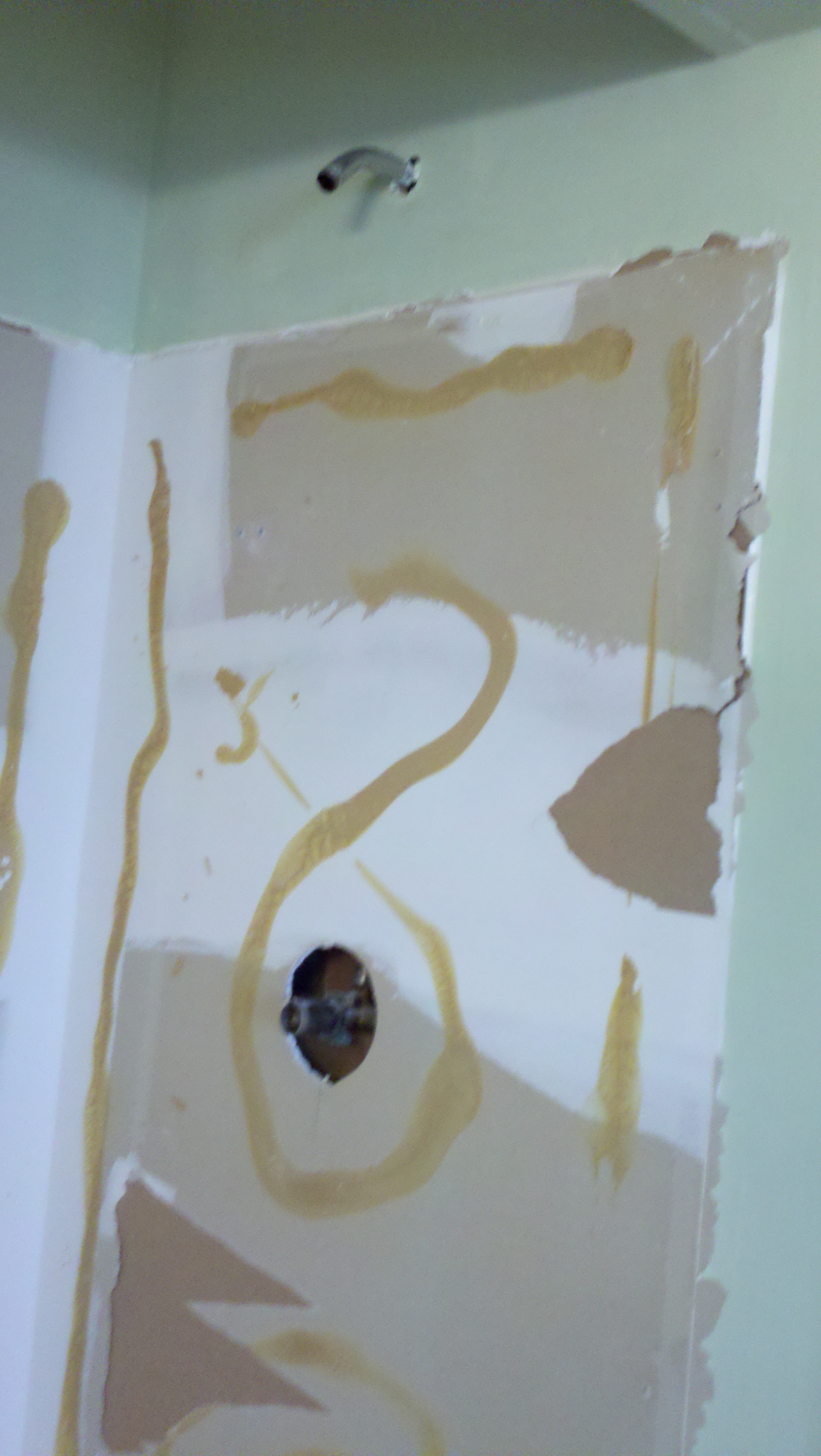

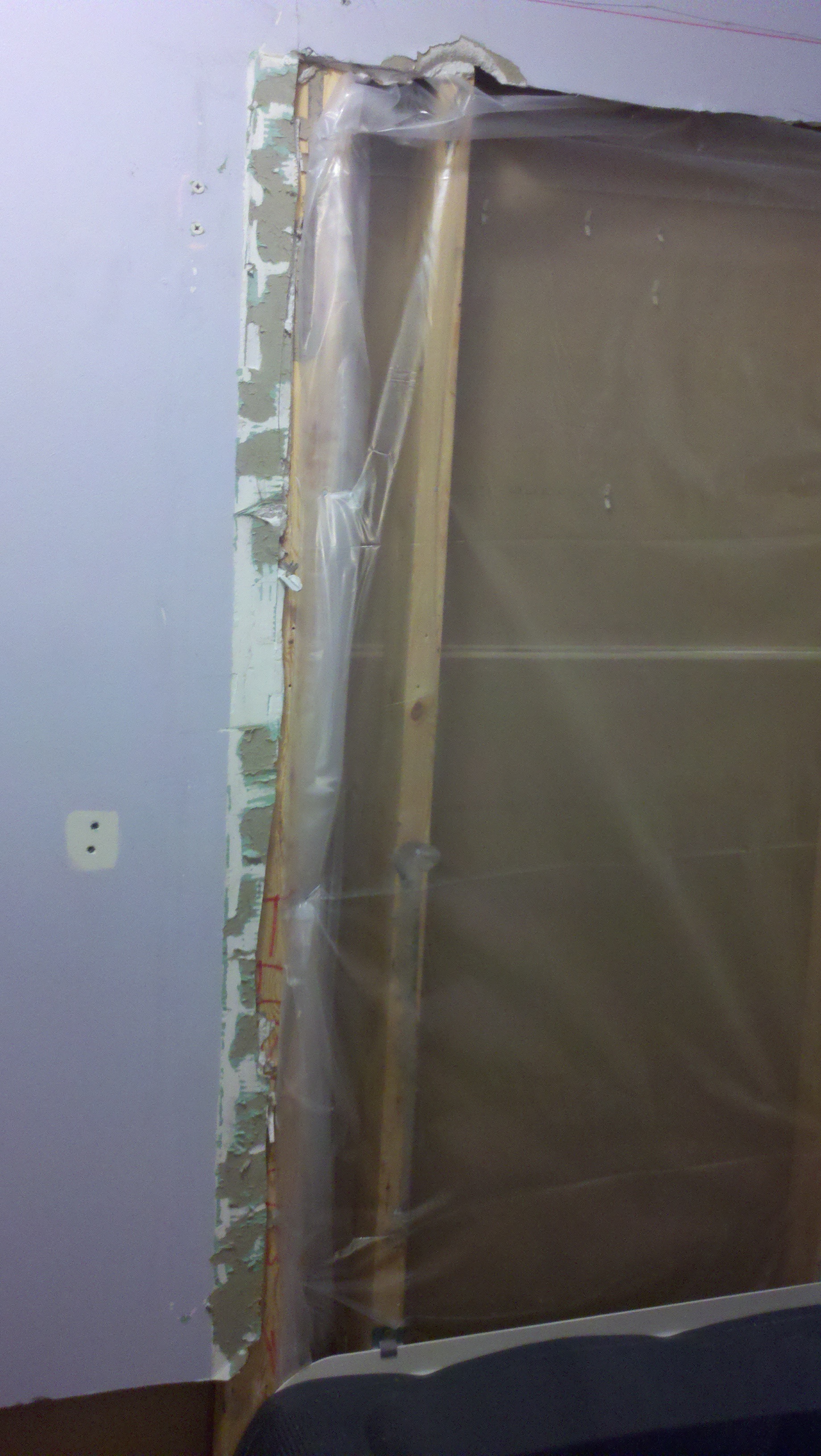

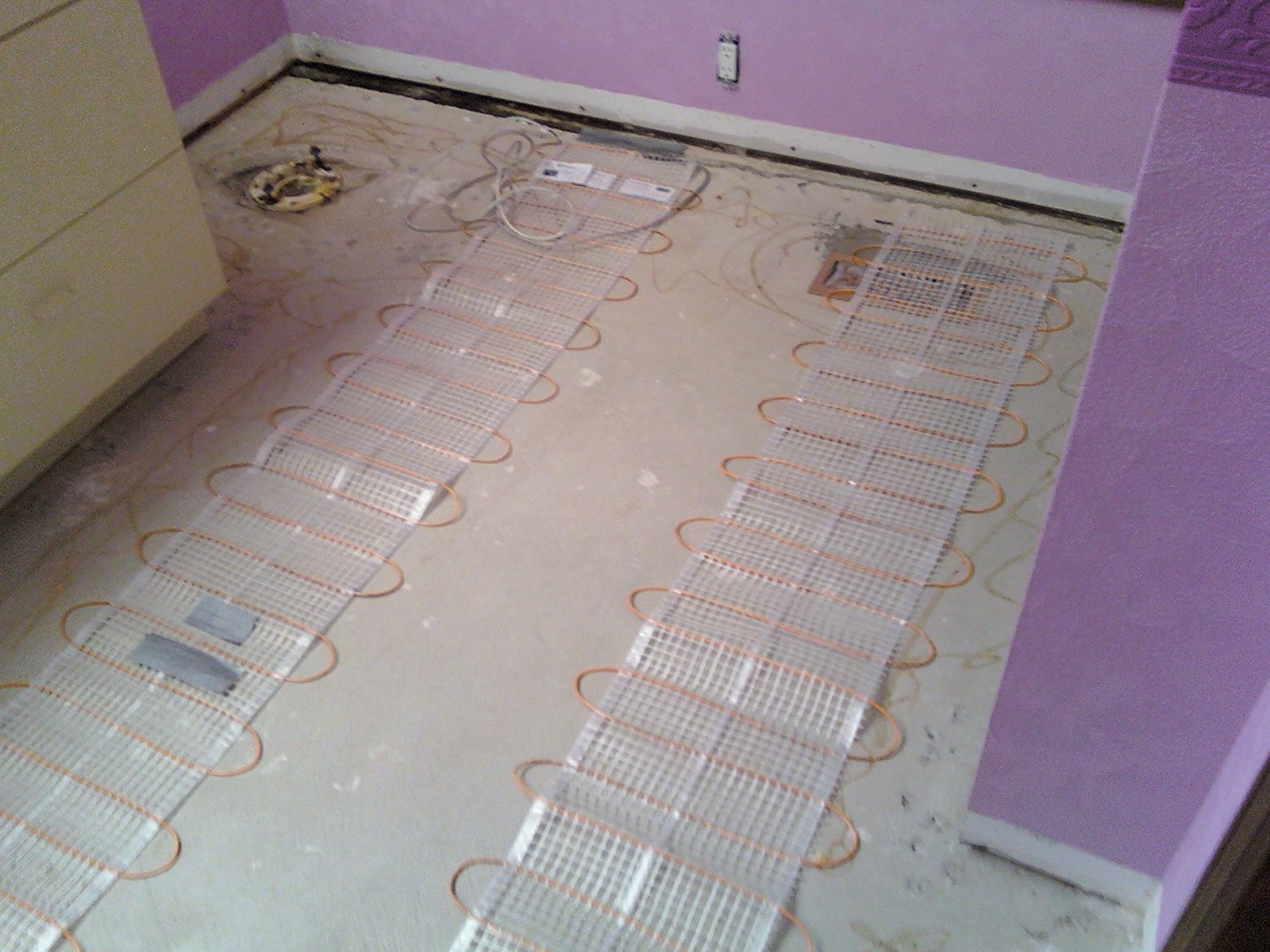

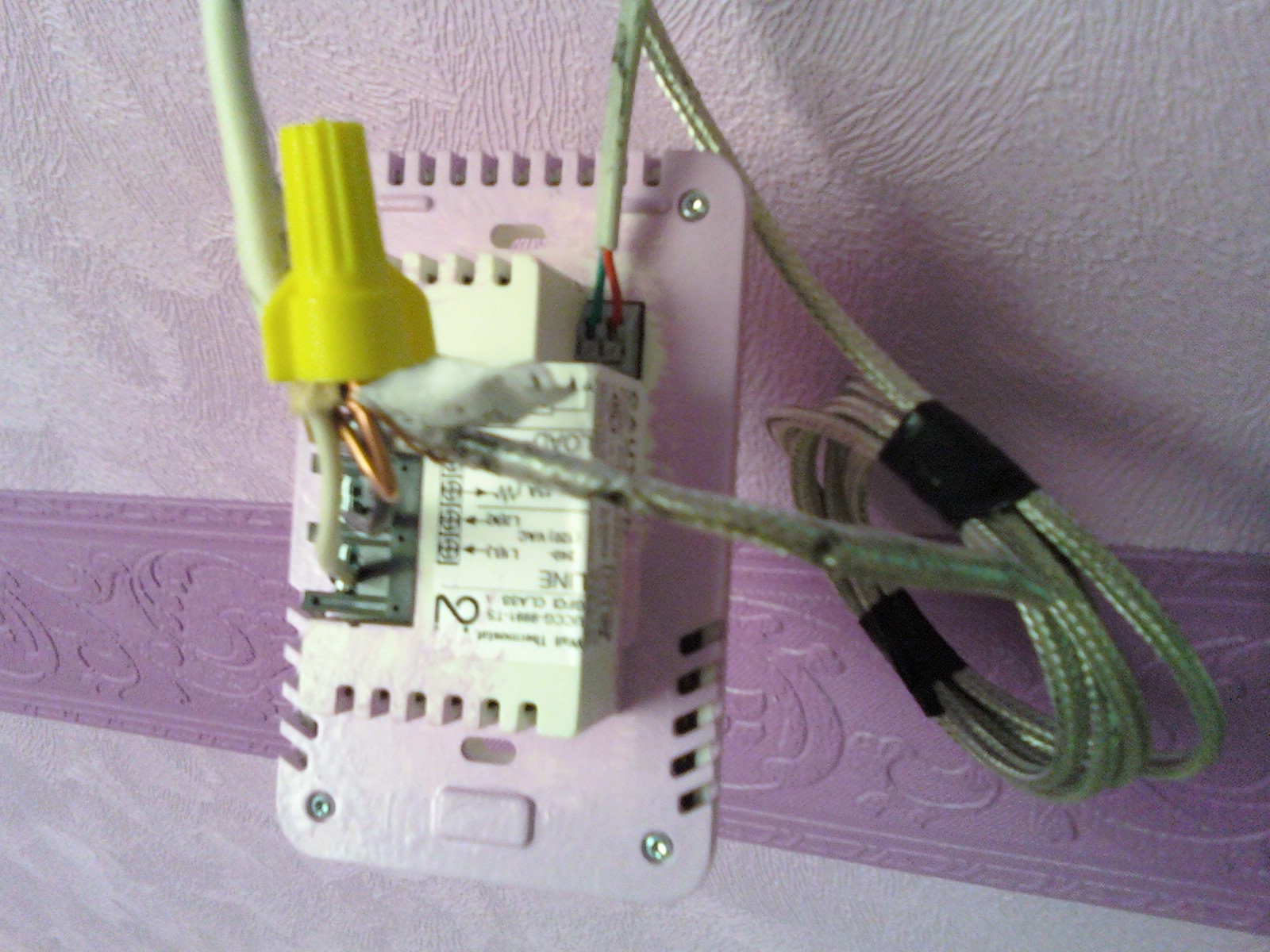

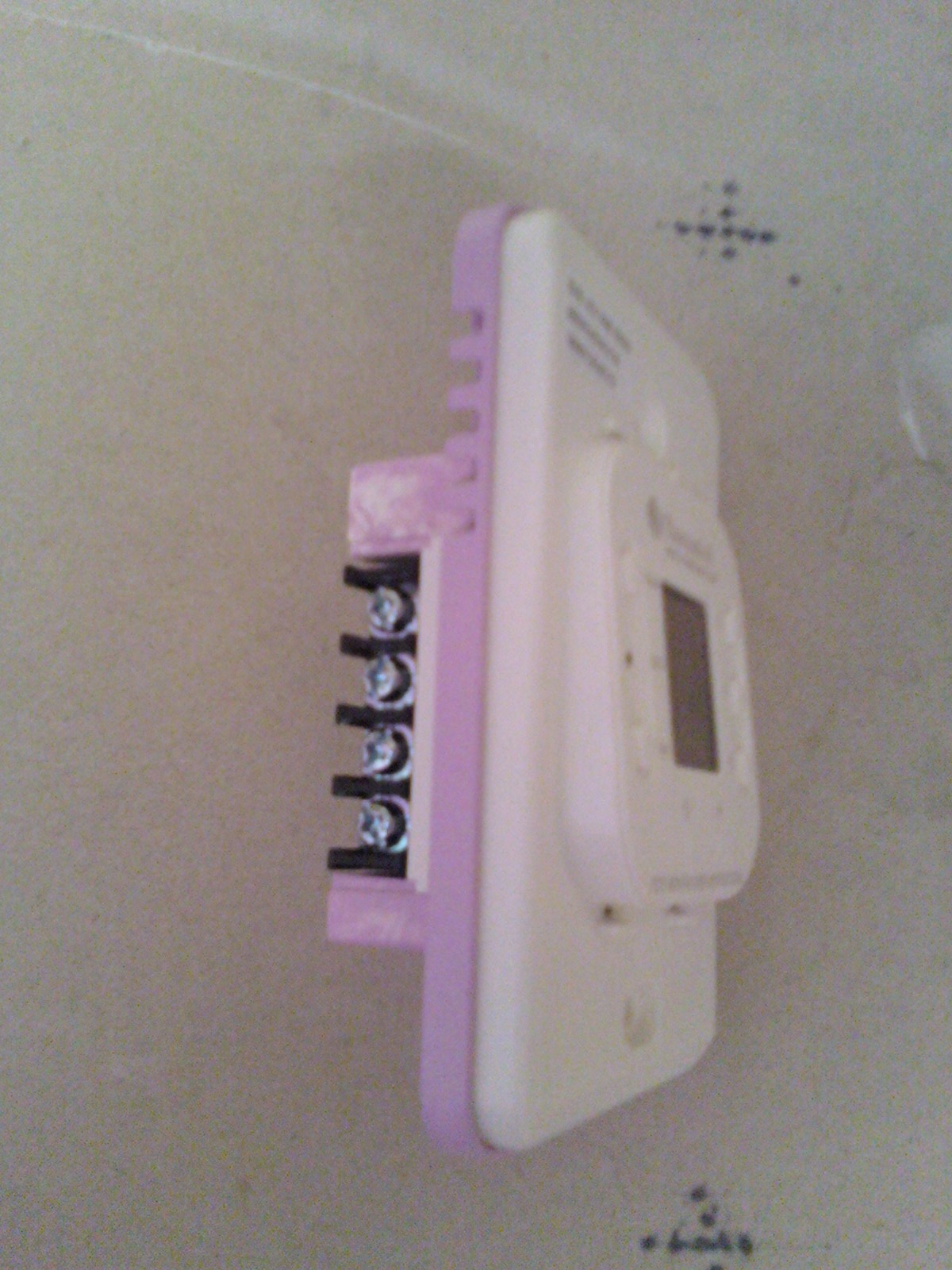

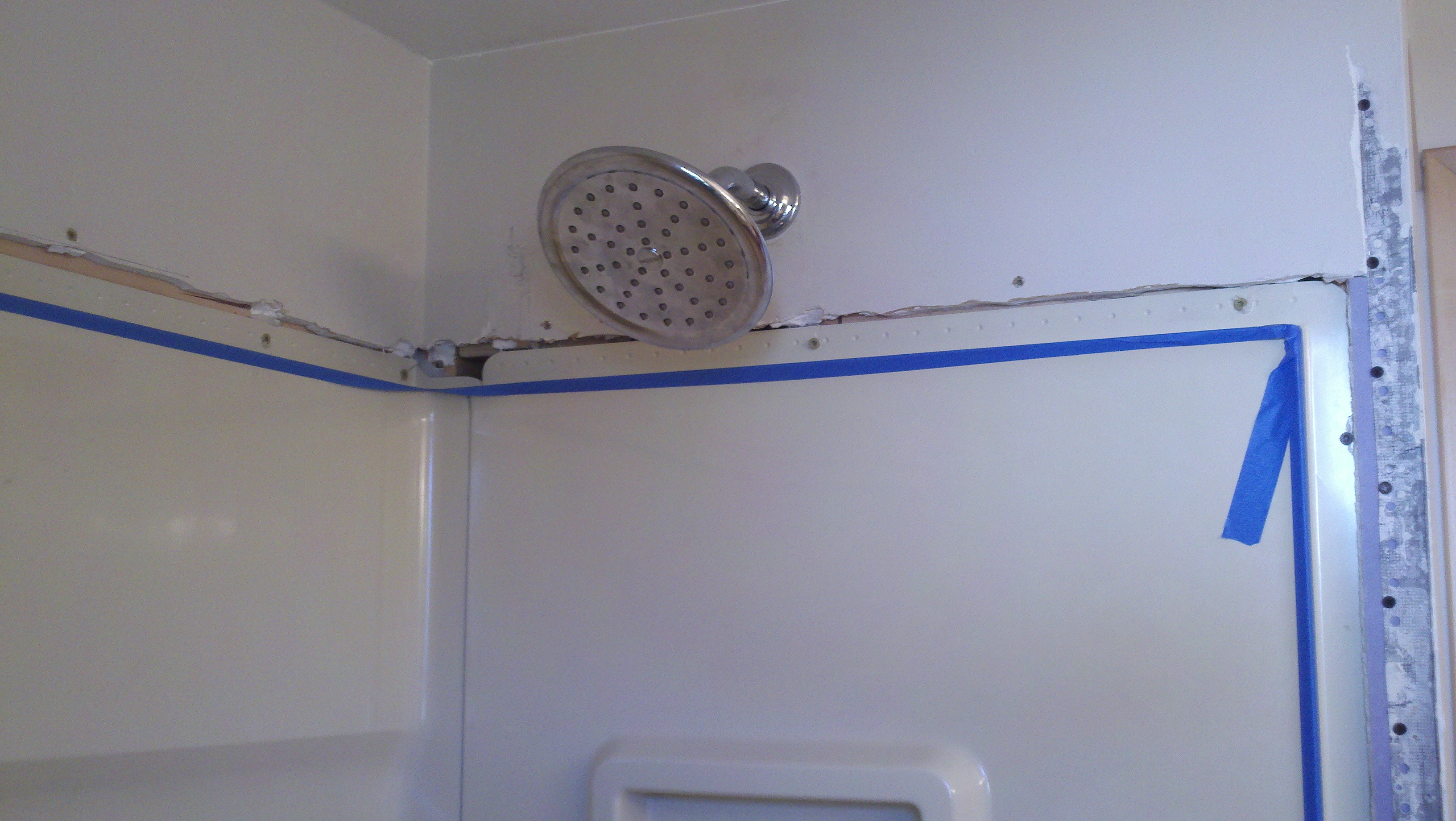

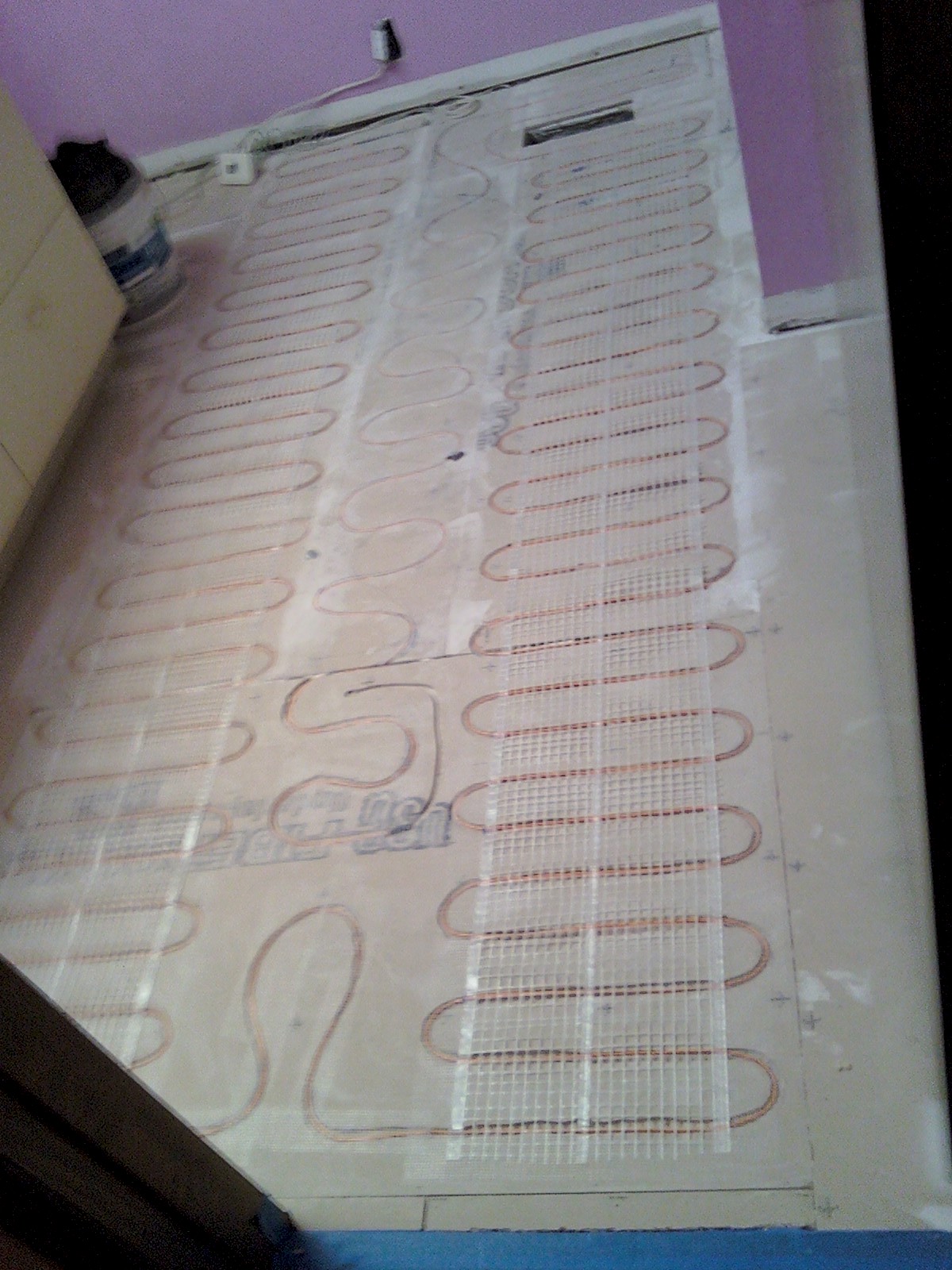

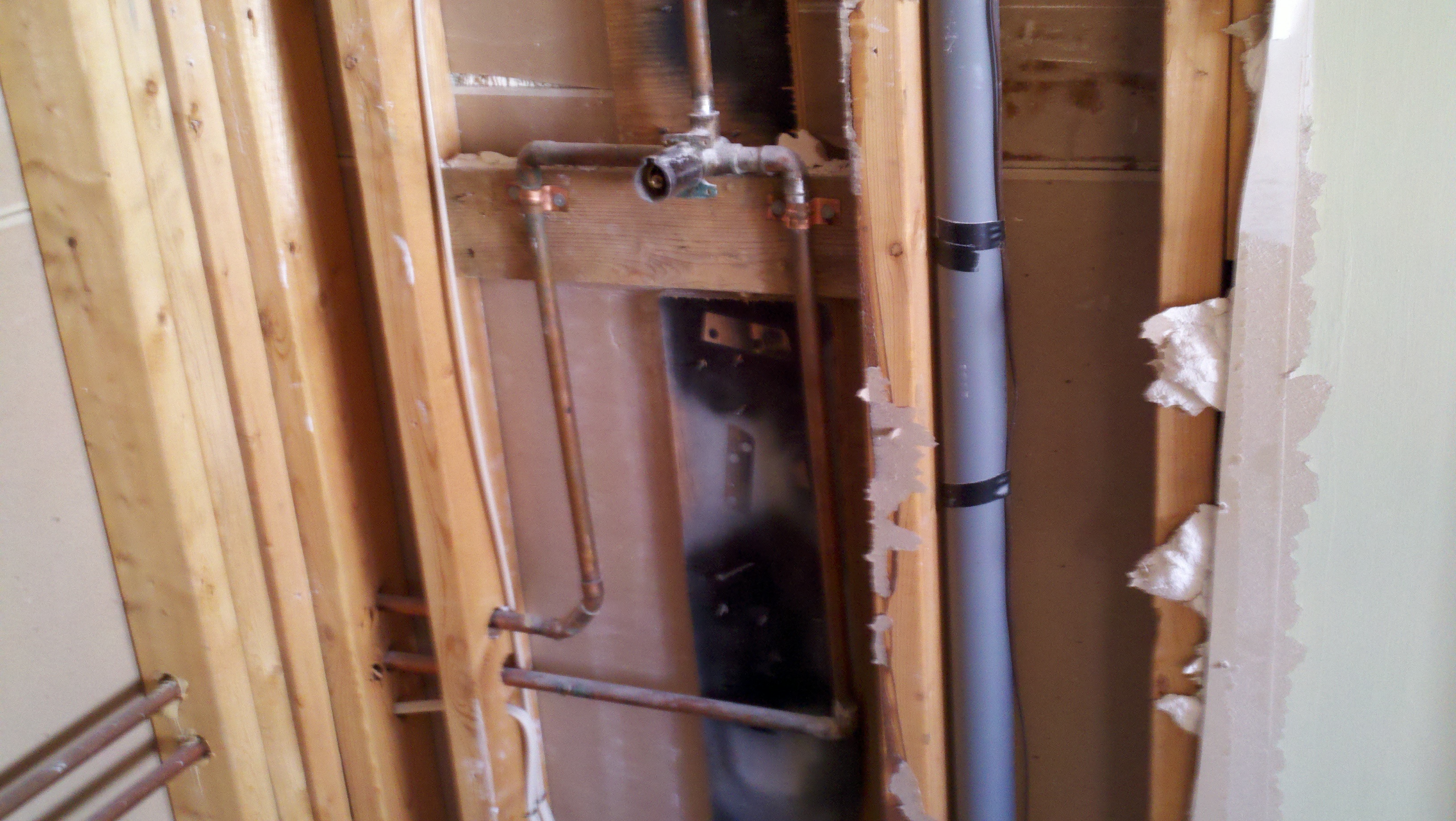

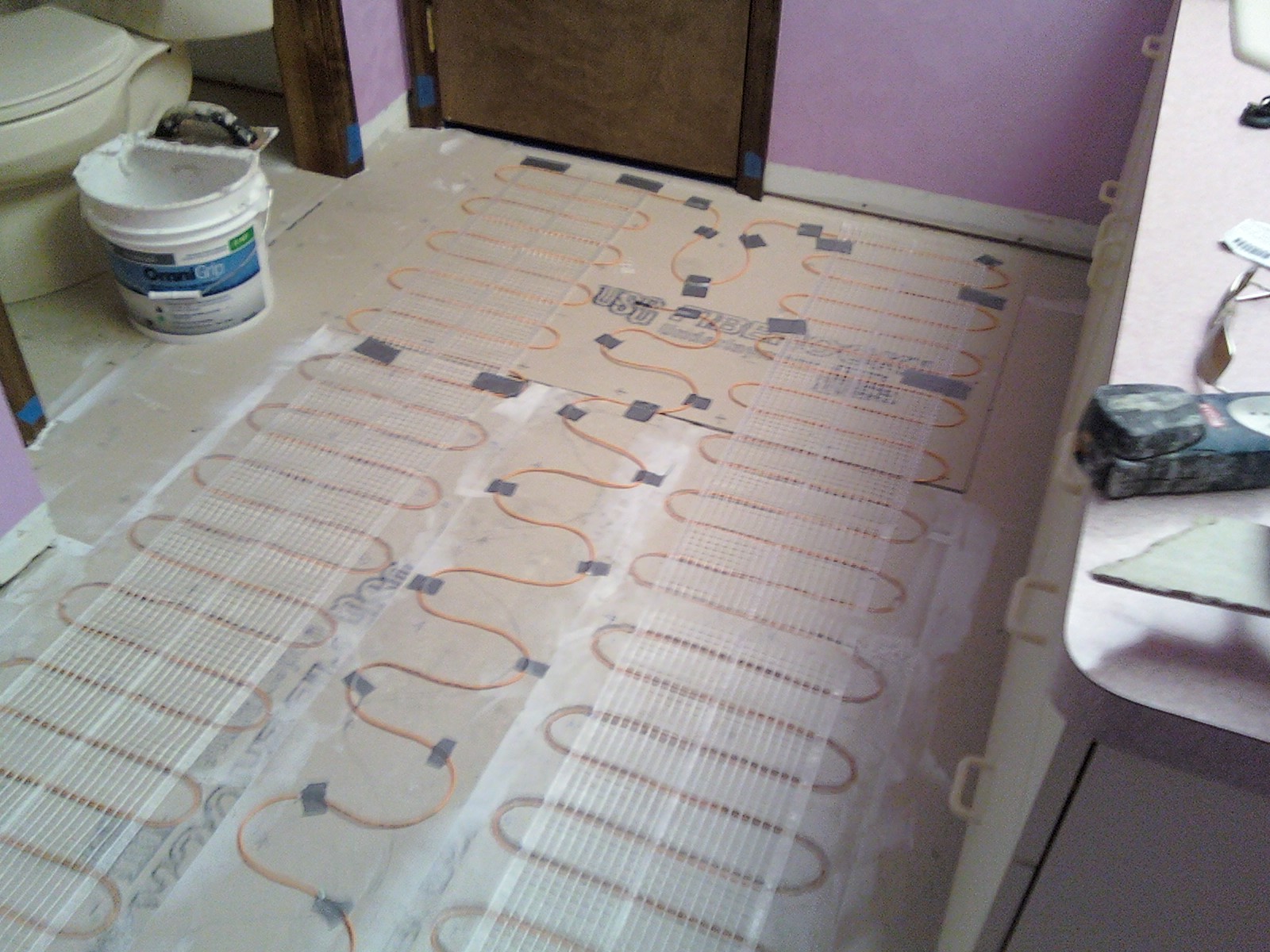

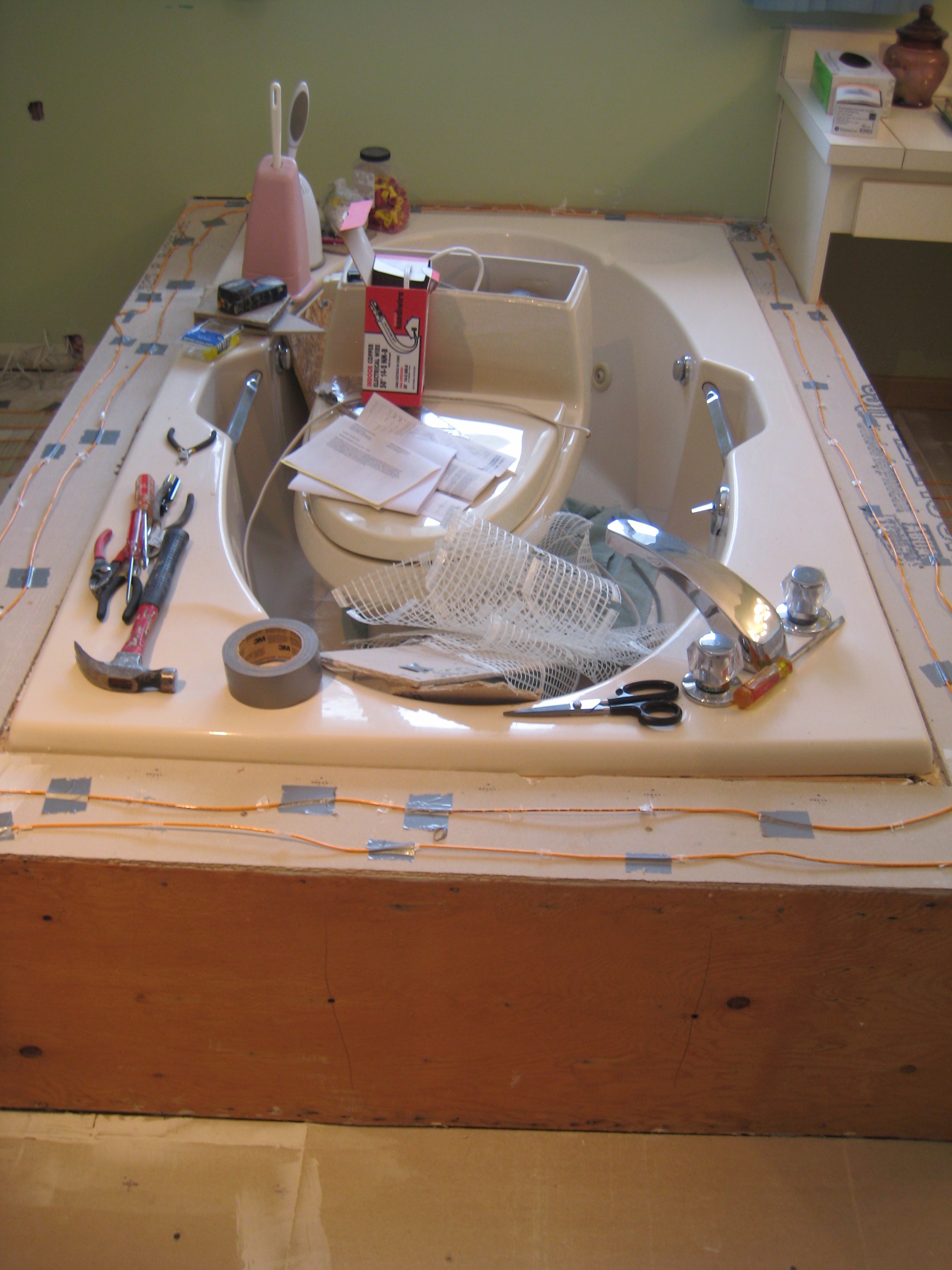

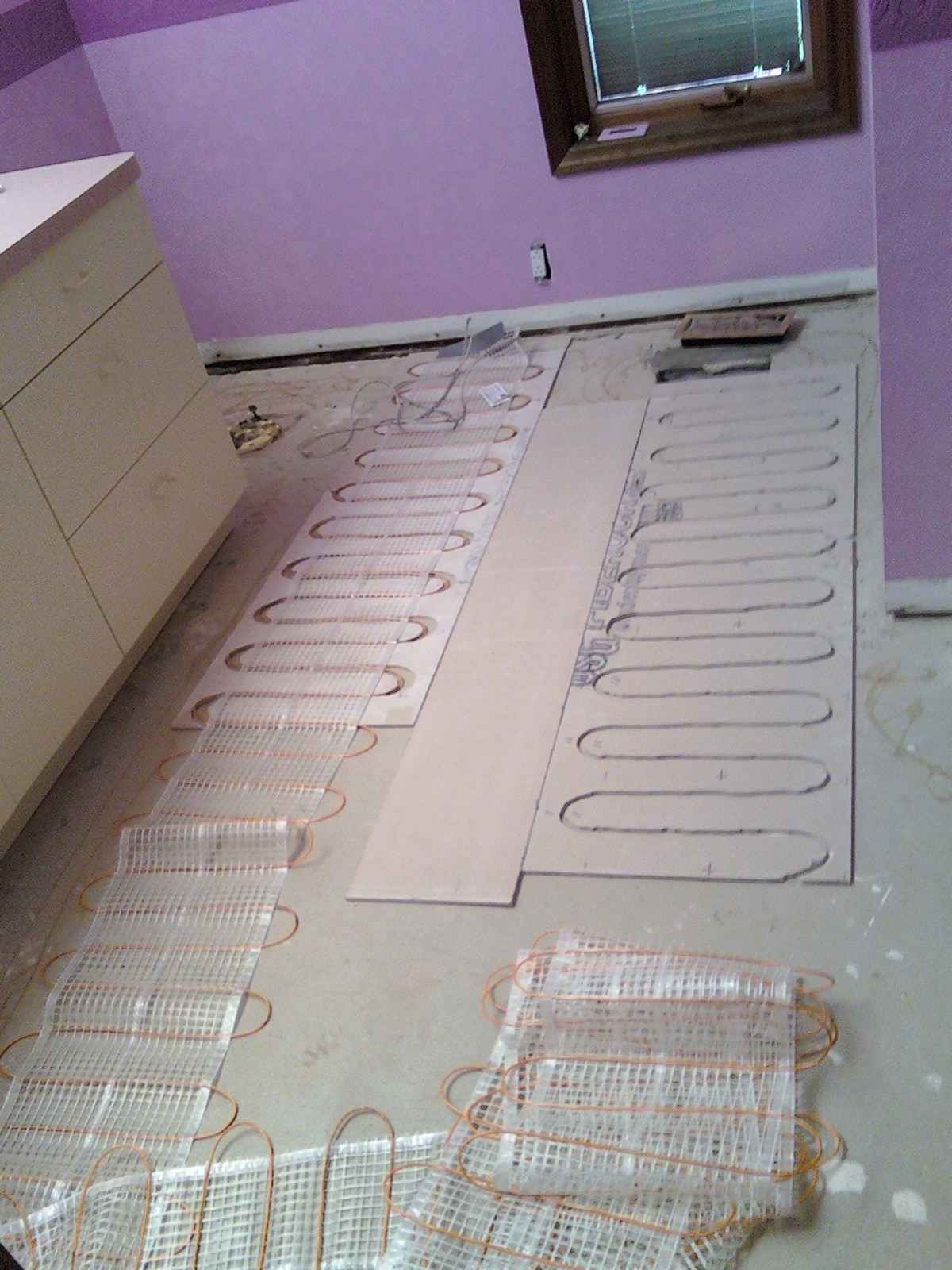

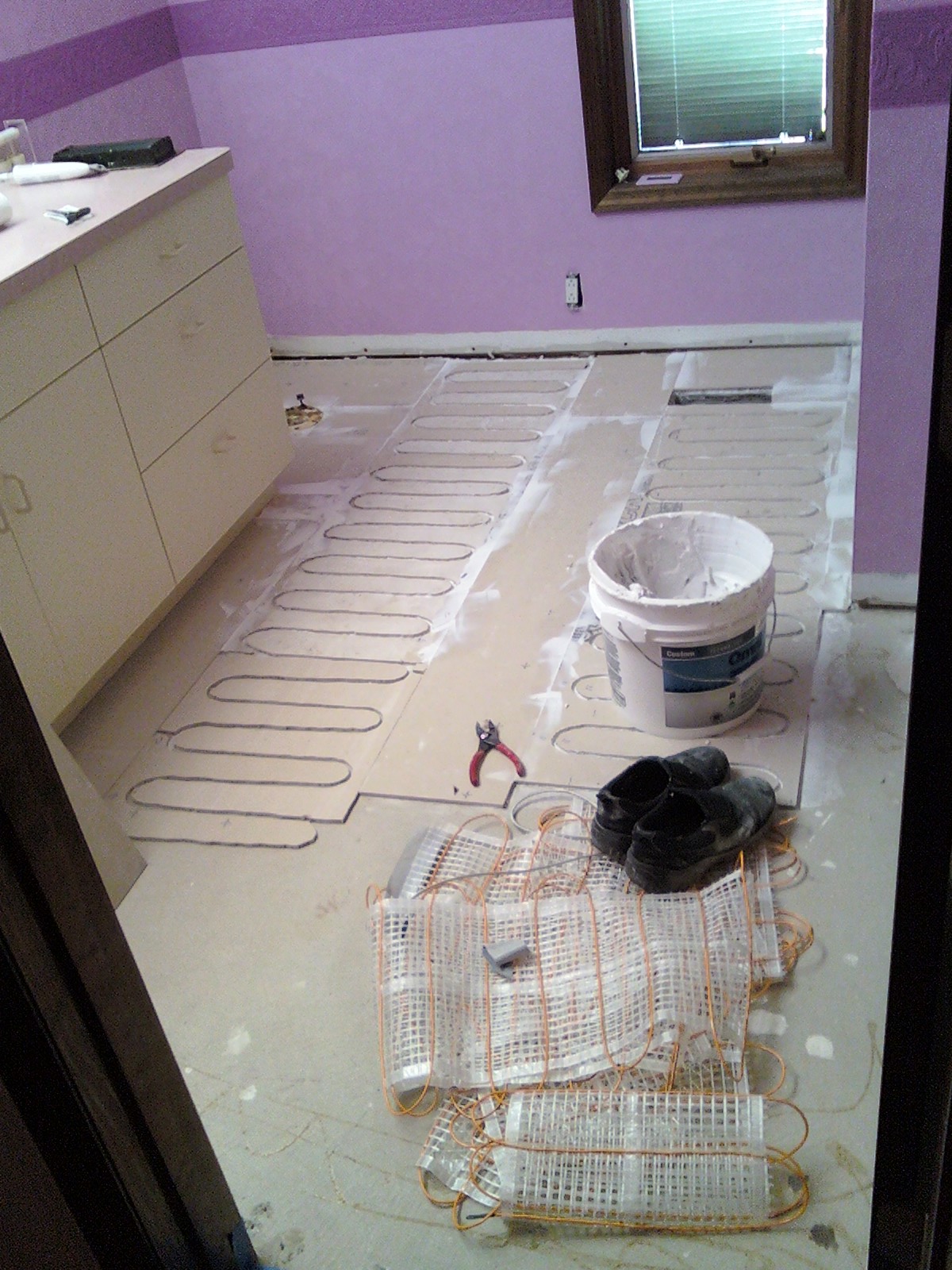

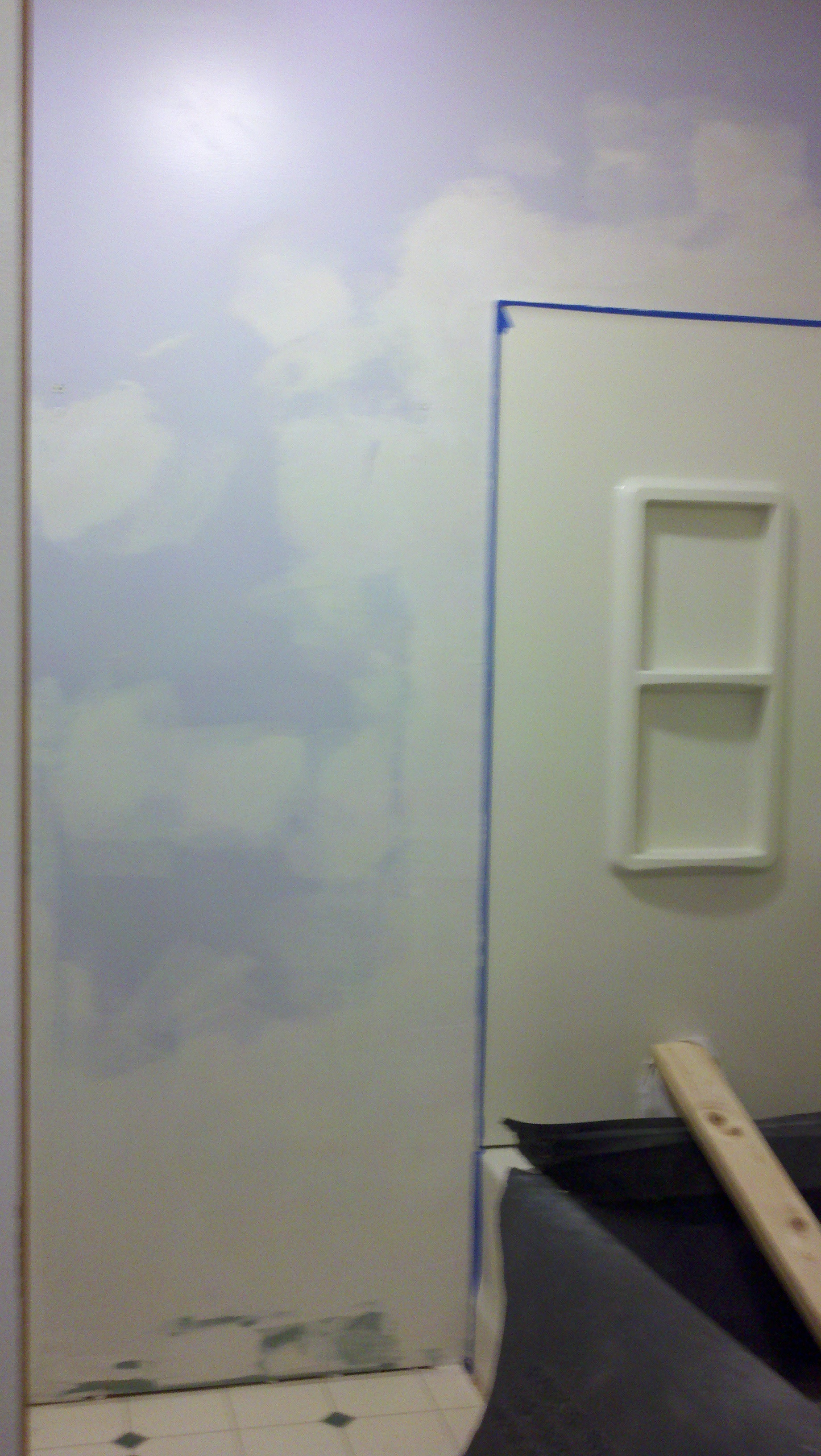

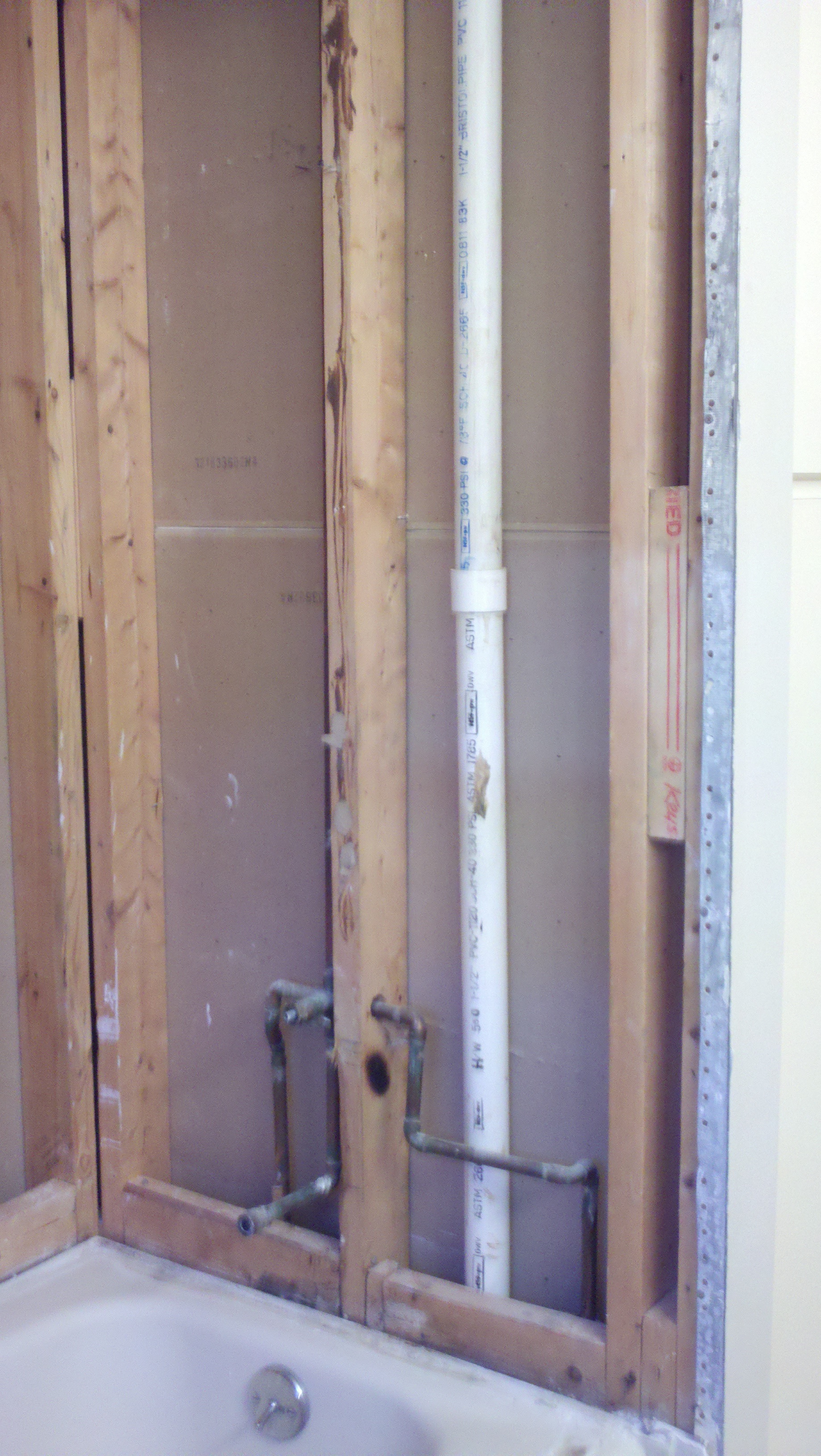

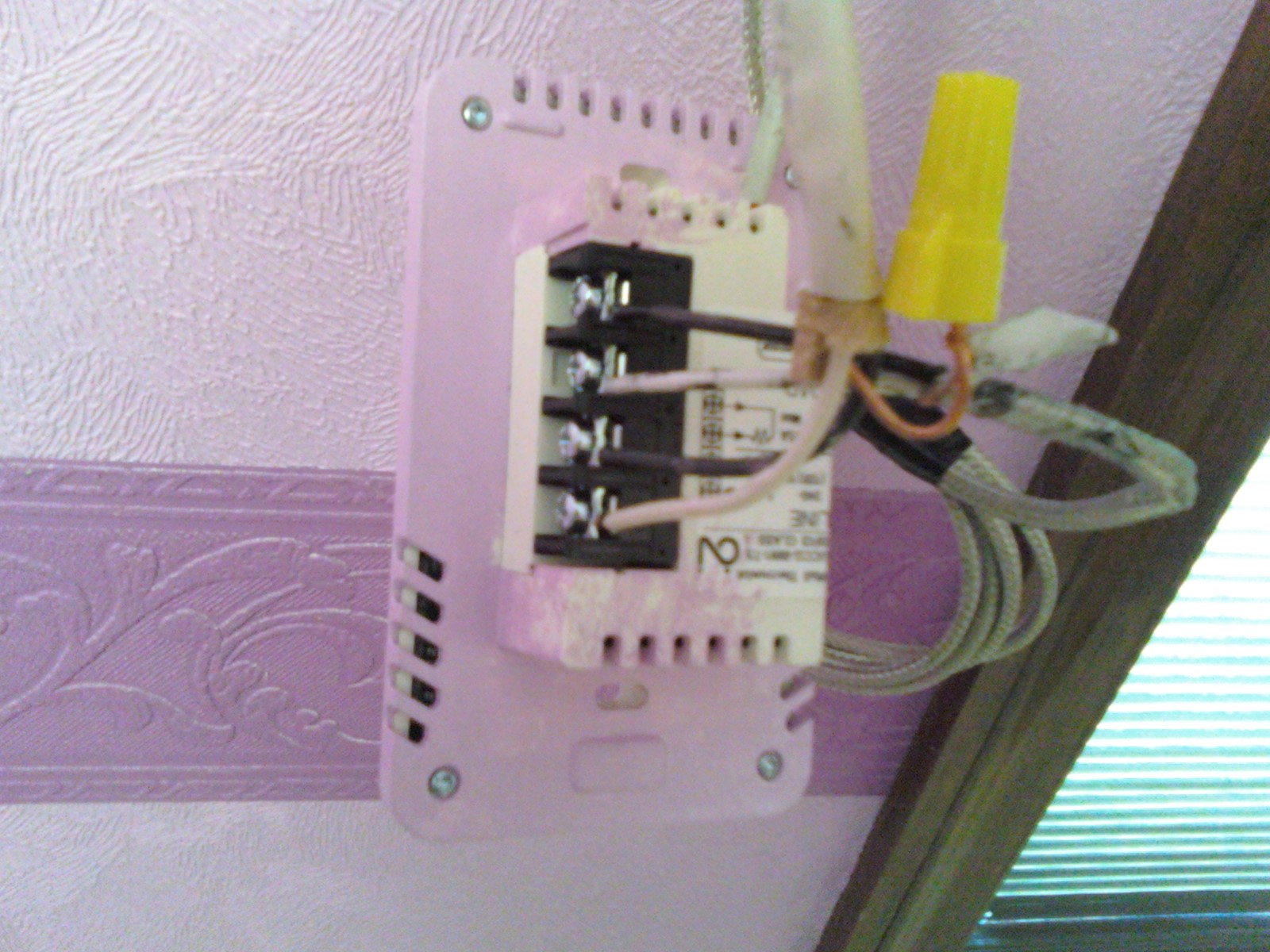

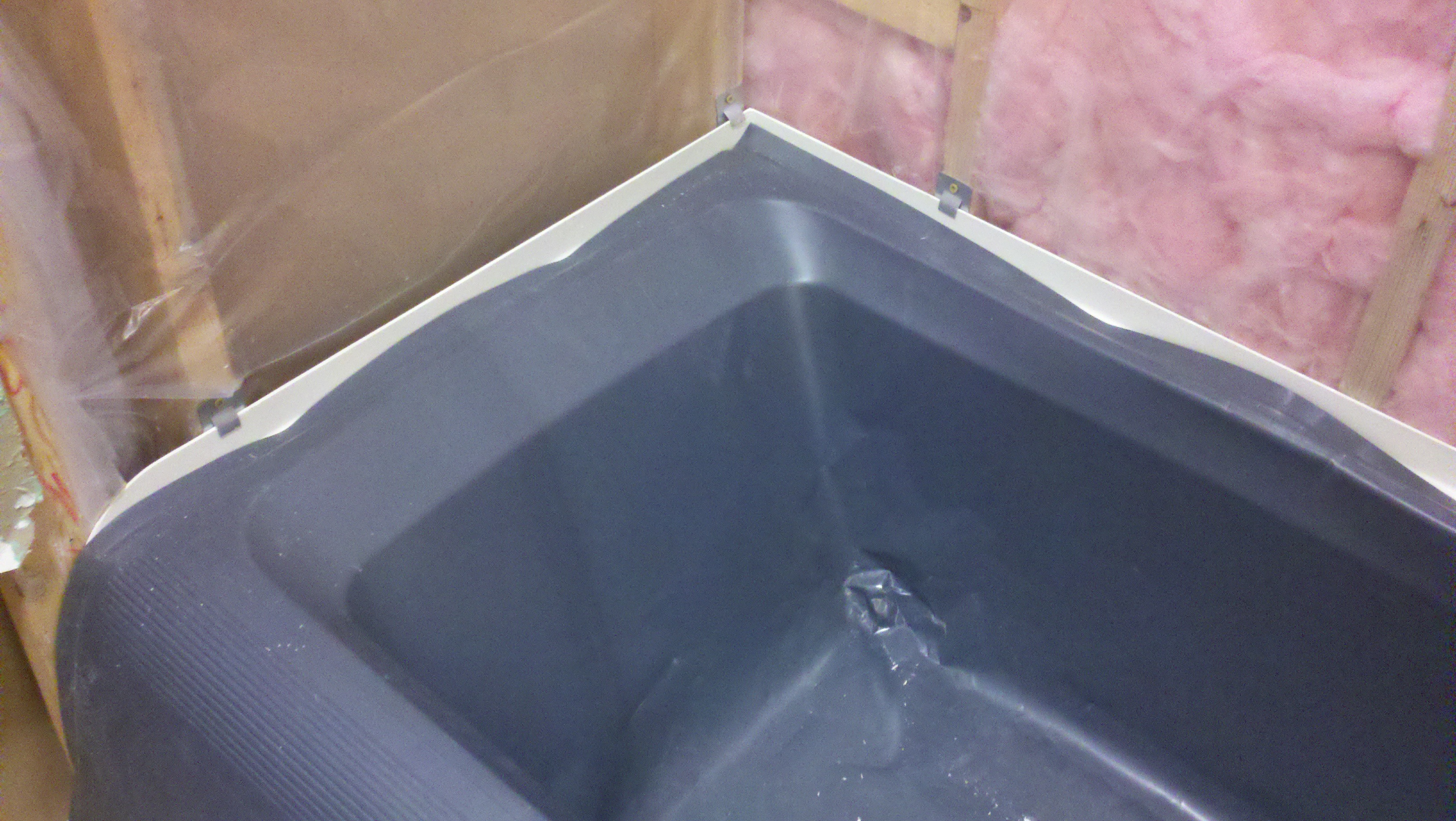

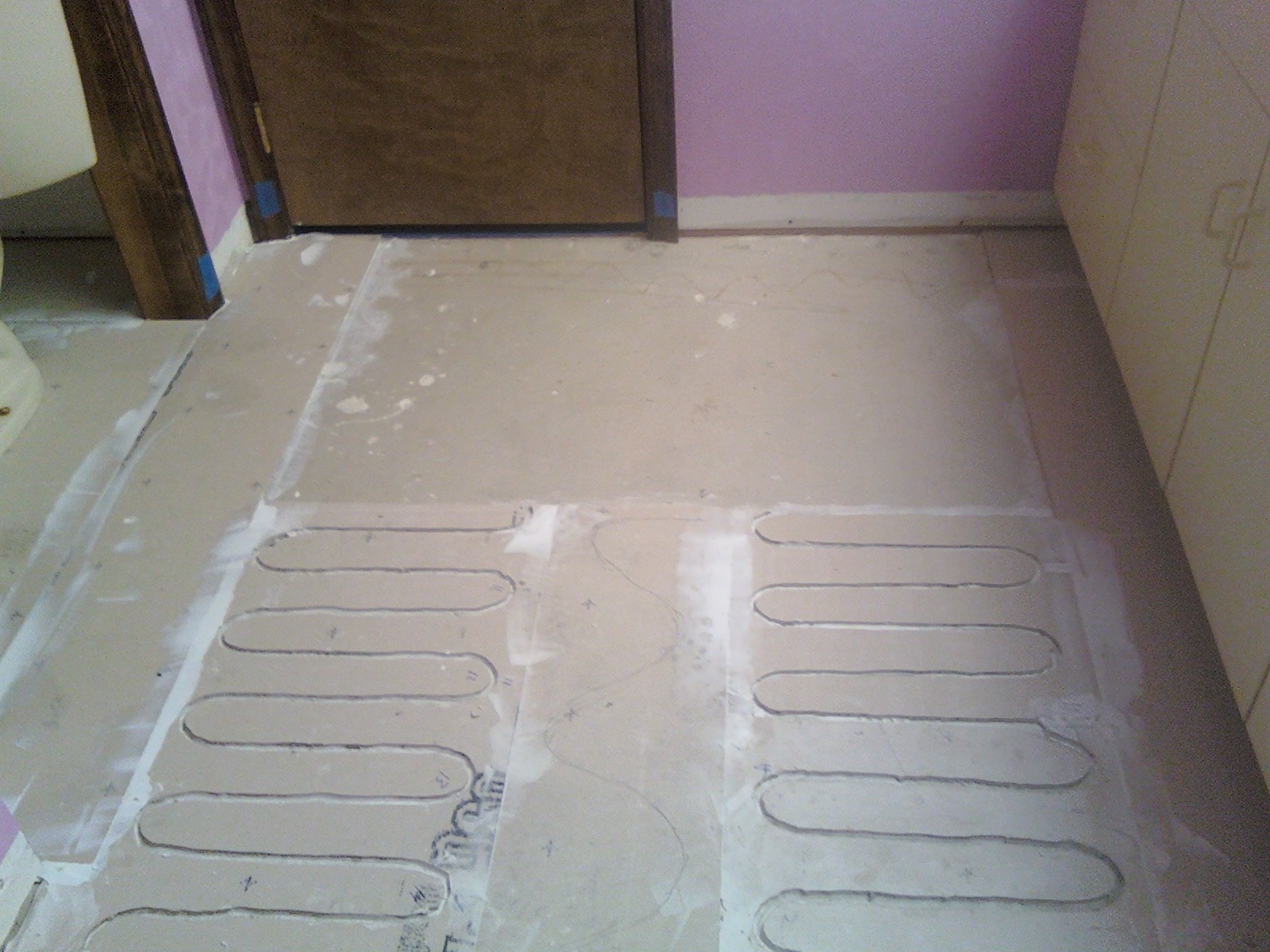

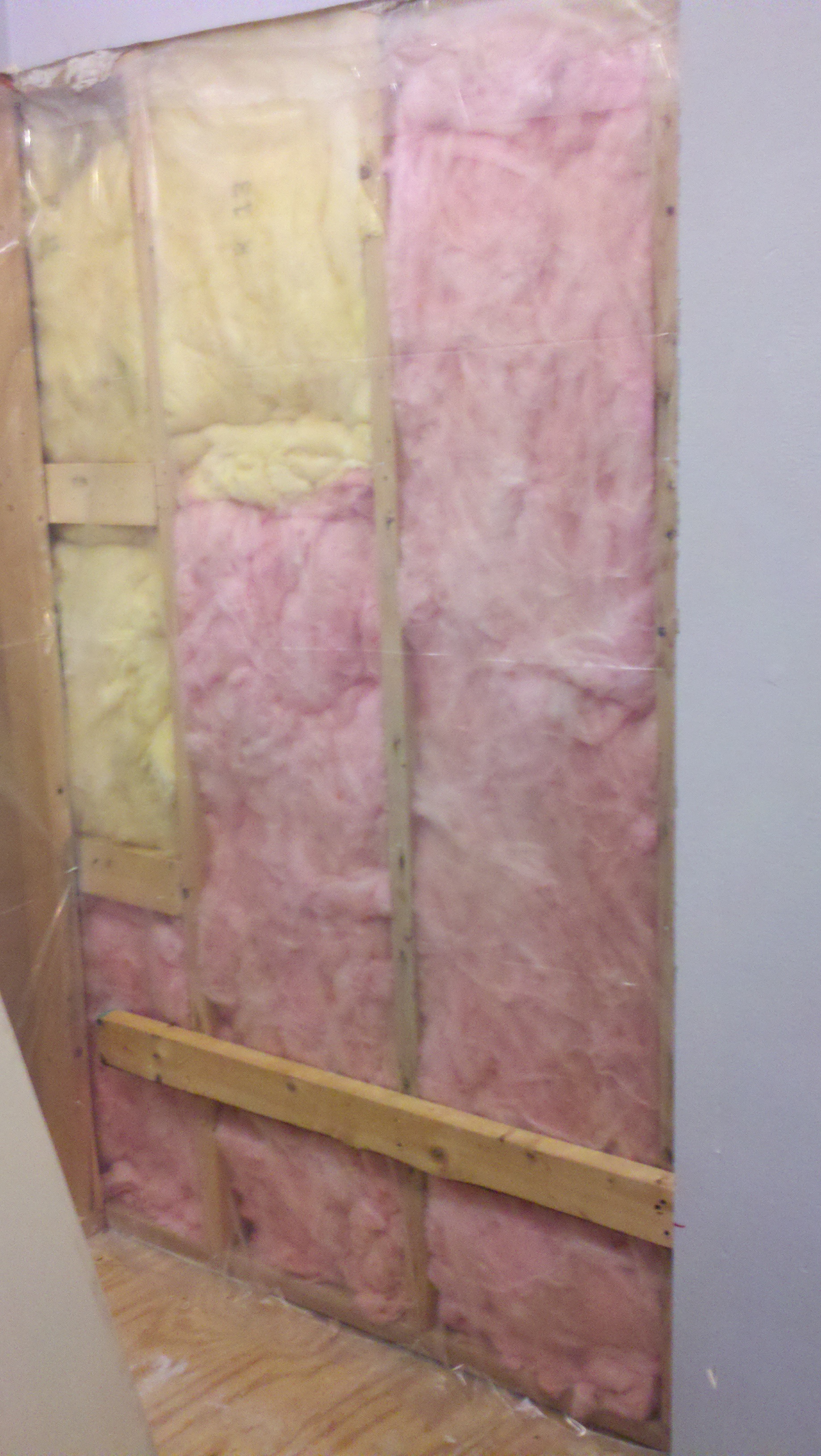

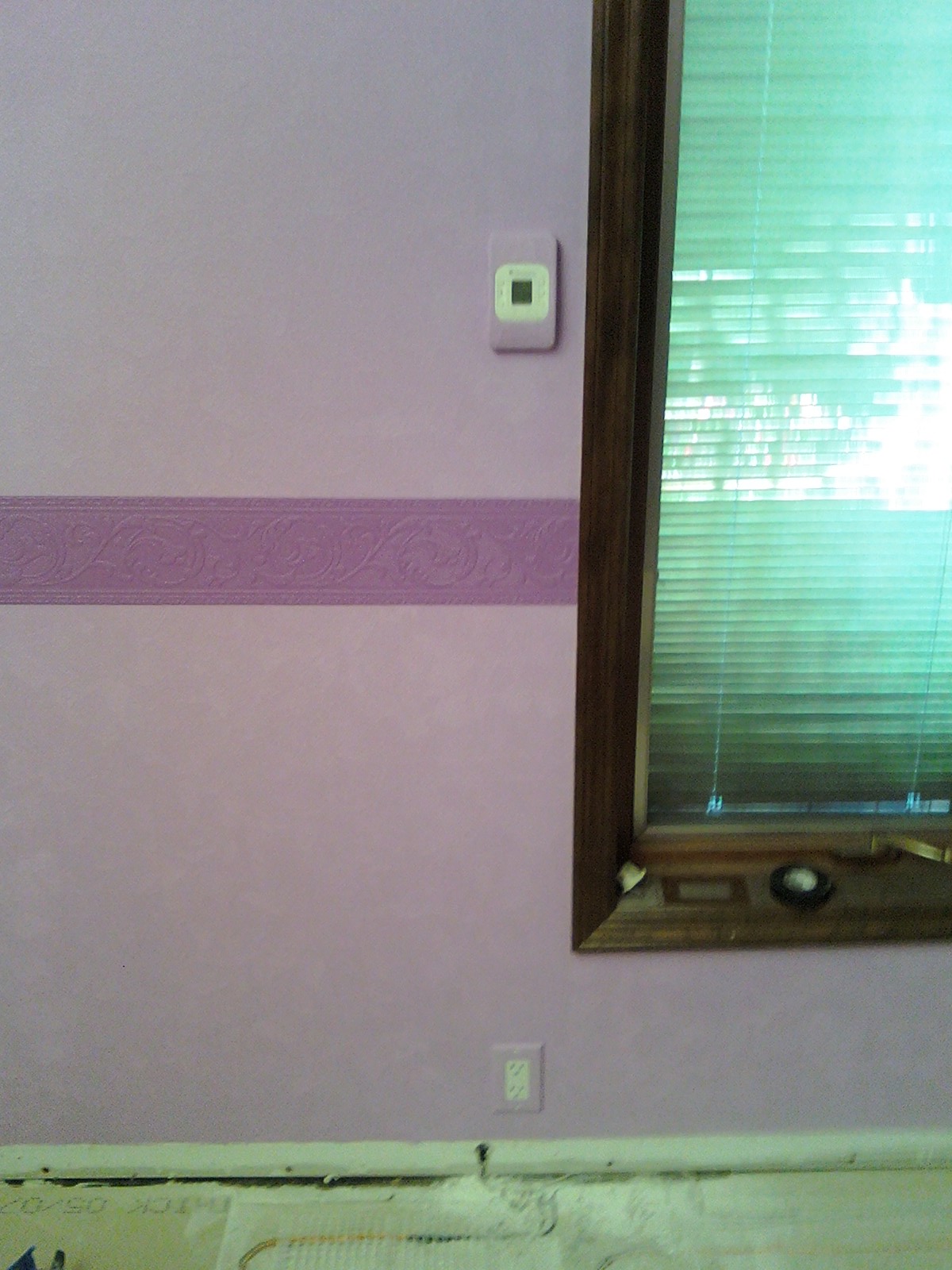

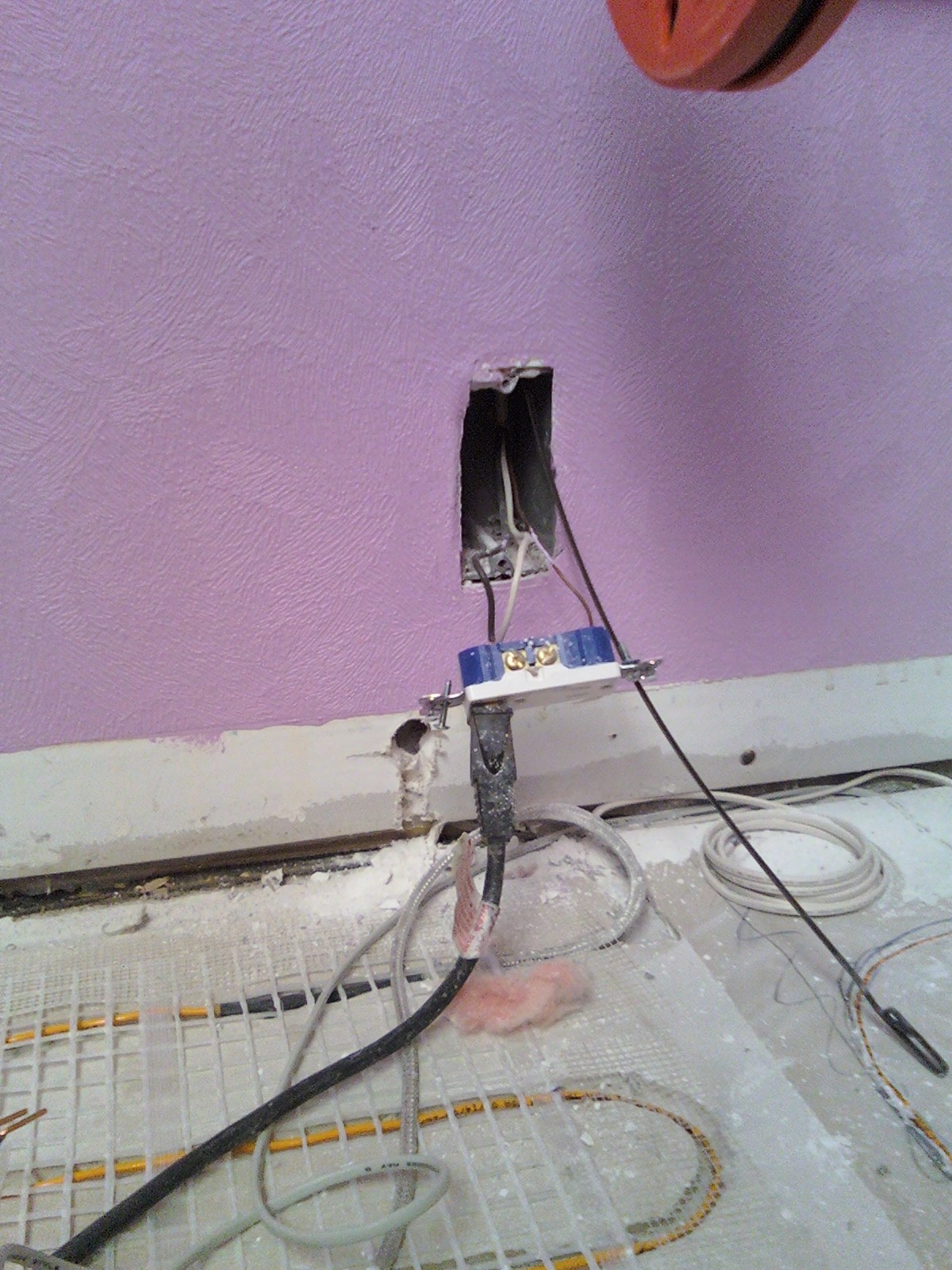

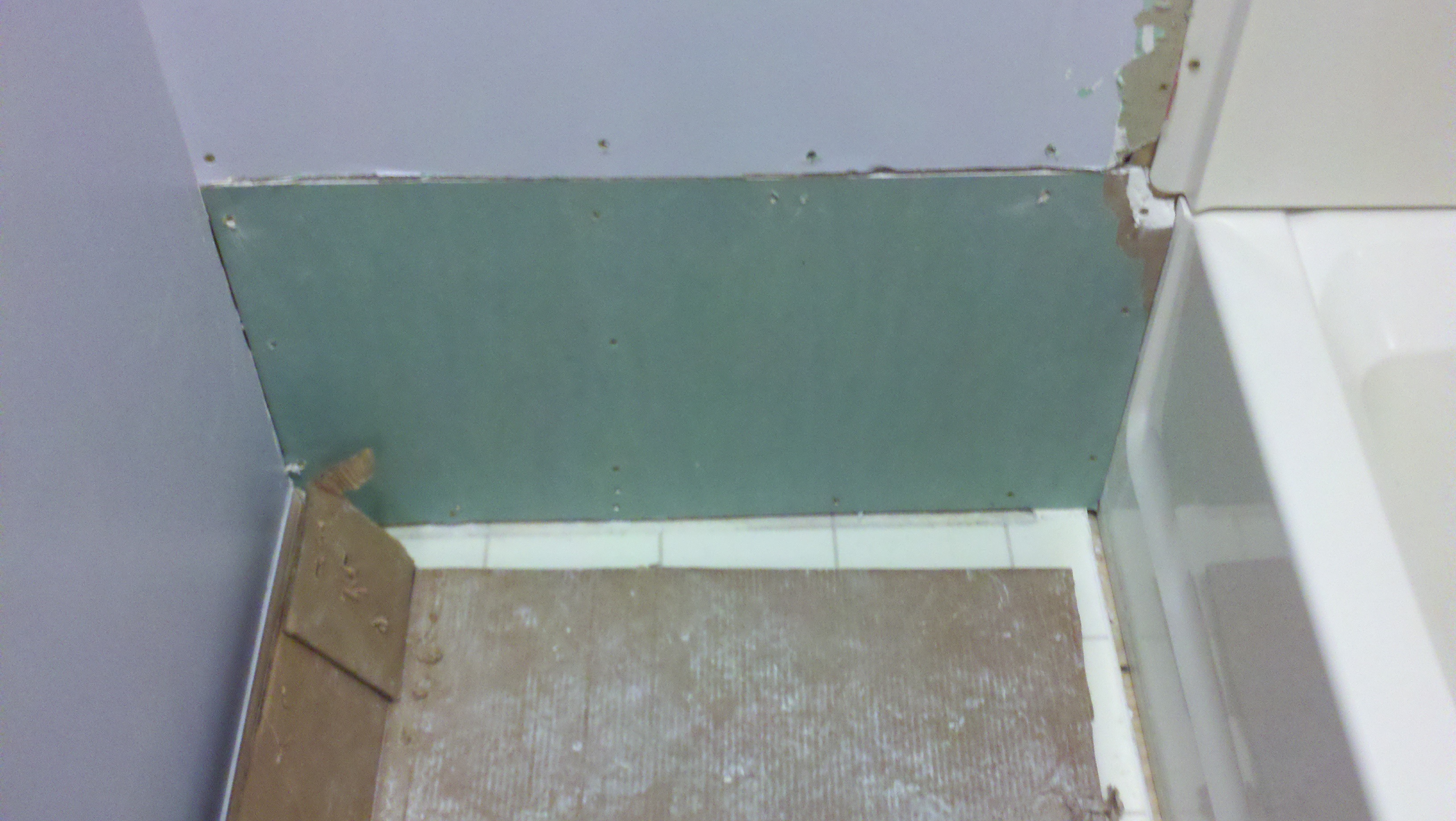

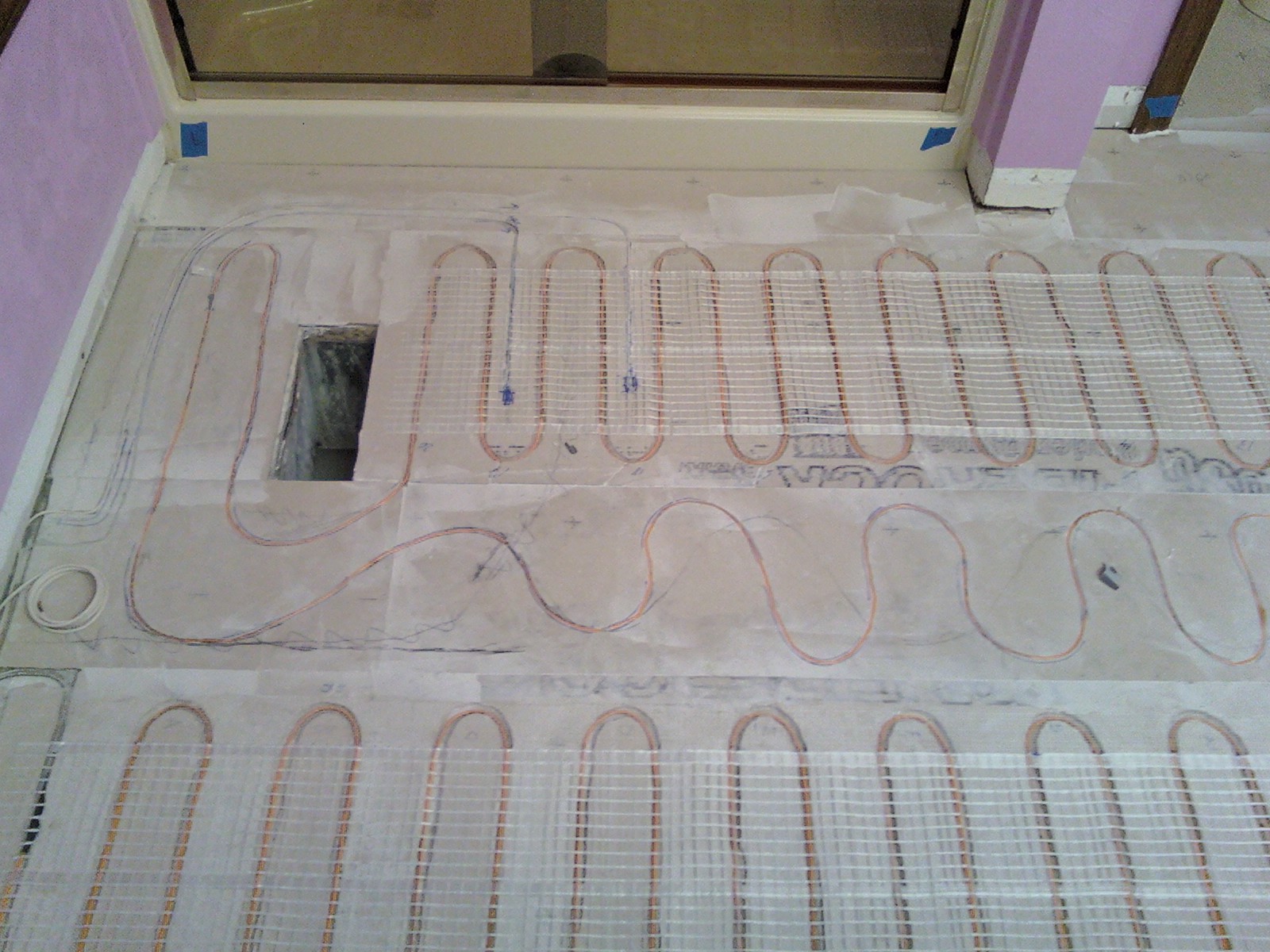

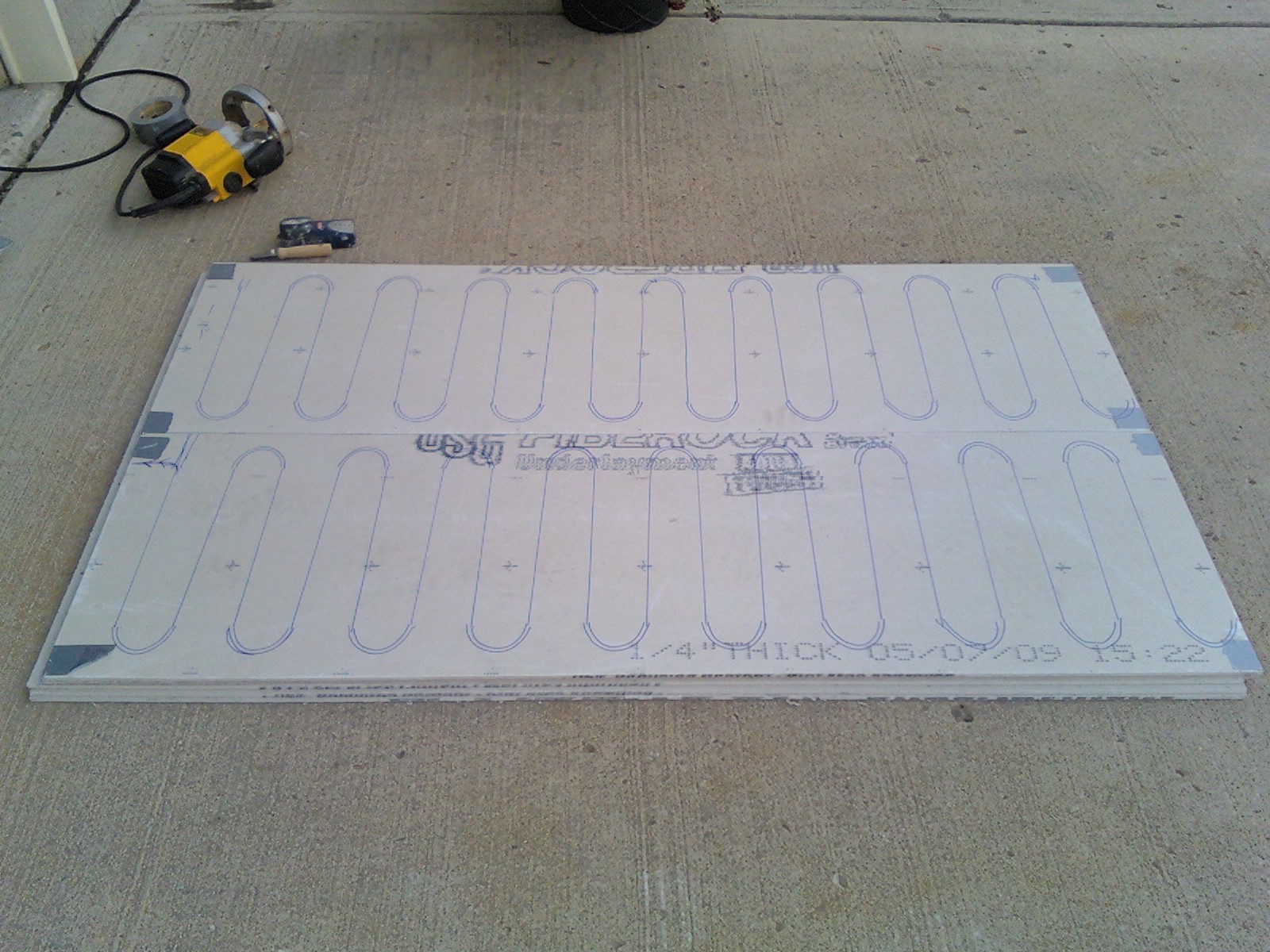

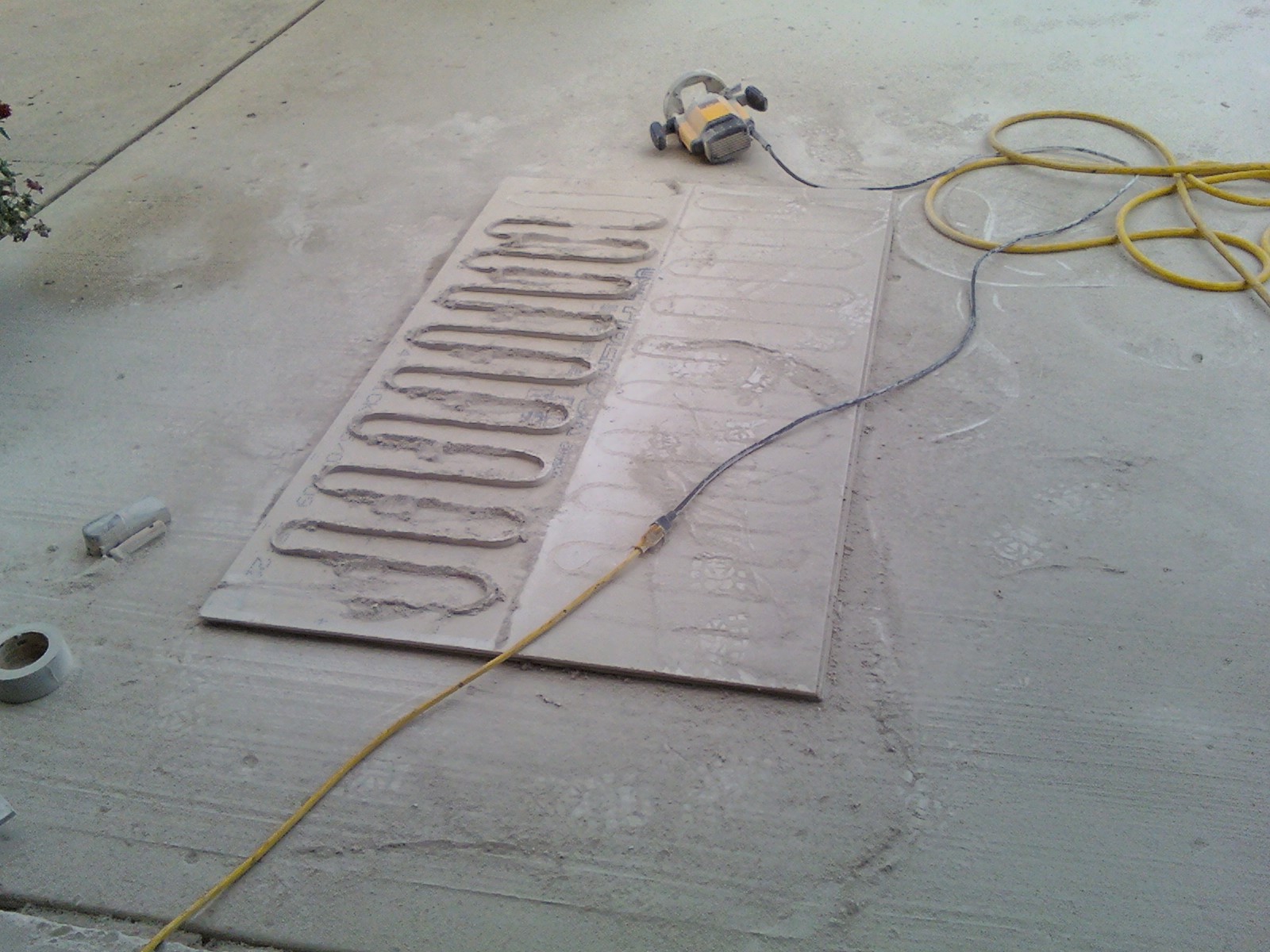

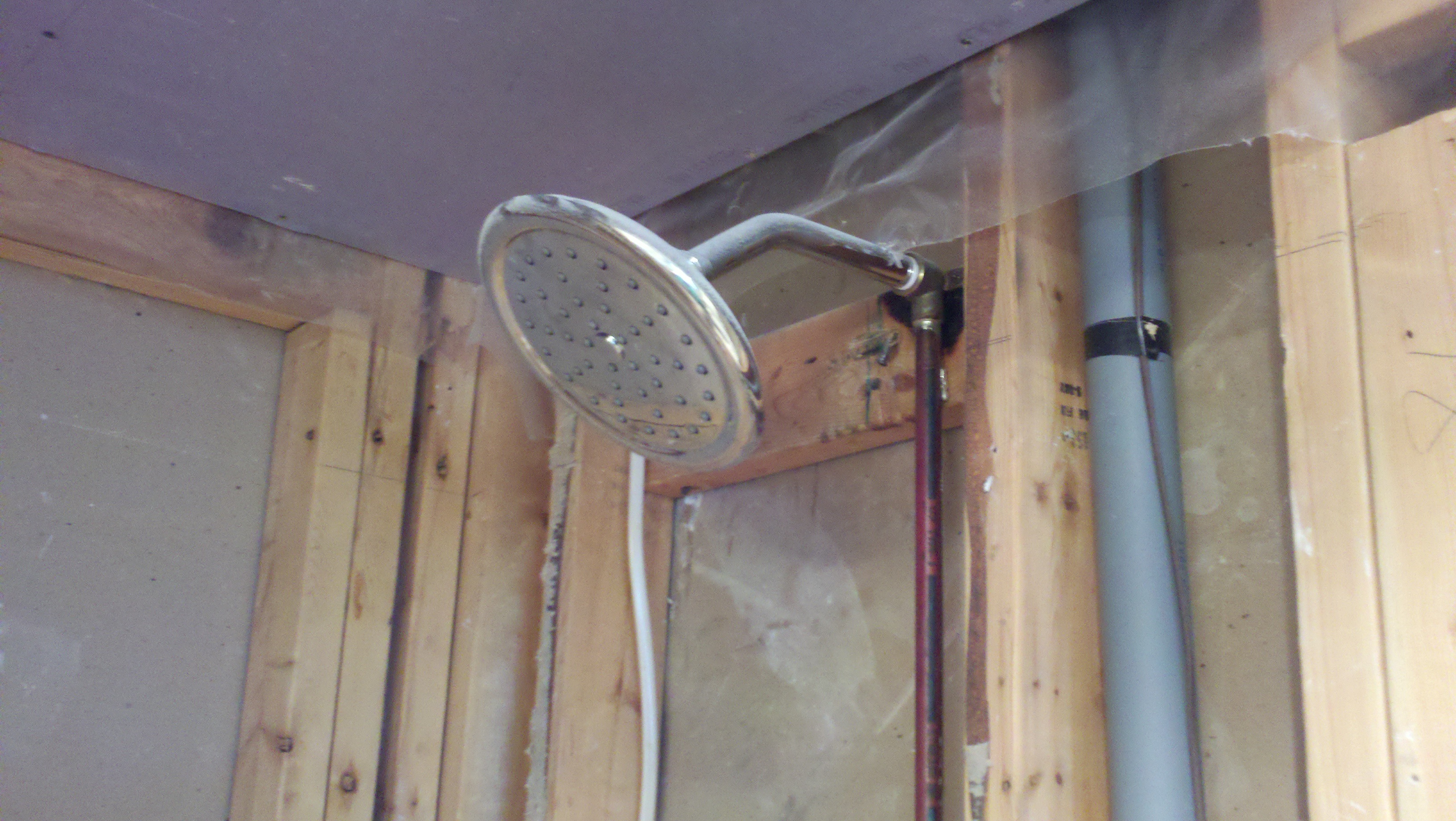

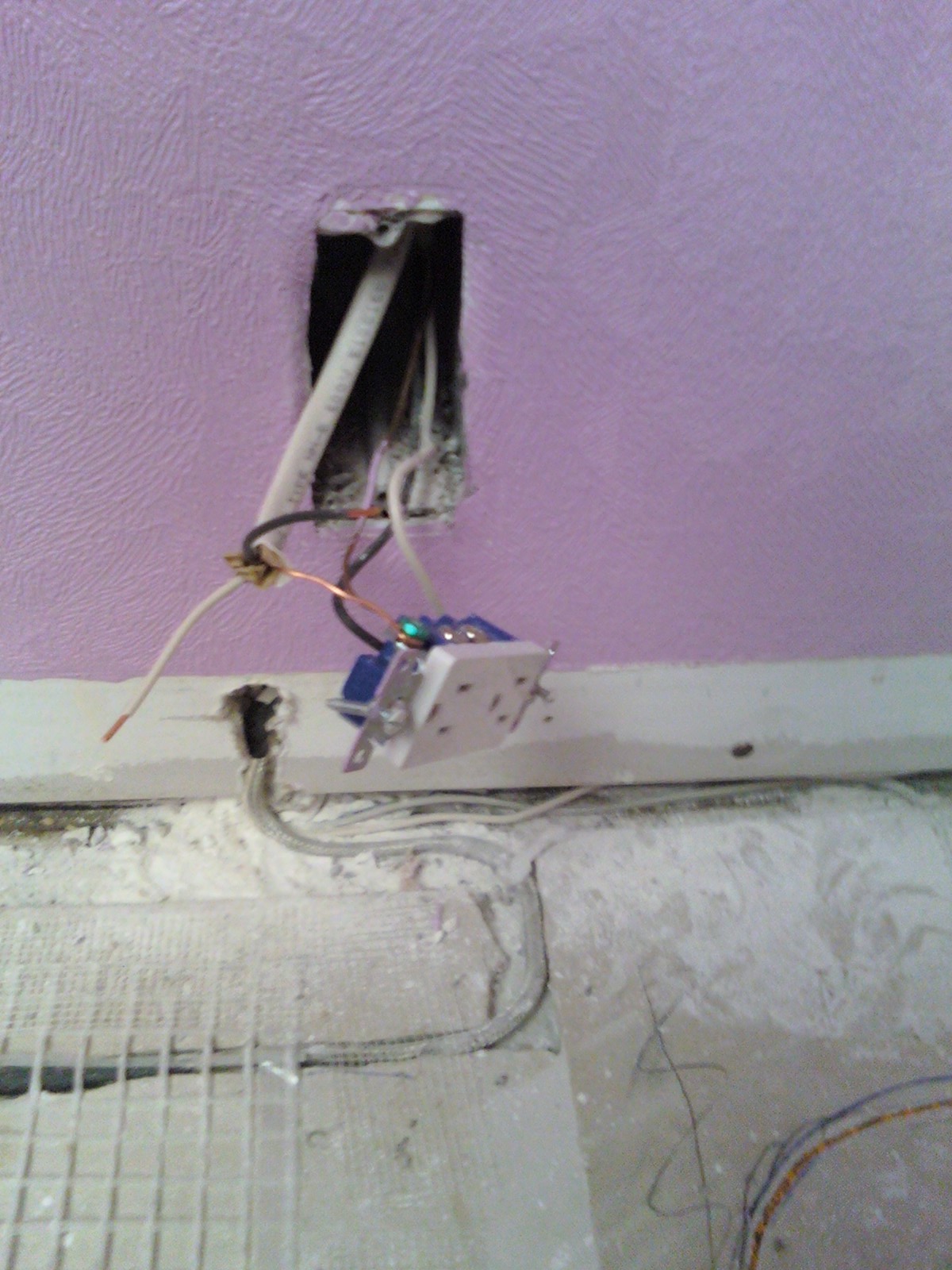

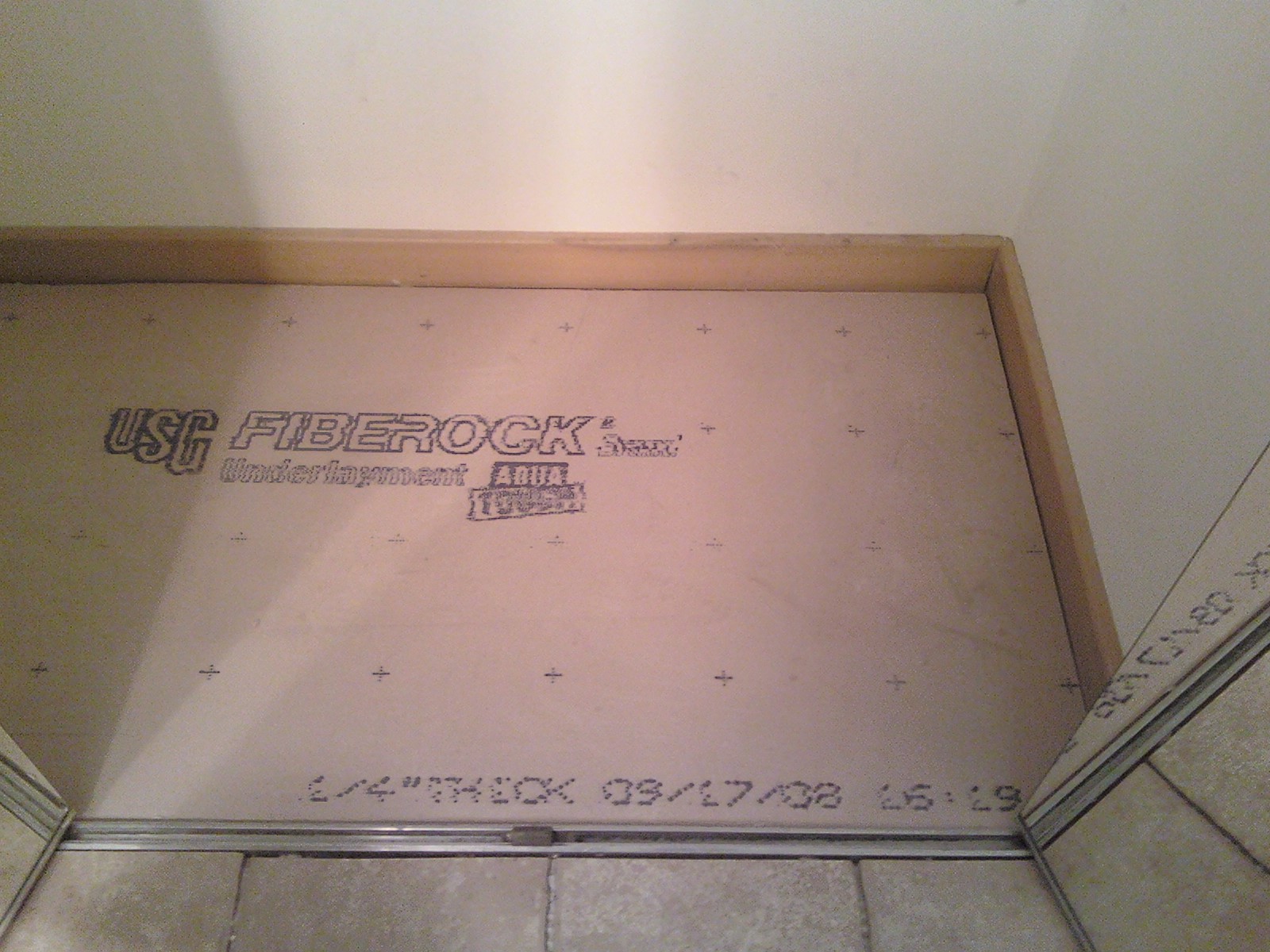

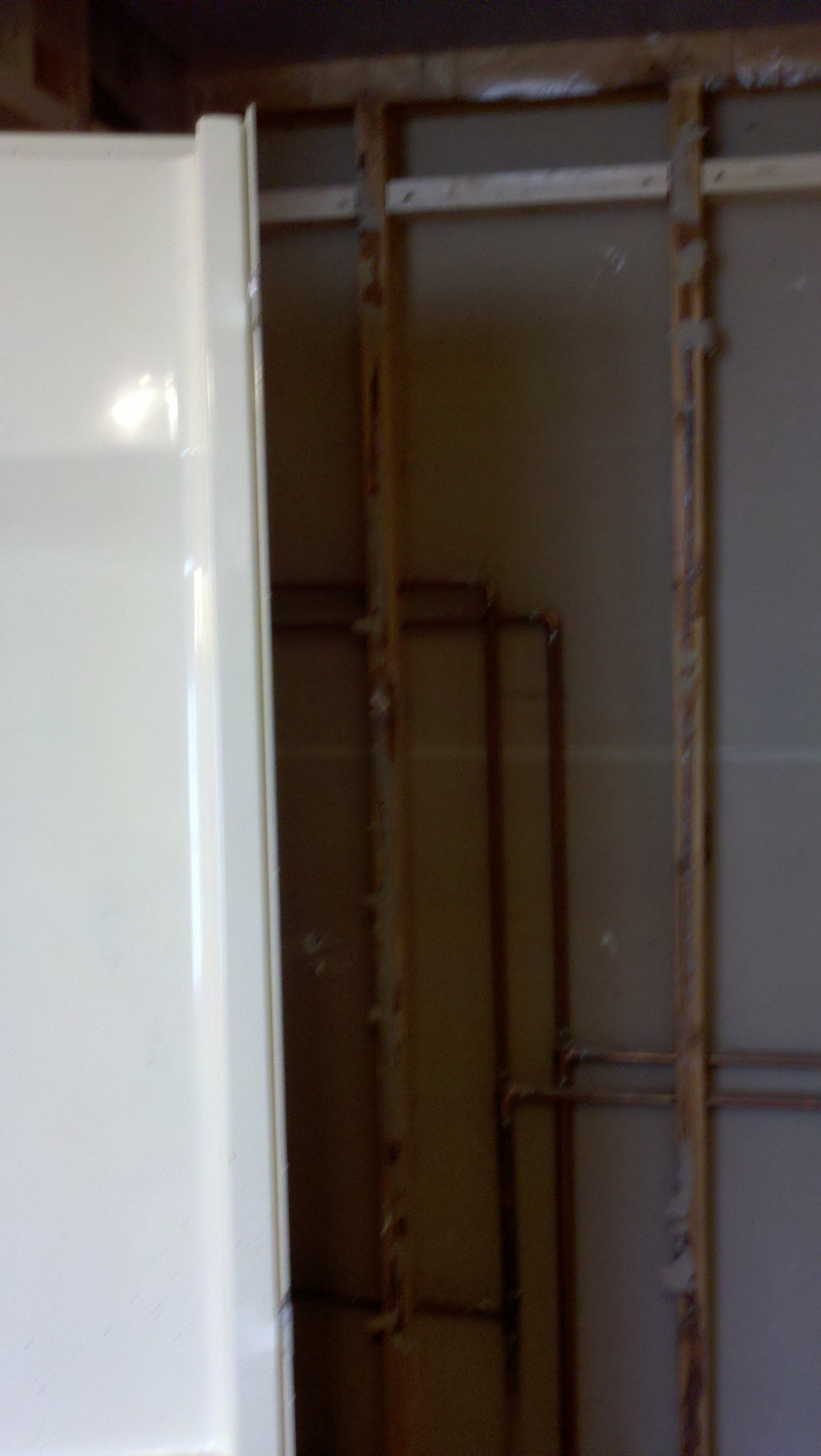

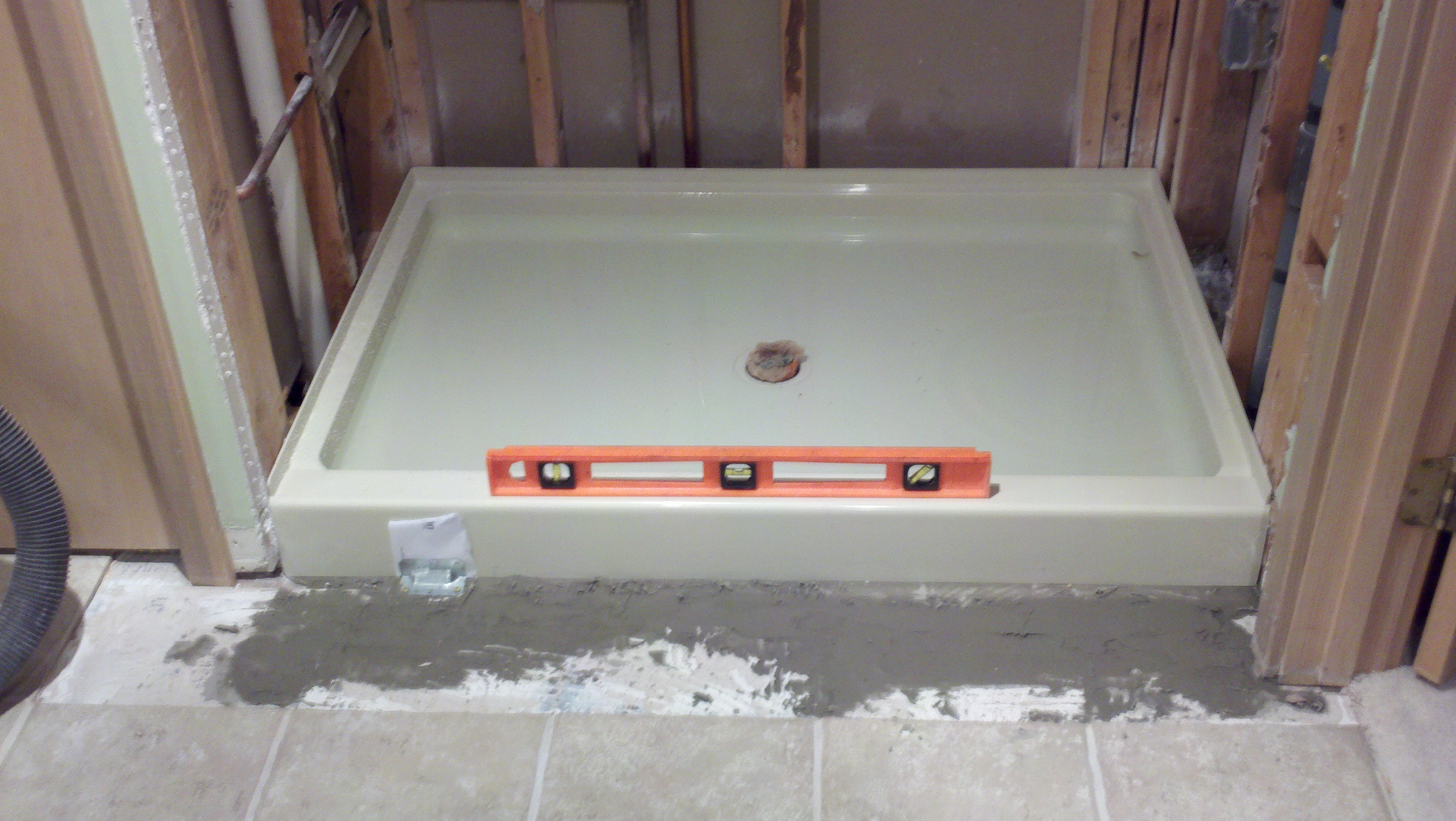

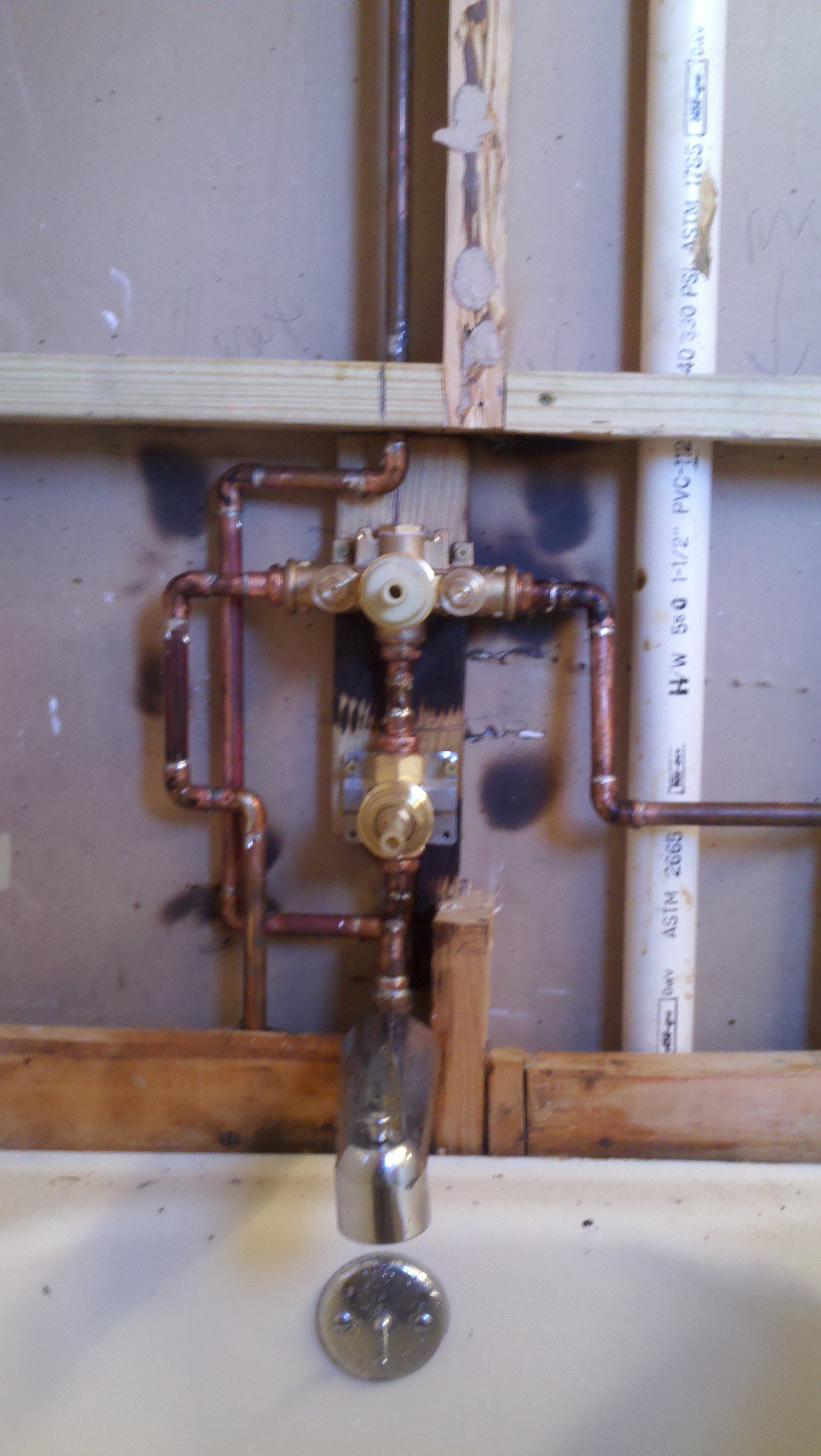

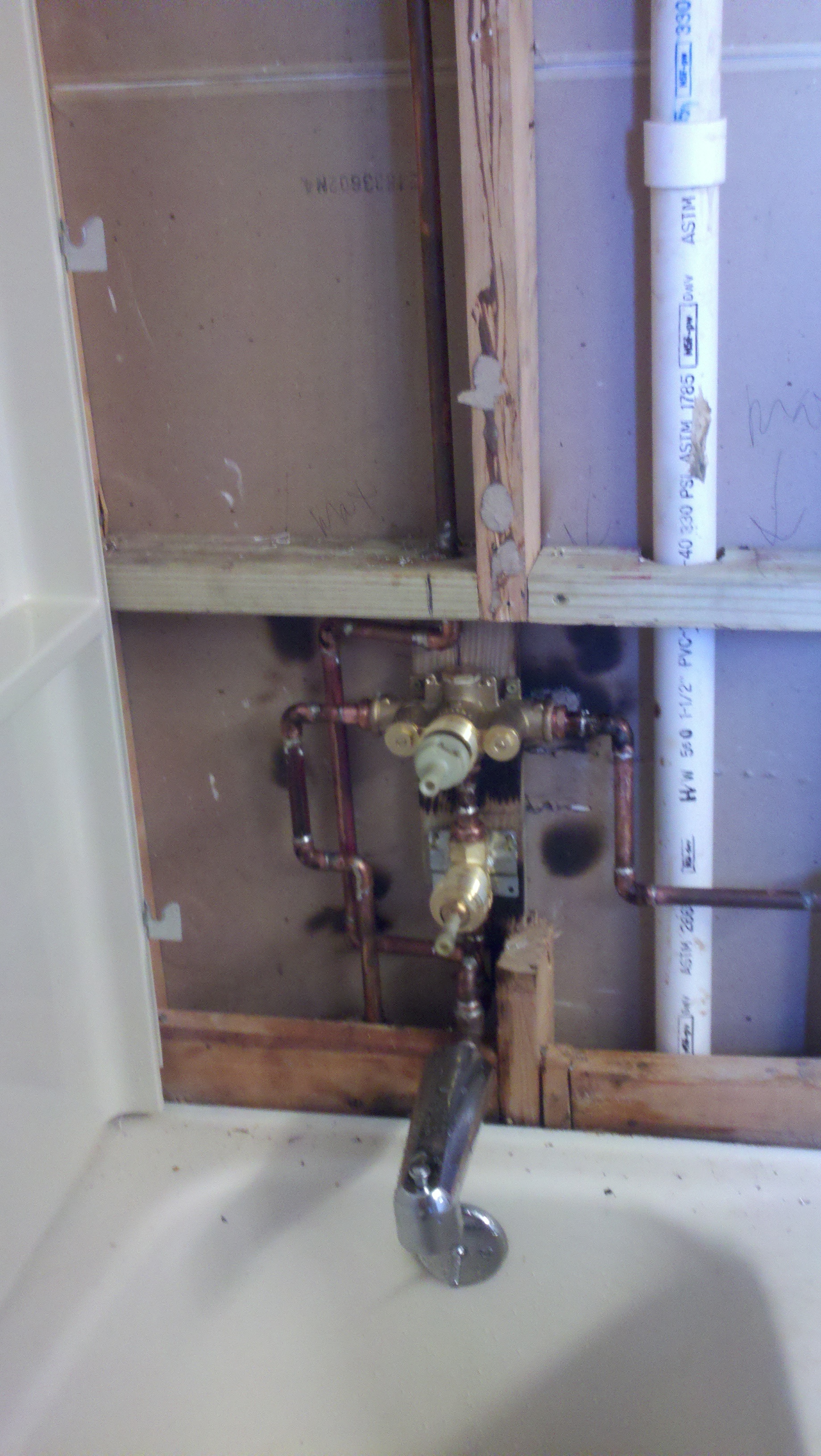

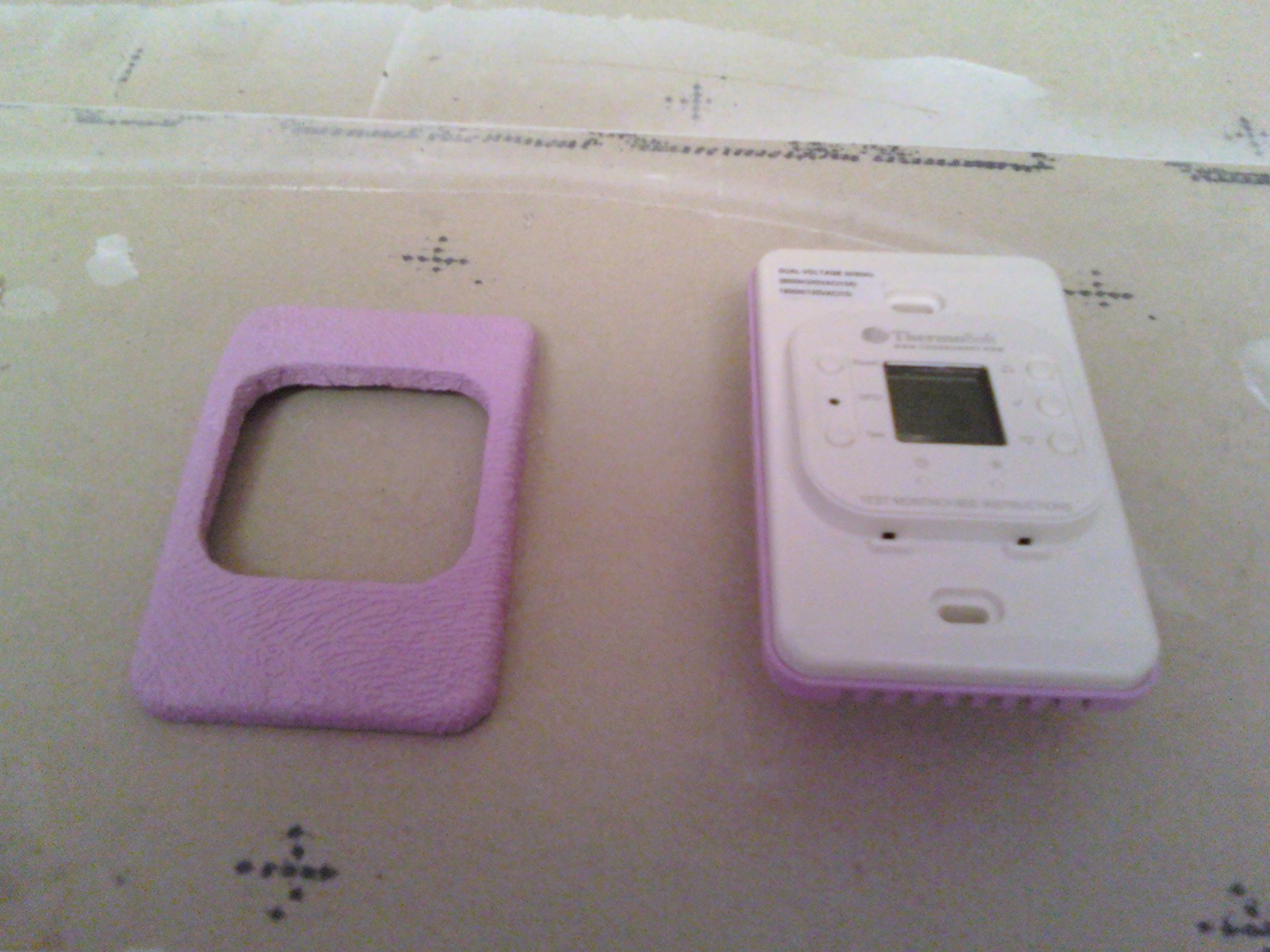

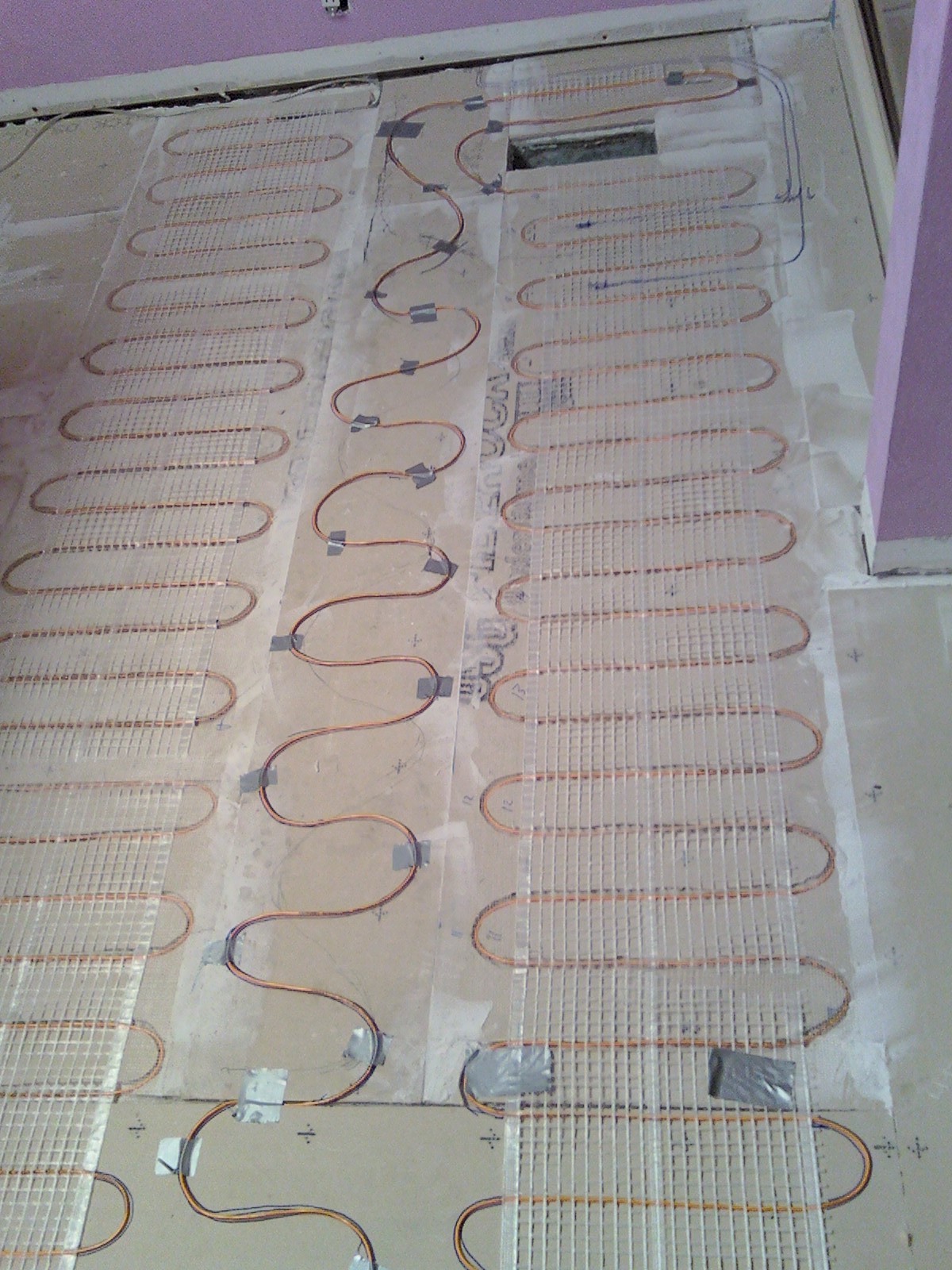

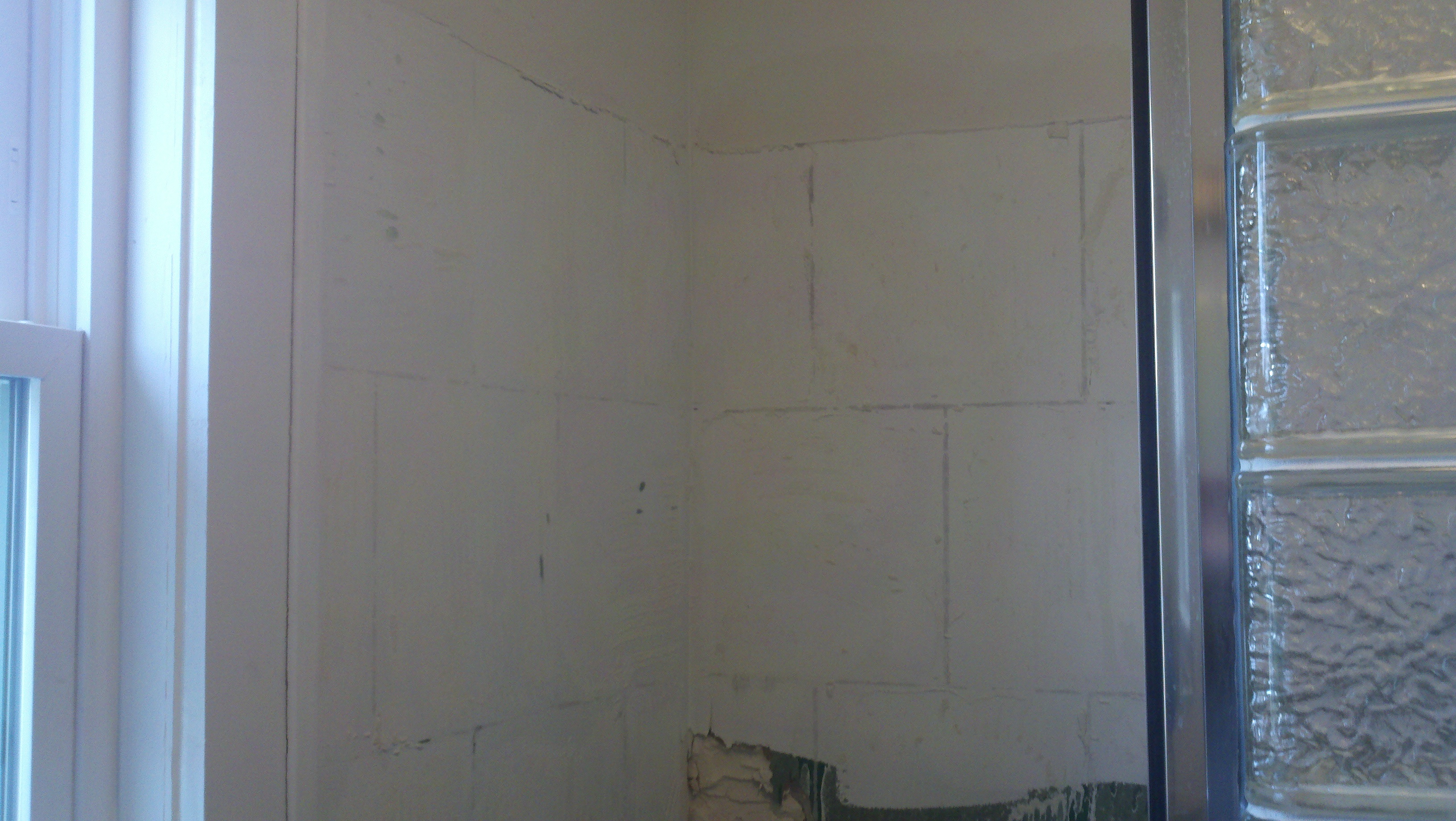

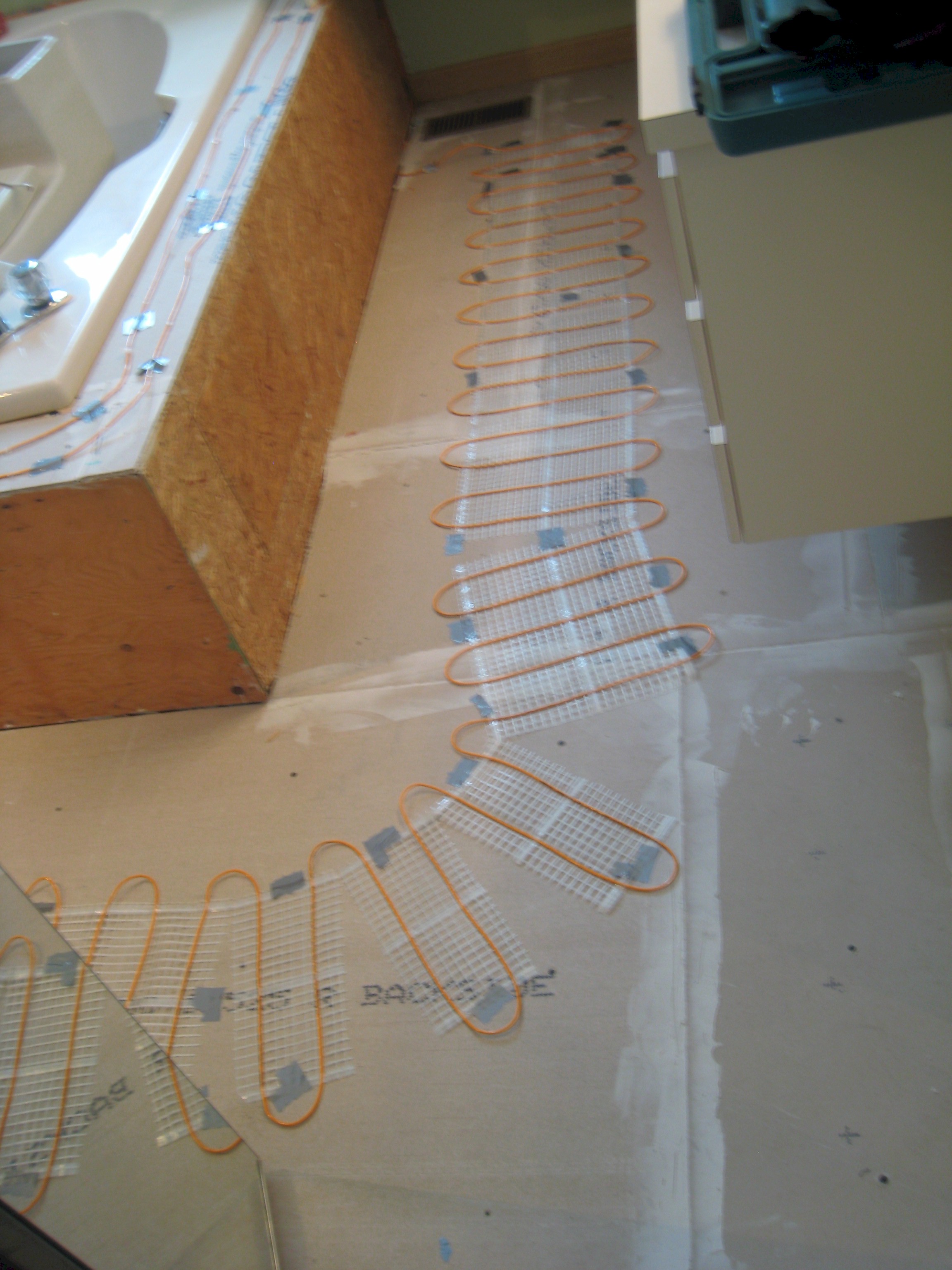

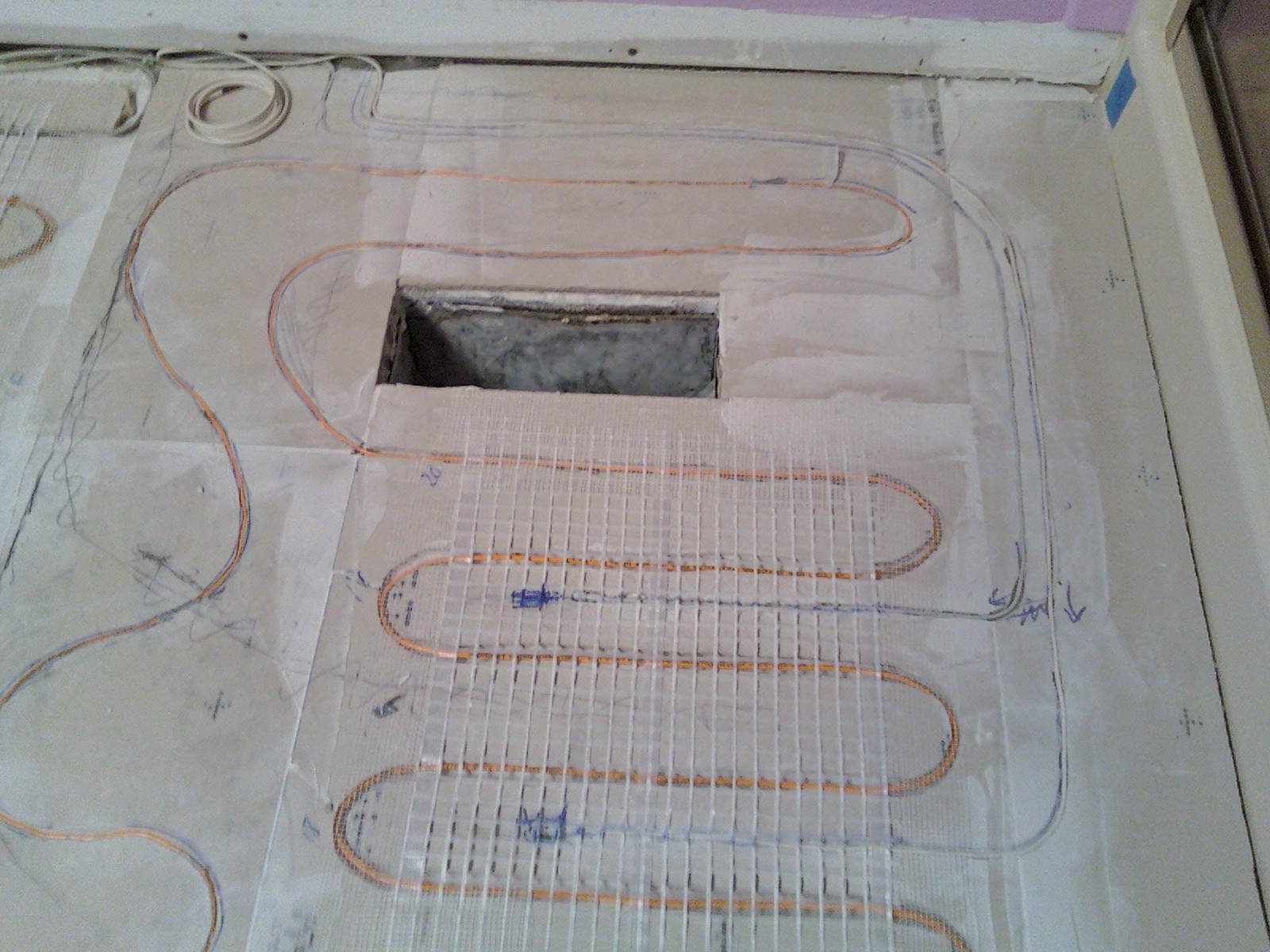

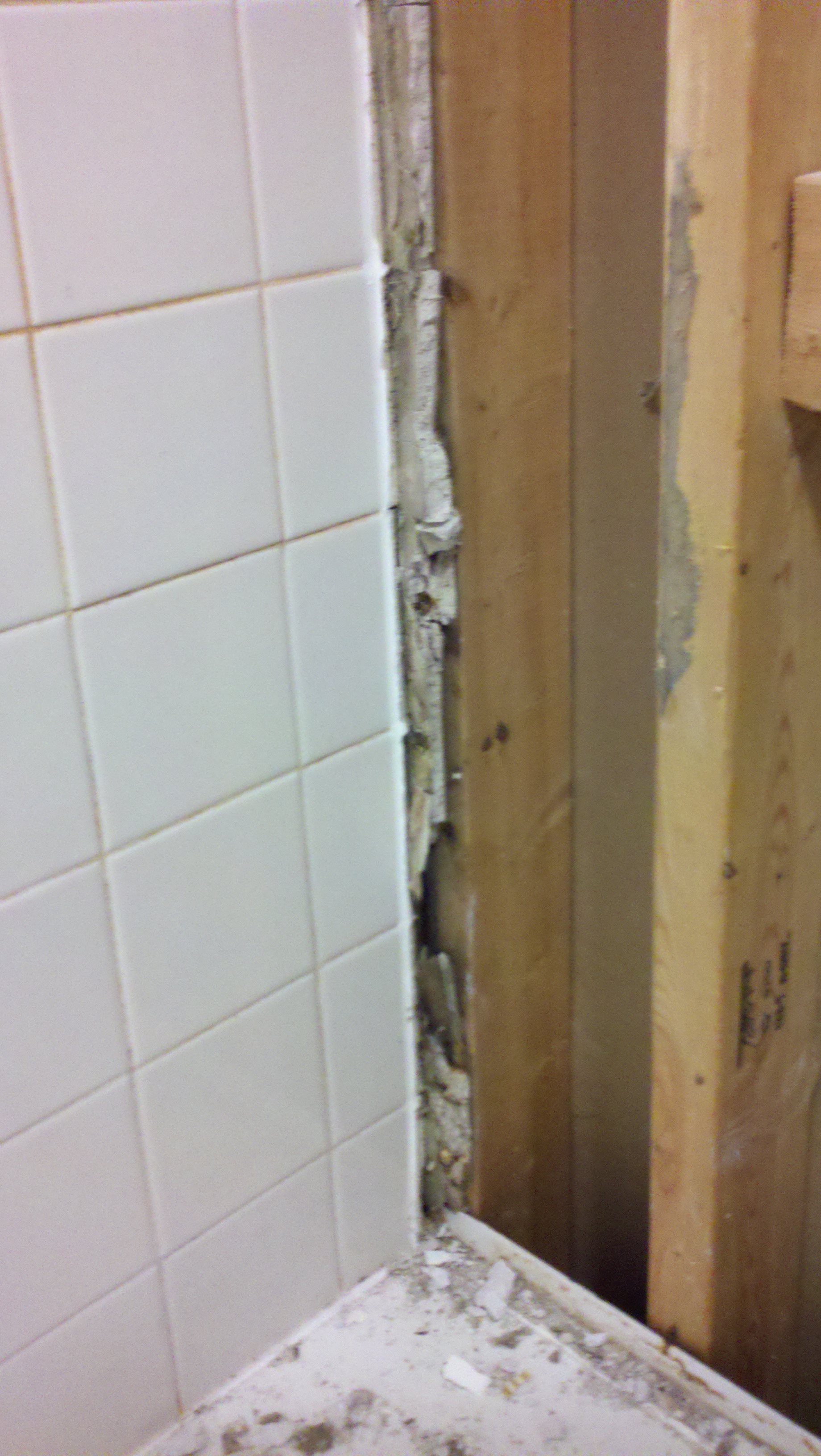

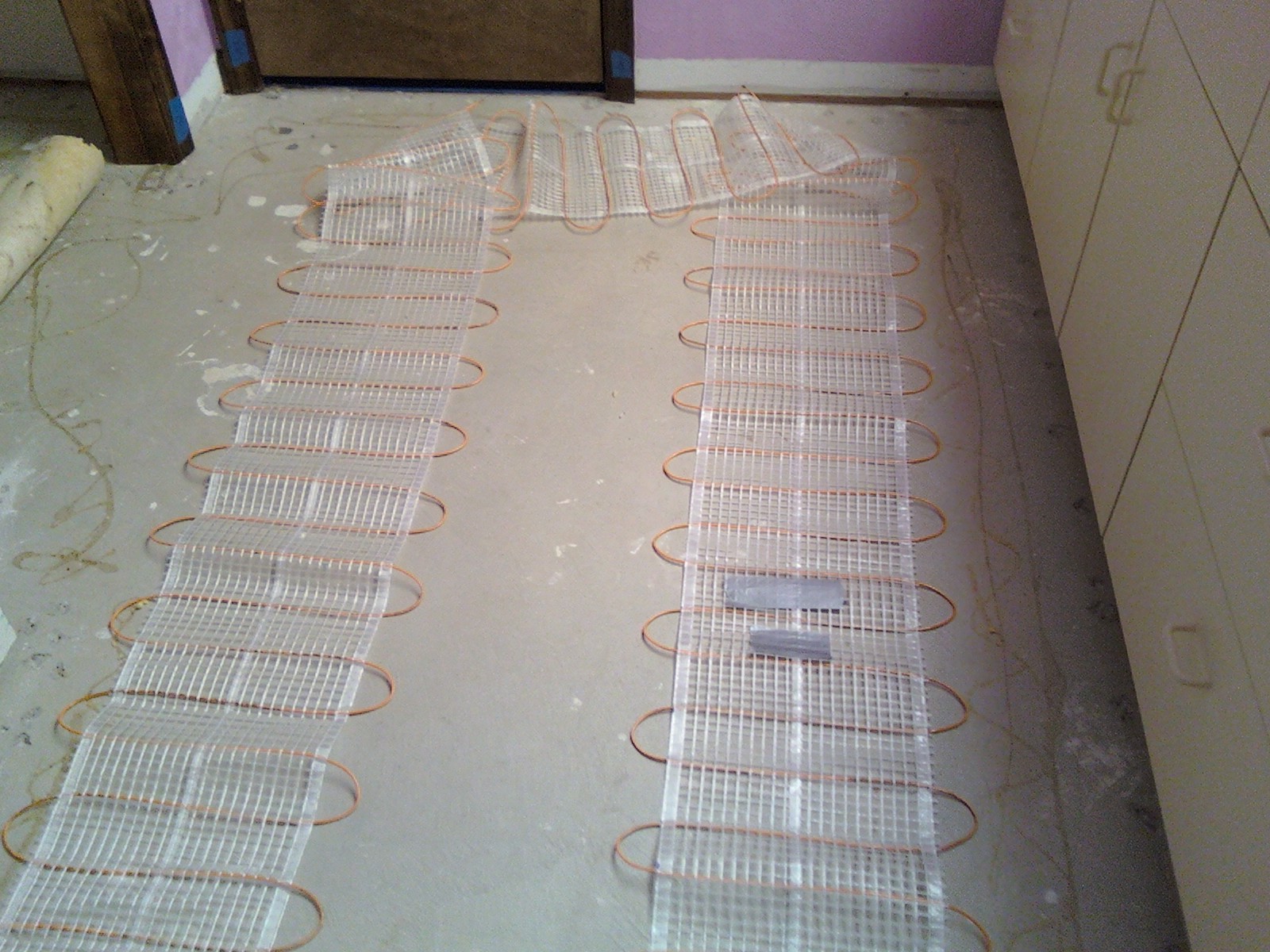

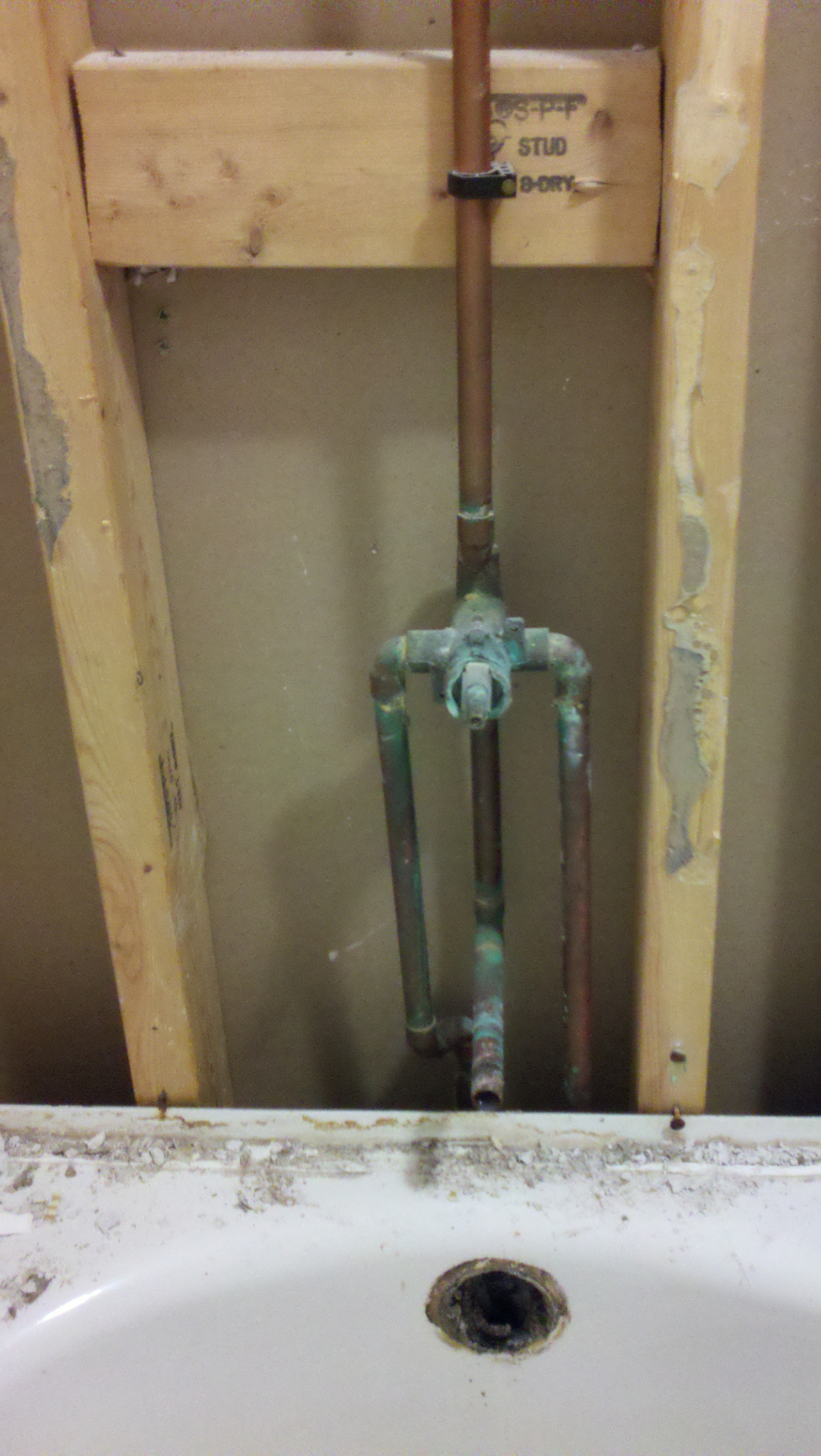

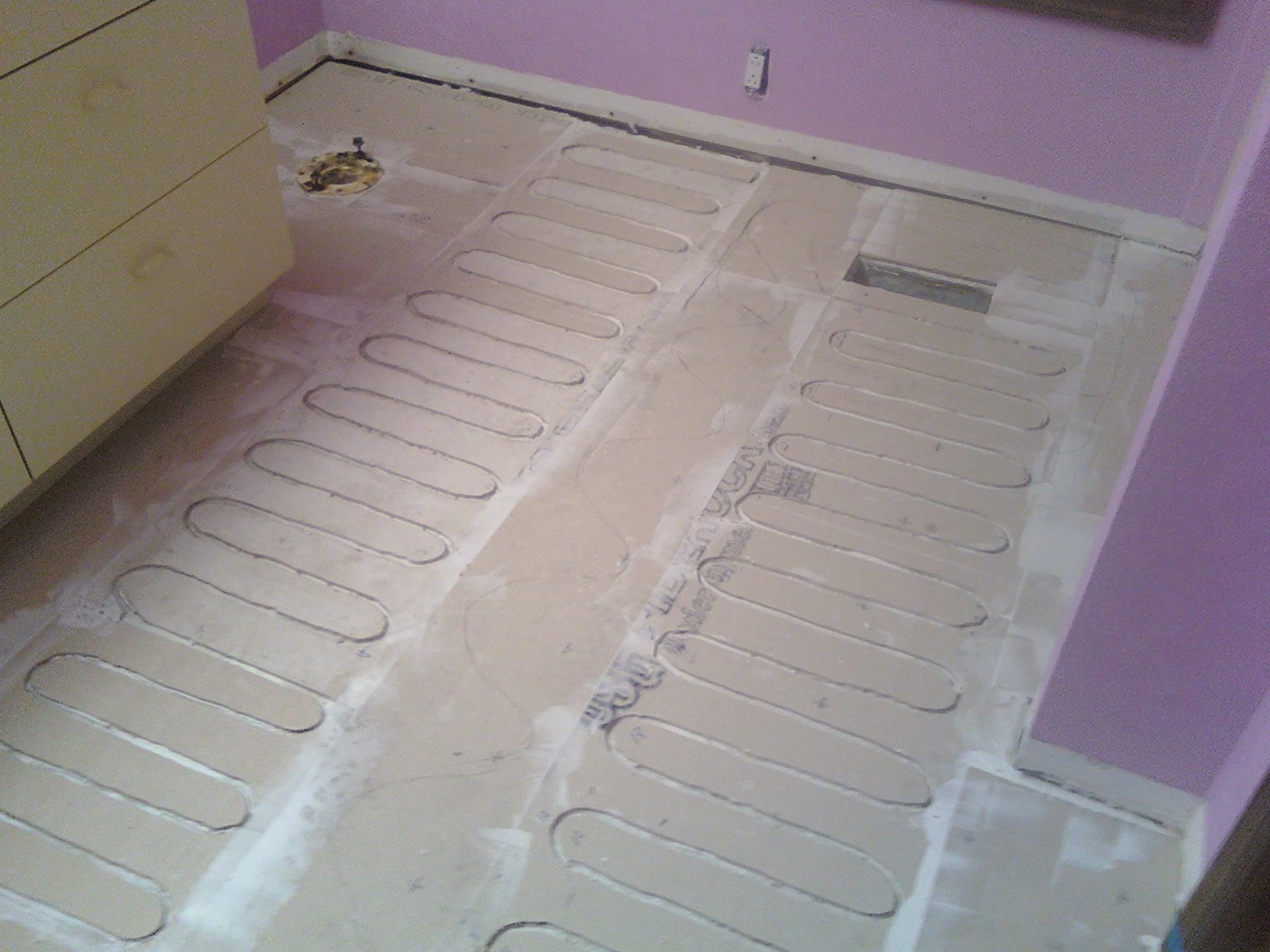

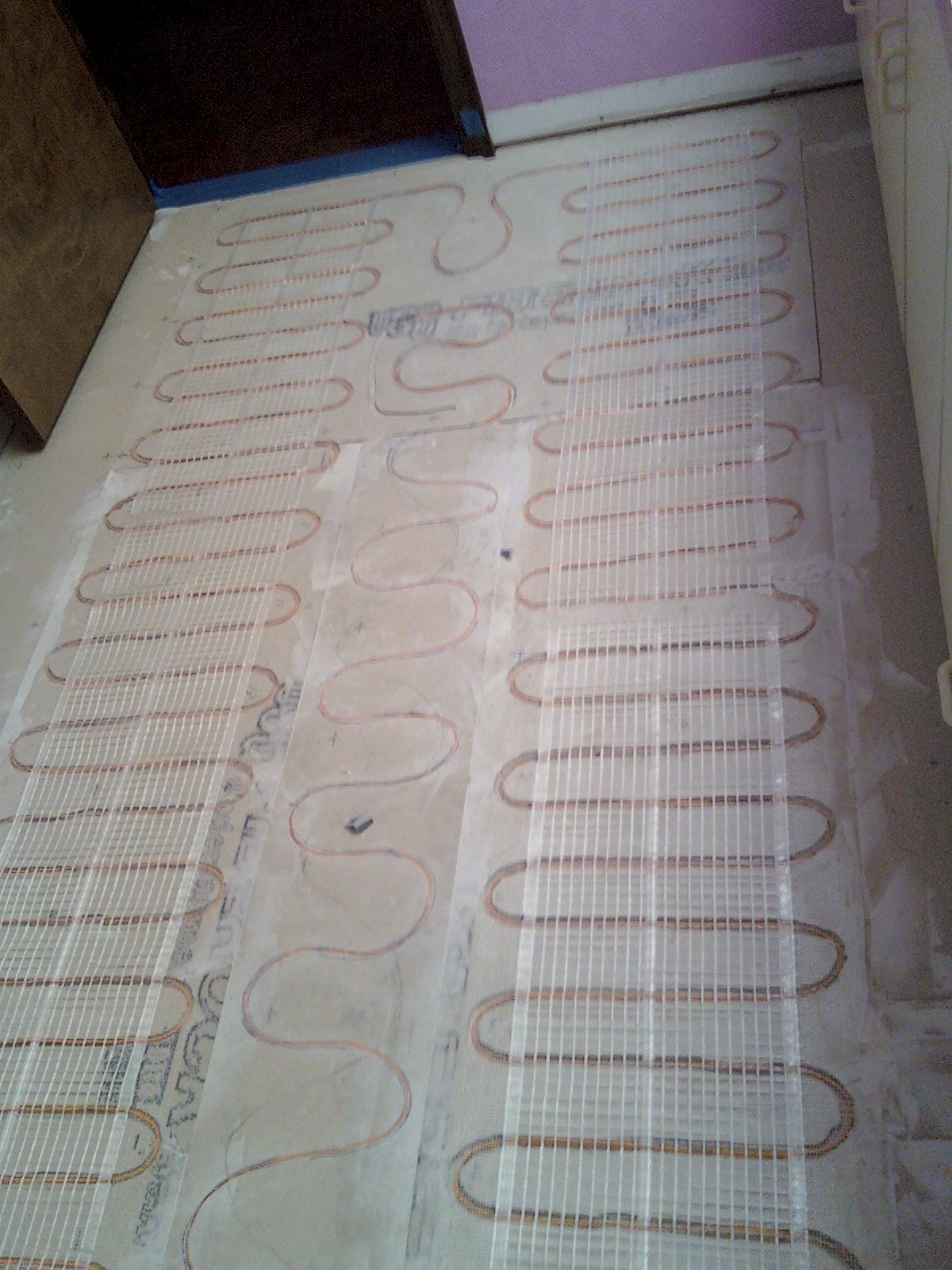

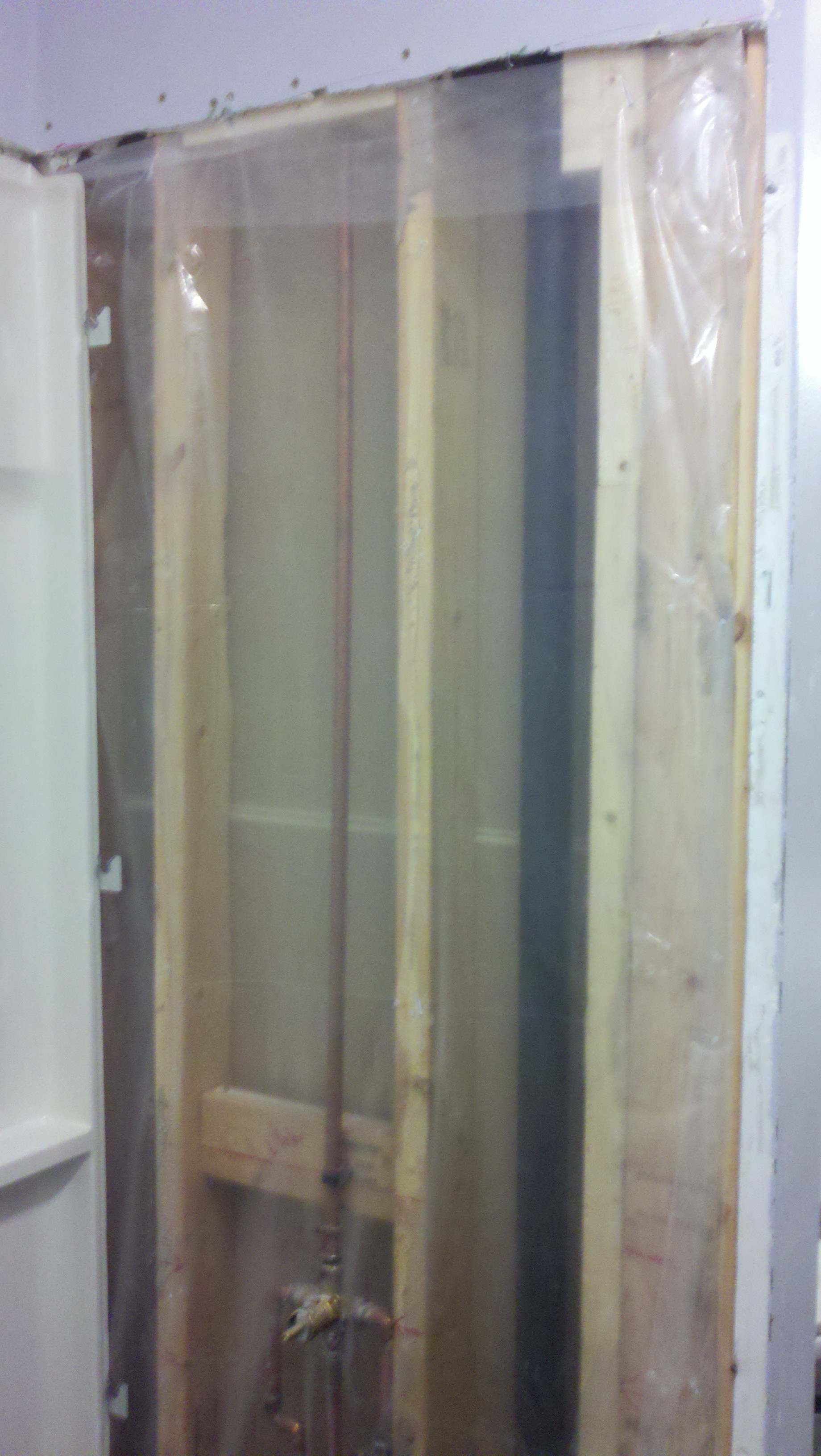

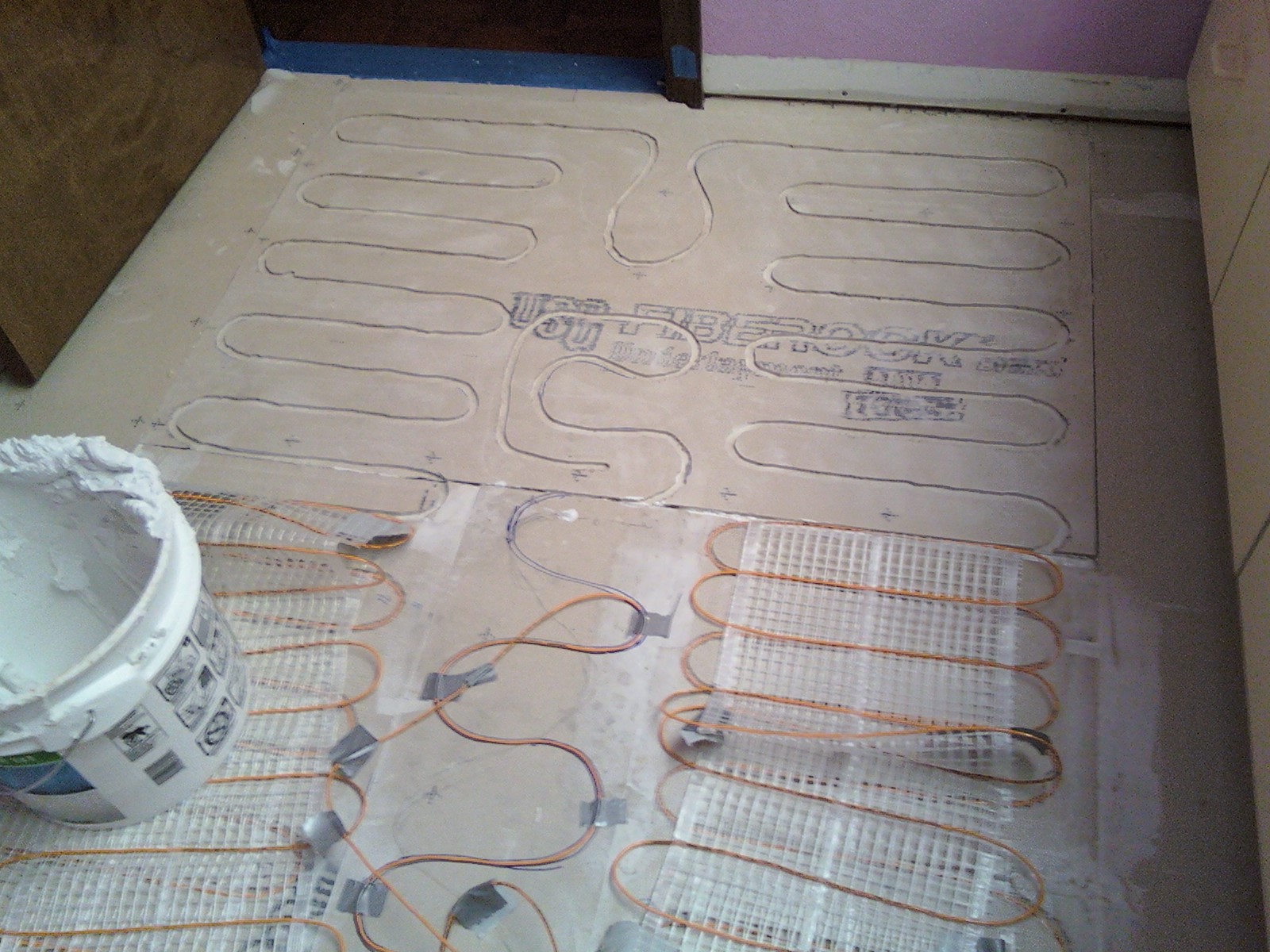

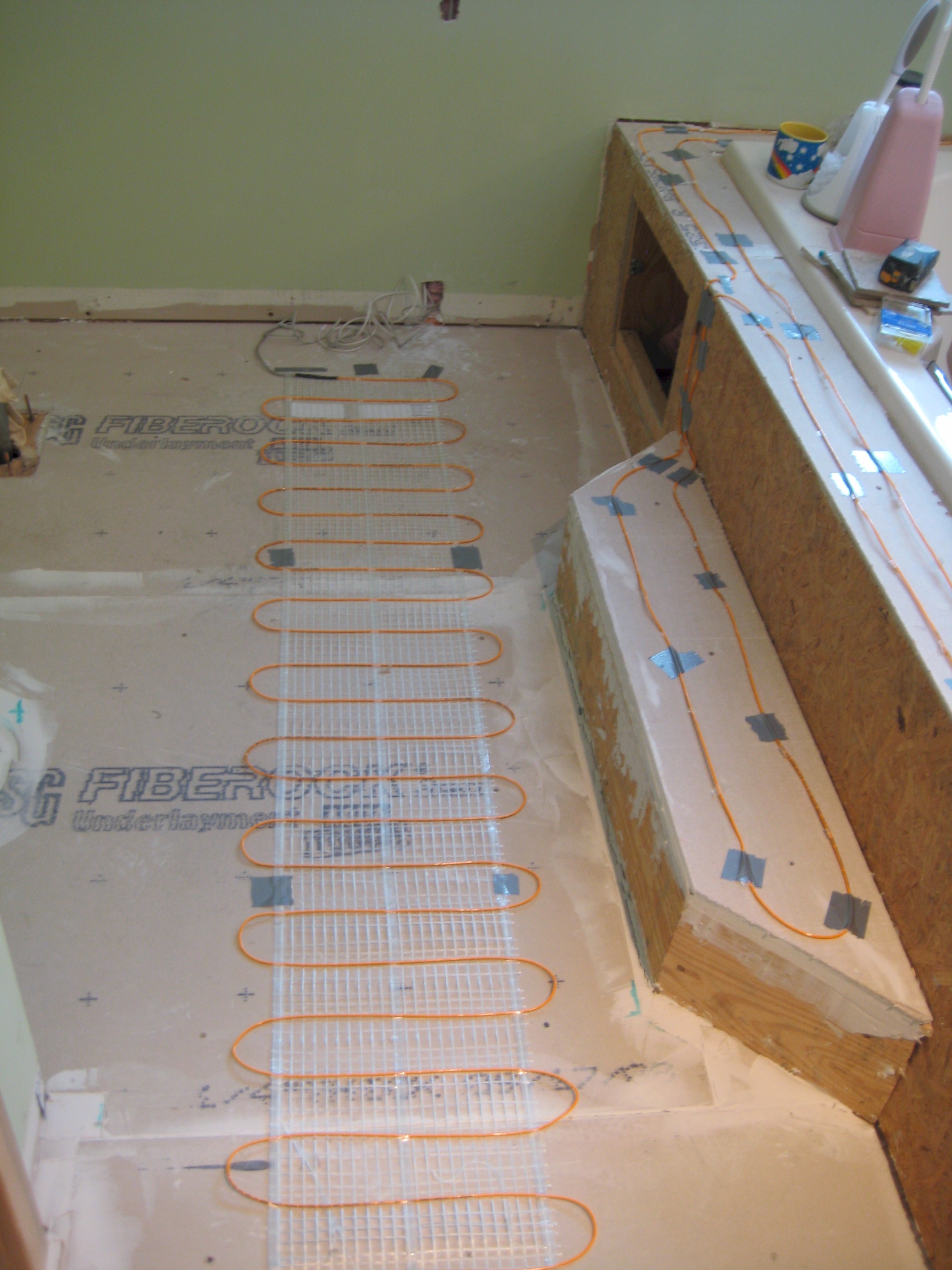

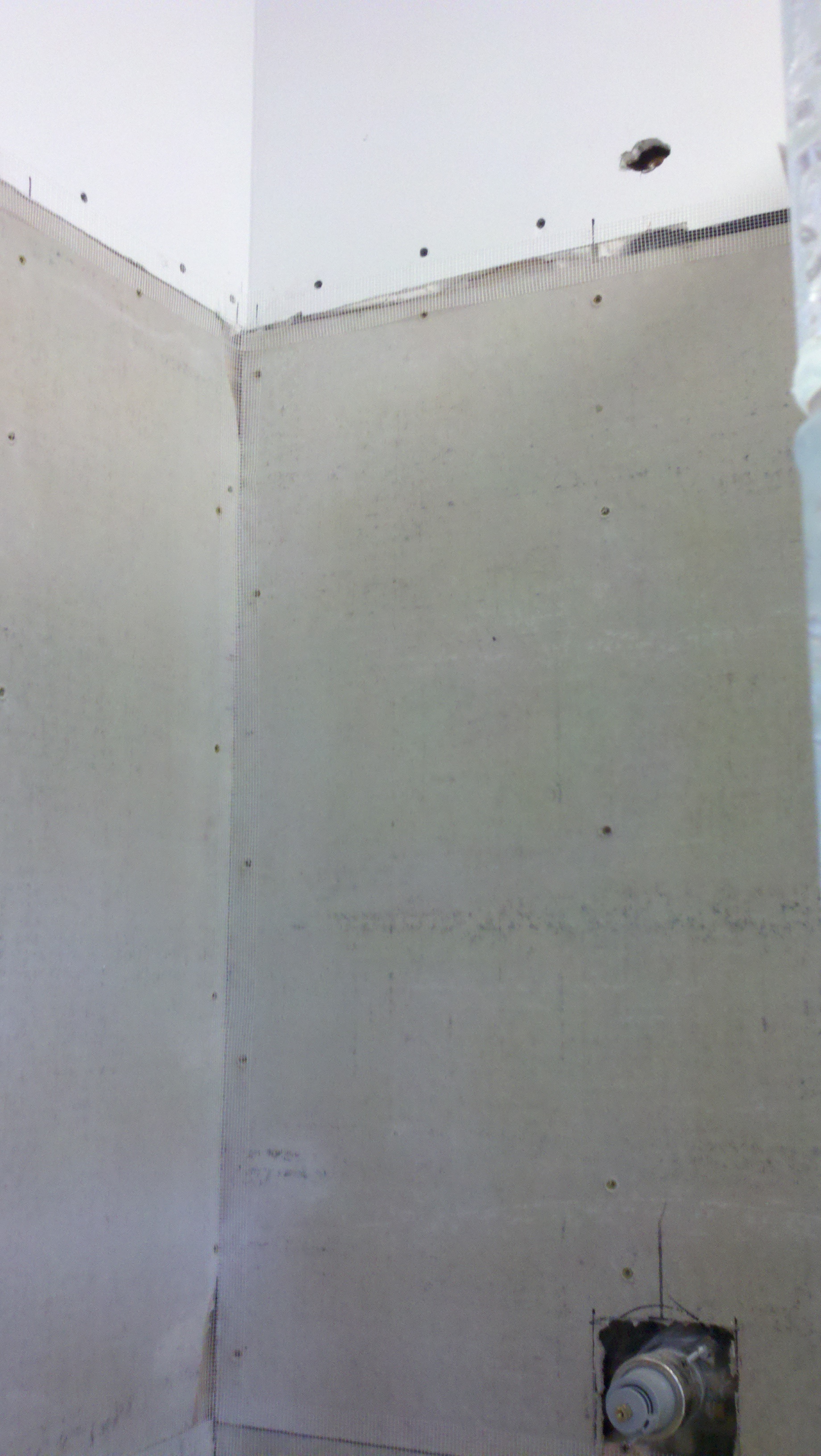

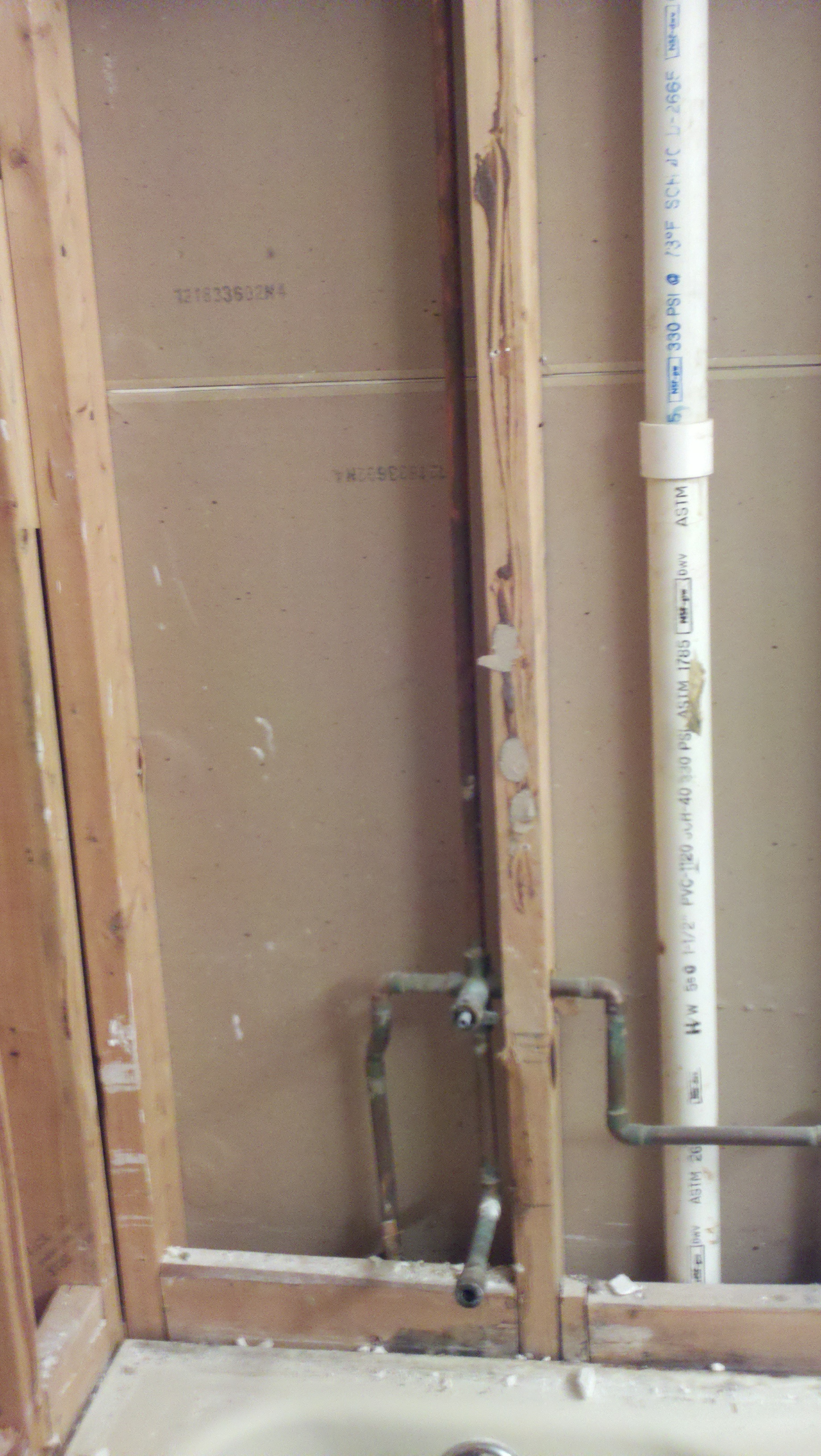

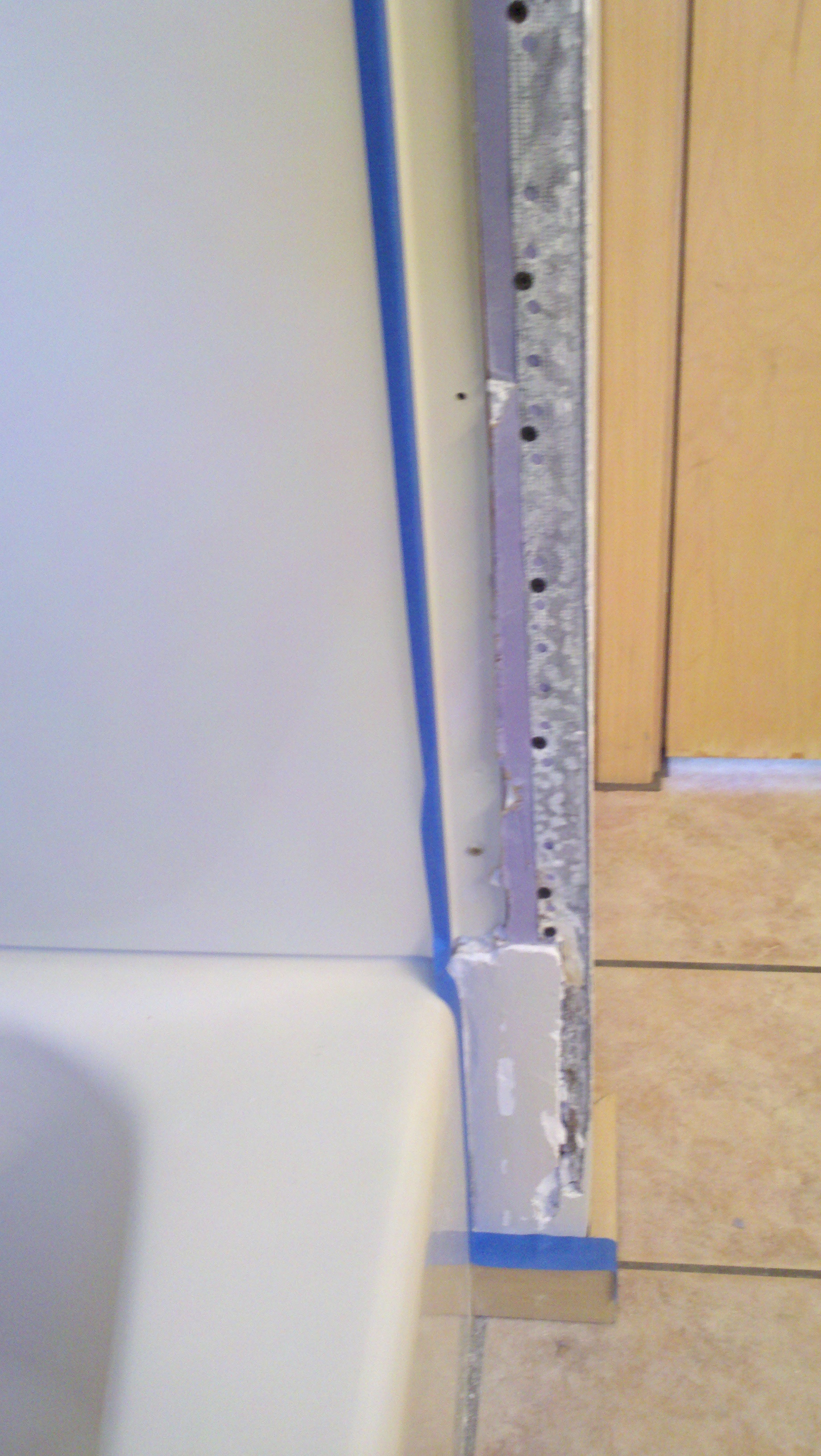

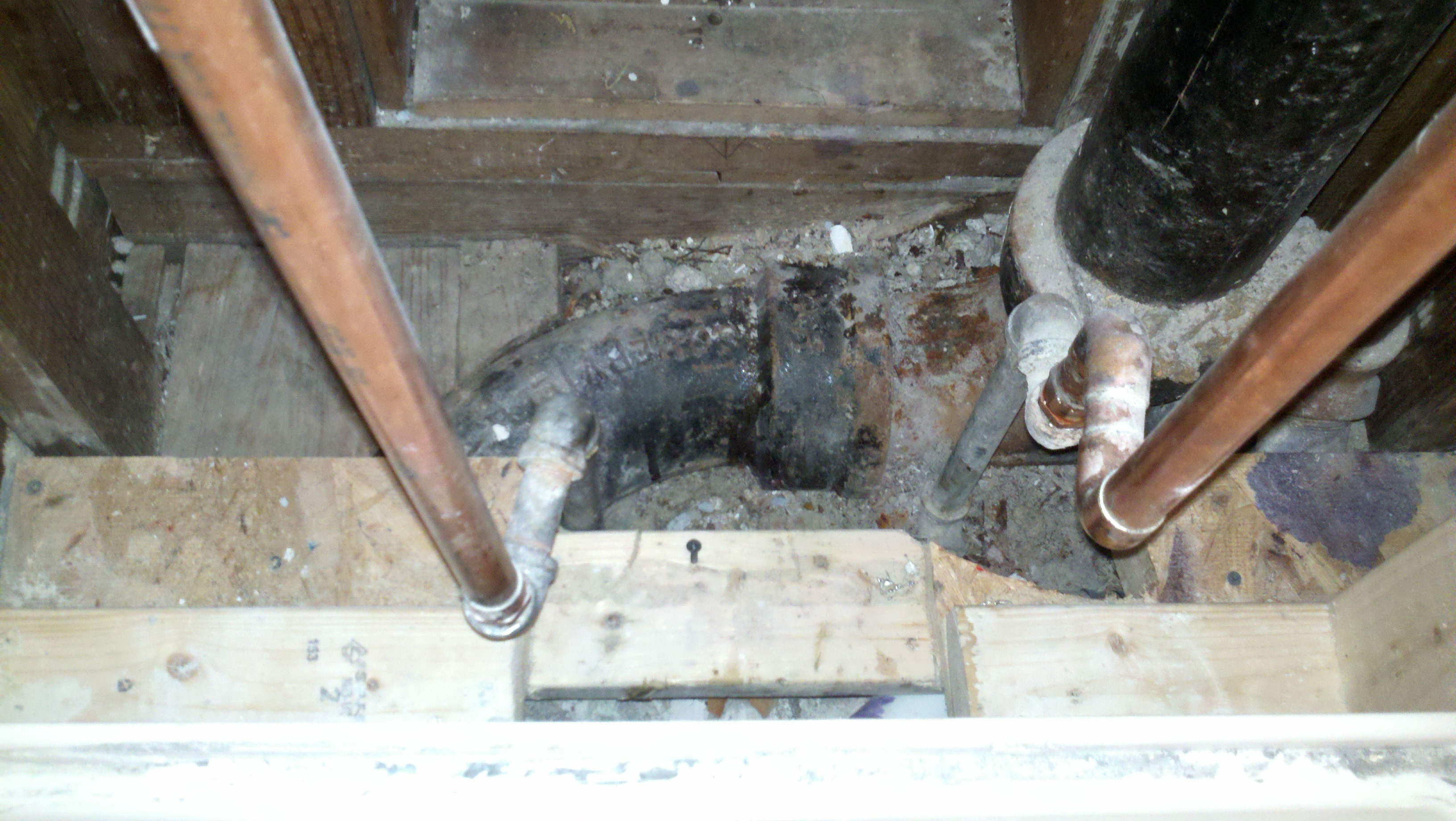

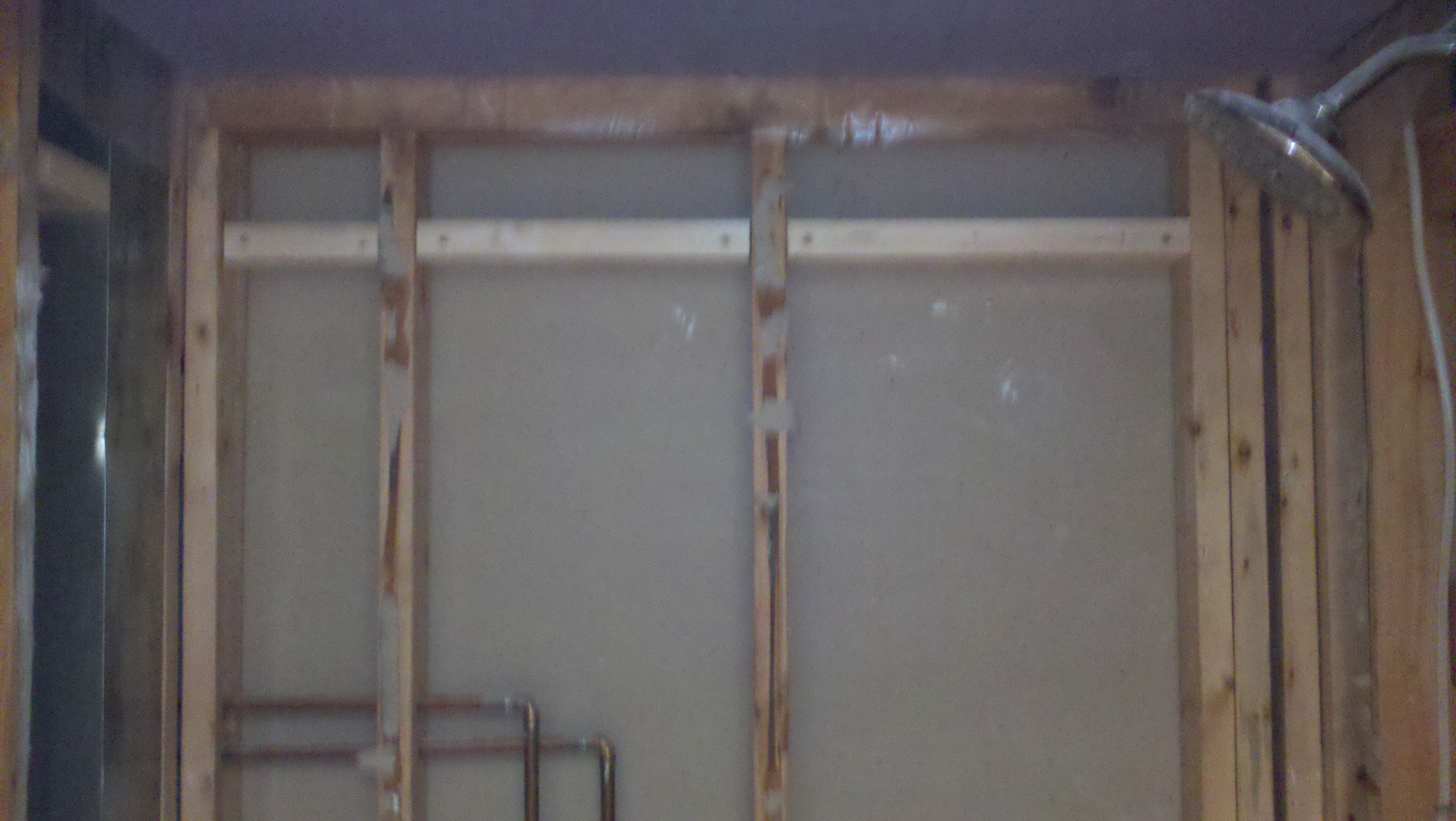

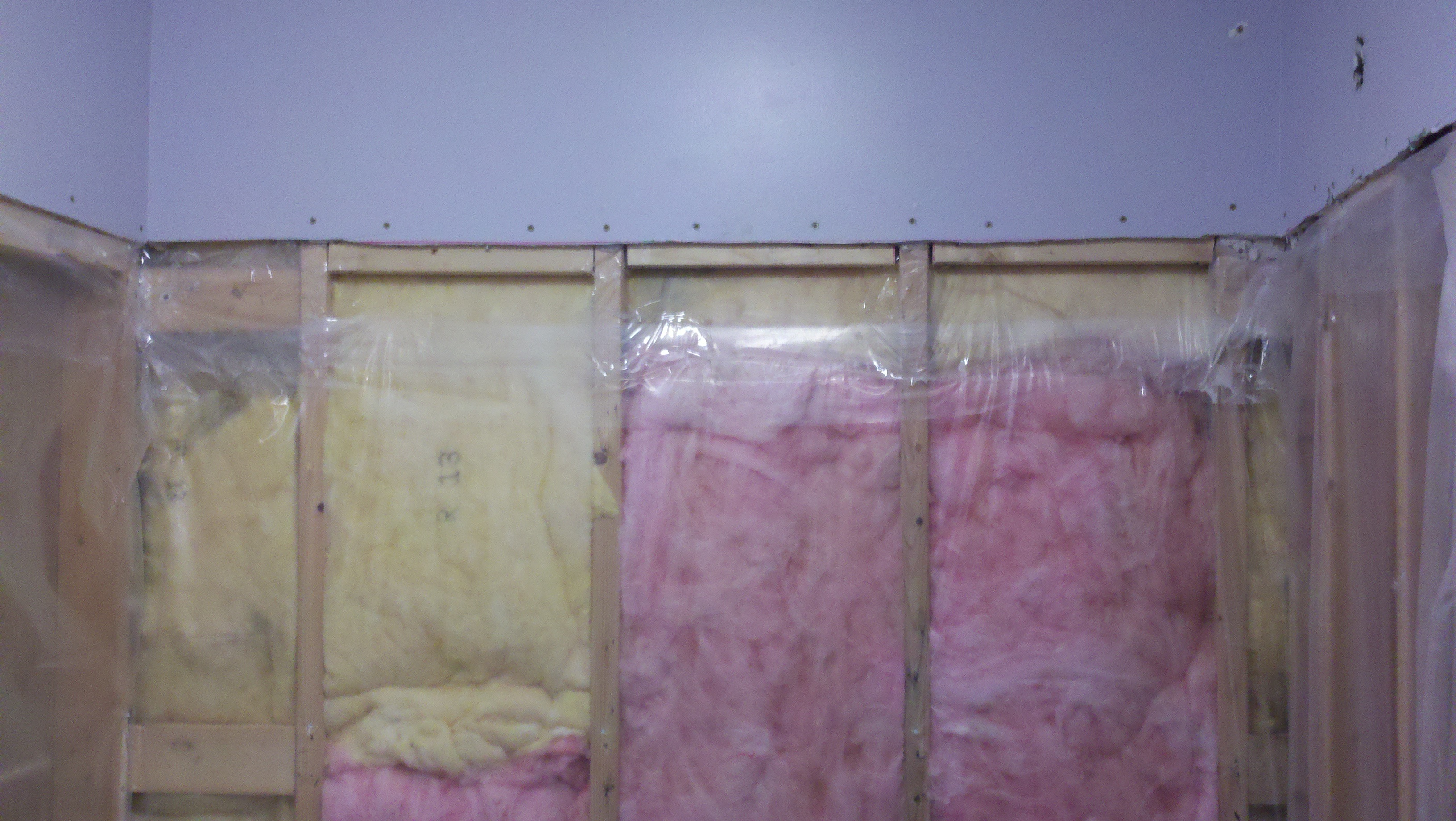

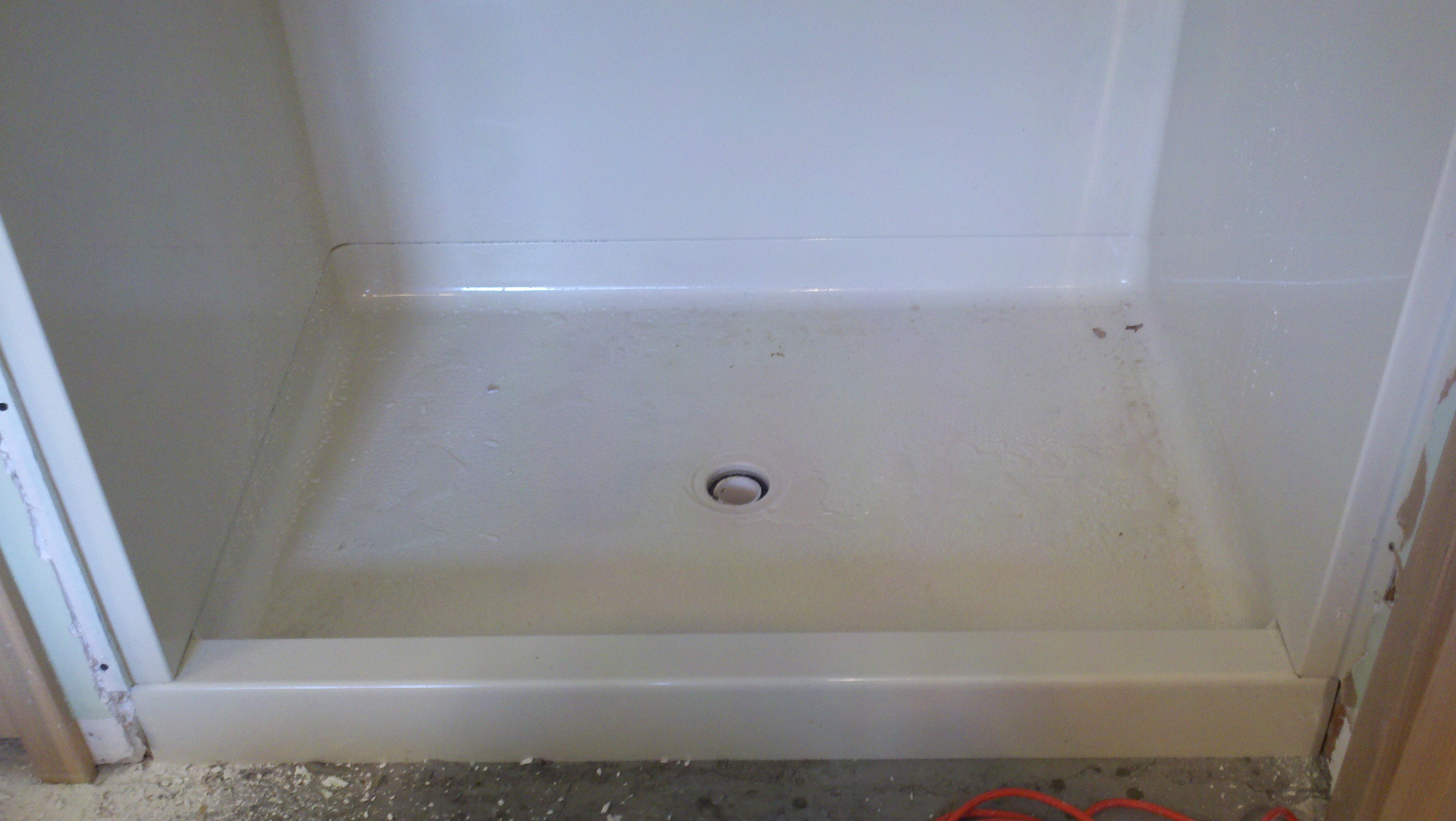

After the floor was clear of all types of restrictive debris, ¼” fiberock was chosen to strengthen the wood floor and provide an insulating barrier for the heat coils. The fiberock laying process provided some additional insight into the possible additional locations which could provide additional pleasure and use for the heat coils. The Thermosoft heat coil configuration provided versatile possibilities for installation. The coils had innovative engineering and design to allow for disassembles into a single flexible heat wire. The single wire could be route around small ledges and steps. The decision was made to install the coil around the power tub. Following the installation of the fiberock and Thermosoft coil routing, the programmable thermostat needed to be installed. The thermostat was chosen to be installed next to the power tub timer control. The thermostat required the installation of a thermometer to regulate the temperature of the coils. An additional thermometer was installed next to the original for backup tactics on the floor below the thermostat. The 115 VAC power was connected to the tub power location, under the wood surround. The following five pictures provide additional insight to the completed tasks mentioned about the fiberock, Thermosoft, and thermostat.

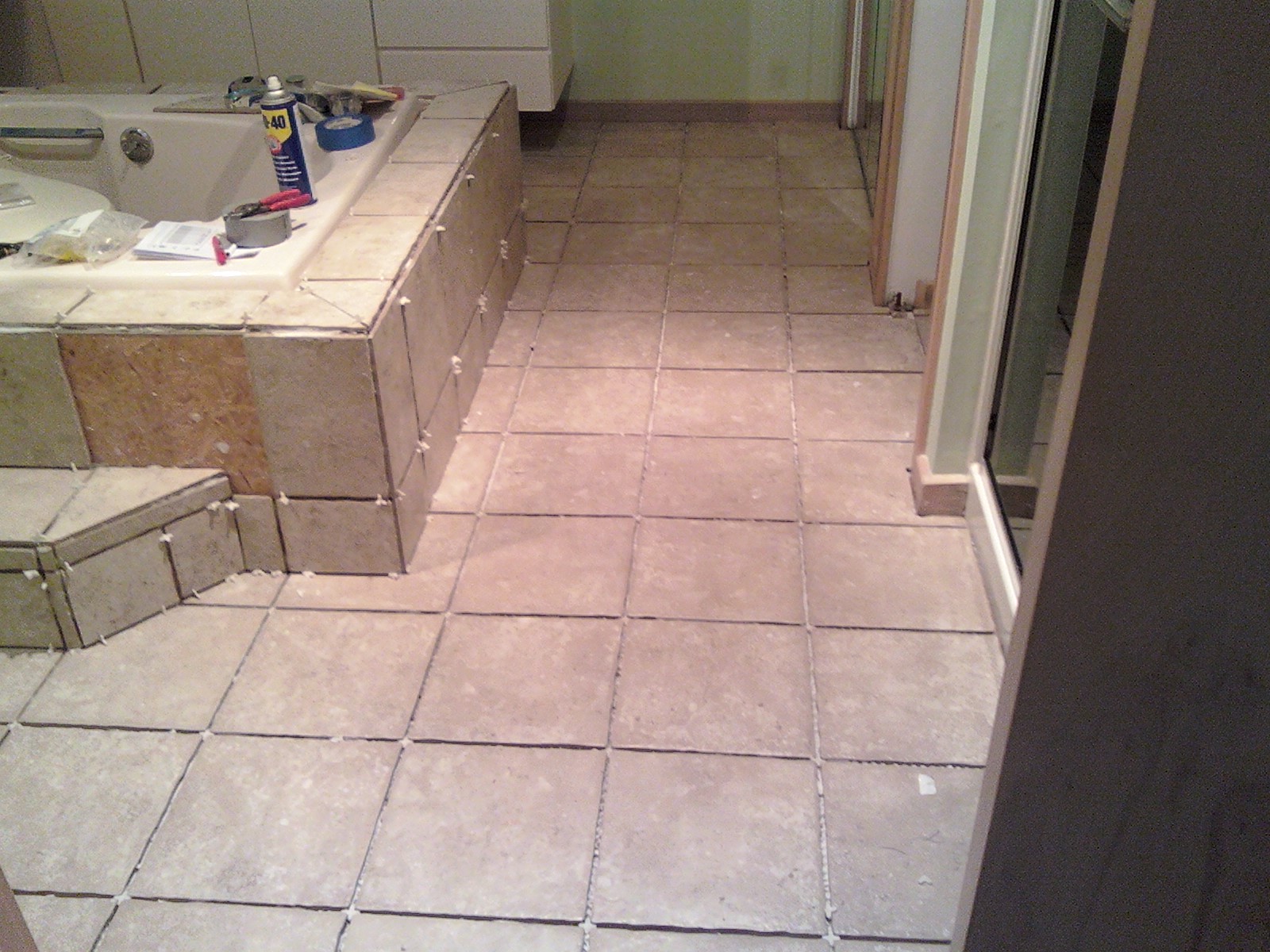

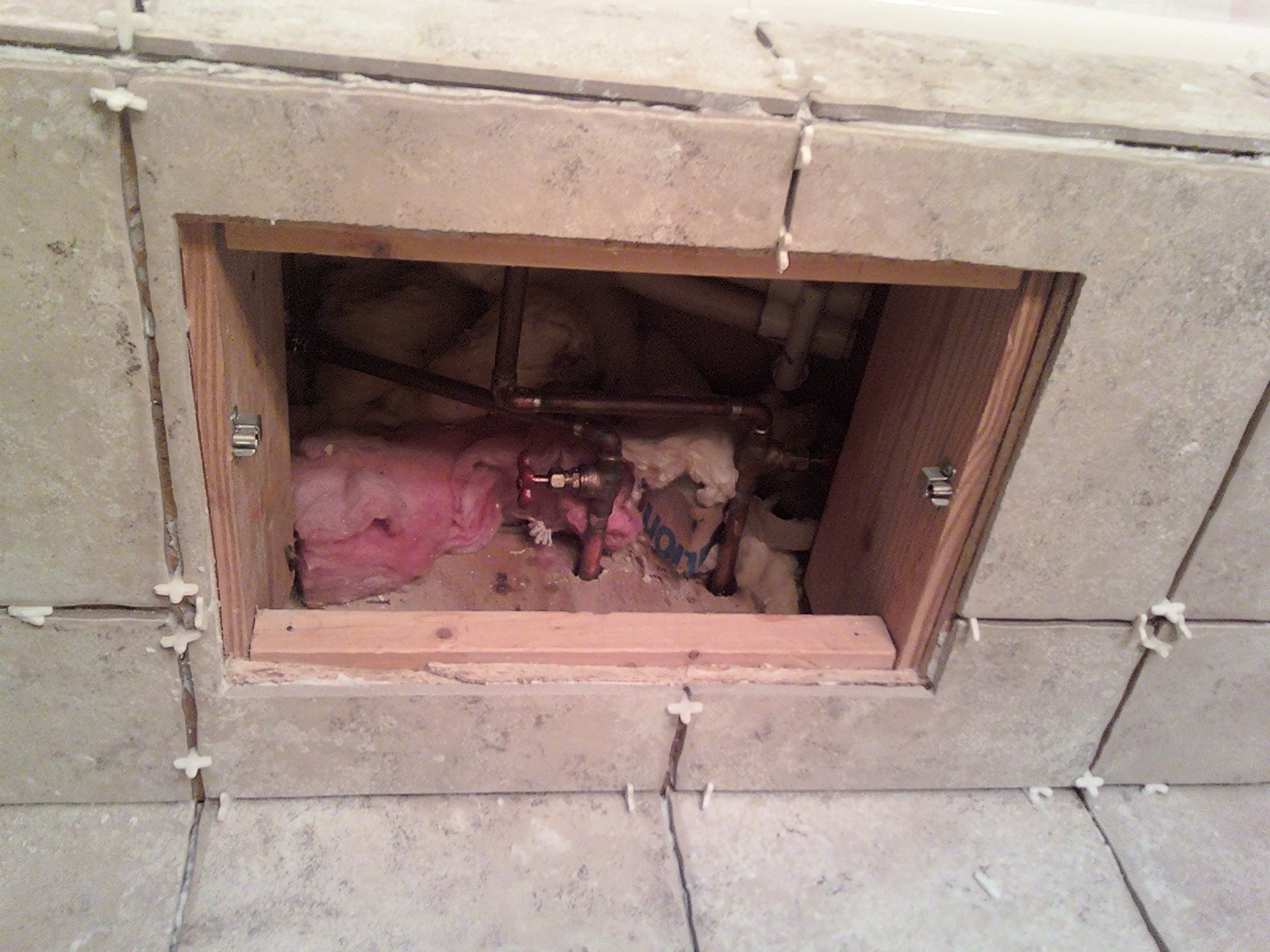

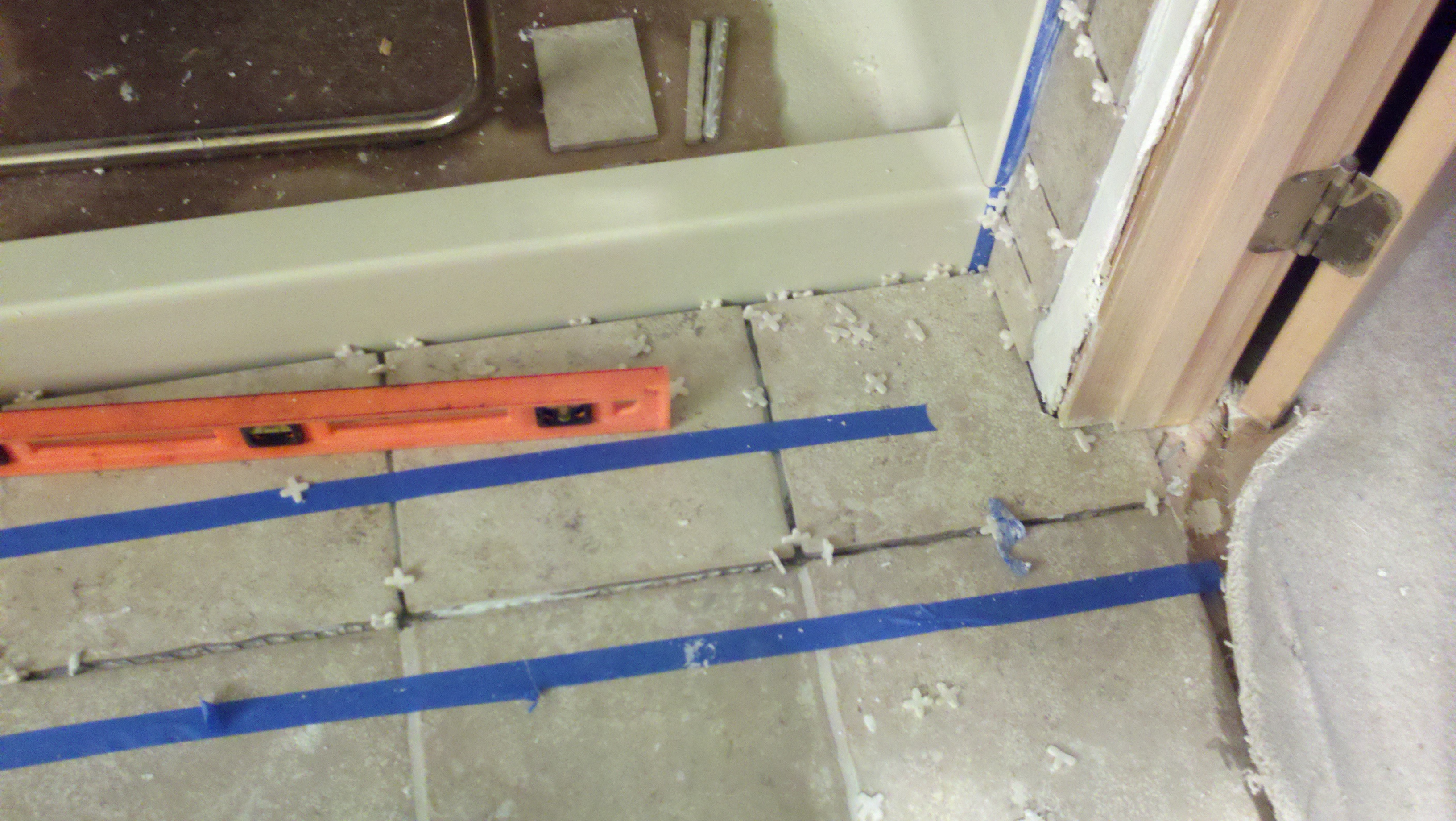

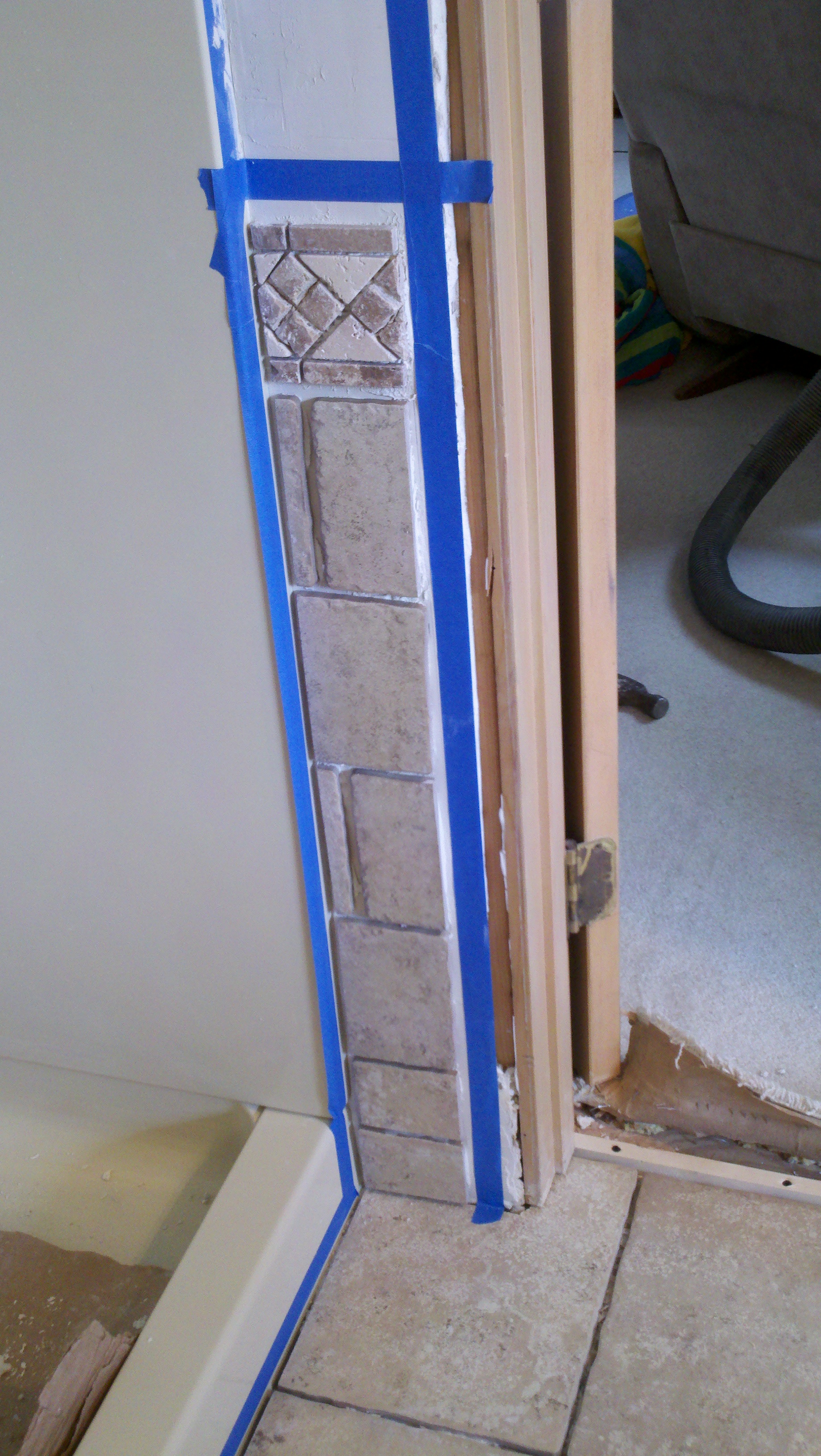

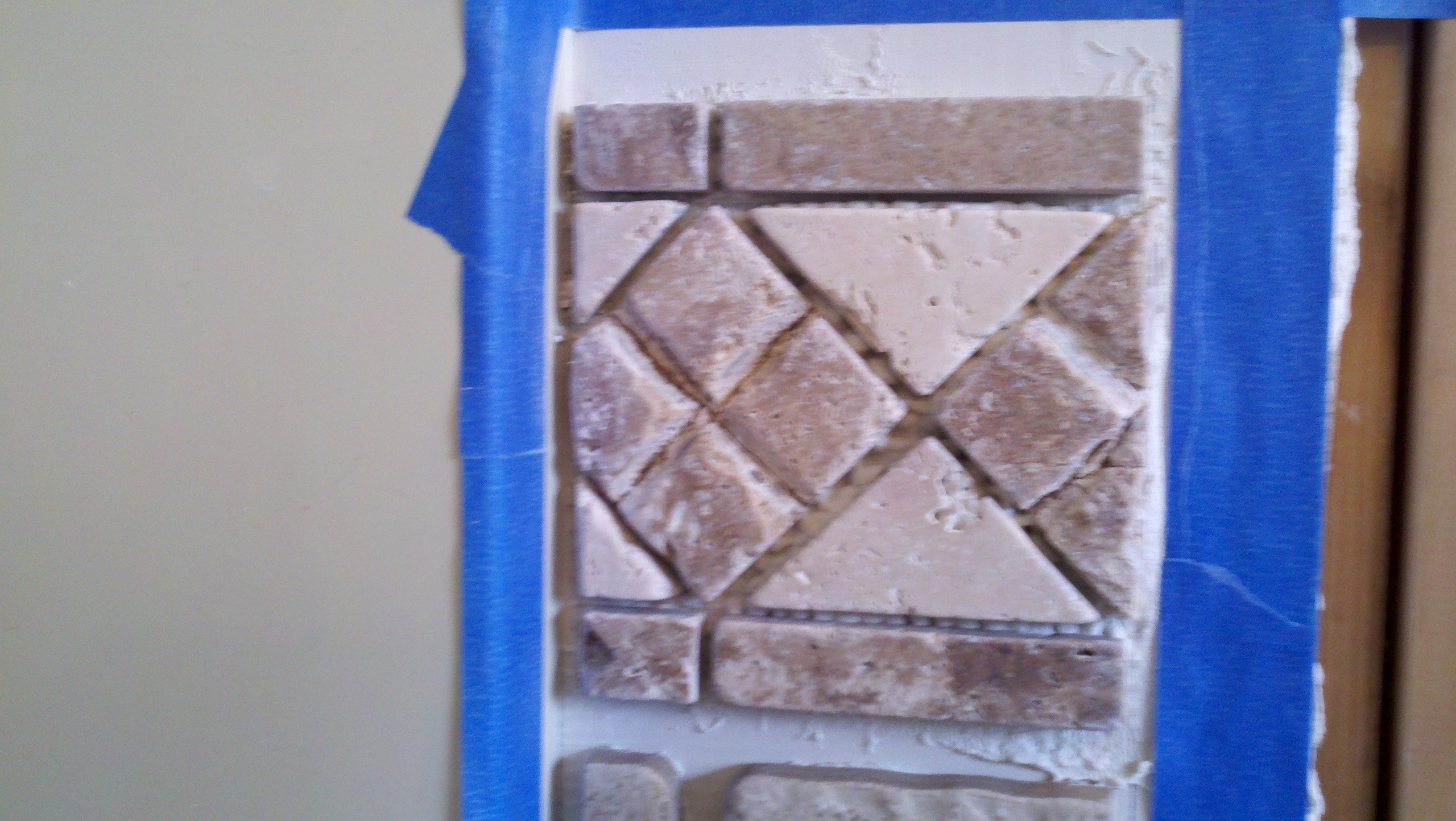

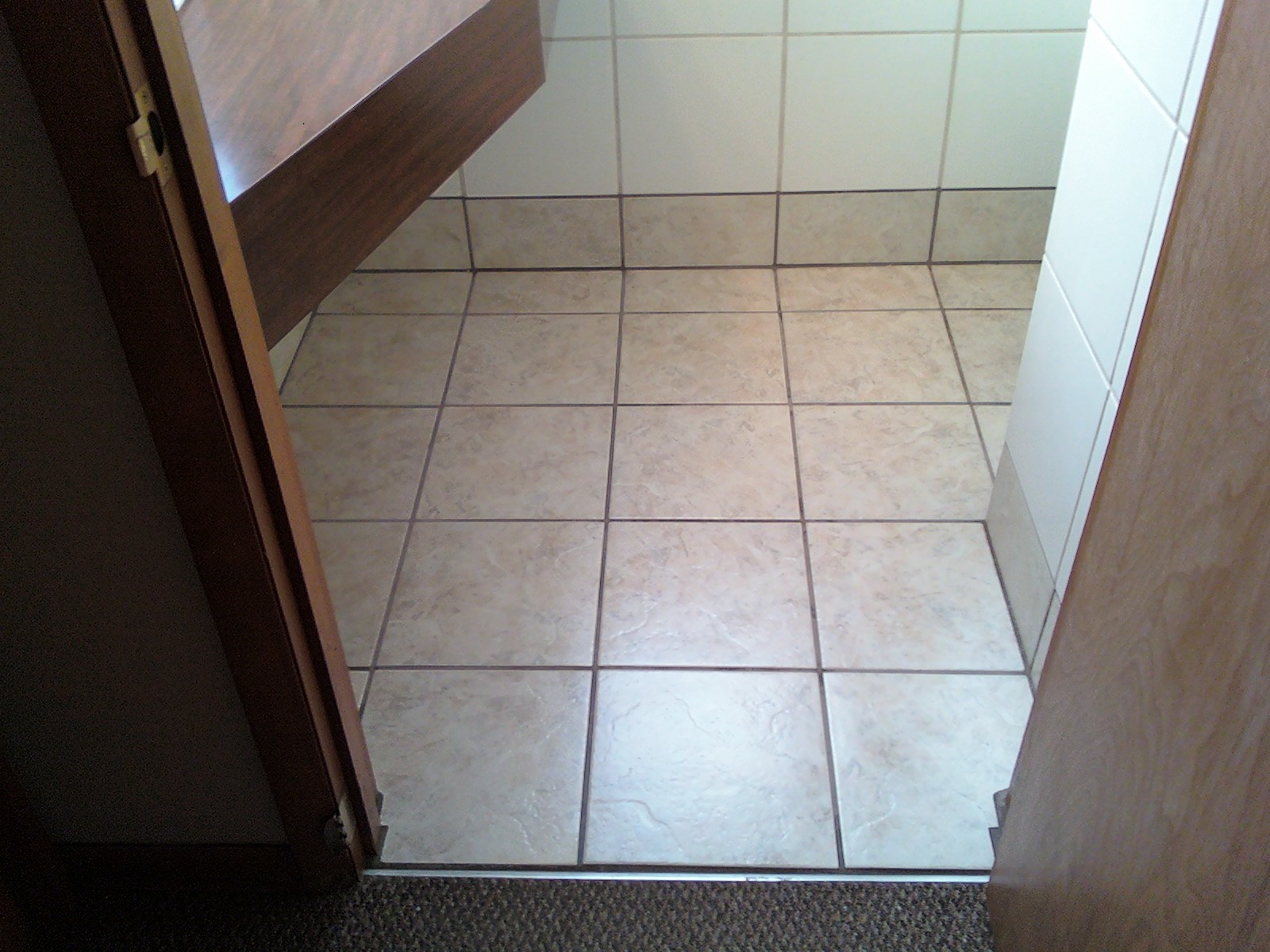

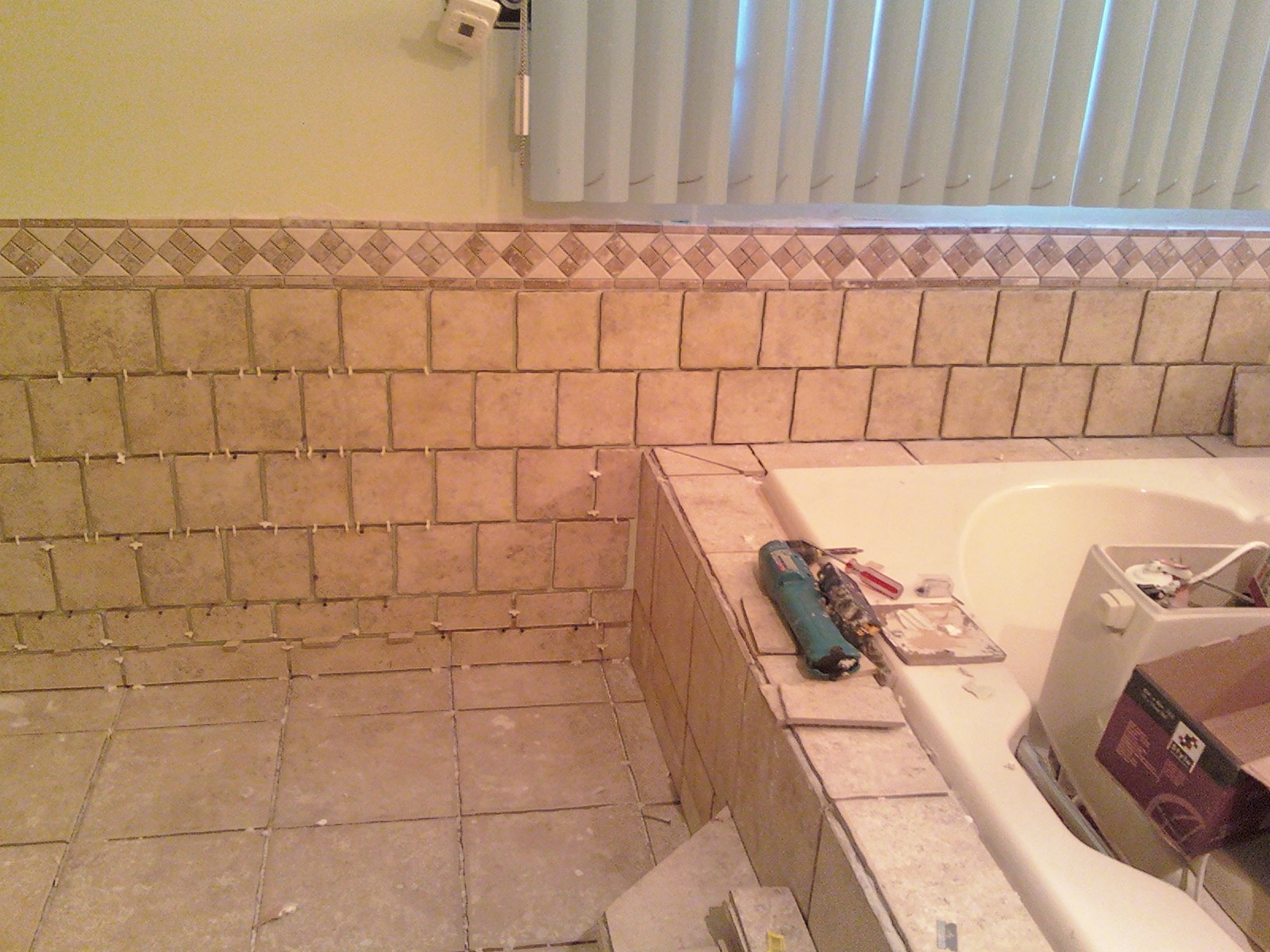

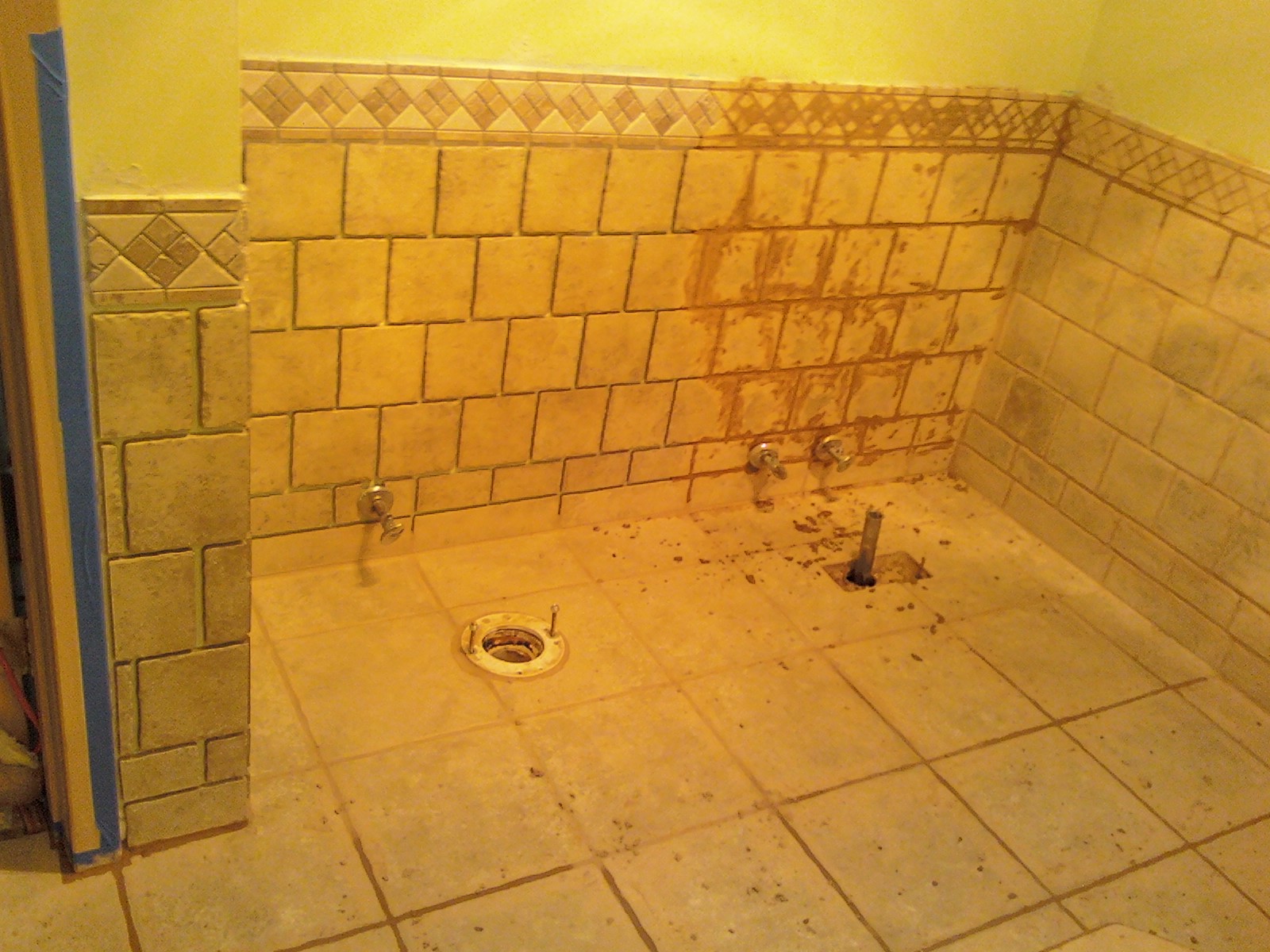

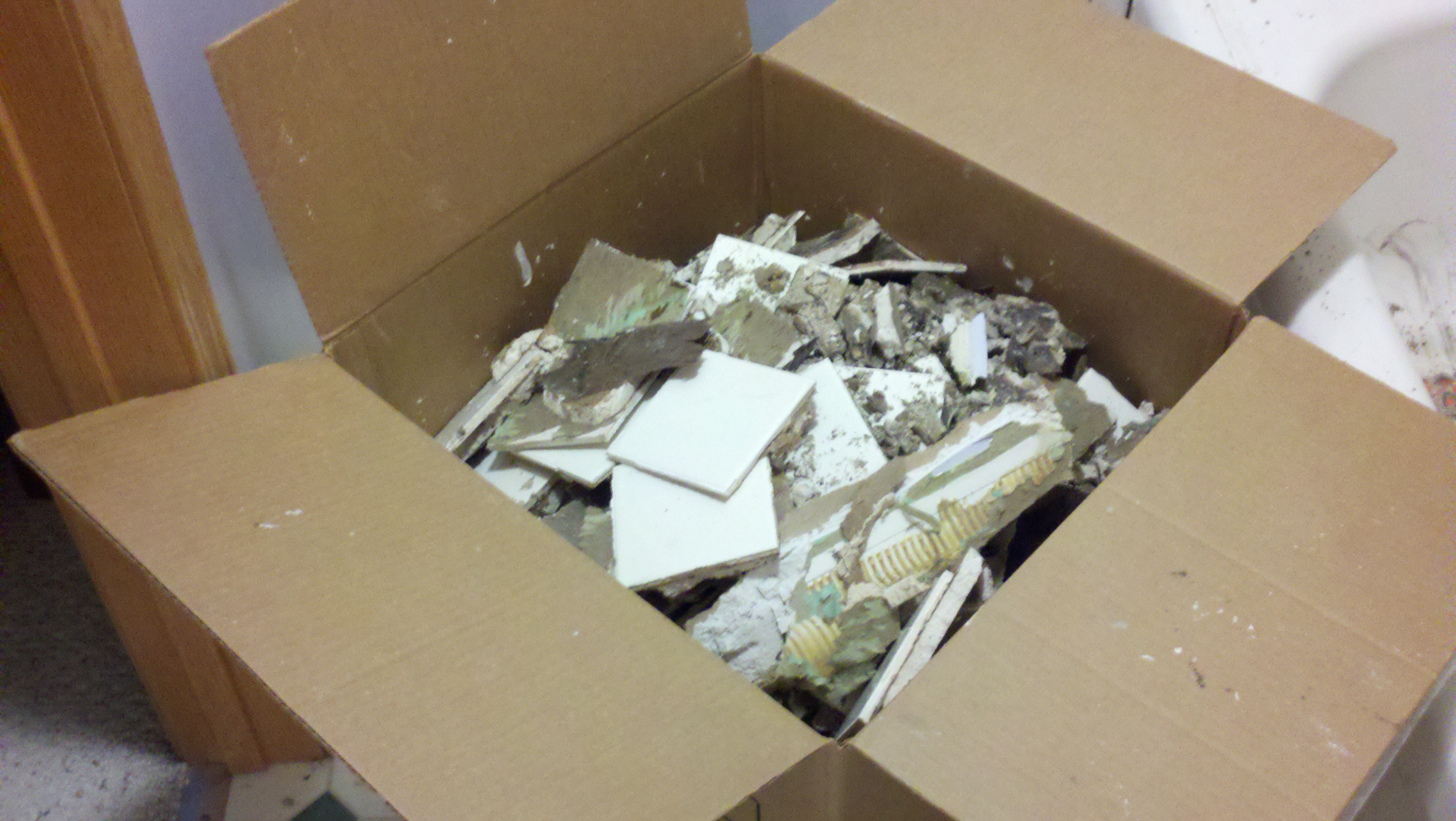

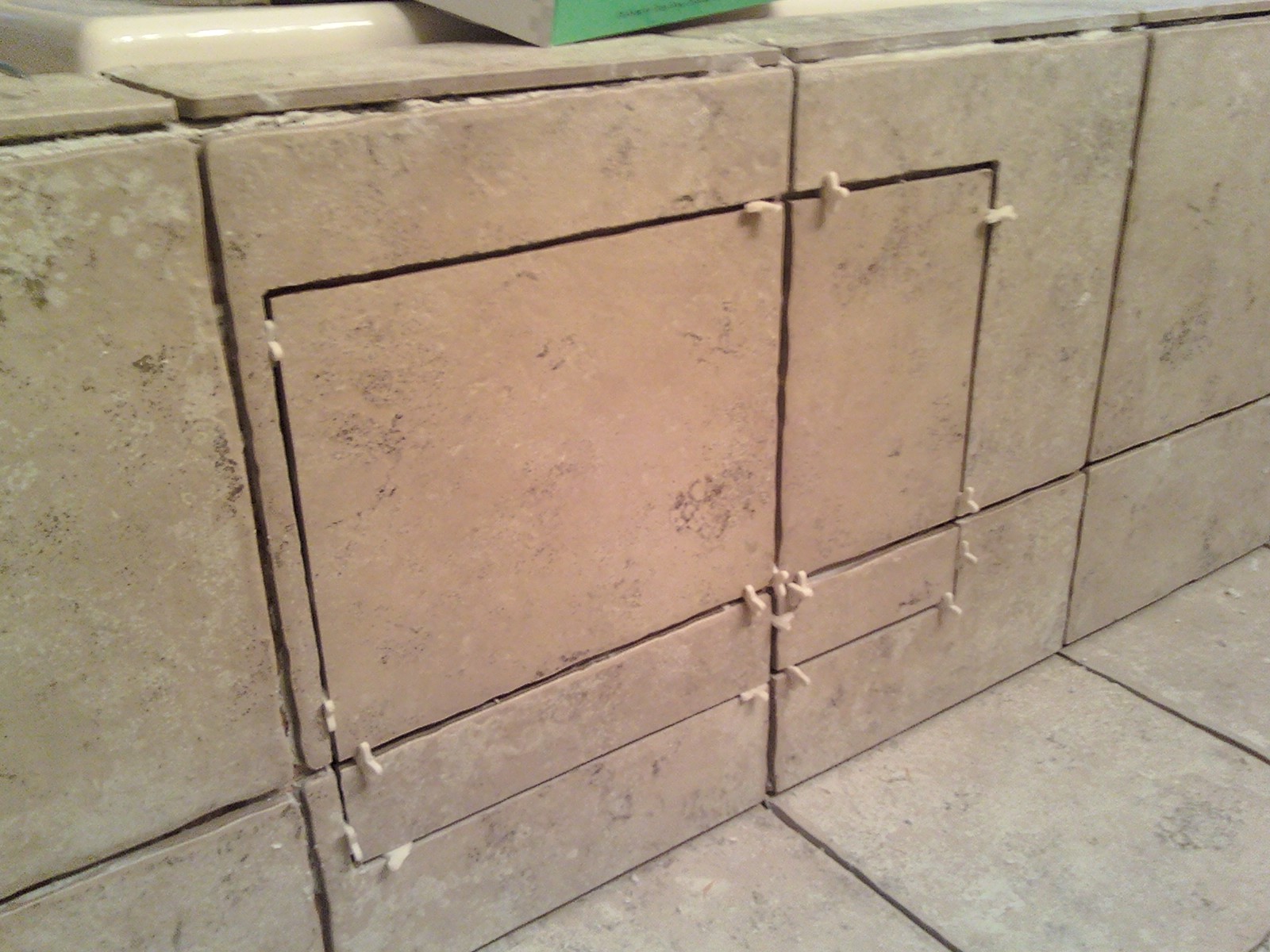

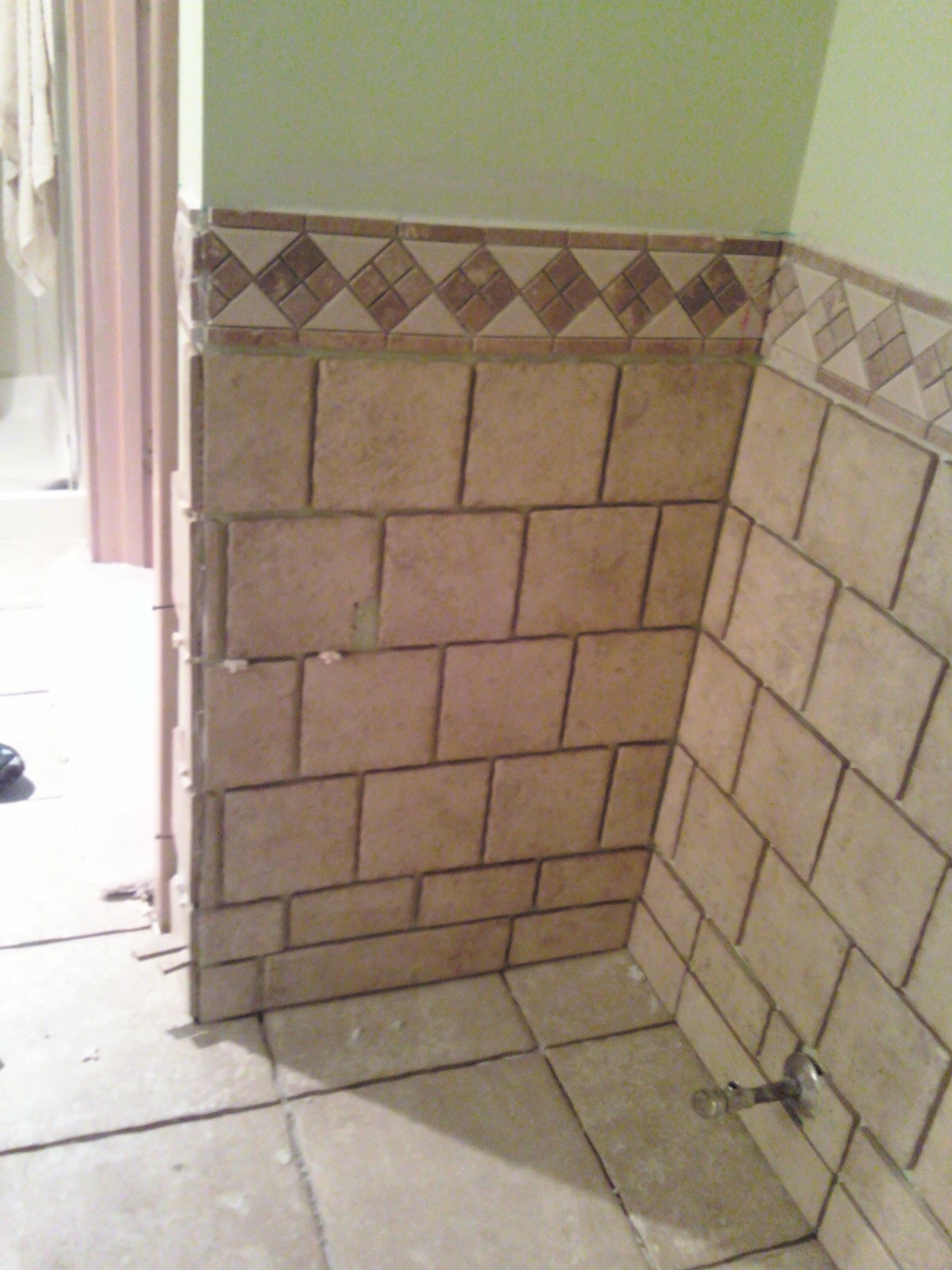

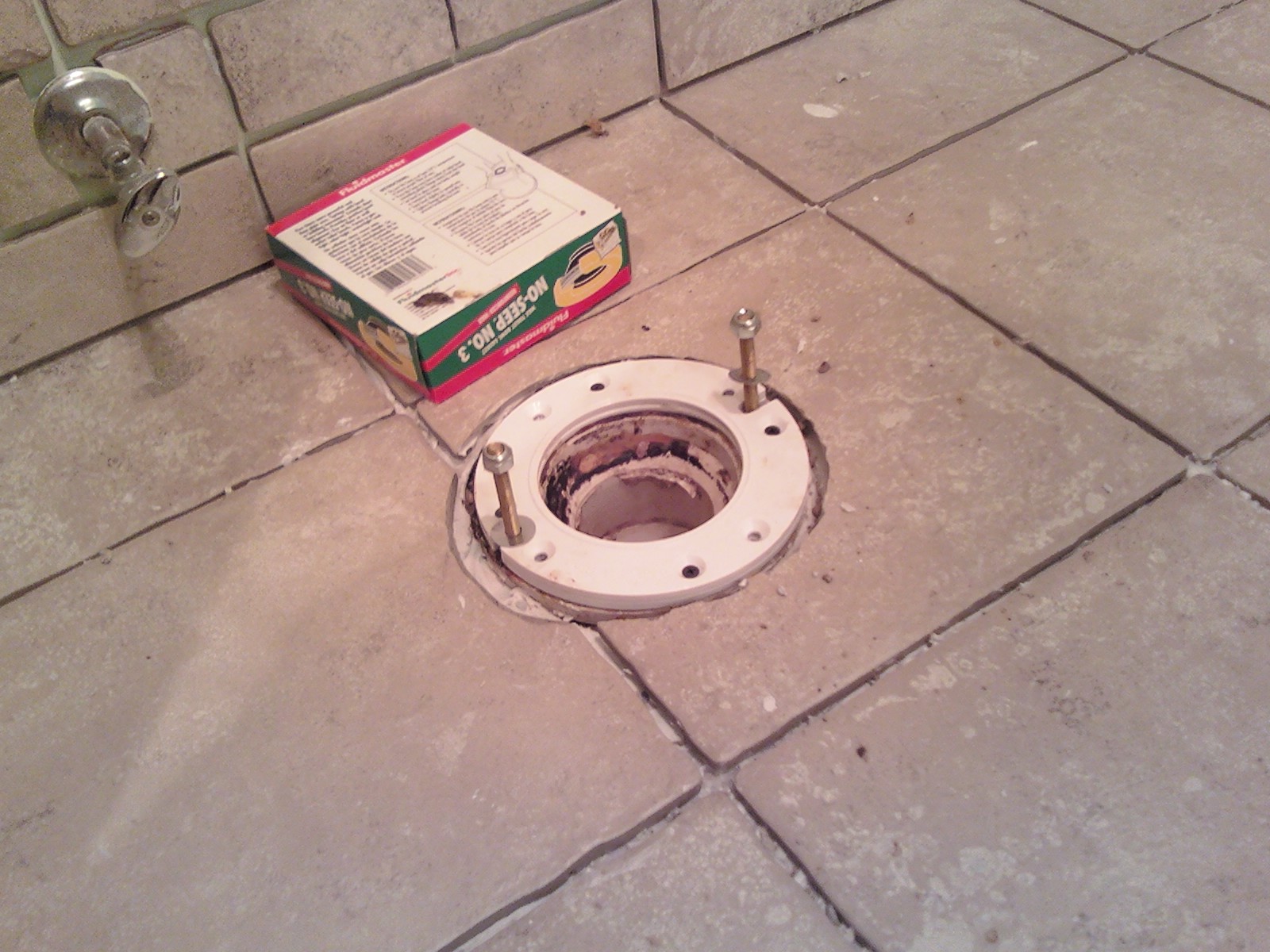

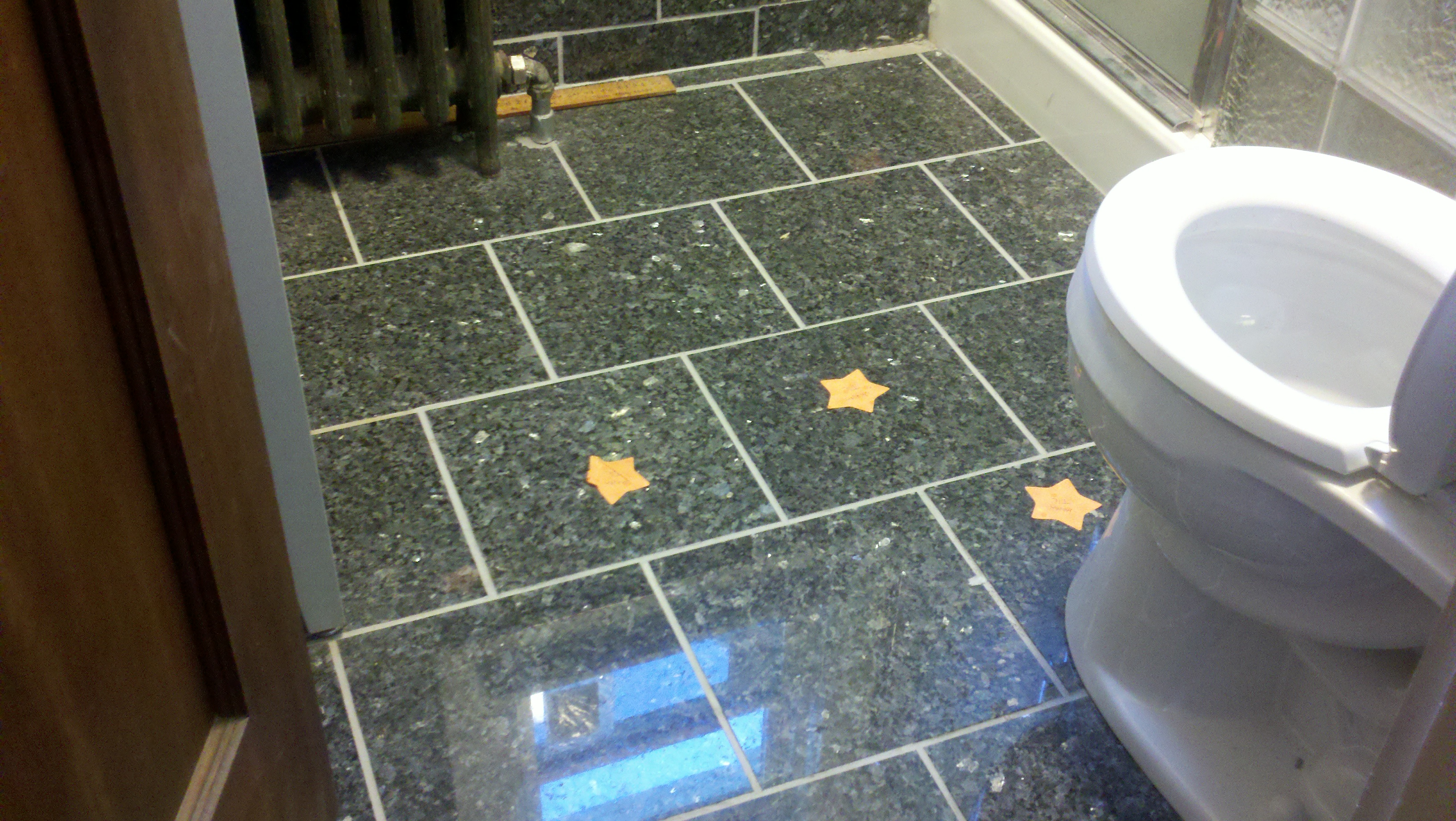

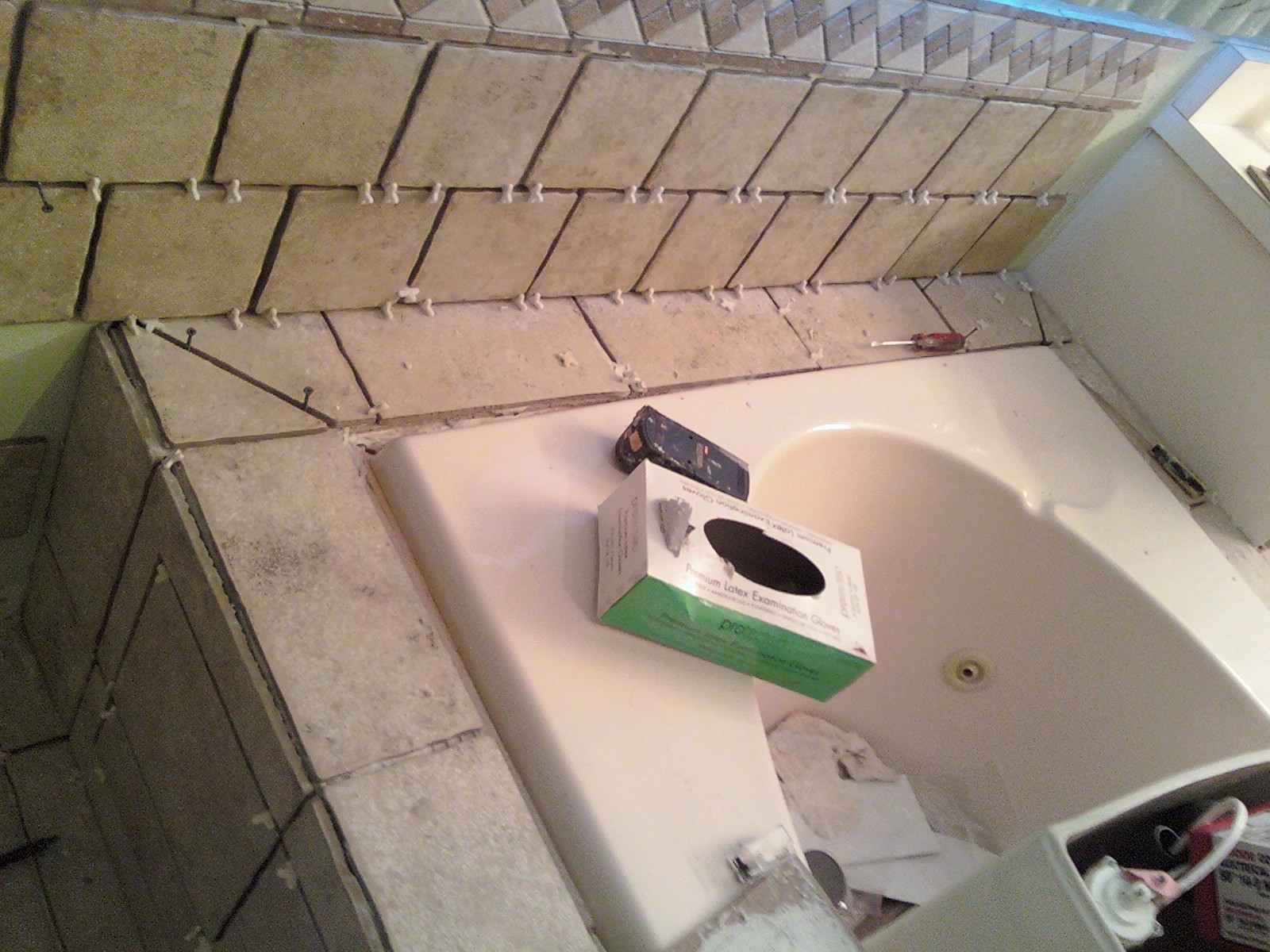

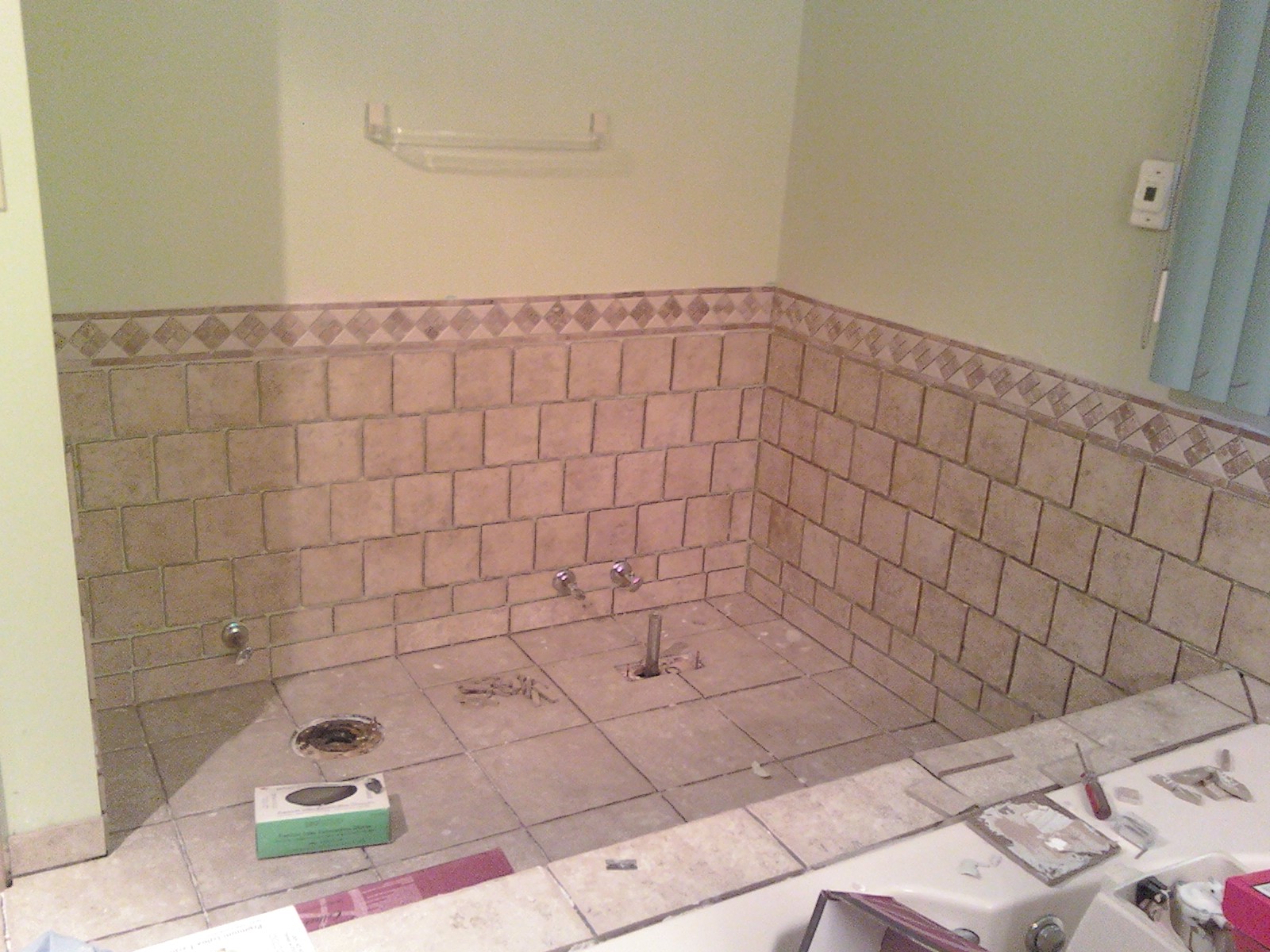

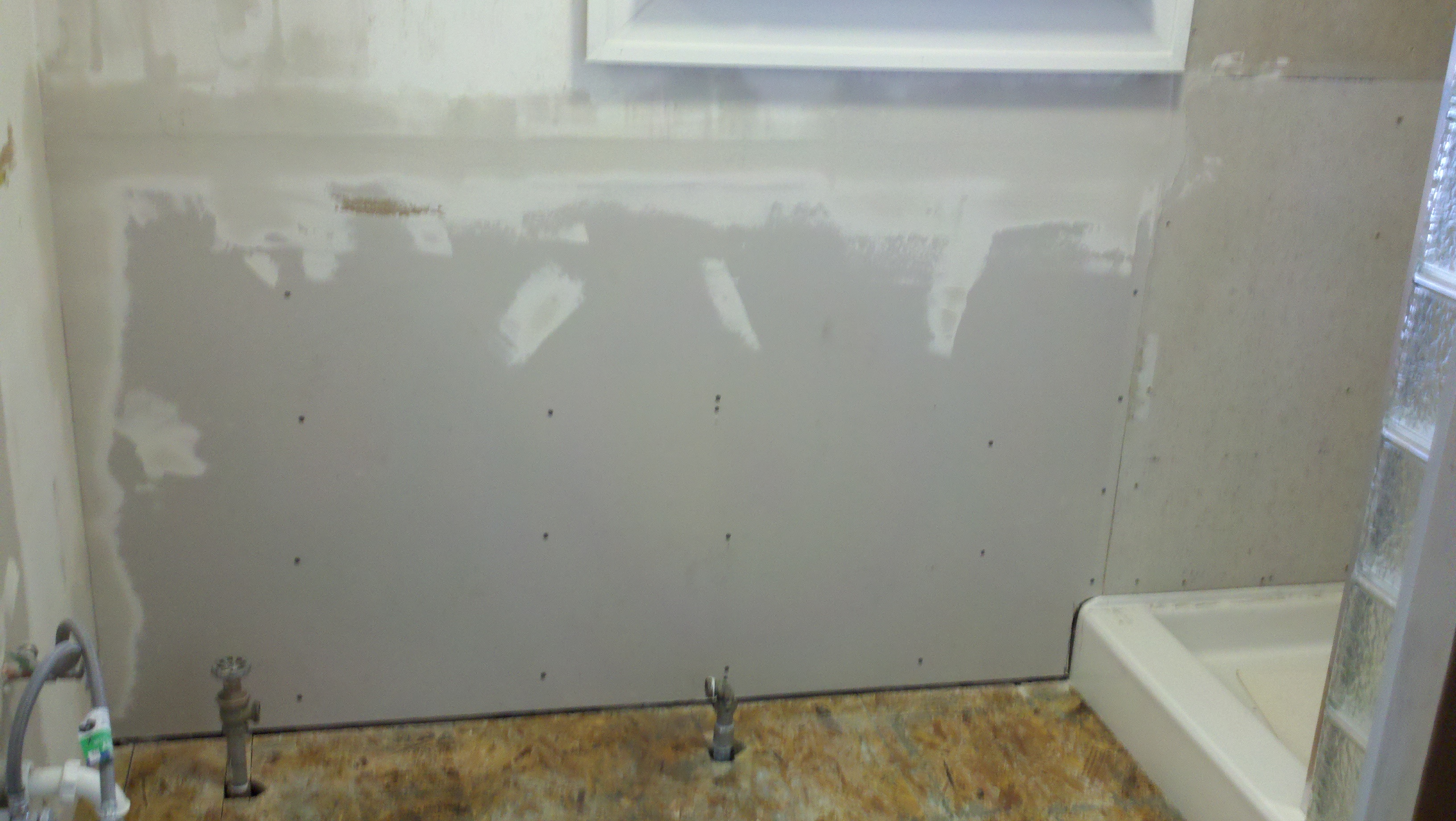

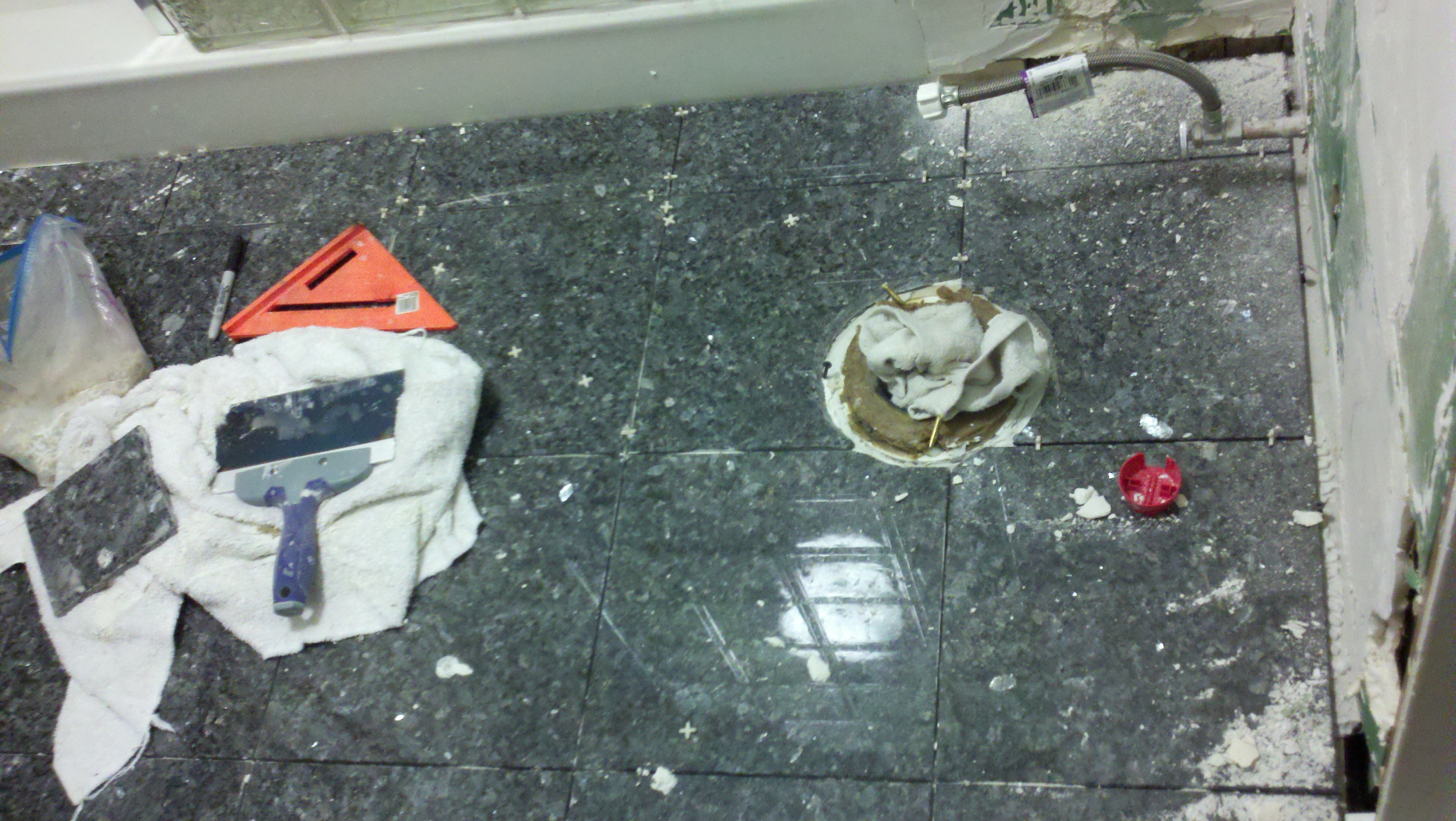

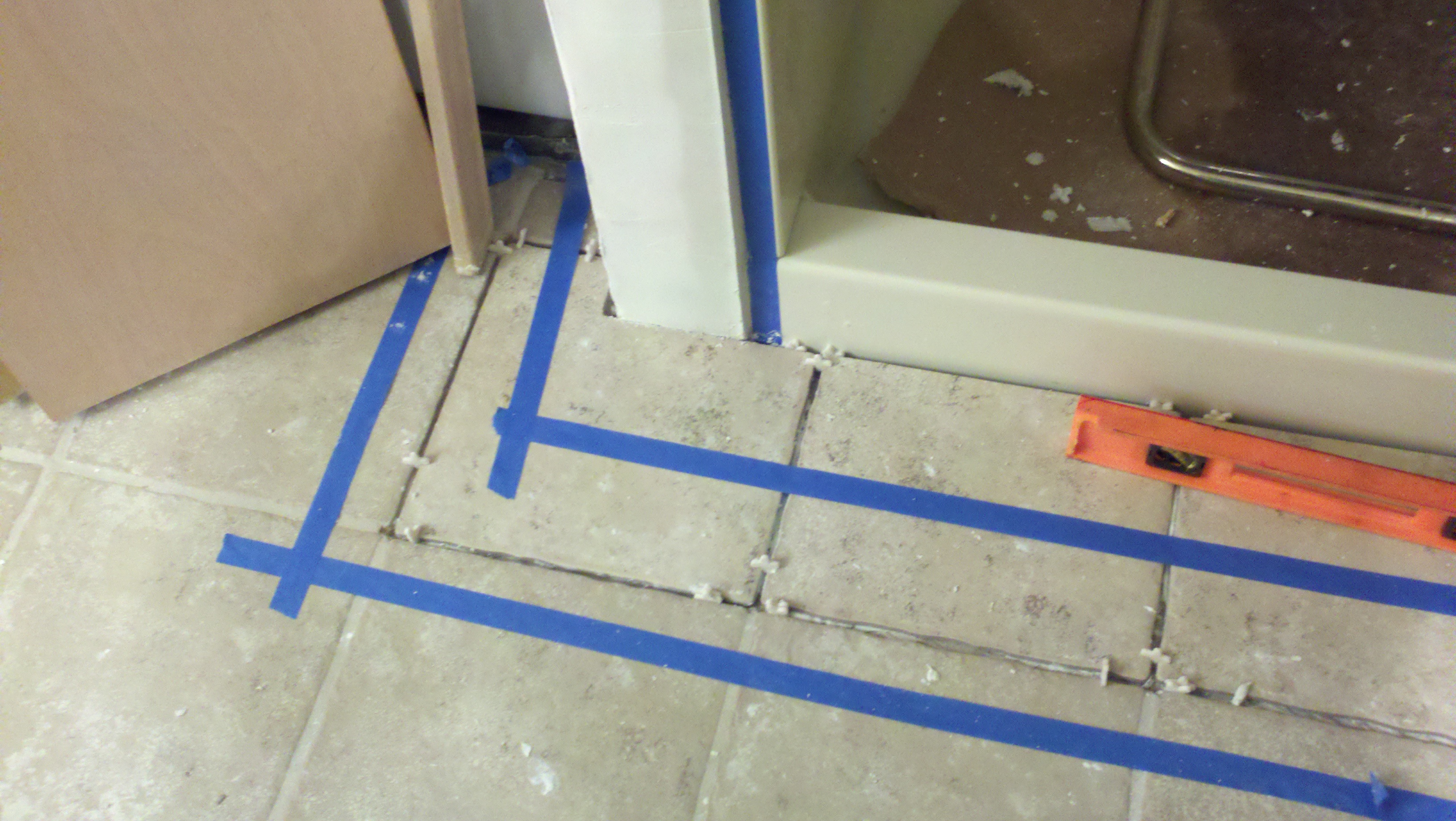

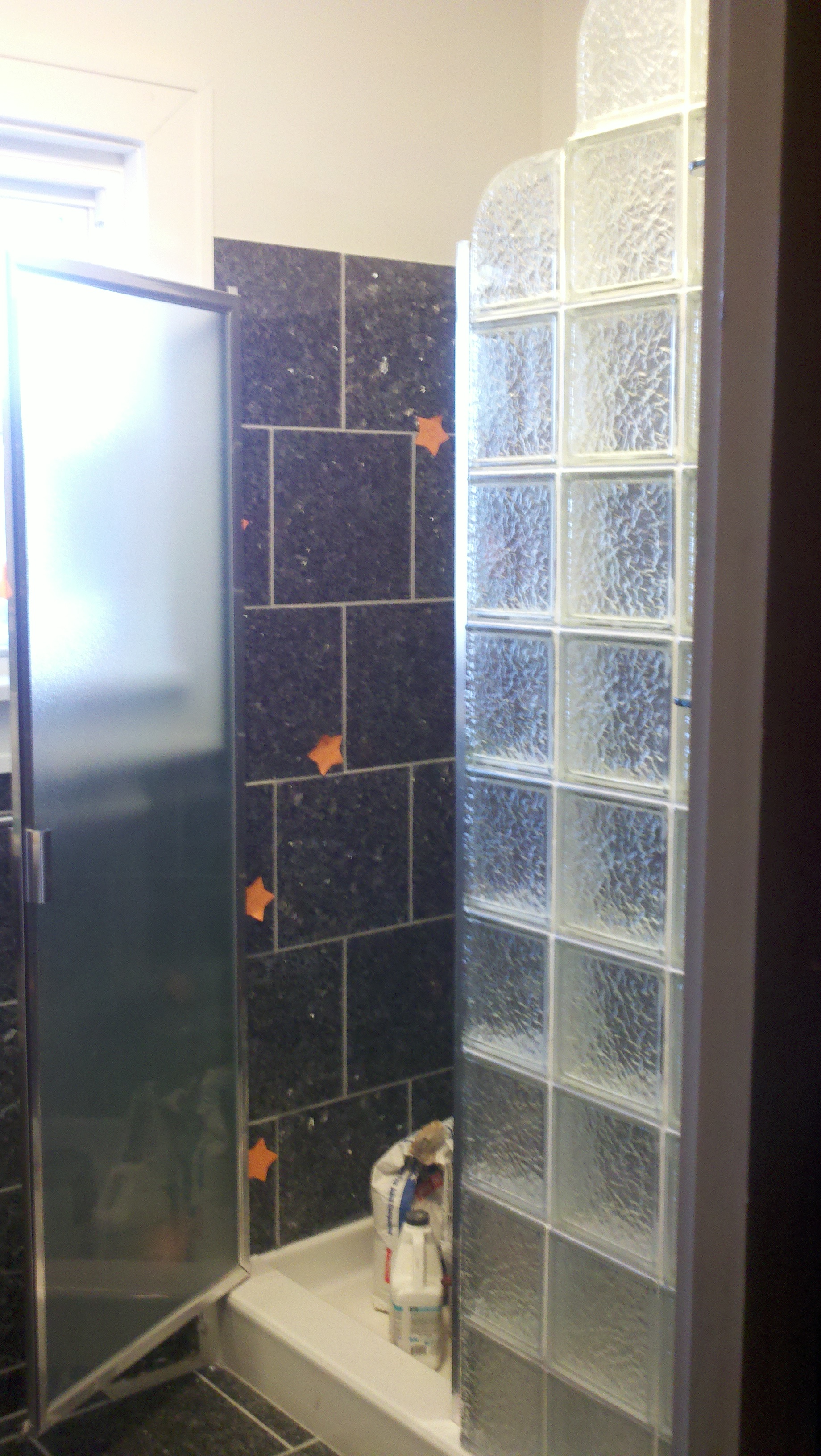

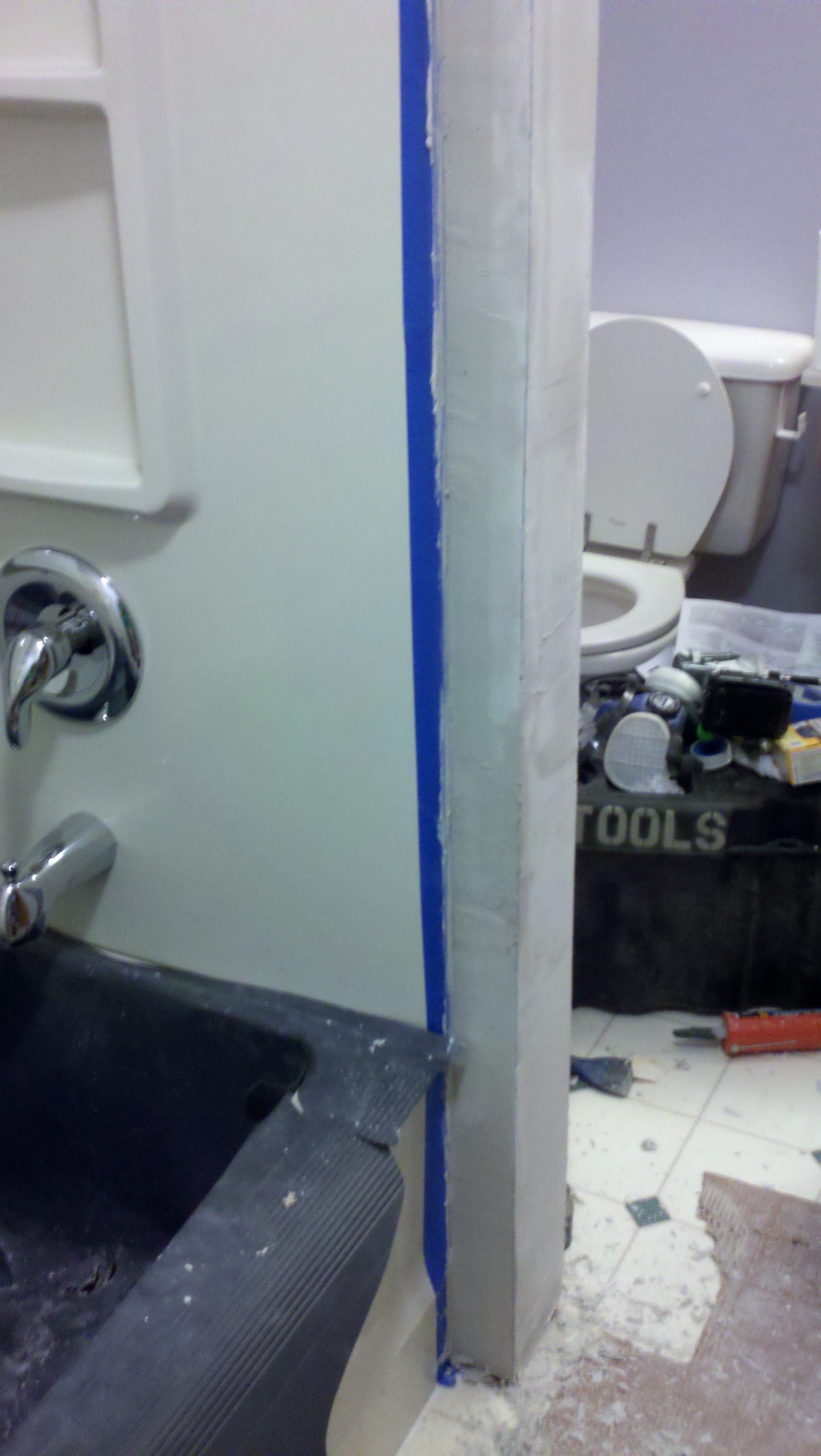

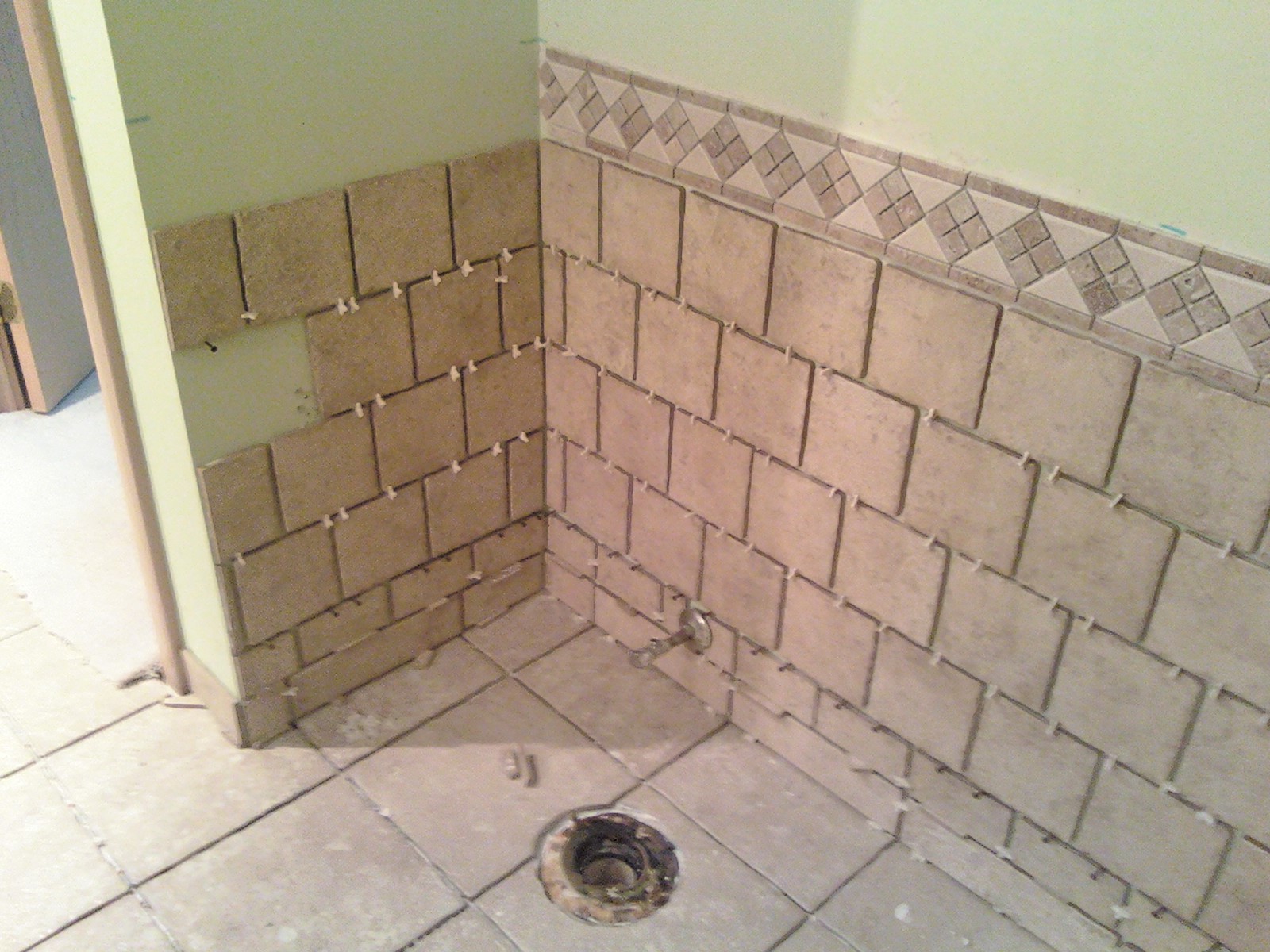

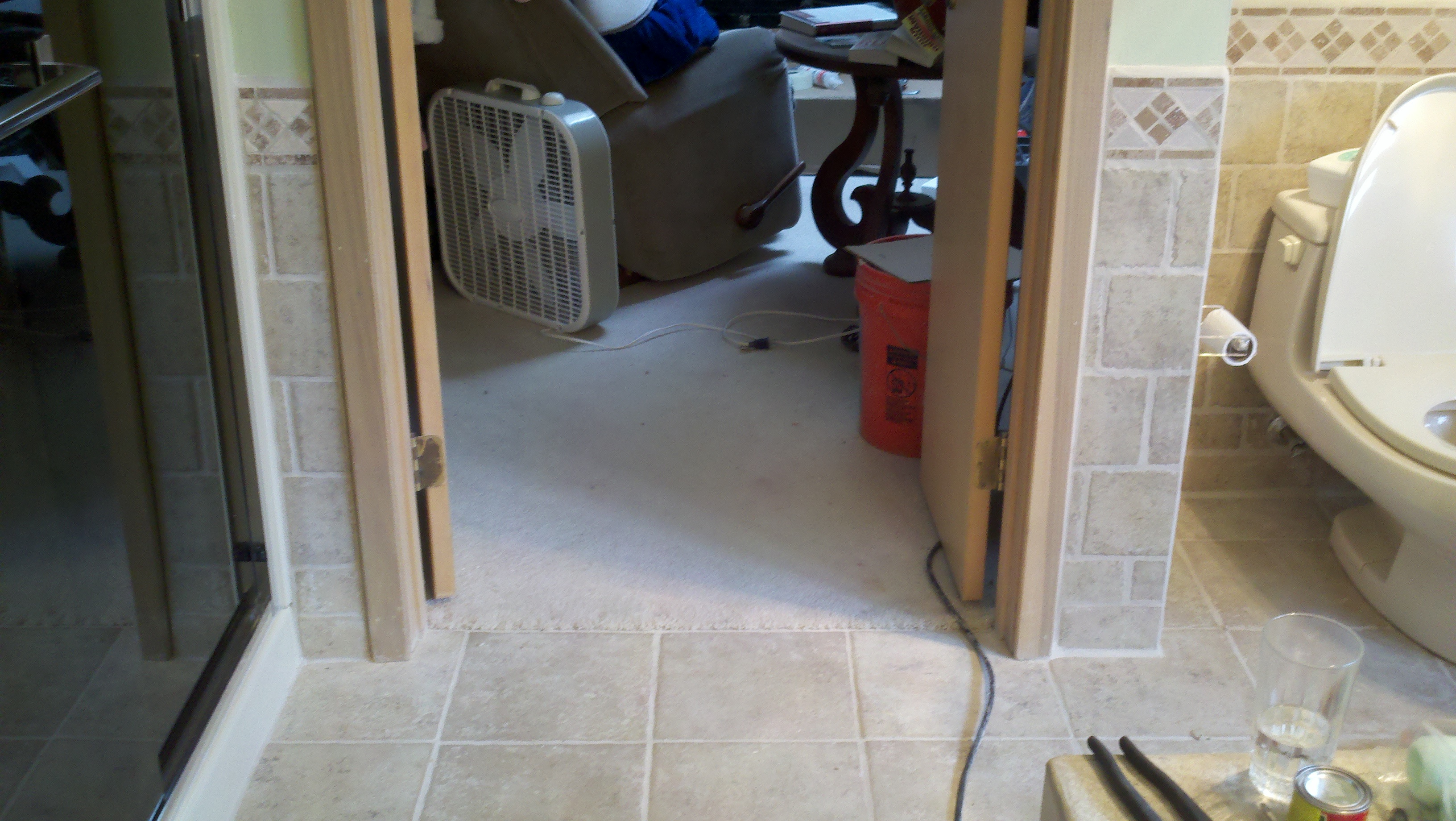

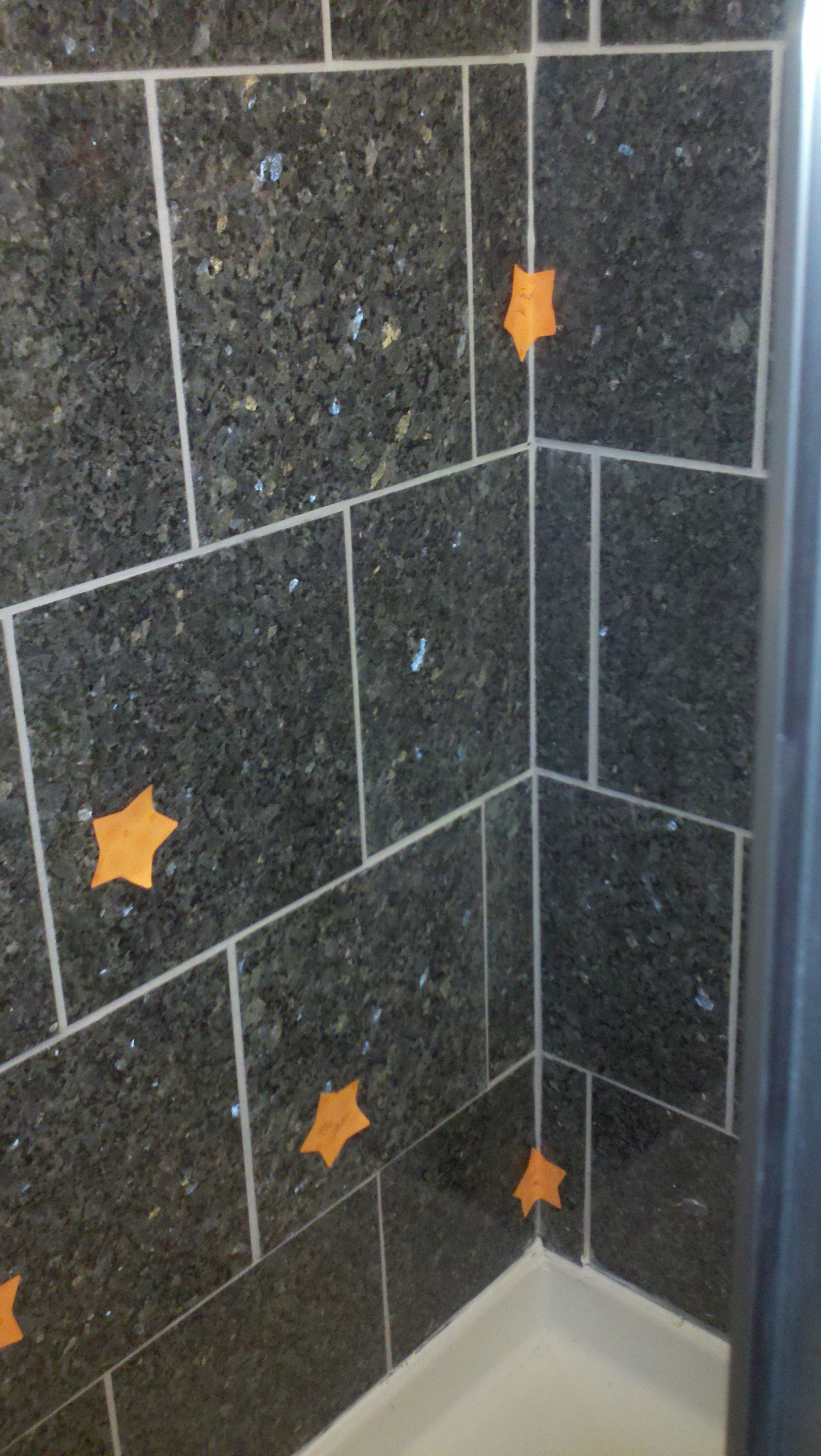

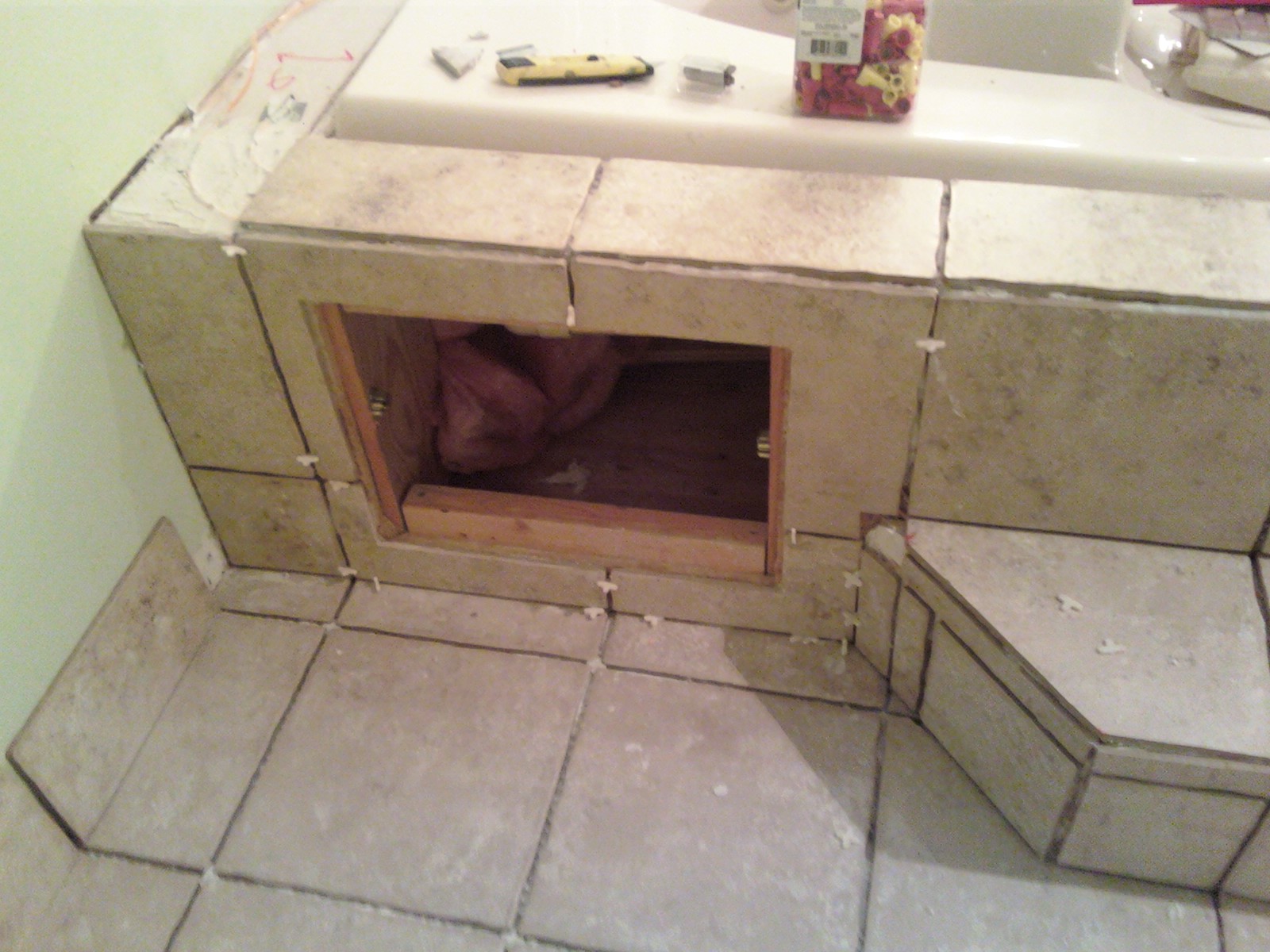

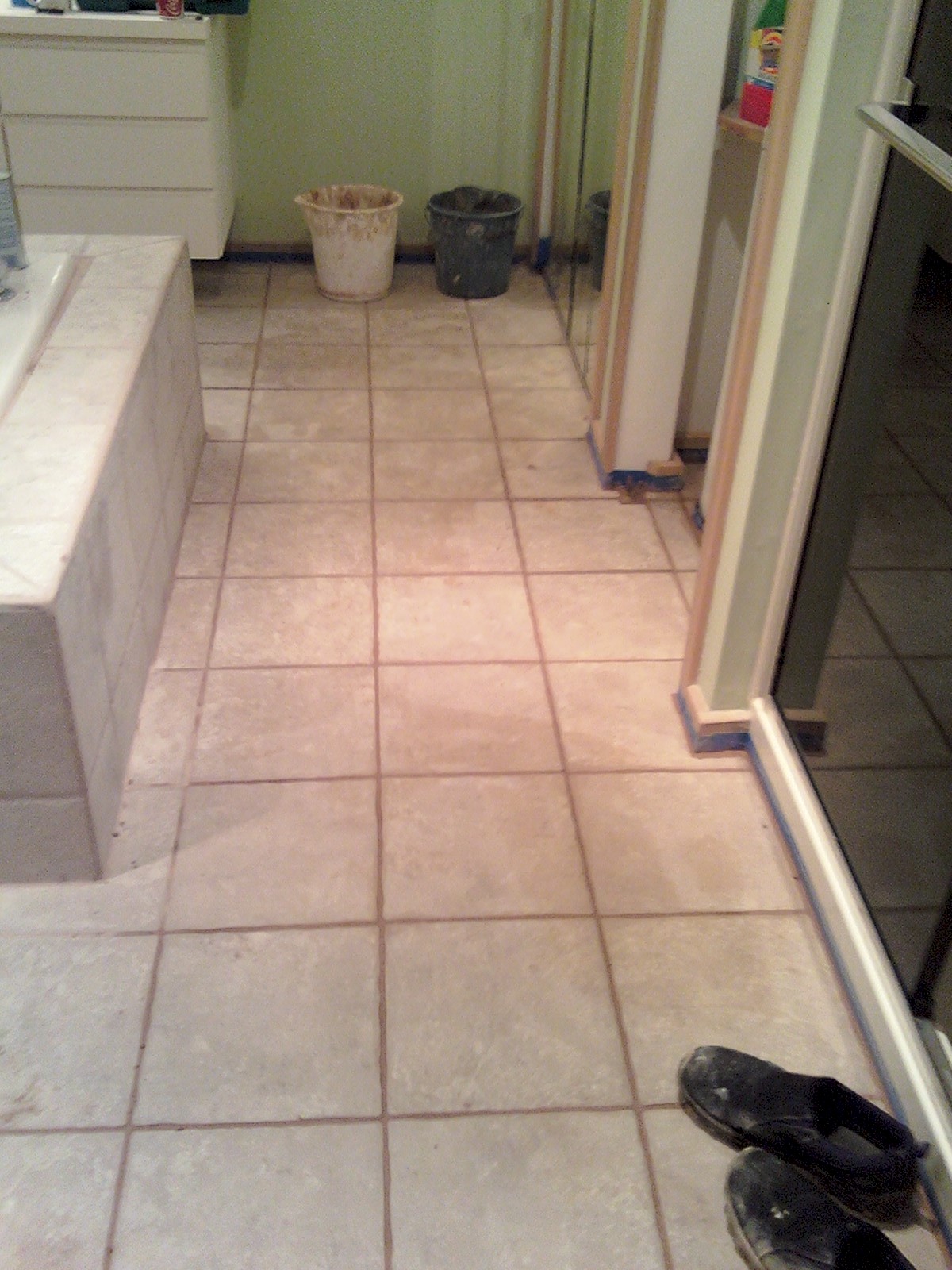

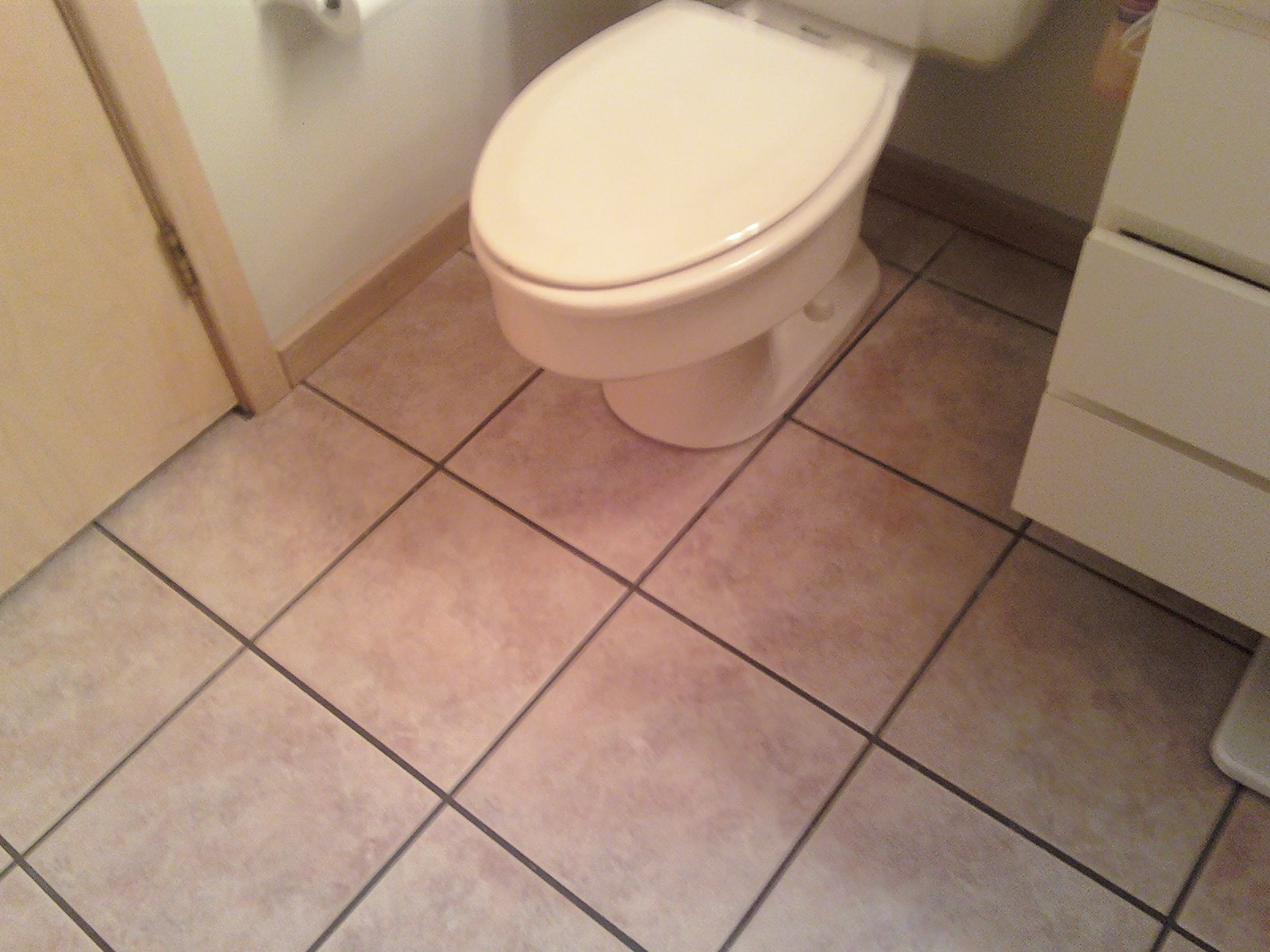

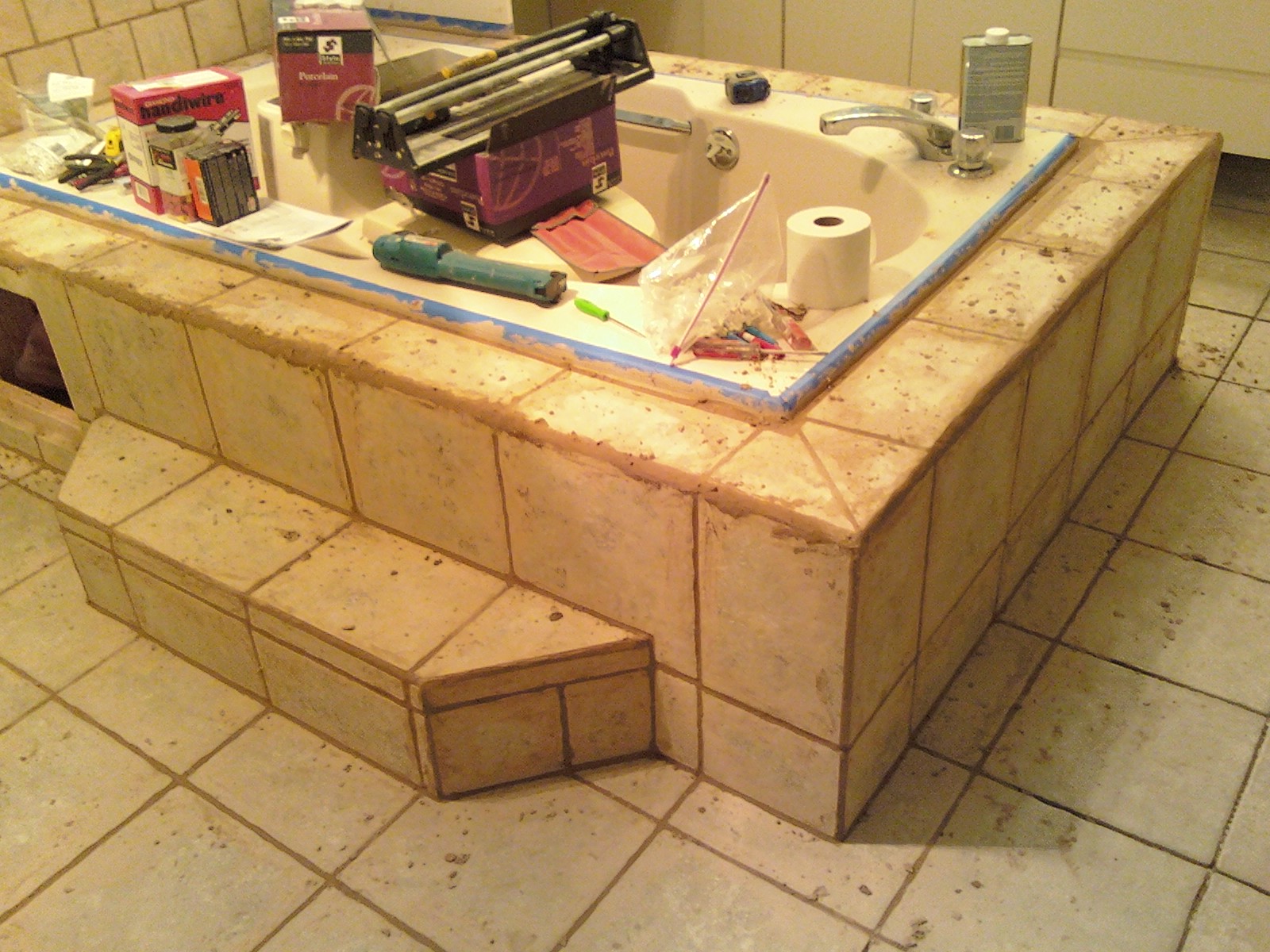

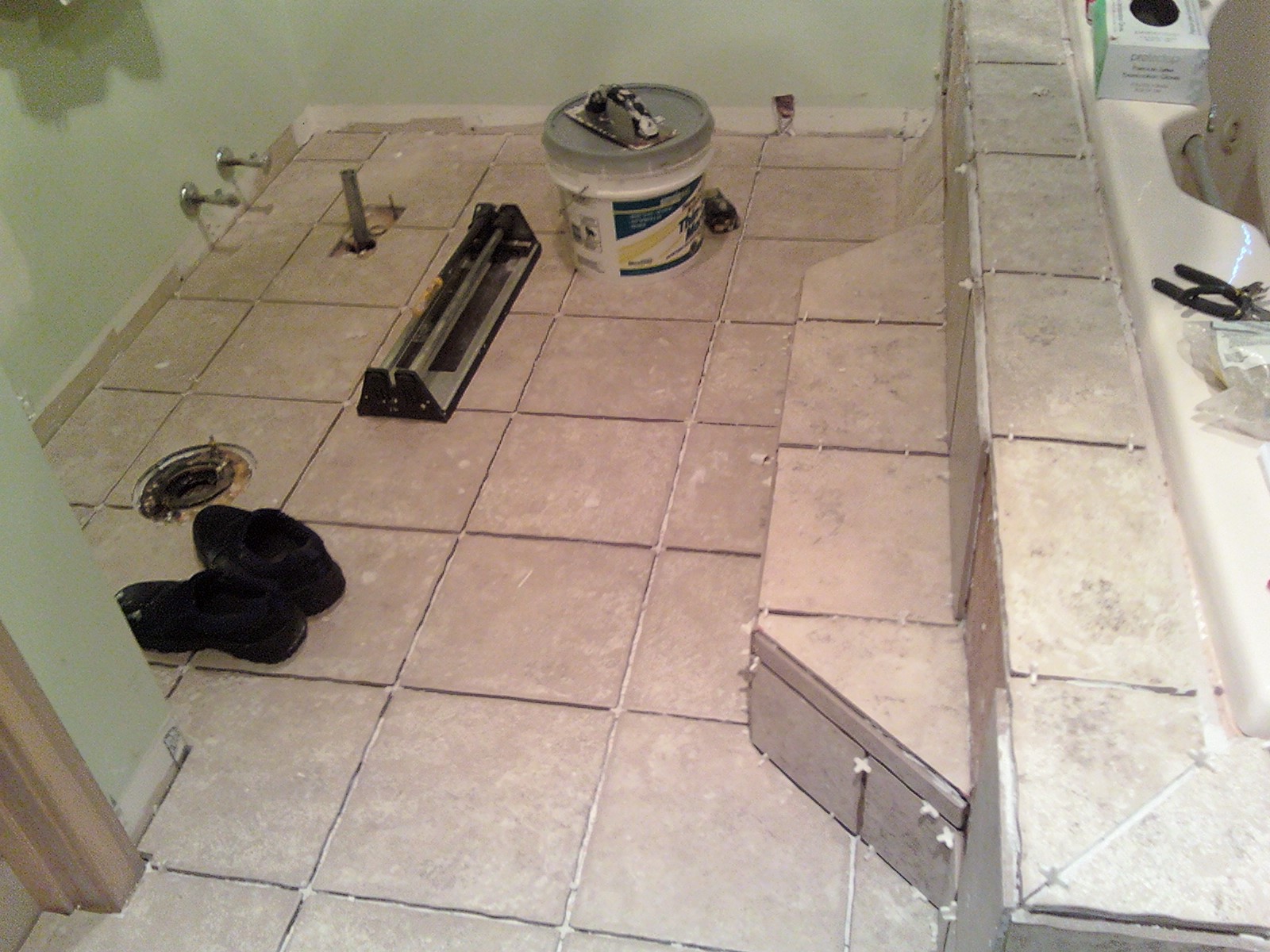

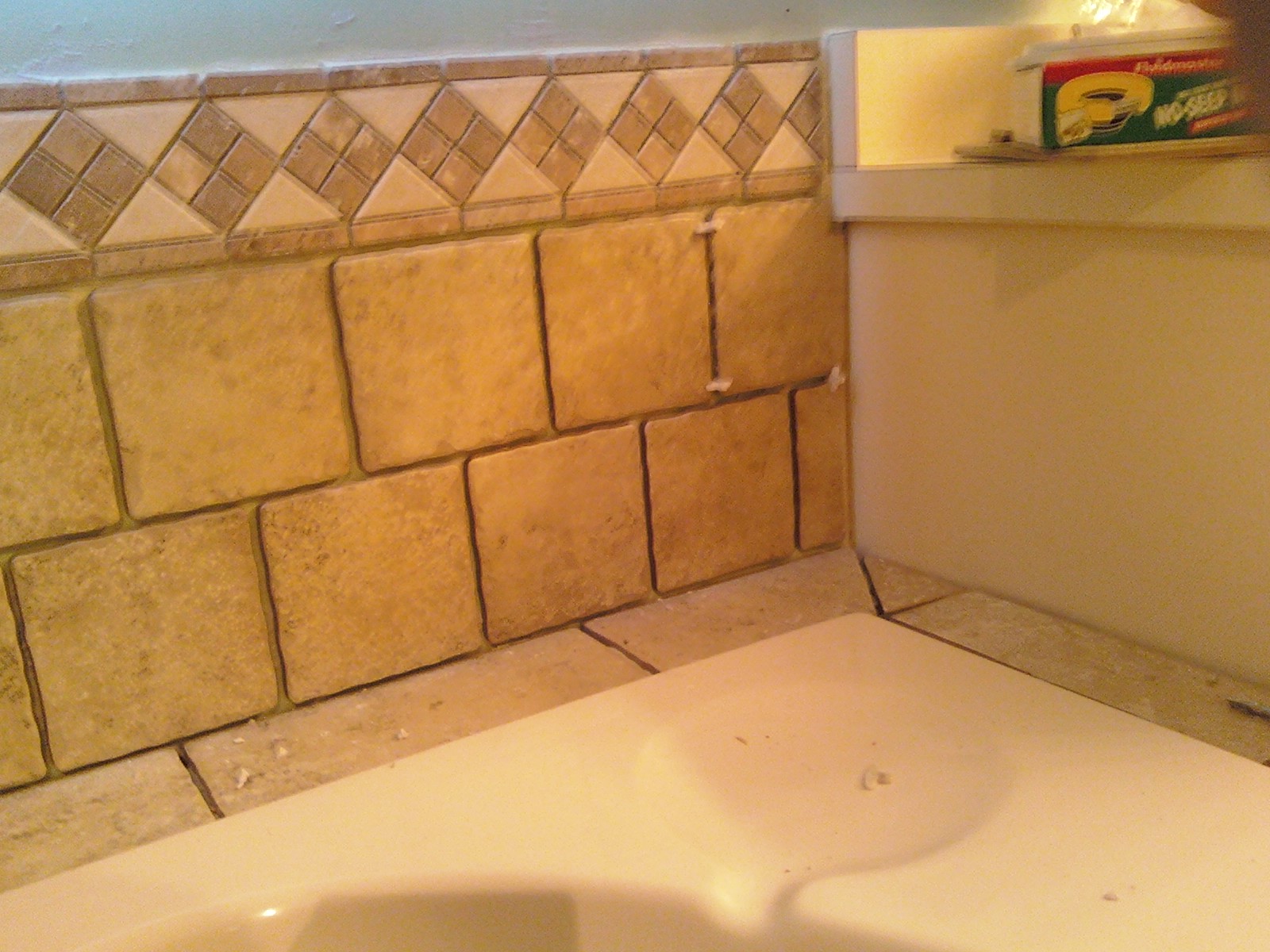

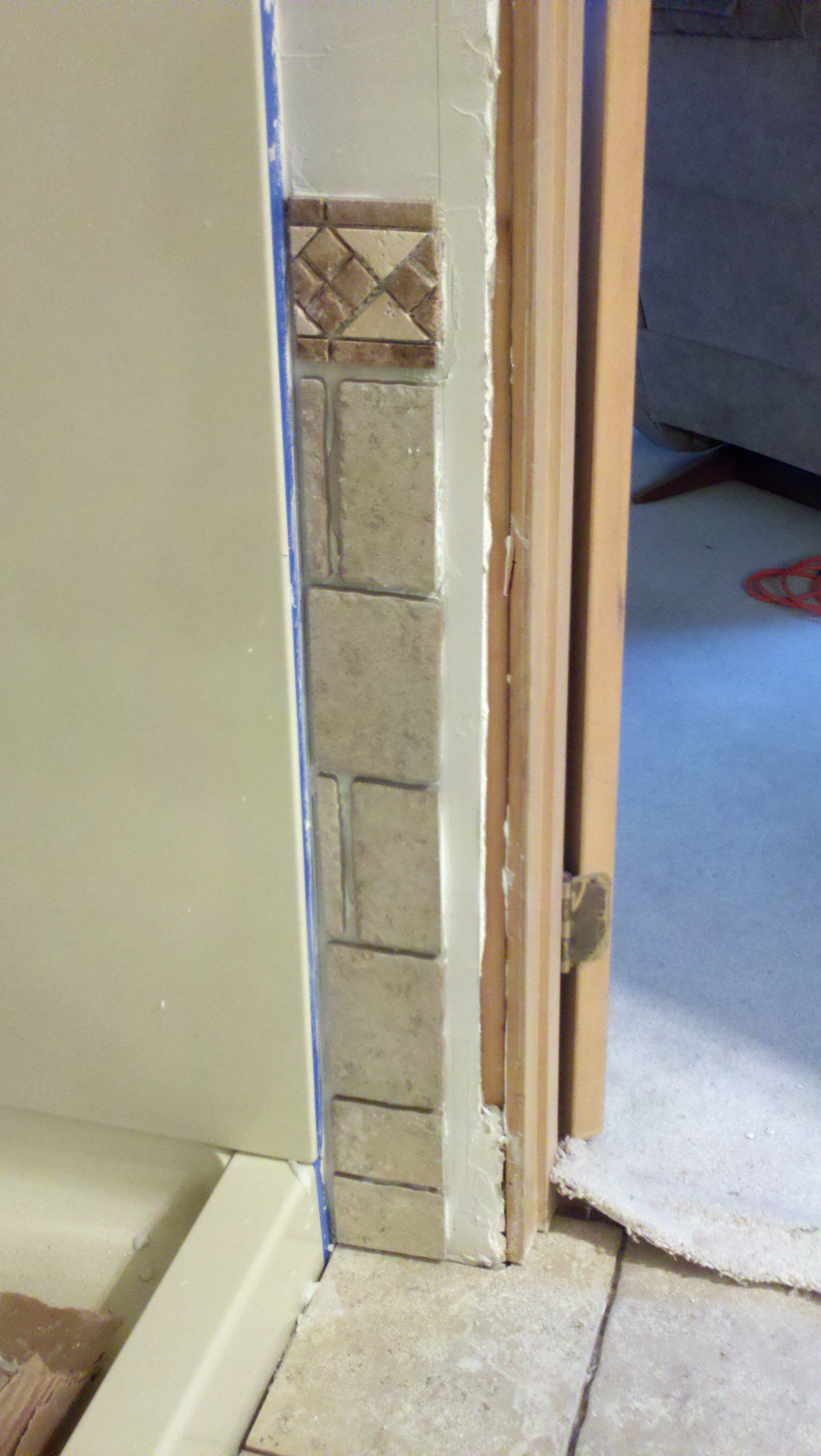

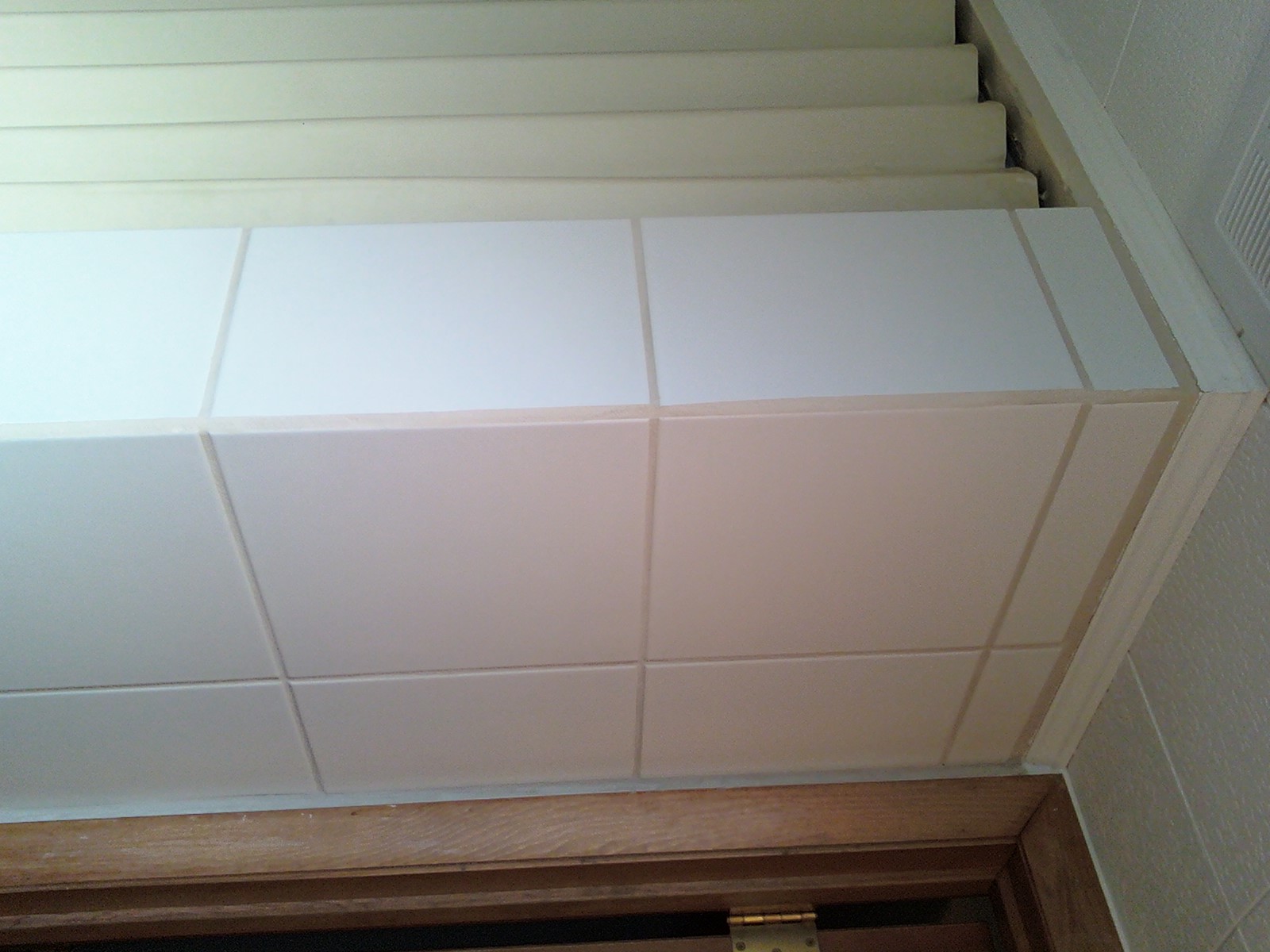

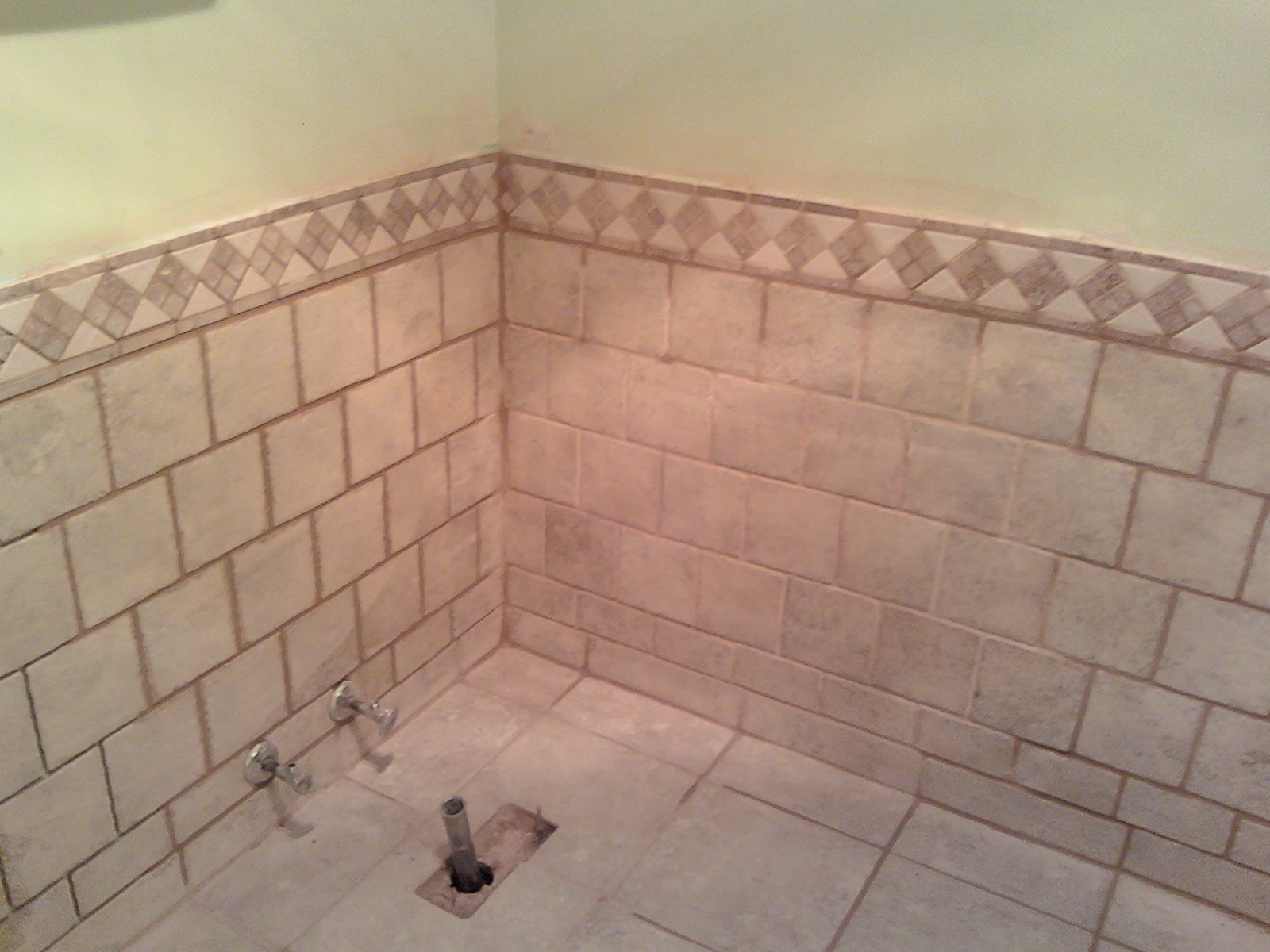

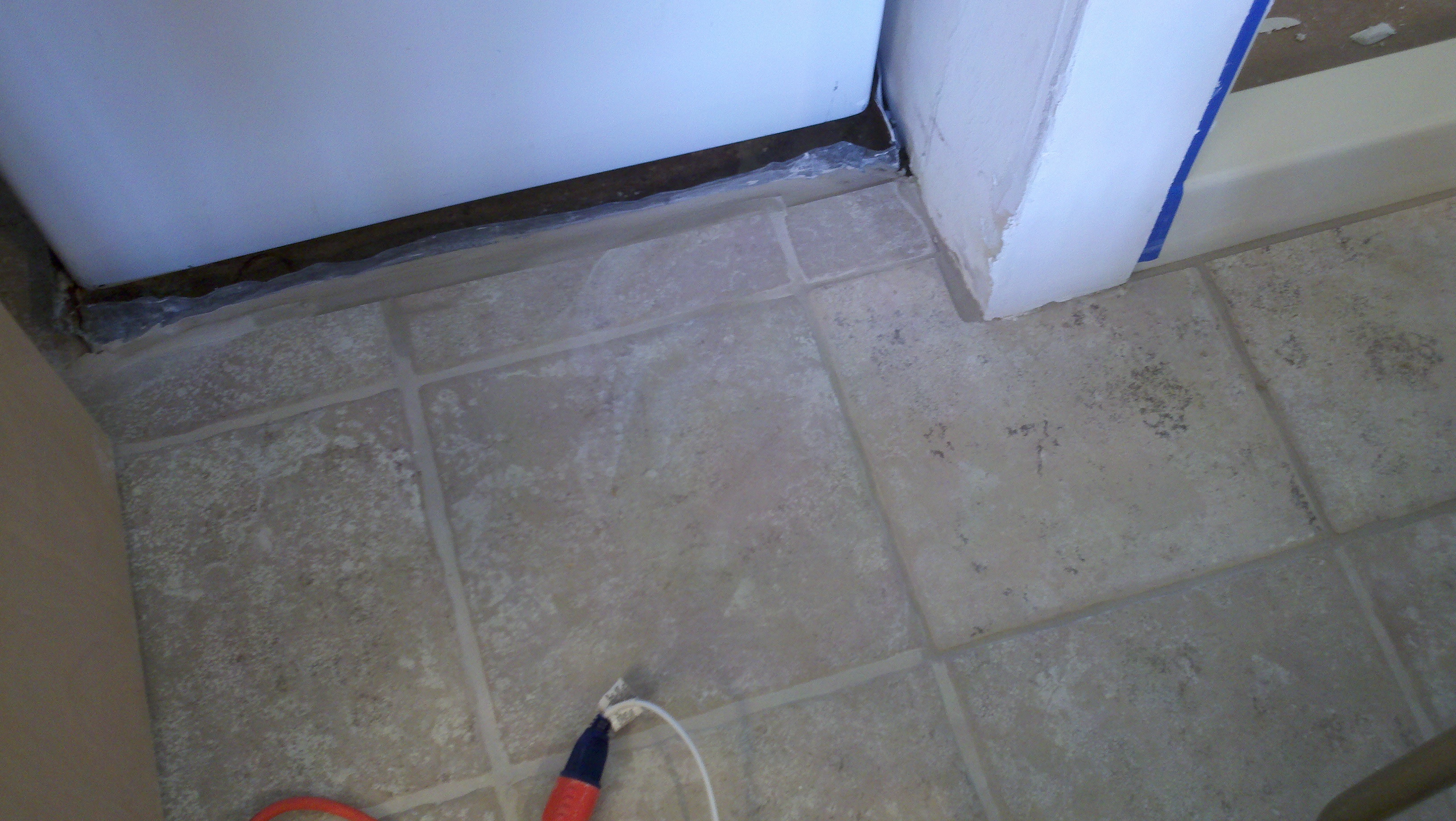

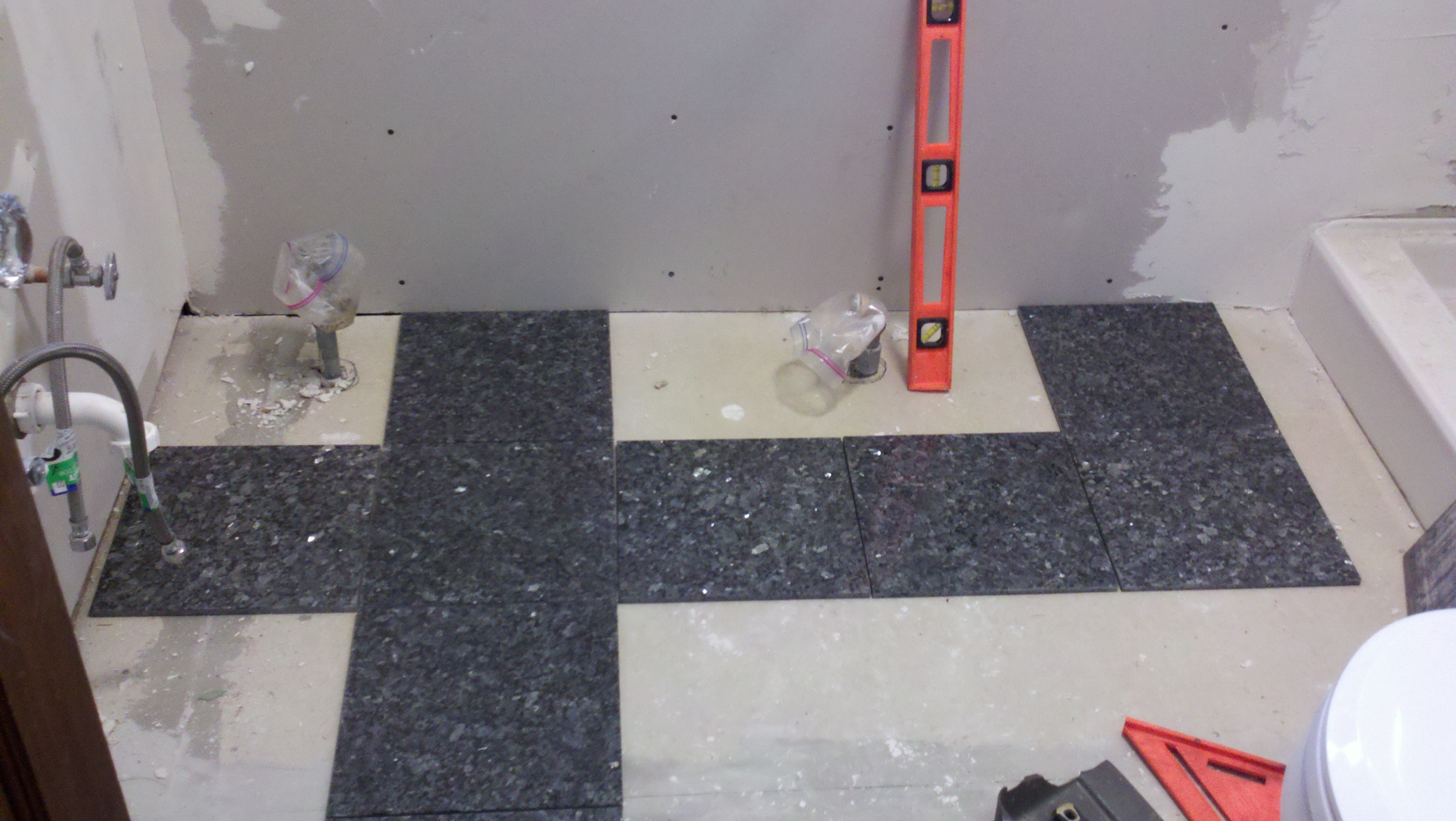

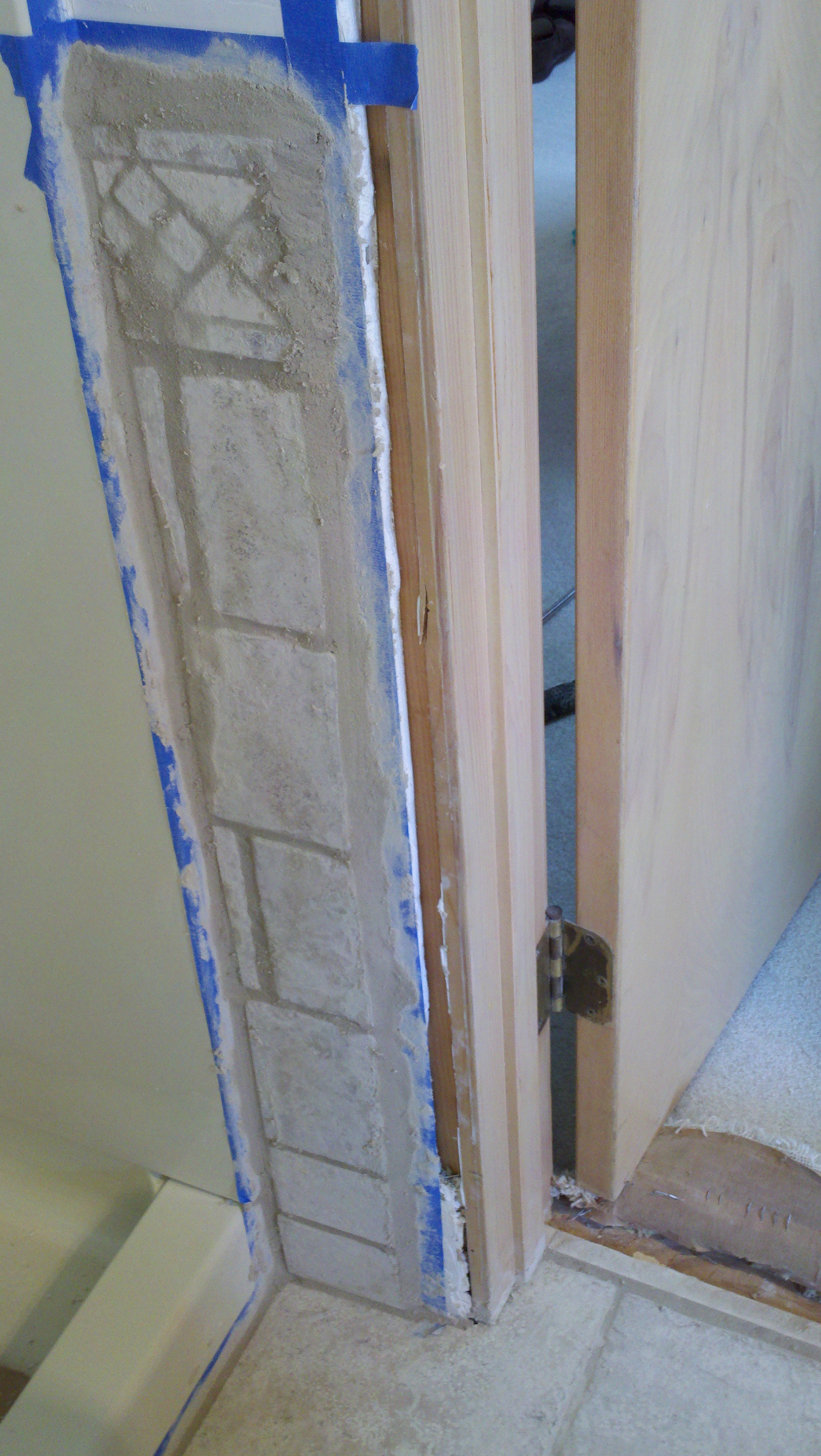

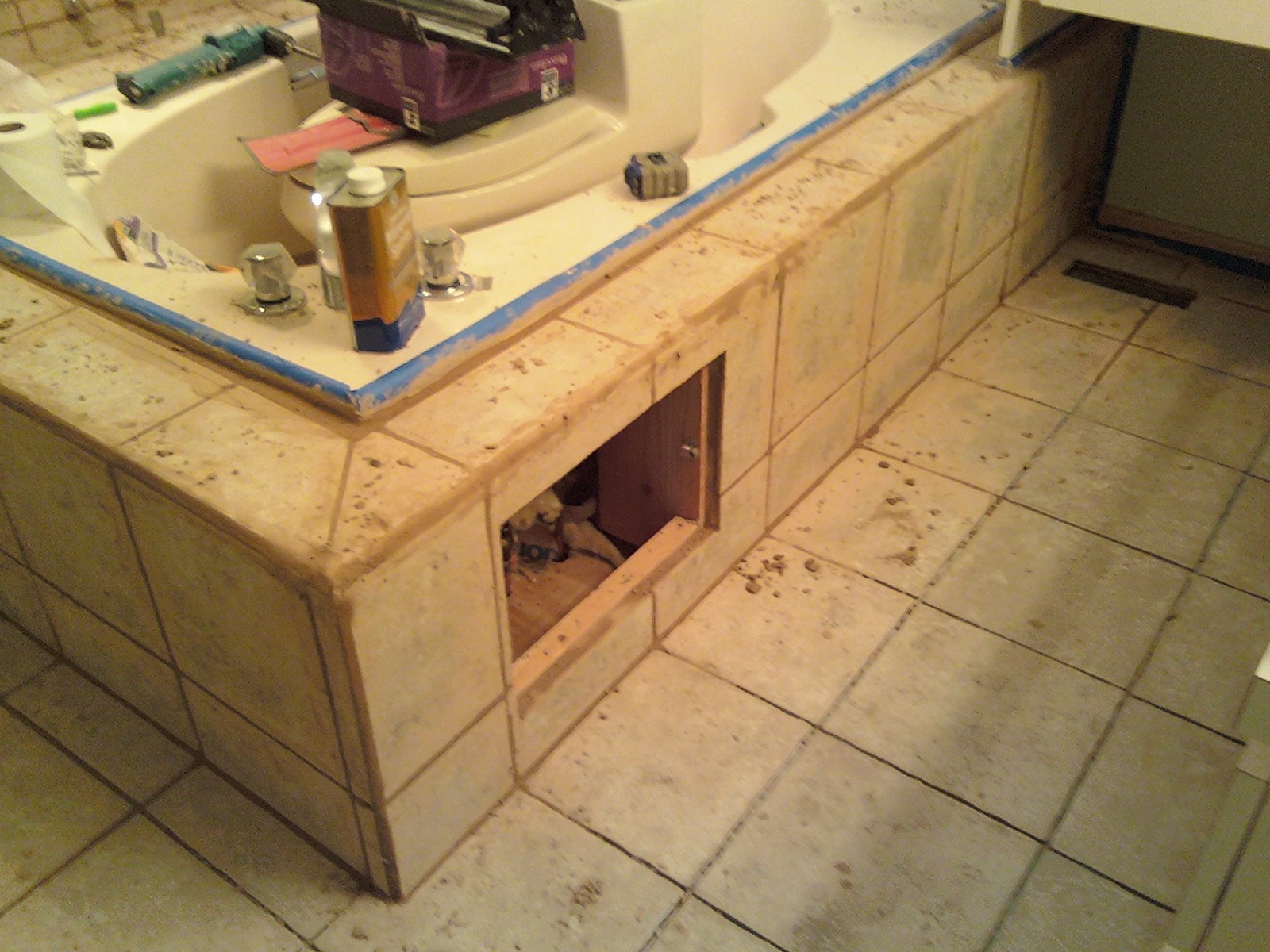

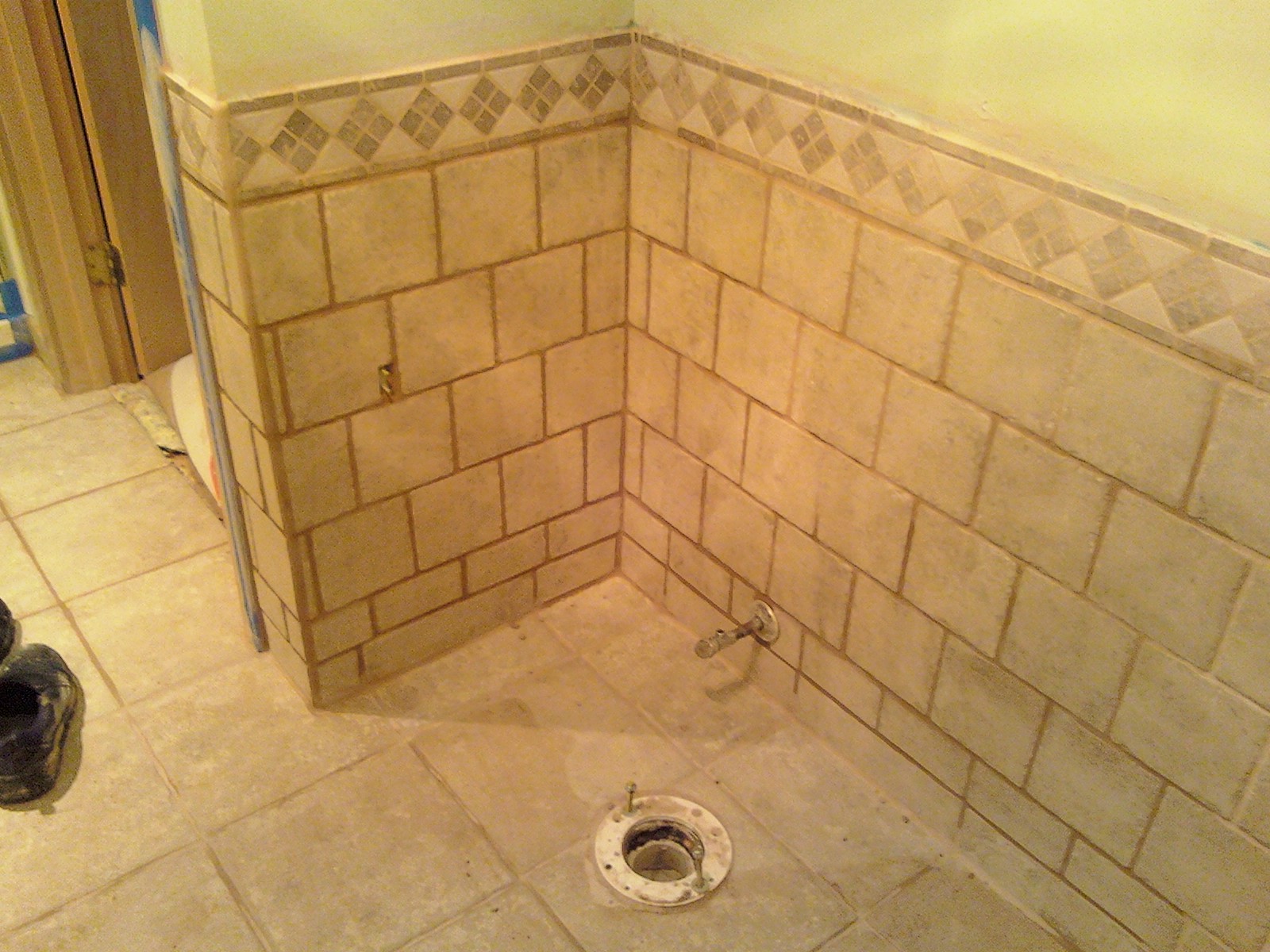

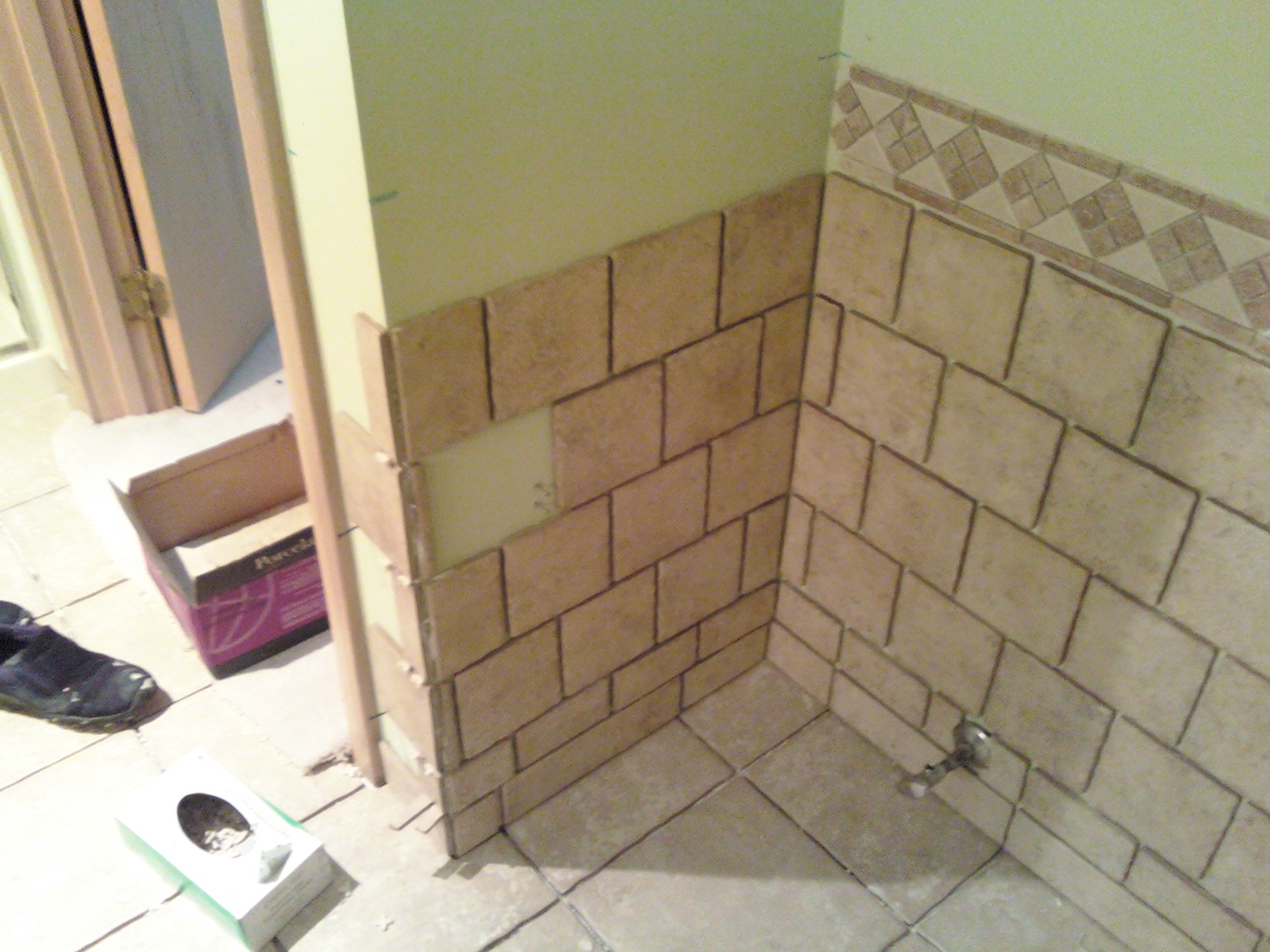

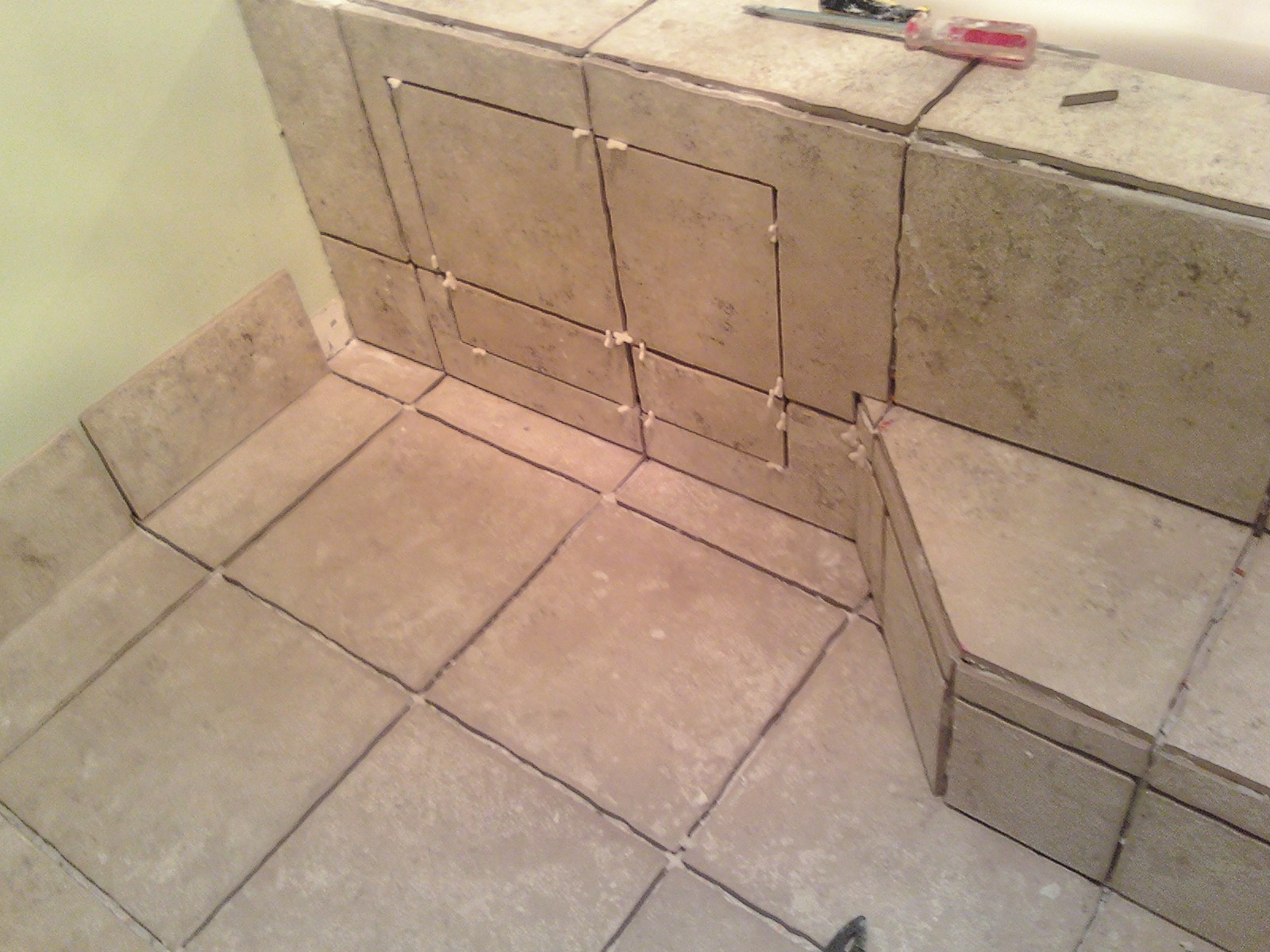

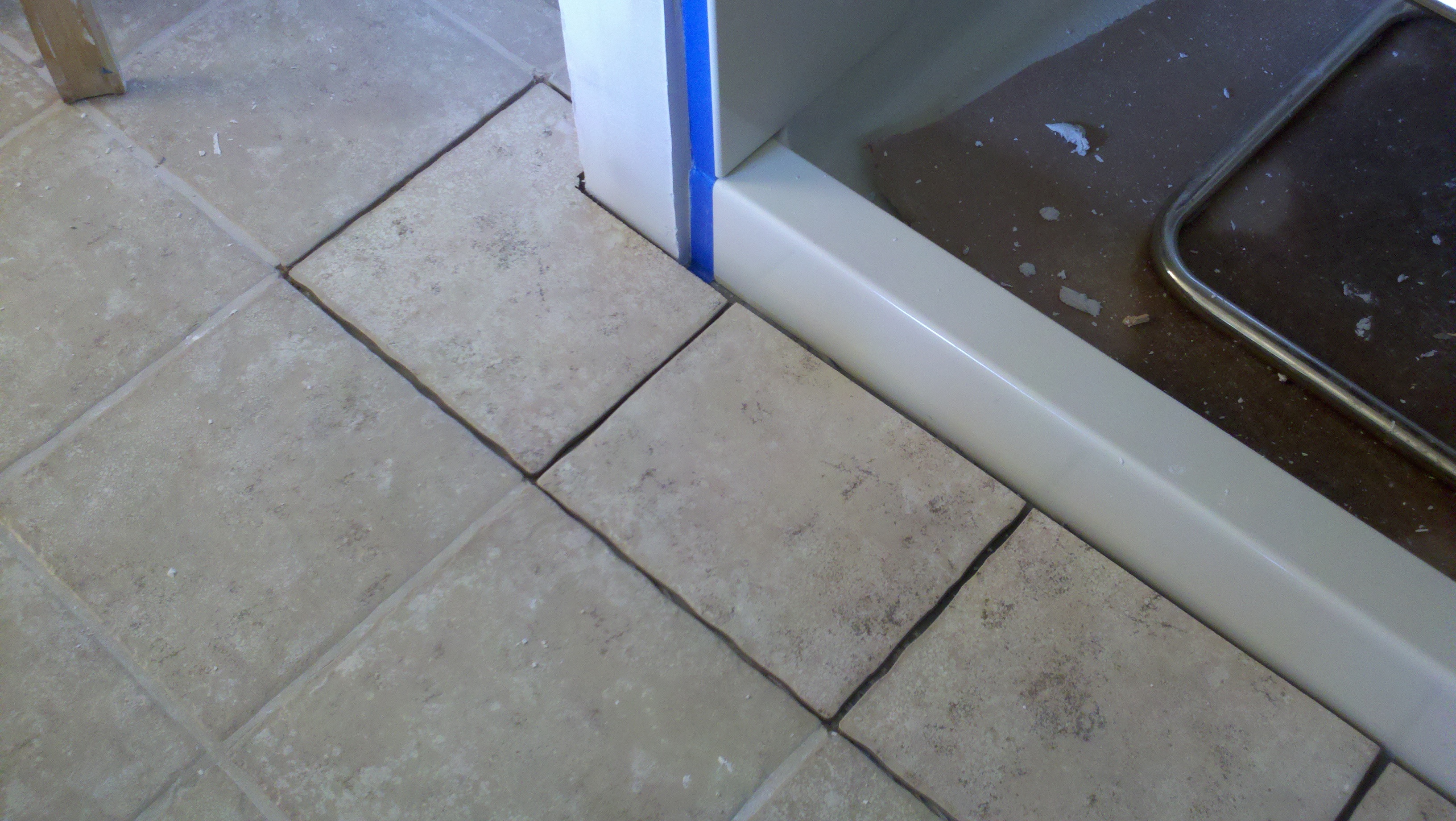

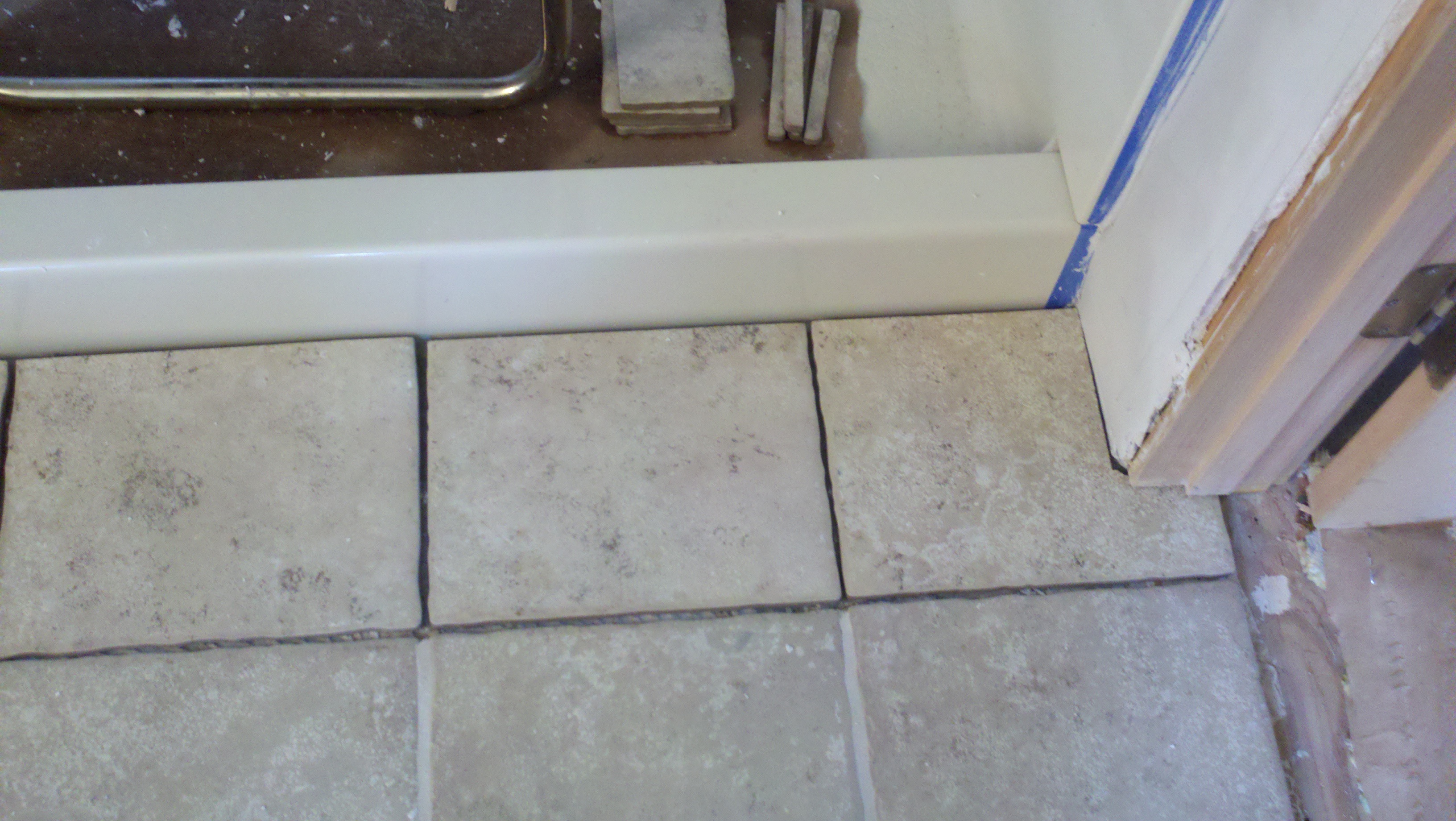

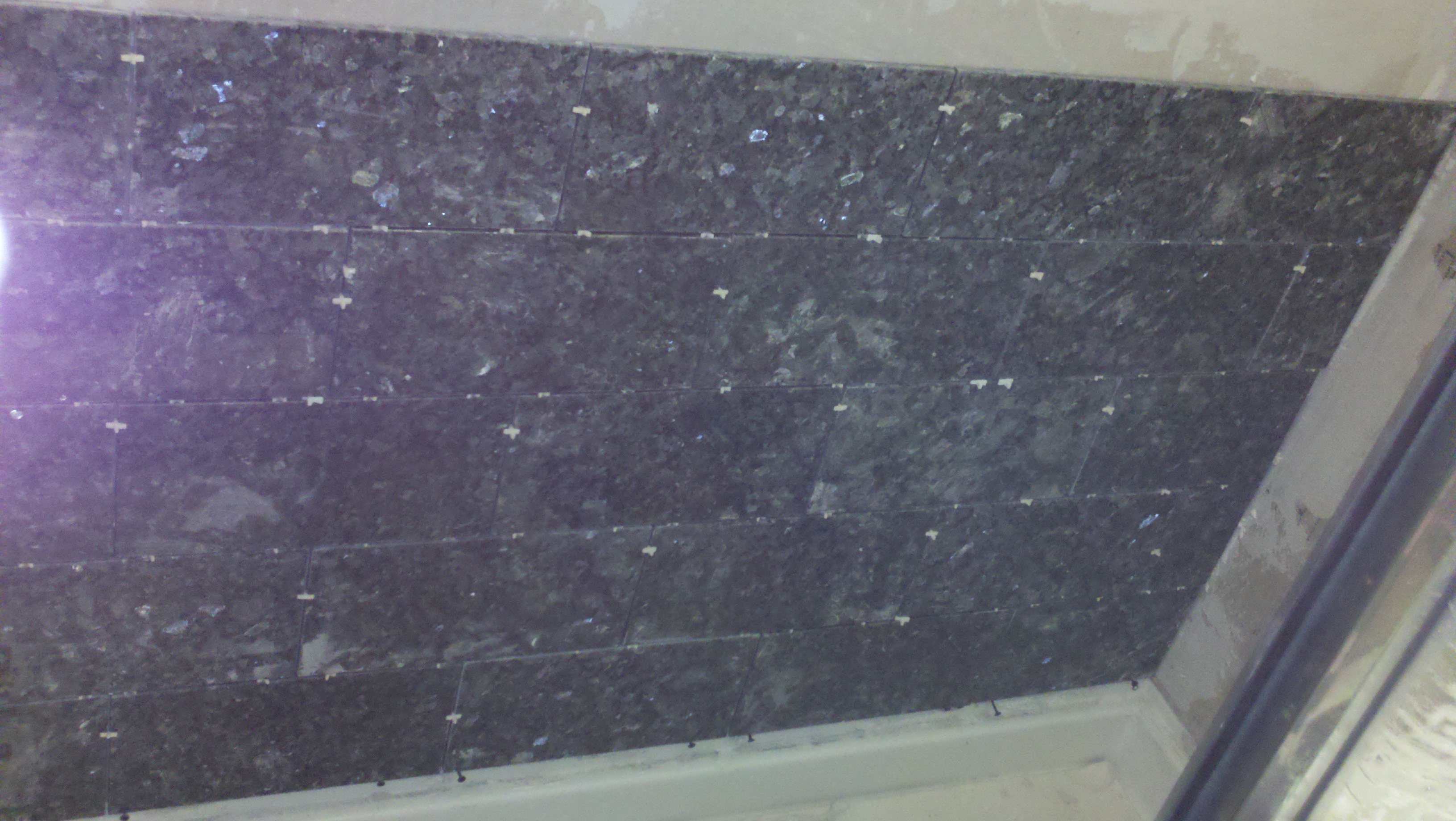

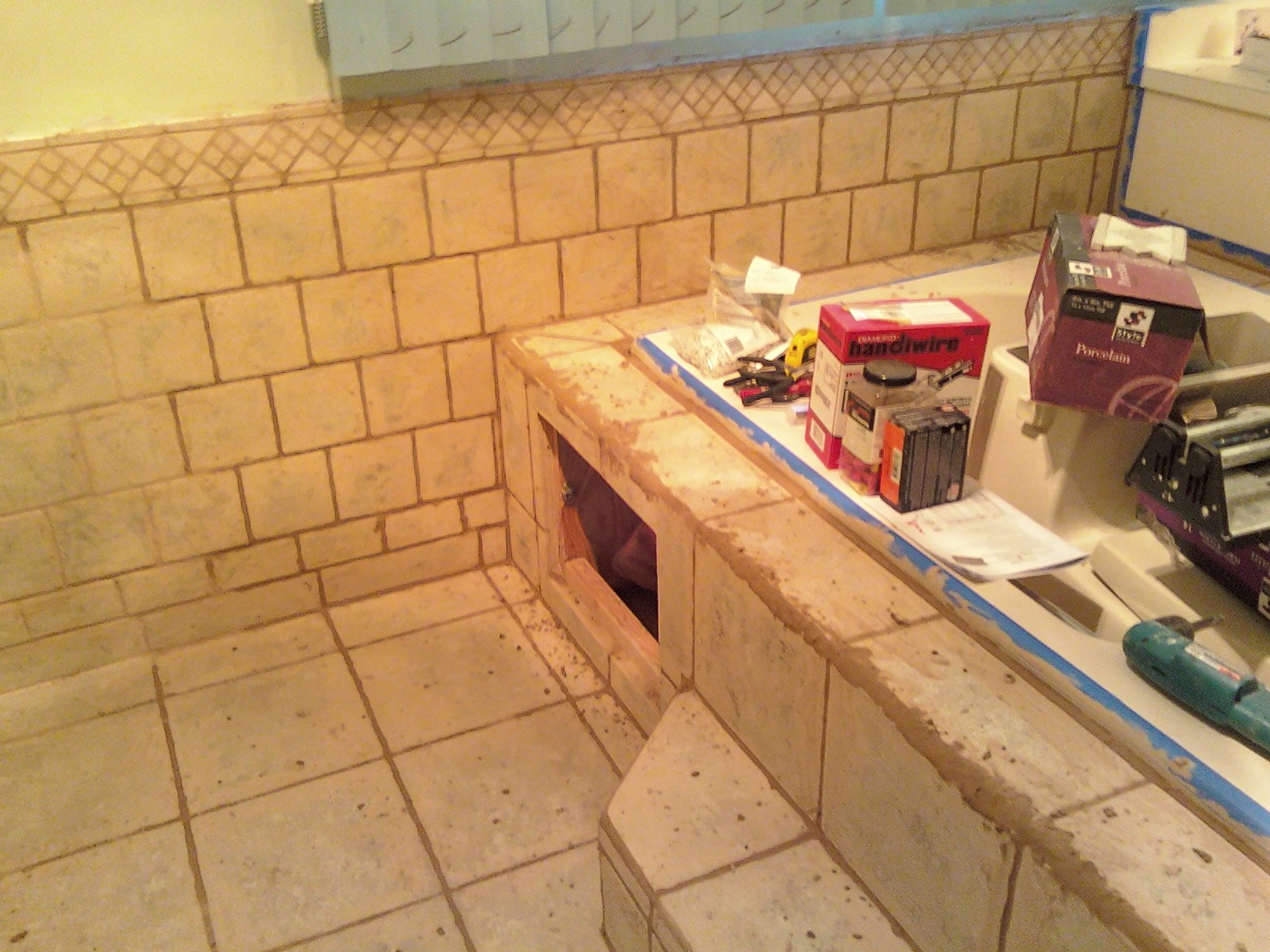

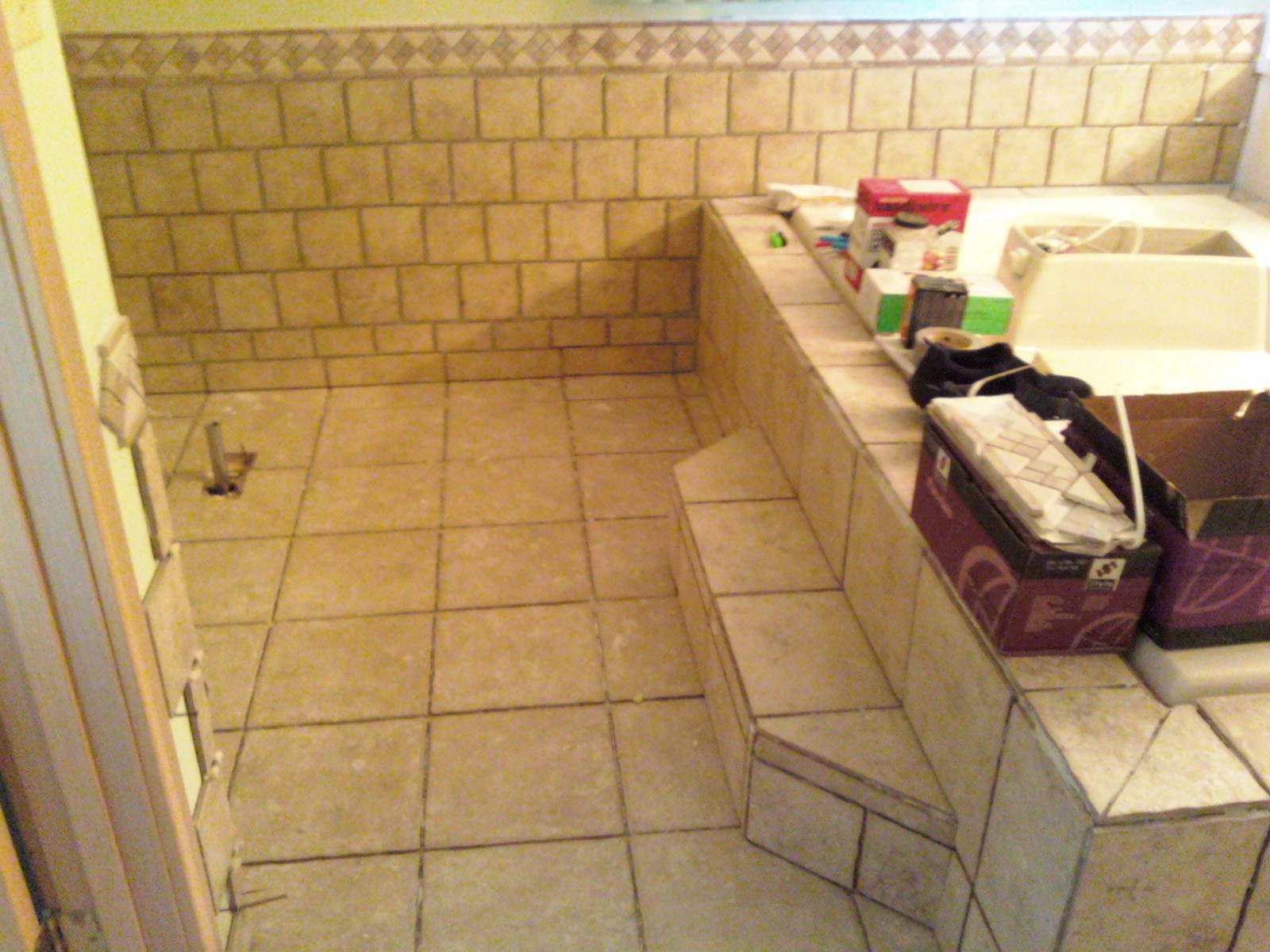

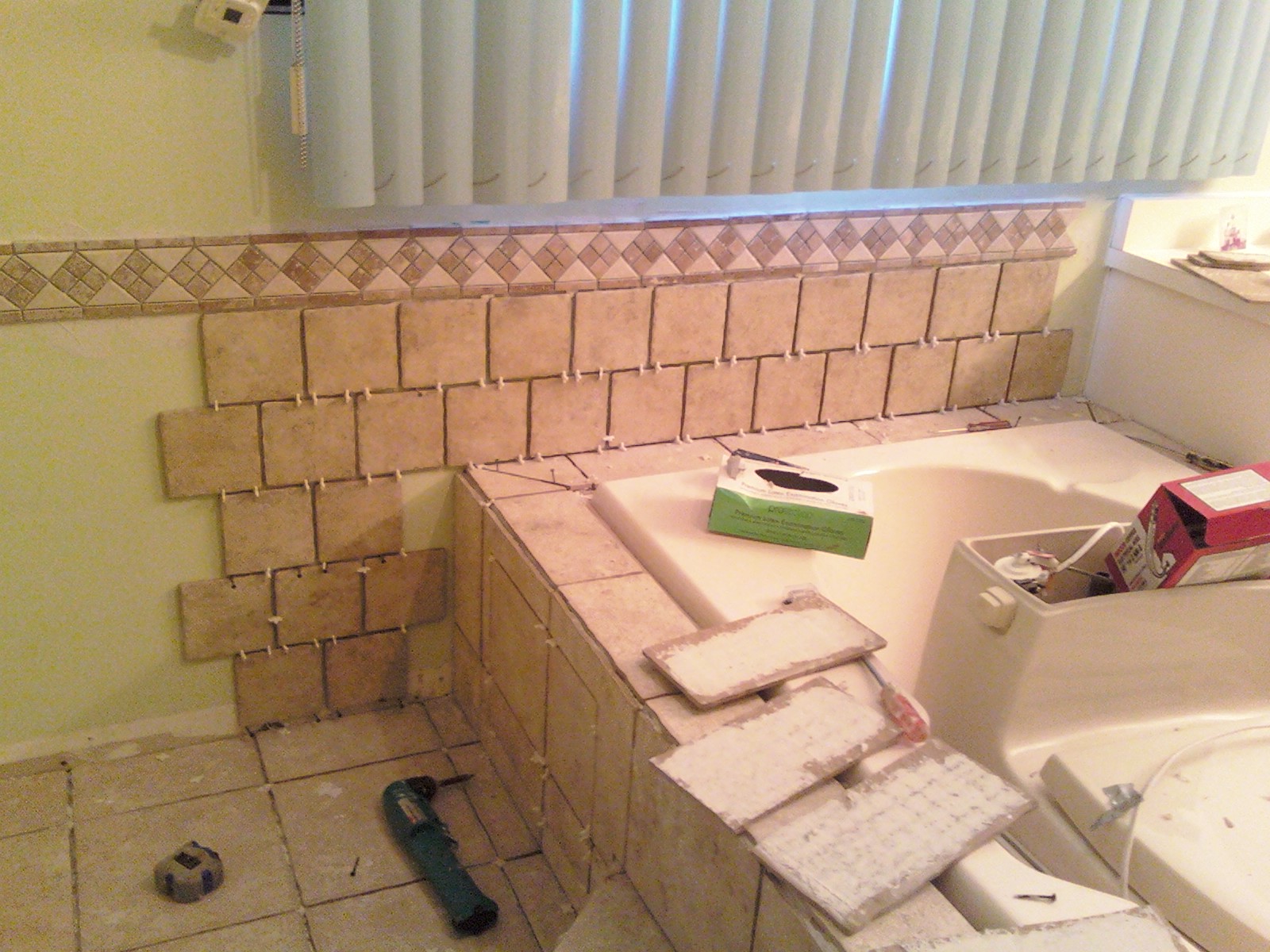

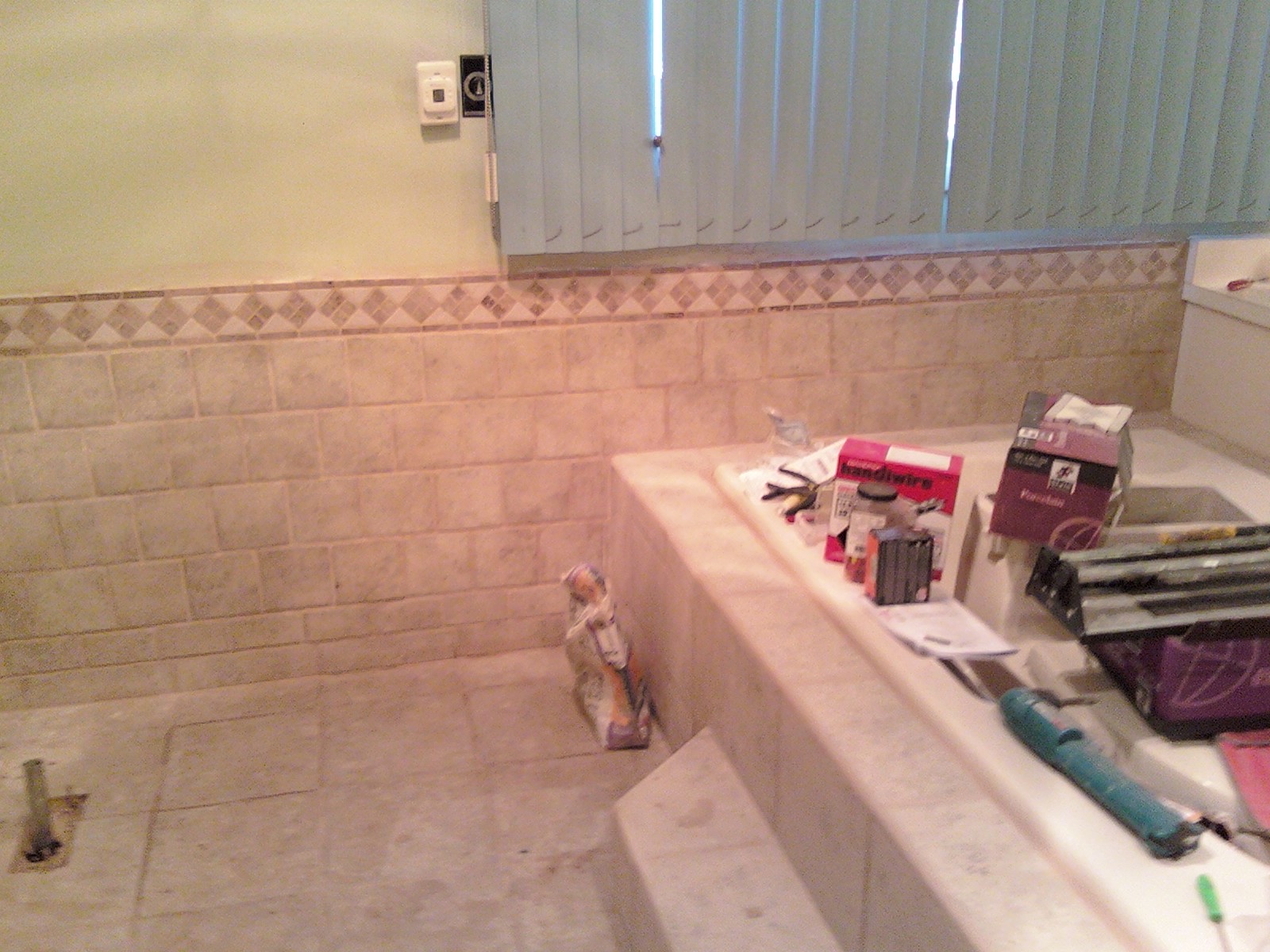

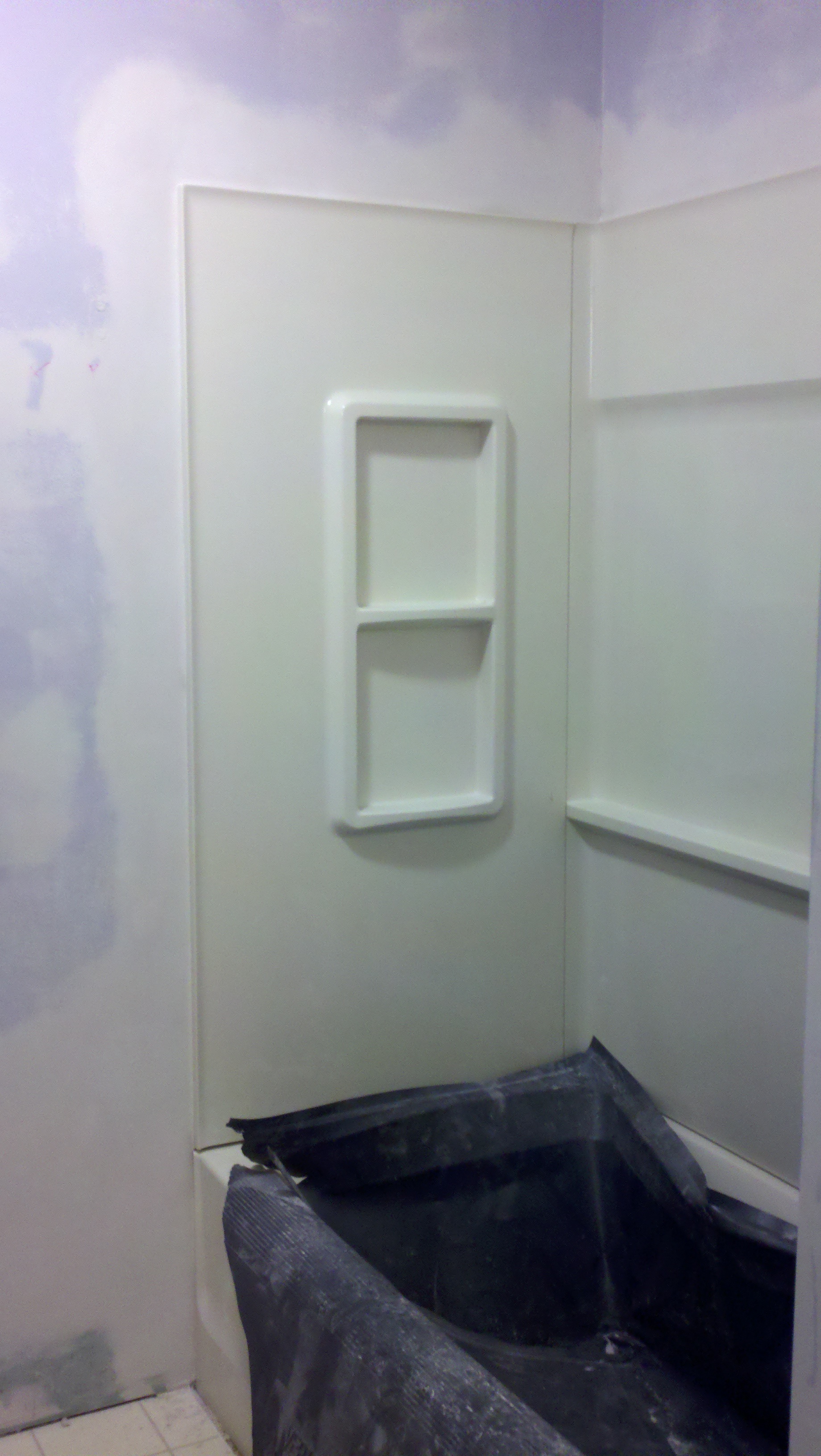

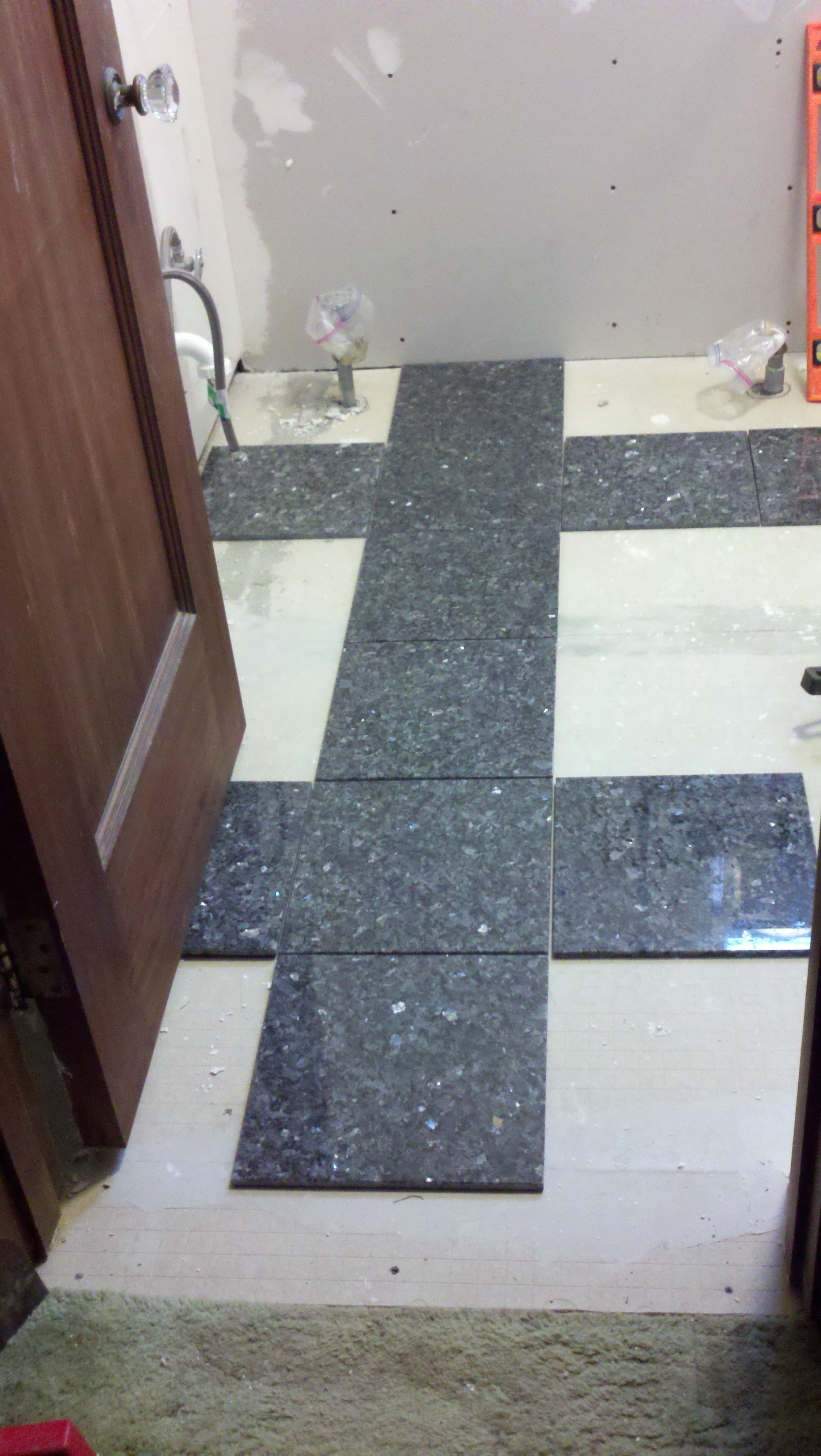

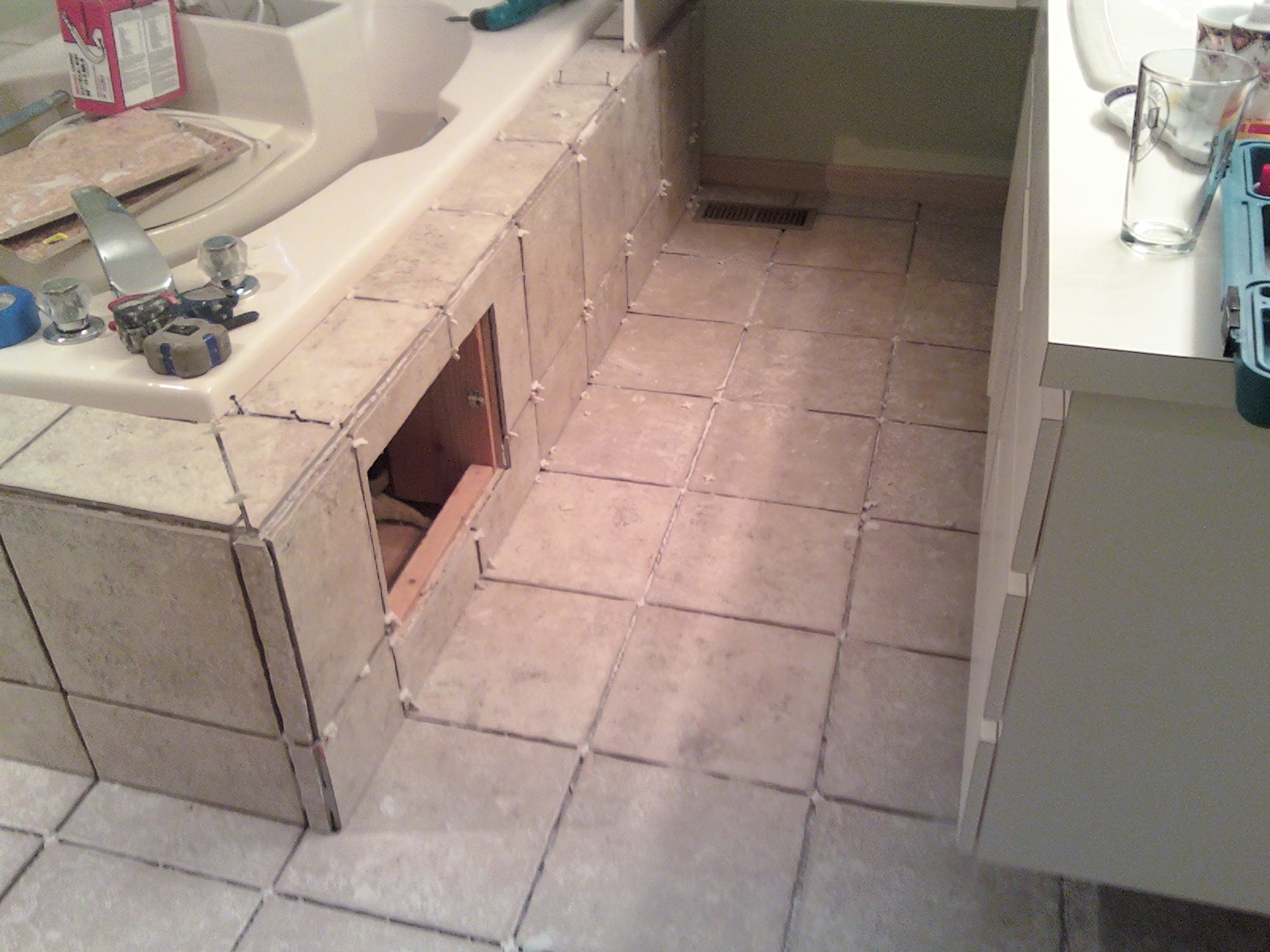

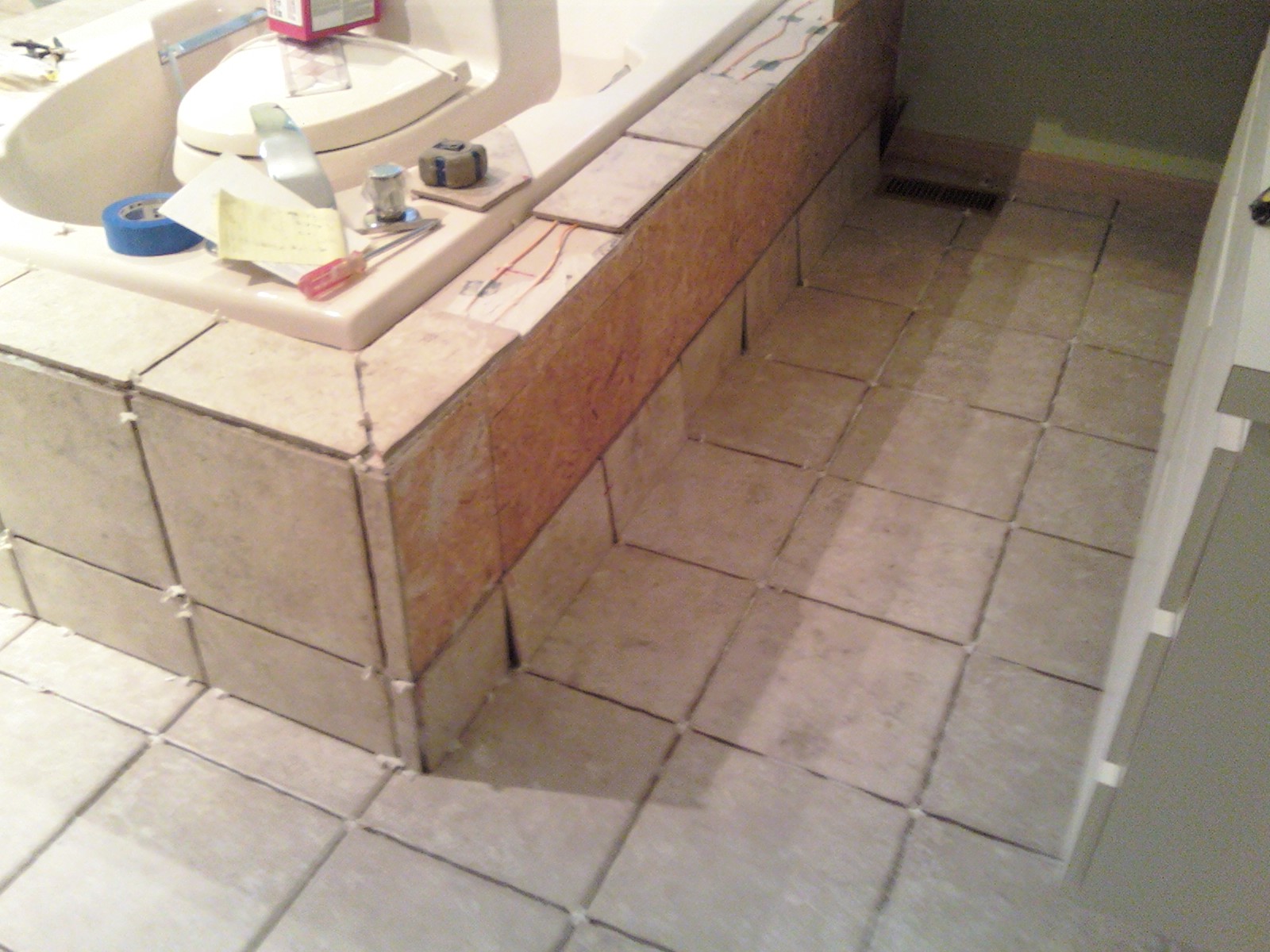

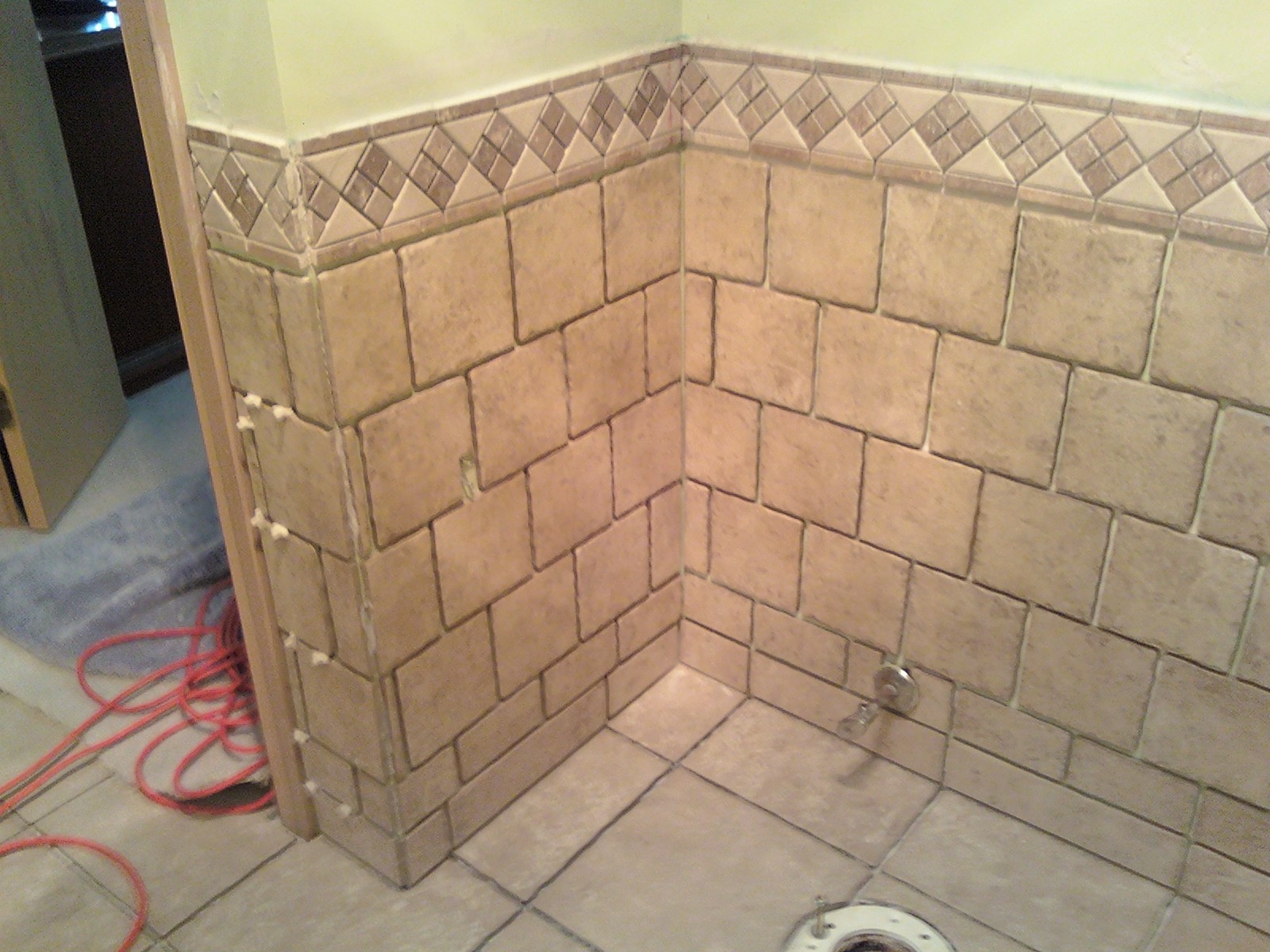

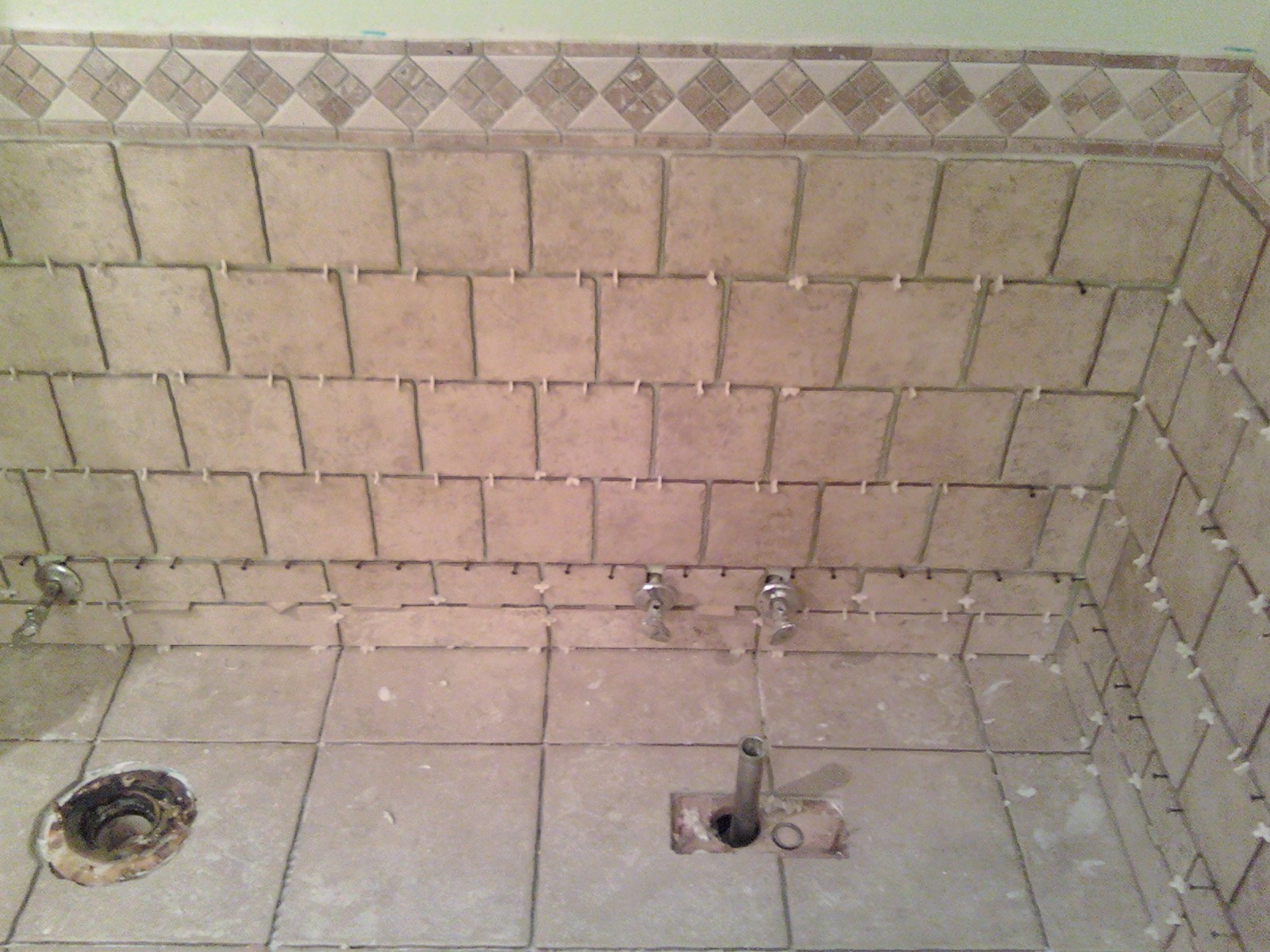

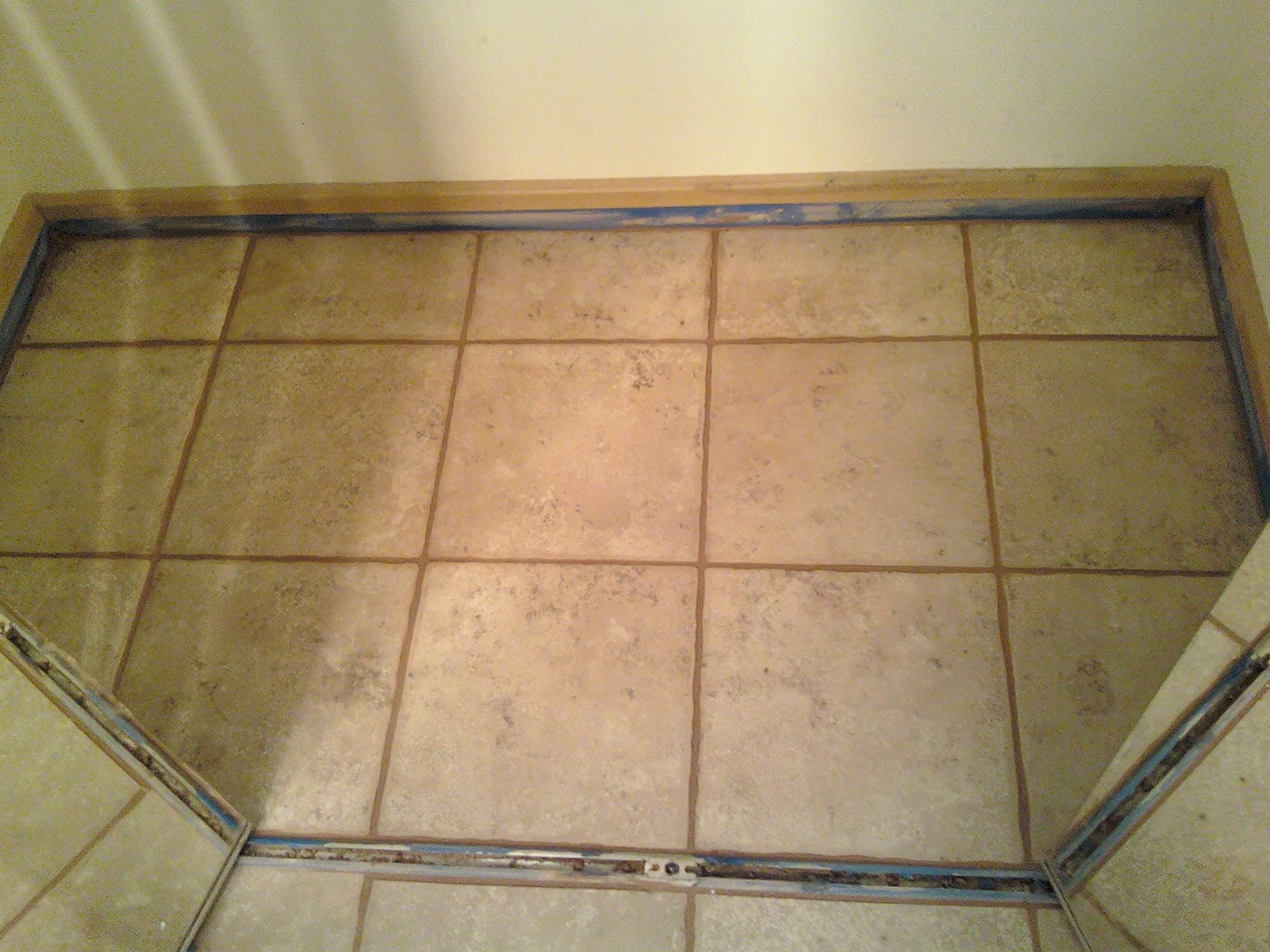

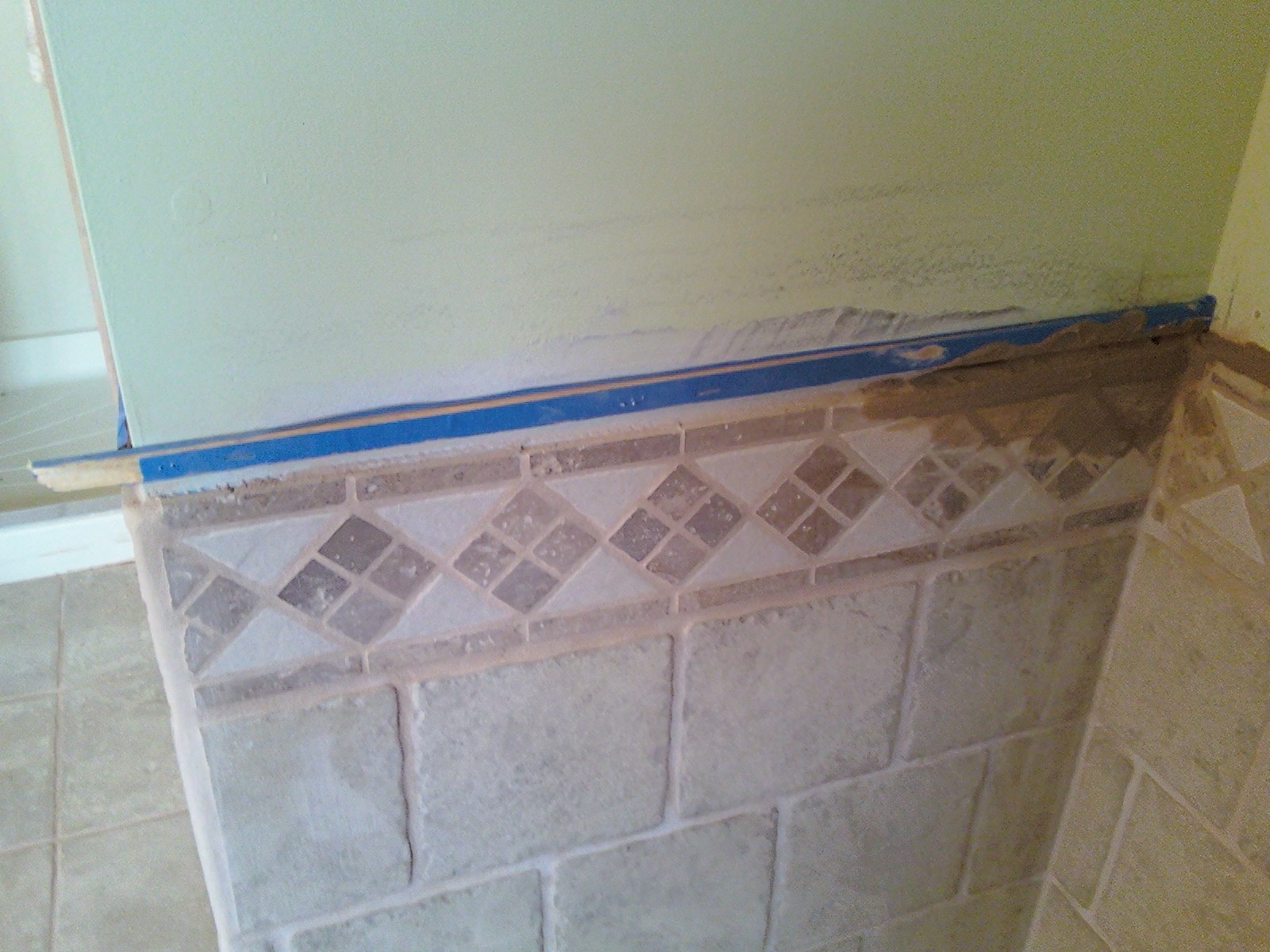

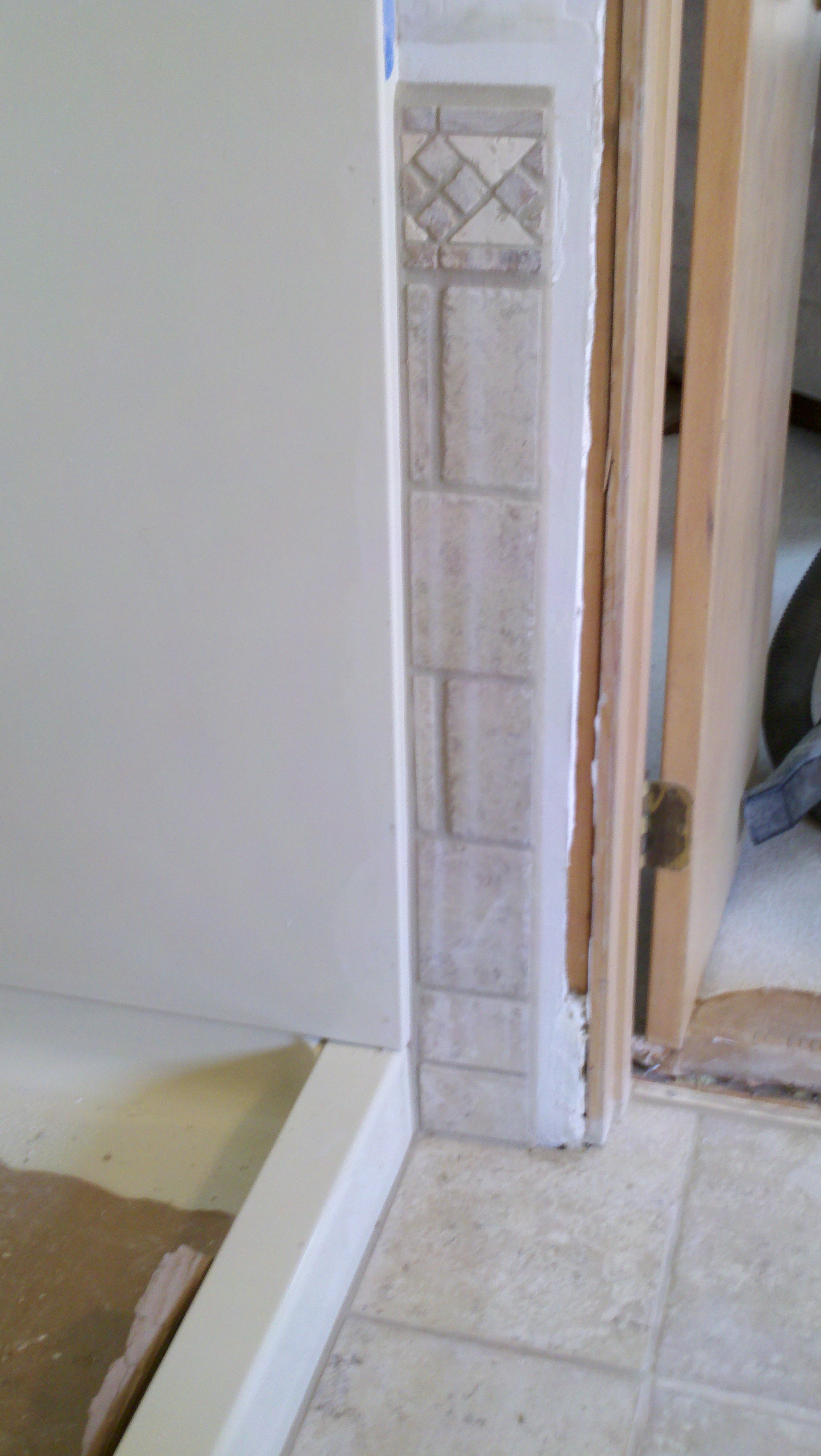

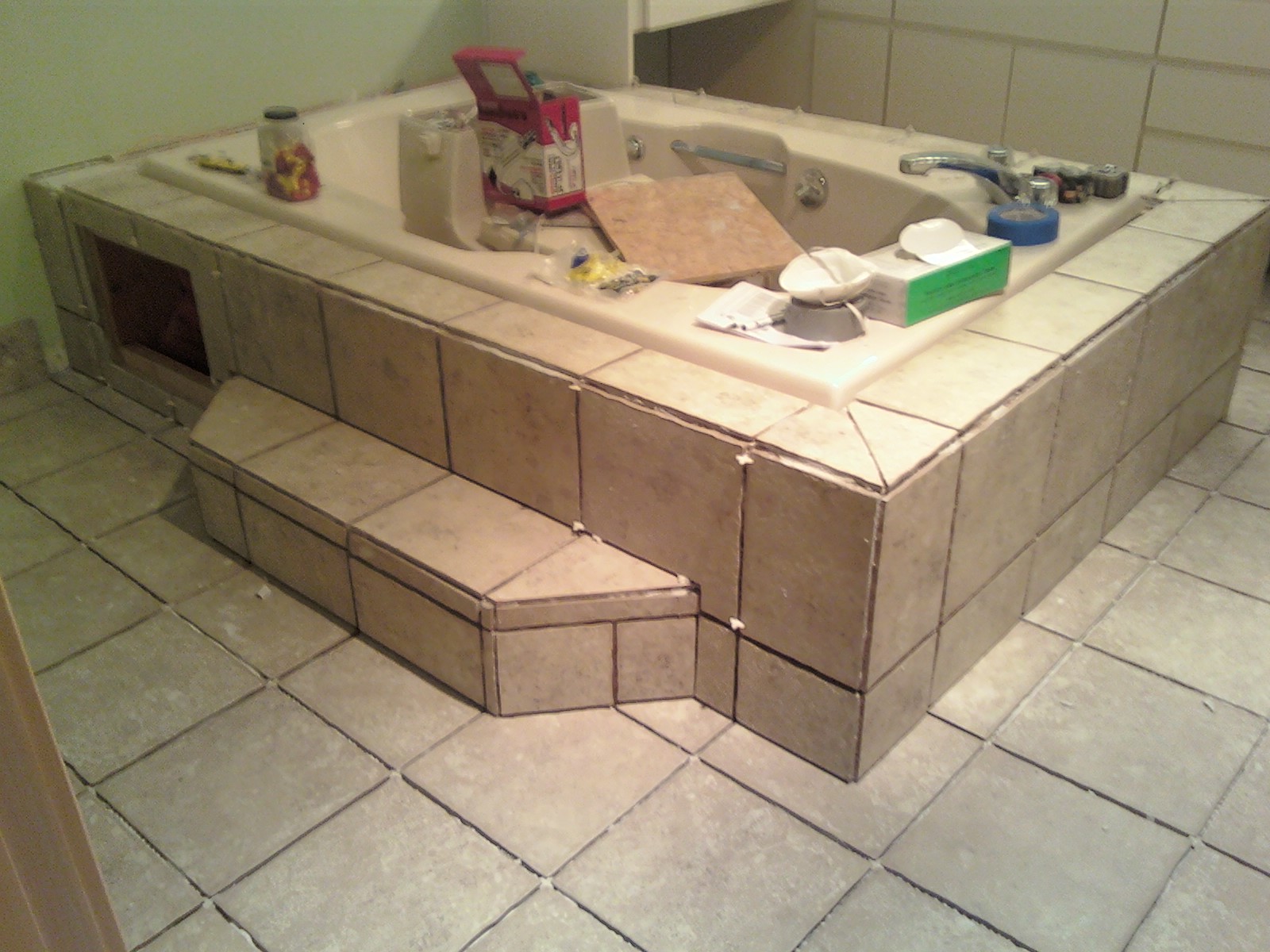

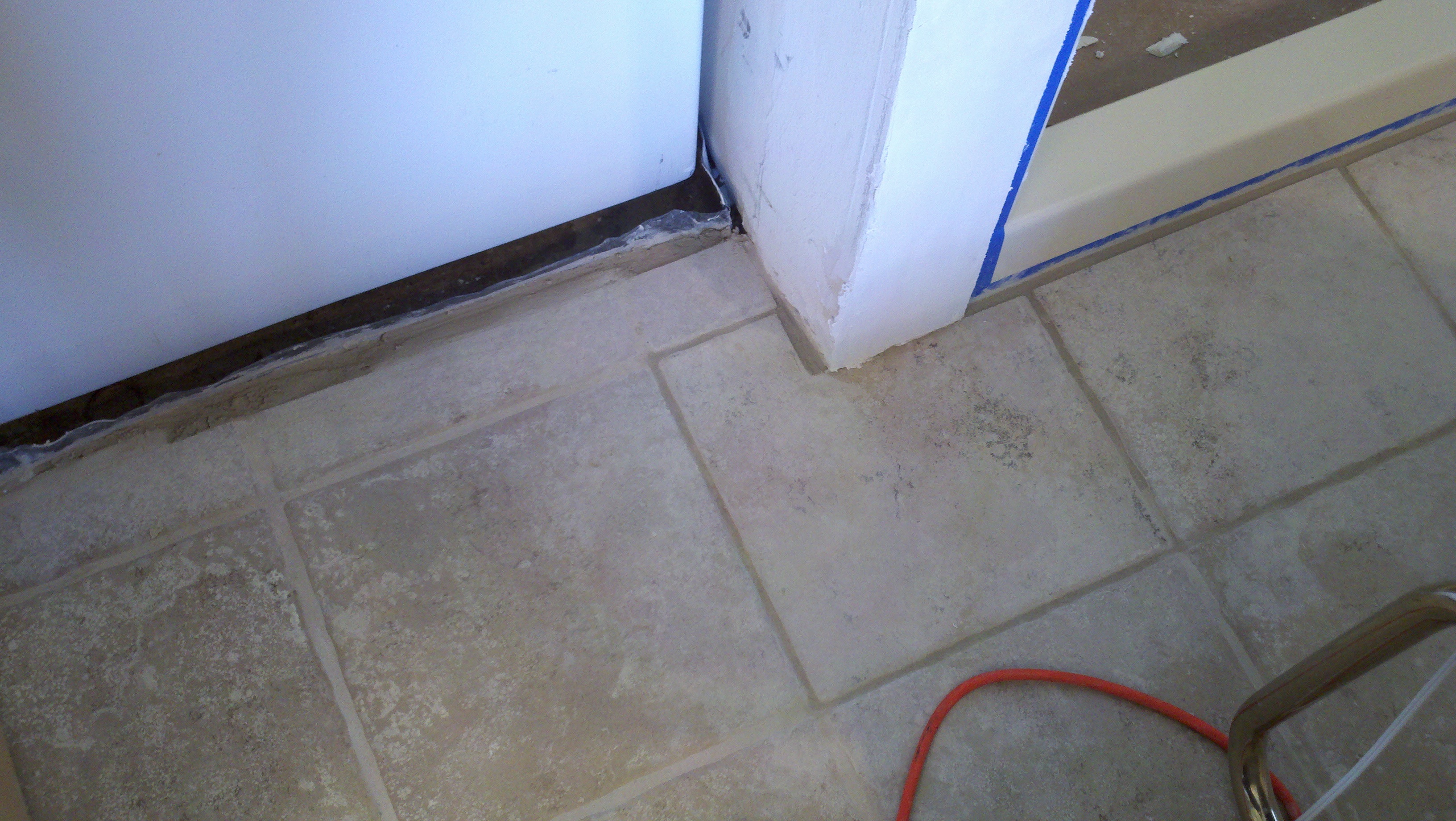

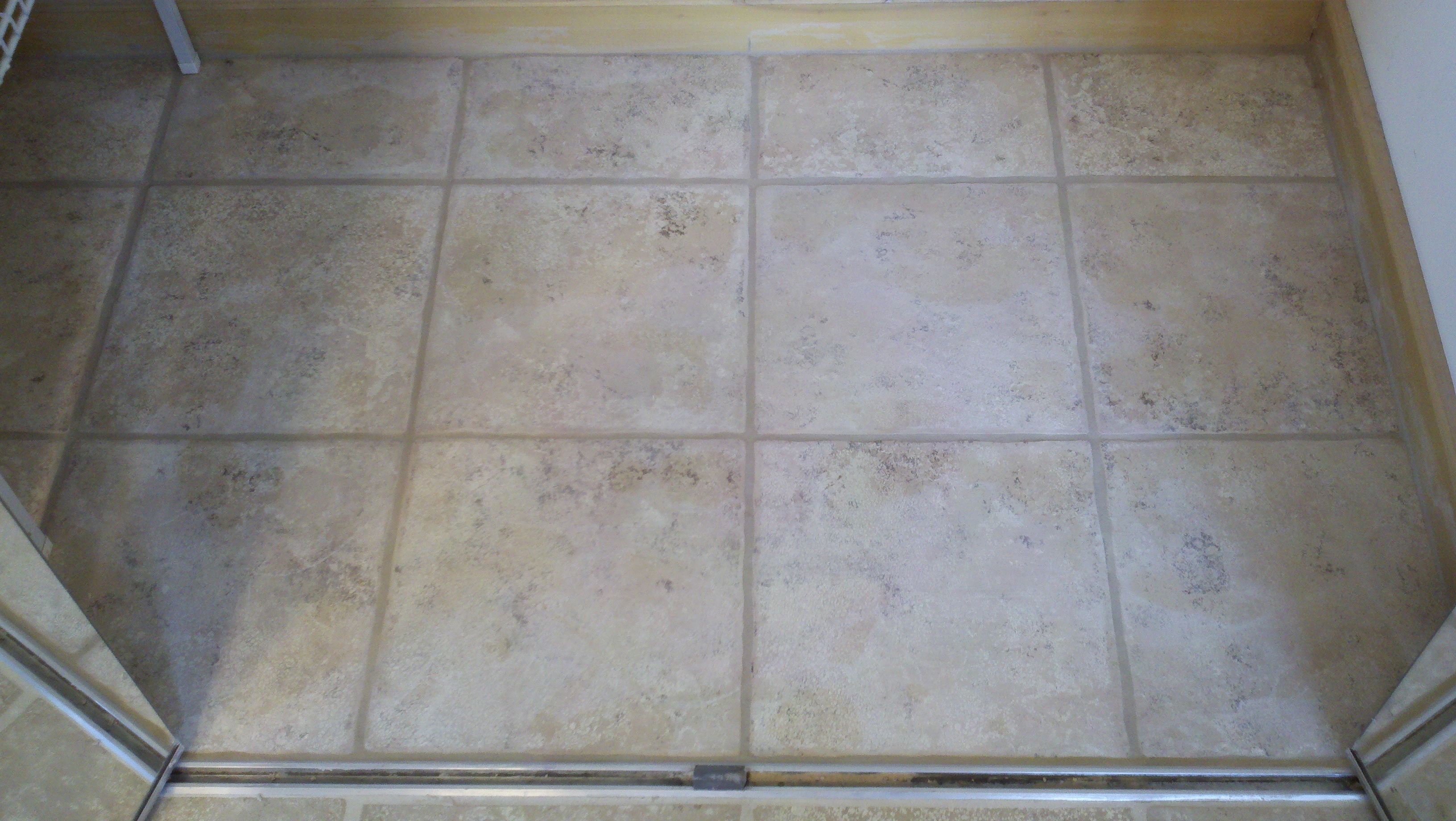

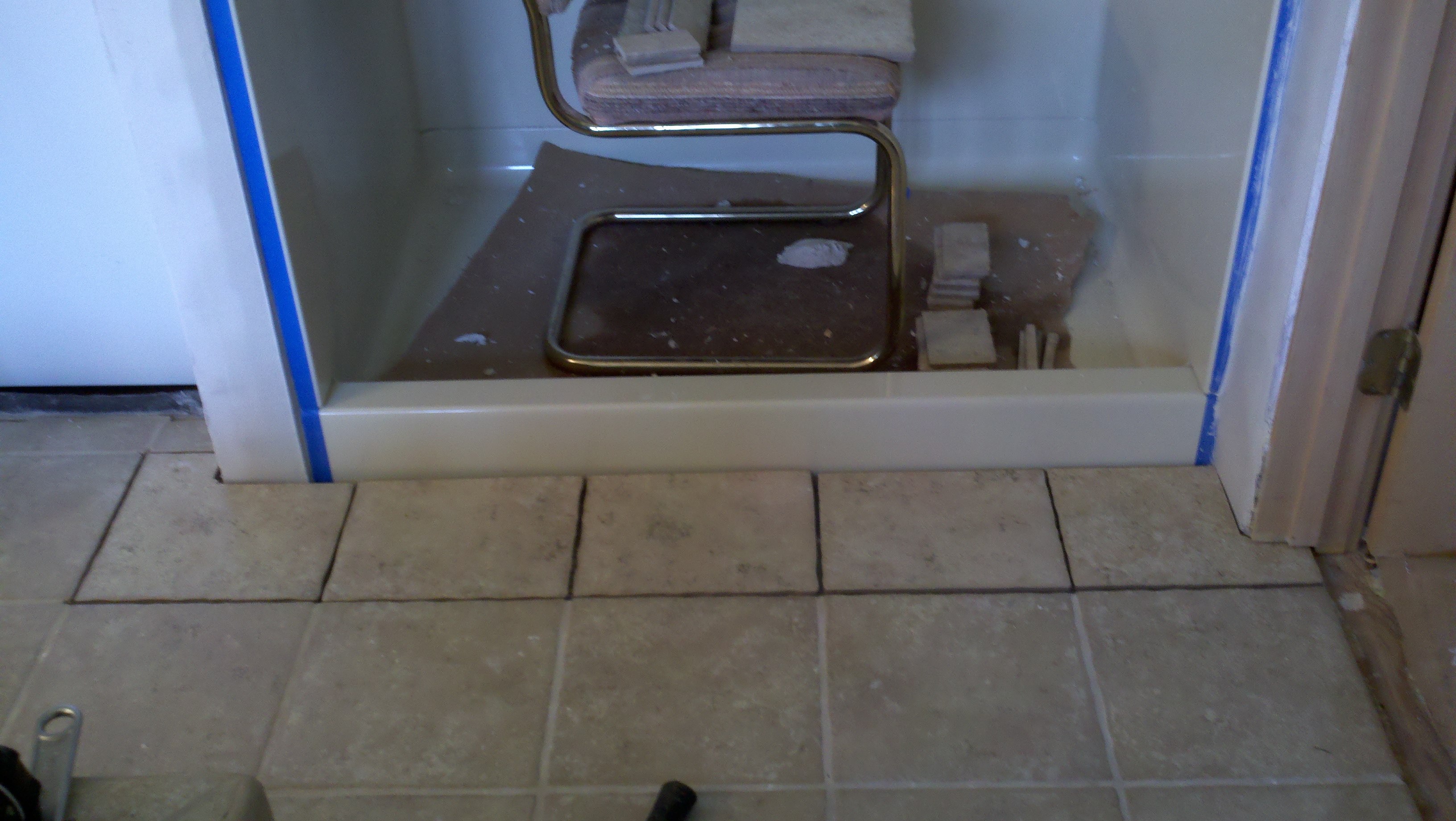

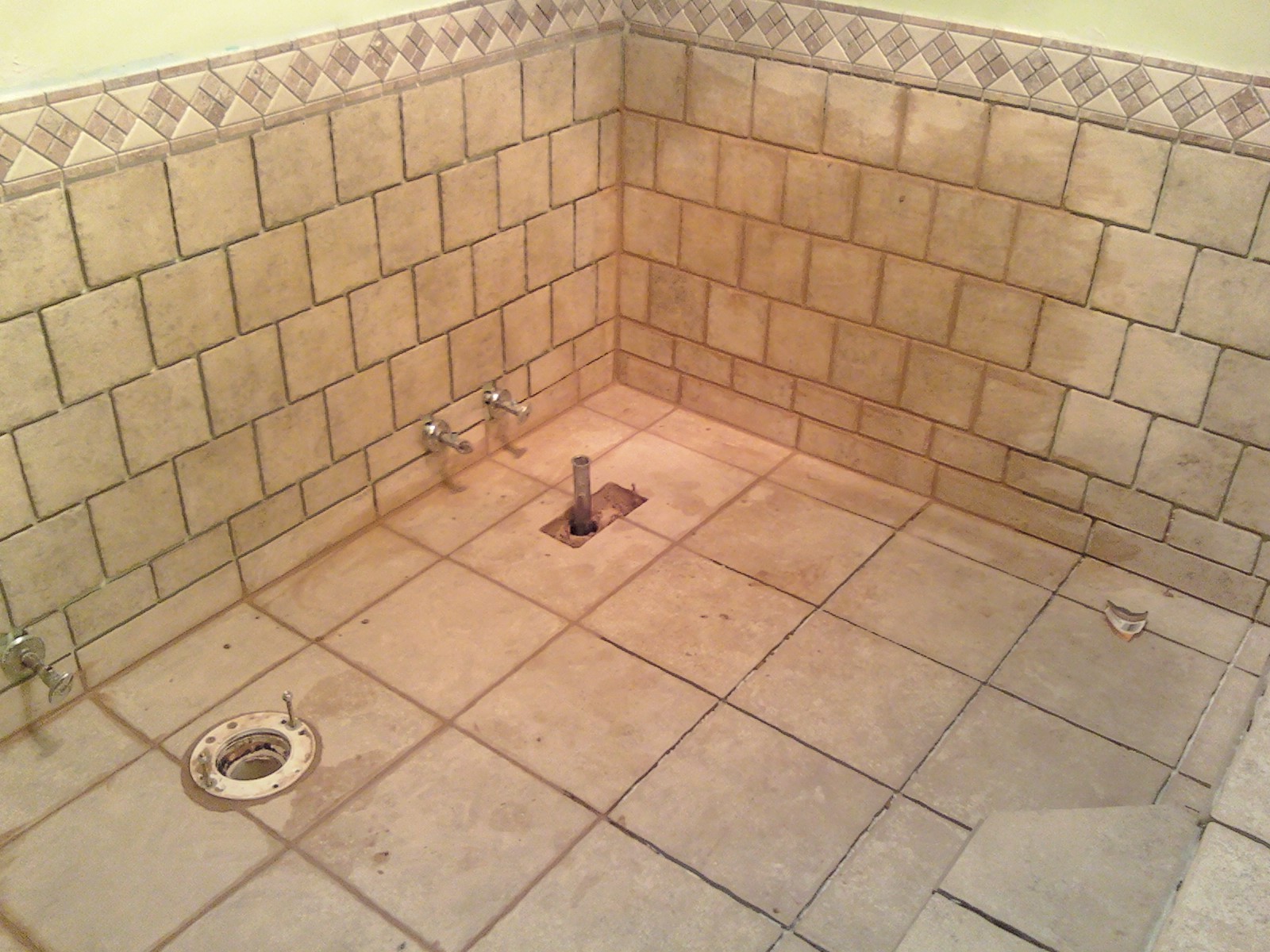

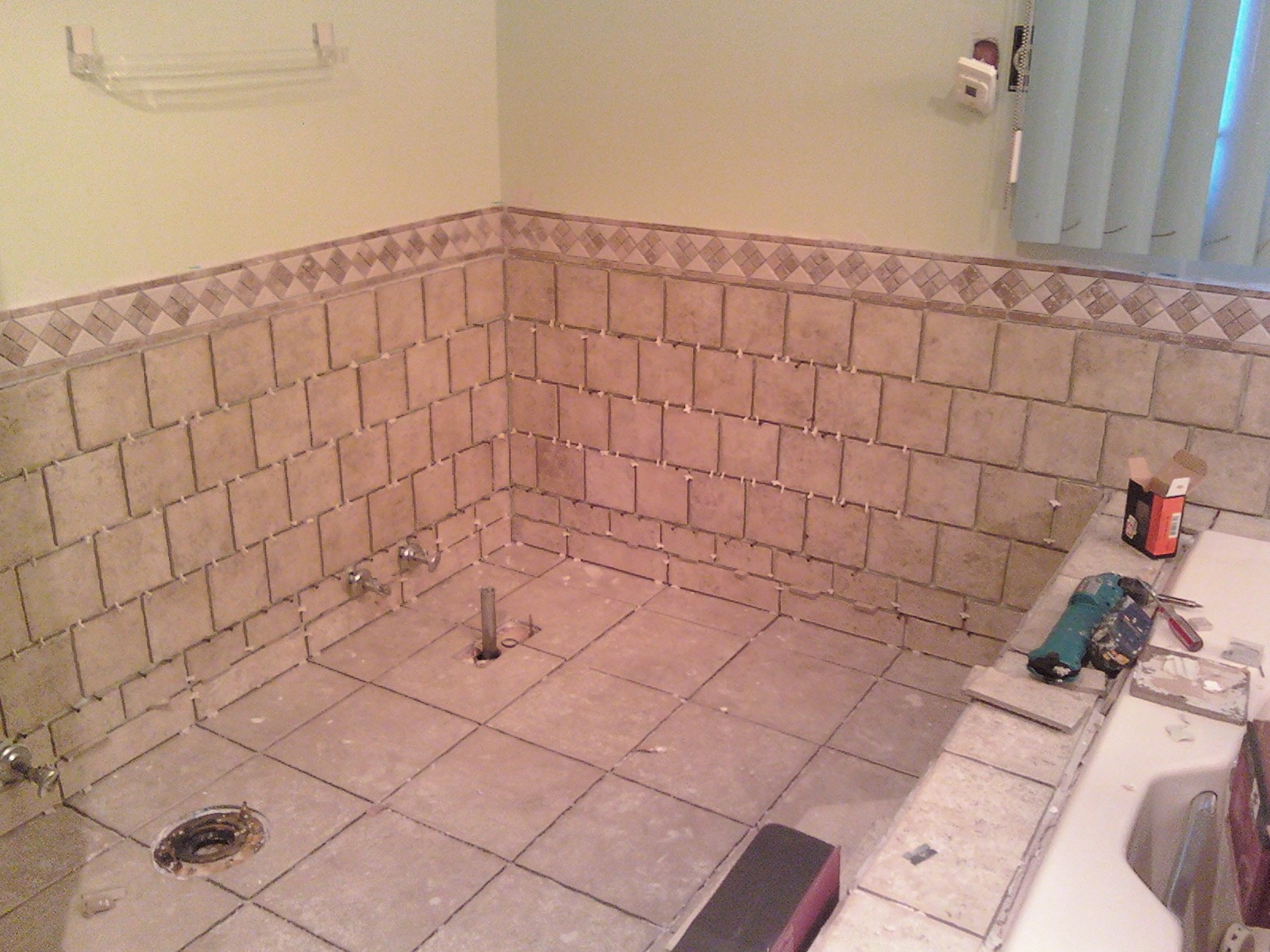

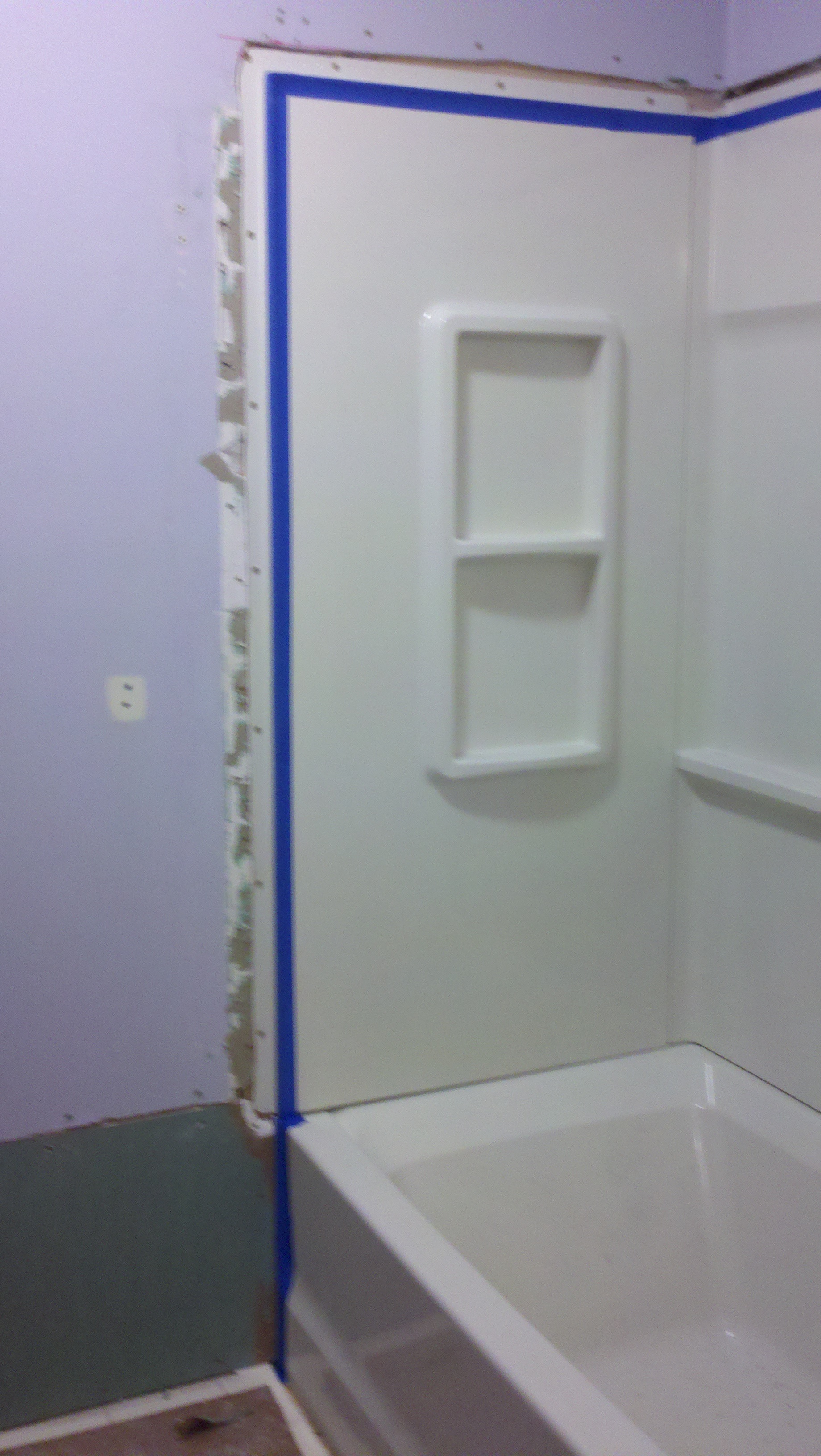

Following the completion of electric portion of the installation process, the mechanical process was initiated. The tile fitting an adhesion was a challenging and intense process to provide a pleasing and functional installation. Pictures ten through thirty-seven provide depiction of the complete tile lament process. The size of the bathroom floor was measured to be twelve by twelve feet, neglecting the power tub, washer/ dryer indention, and closet expansions. Additional six inch wall tile and decretive trim was used to surround the water cycling fixtures. Added attention was also provided for the step attached to the power tub enclosure, toilet down spout holes, and power tub access covers.

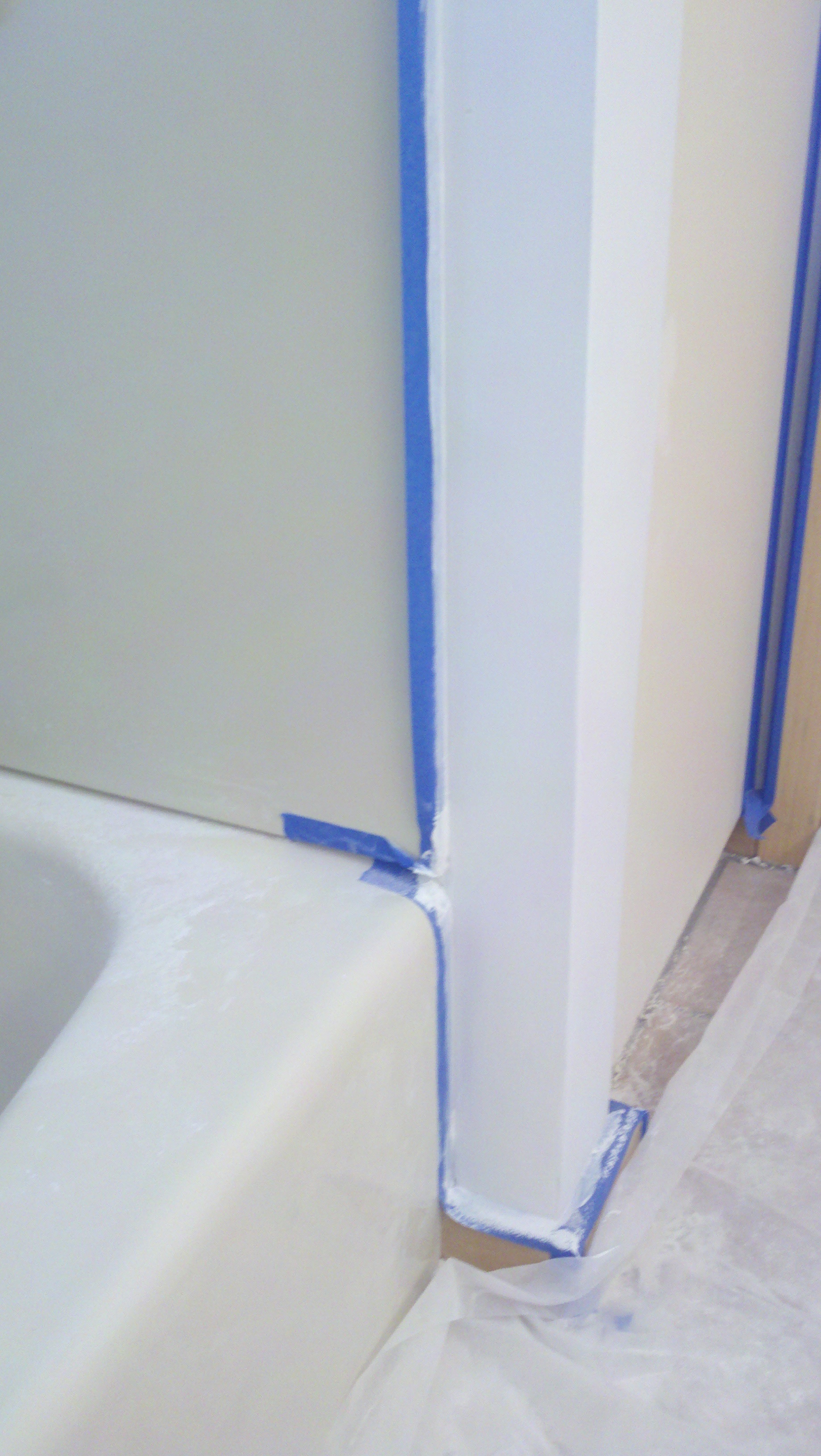

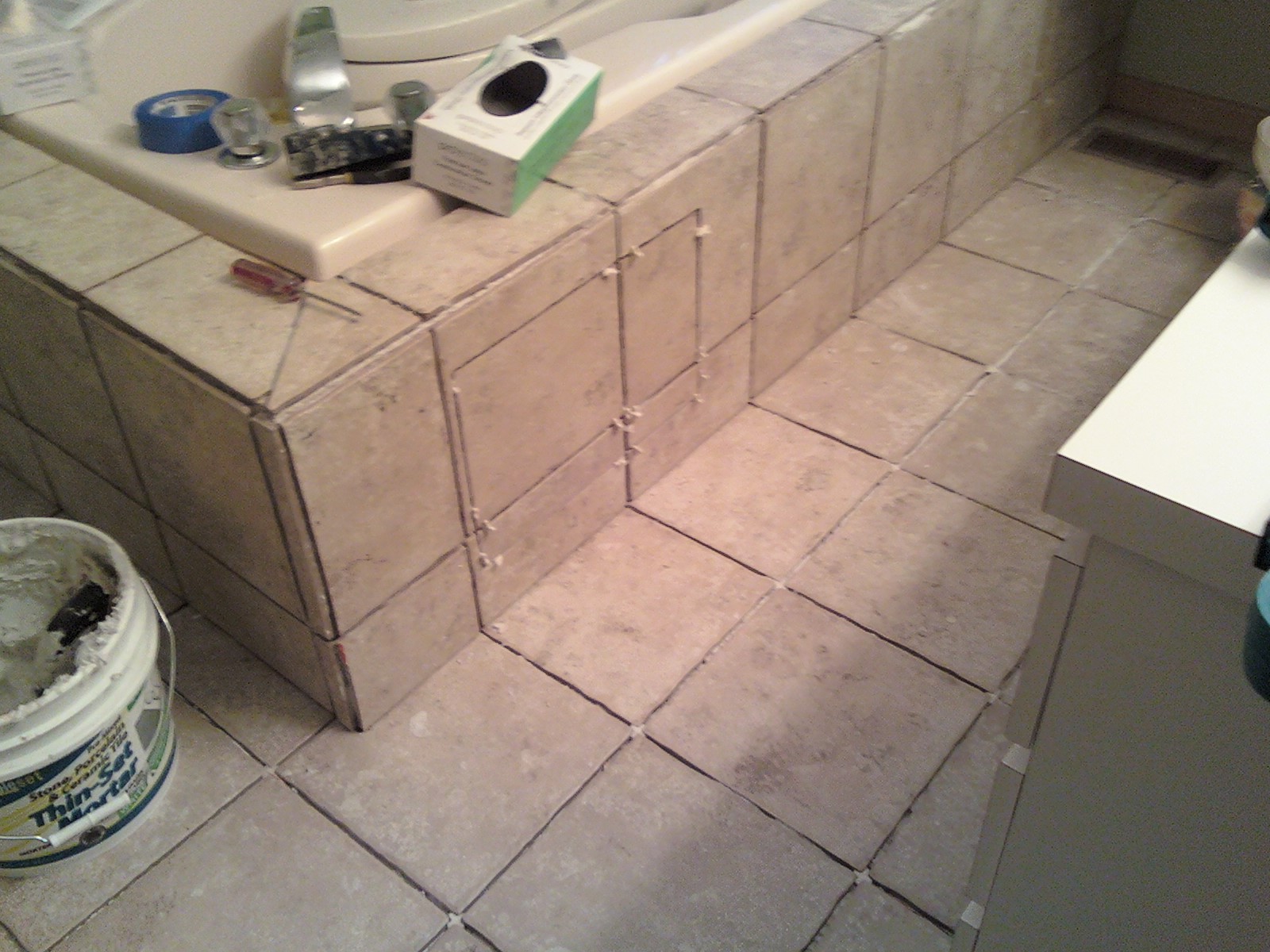

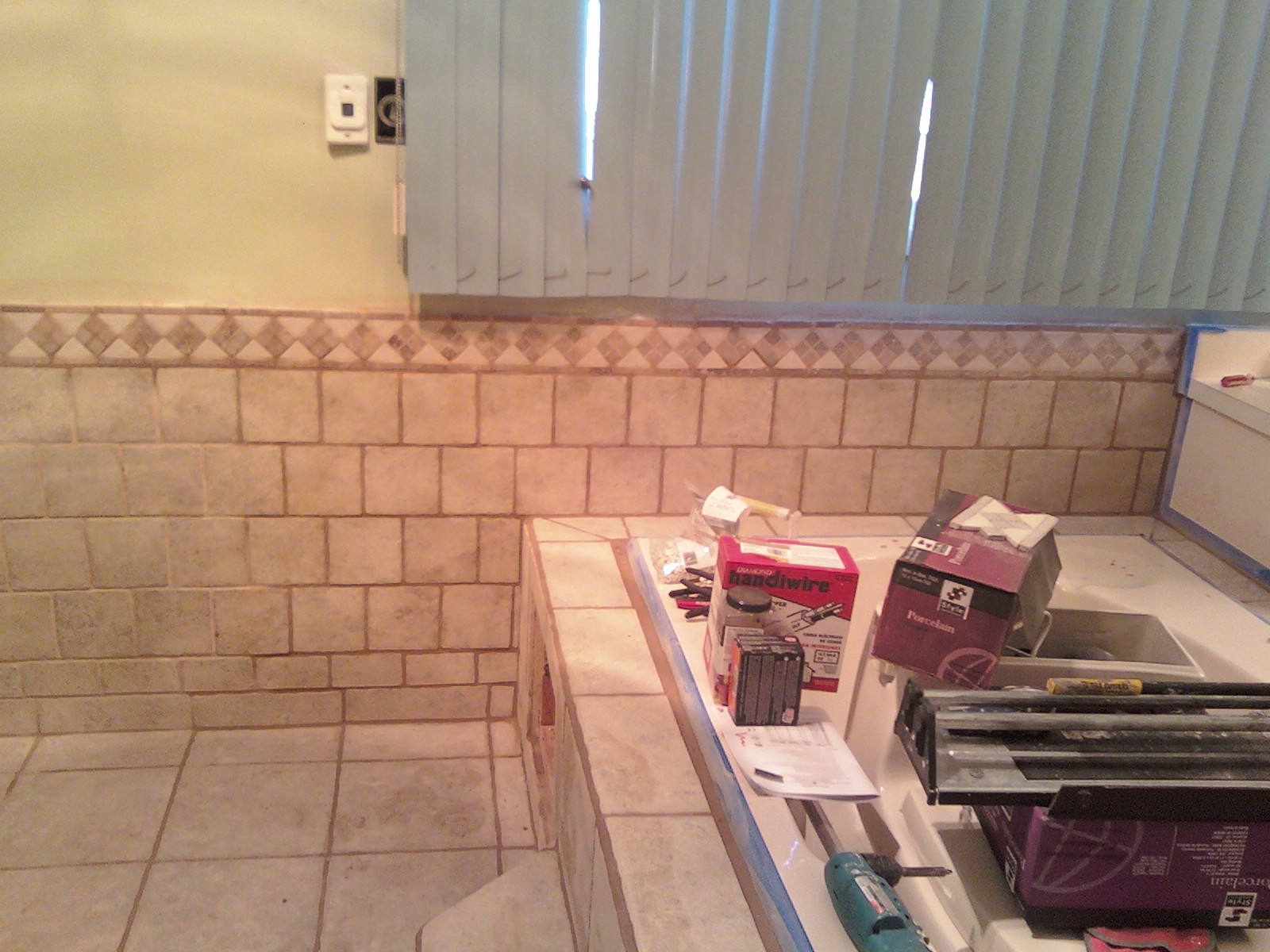

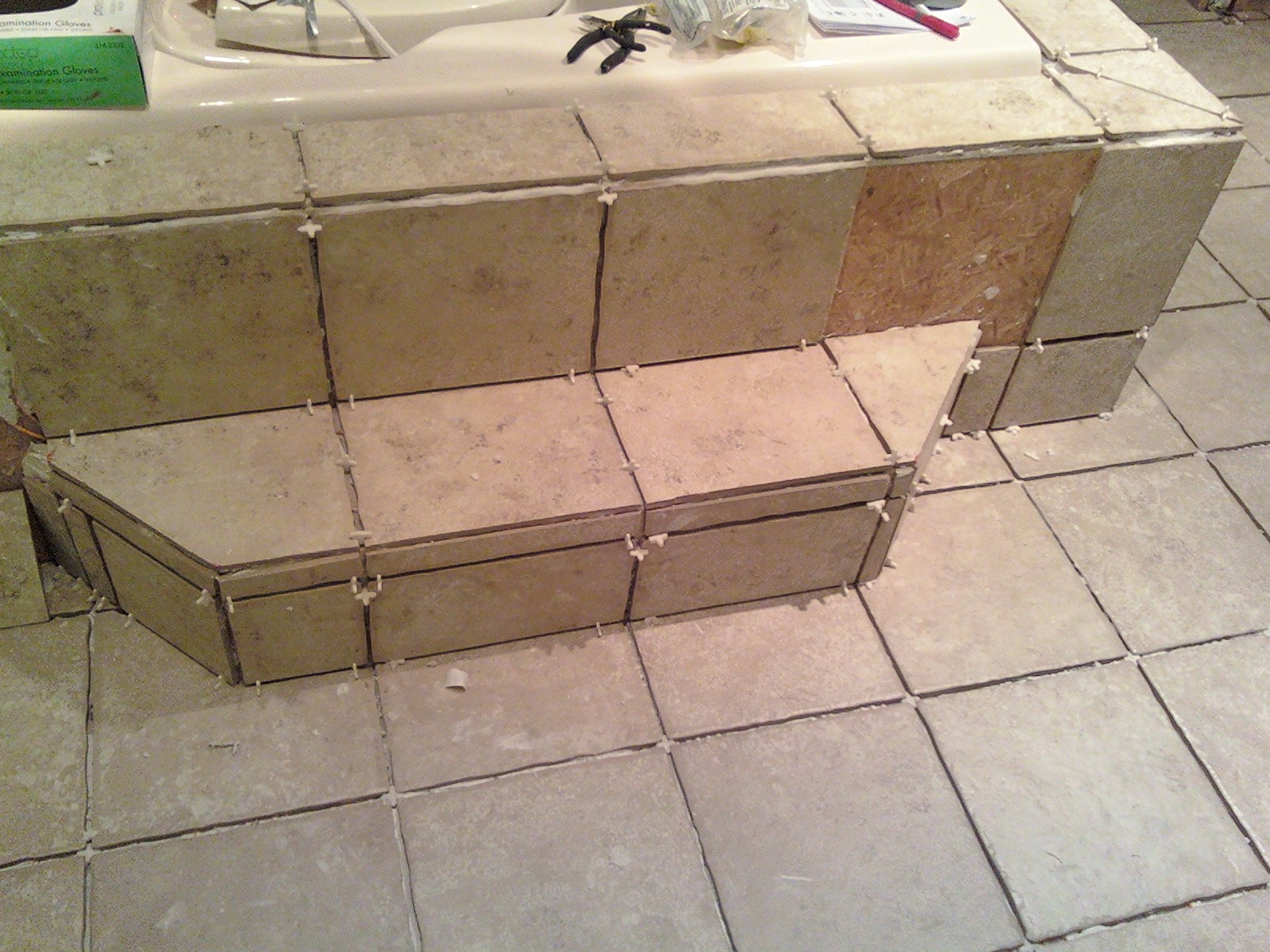

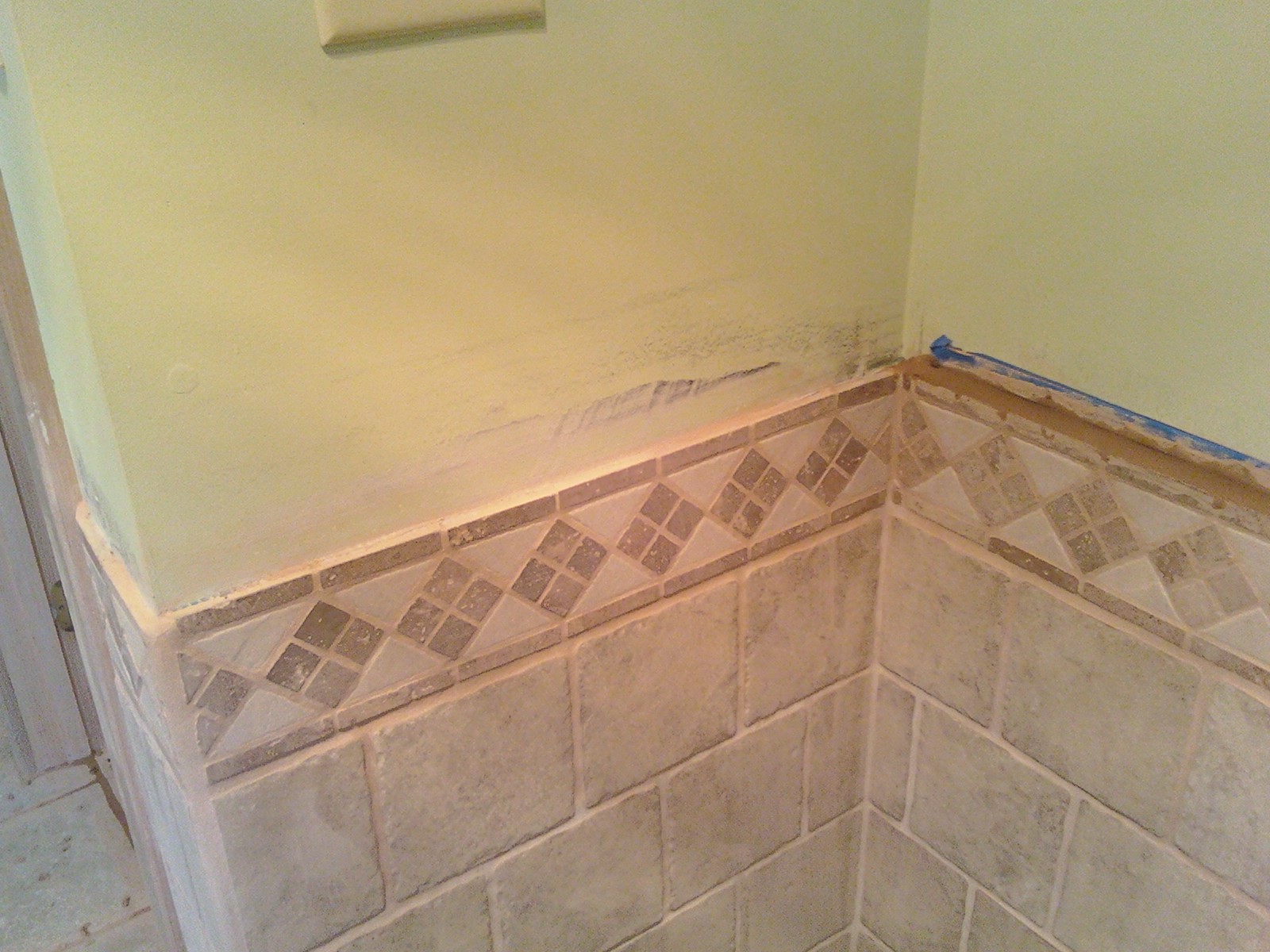

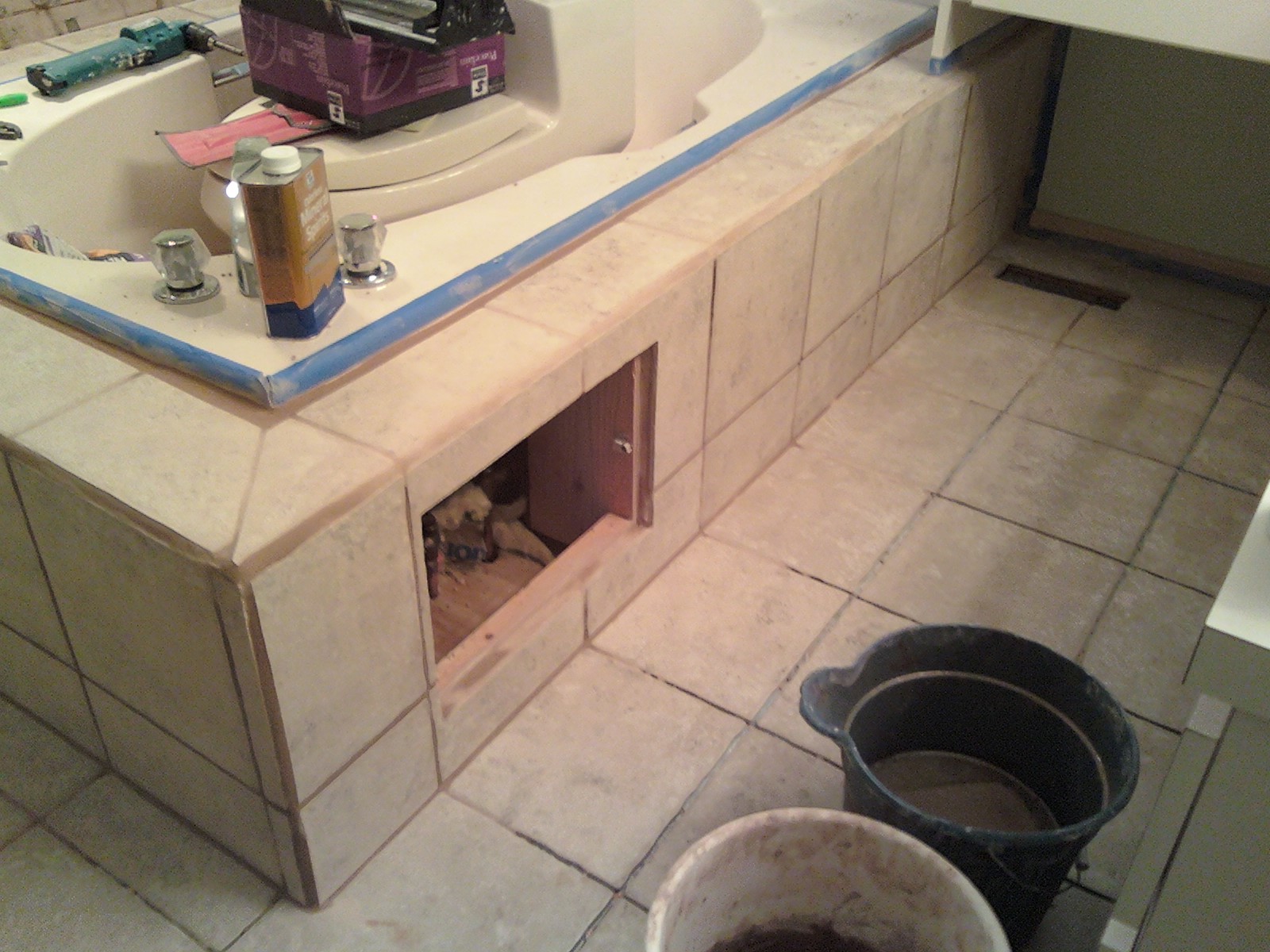

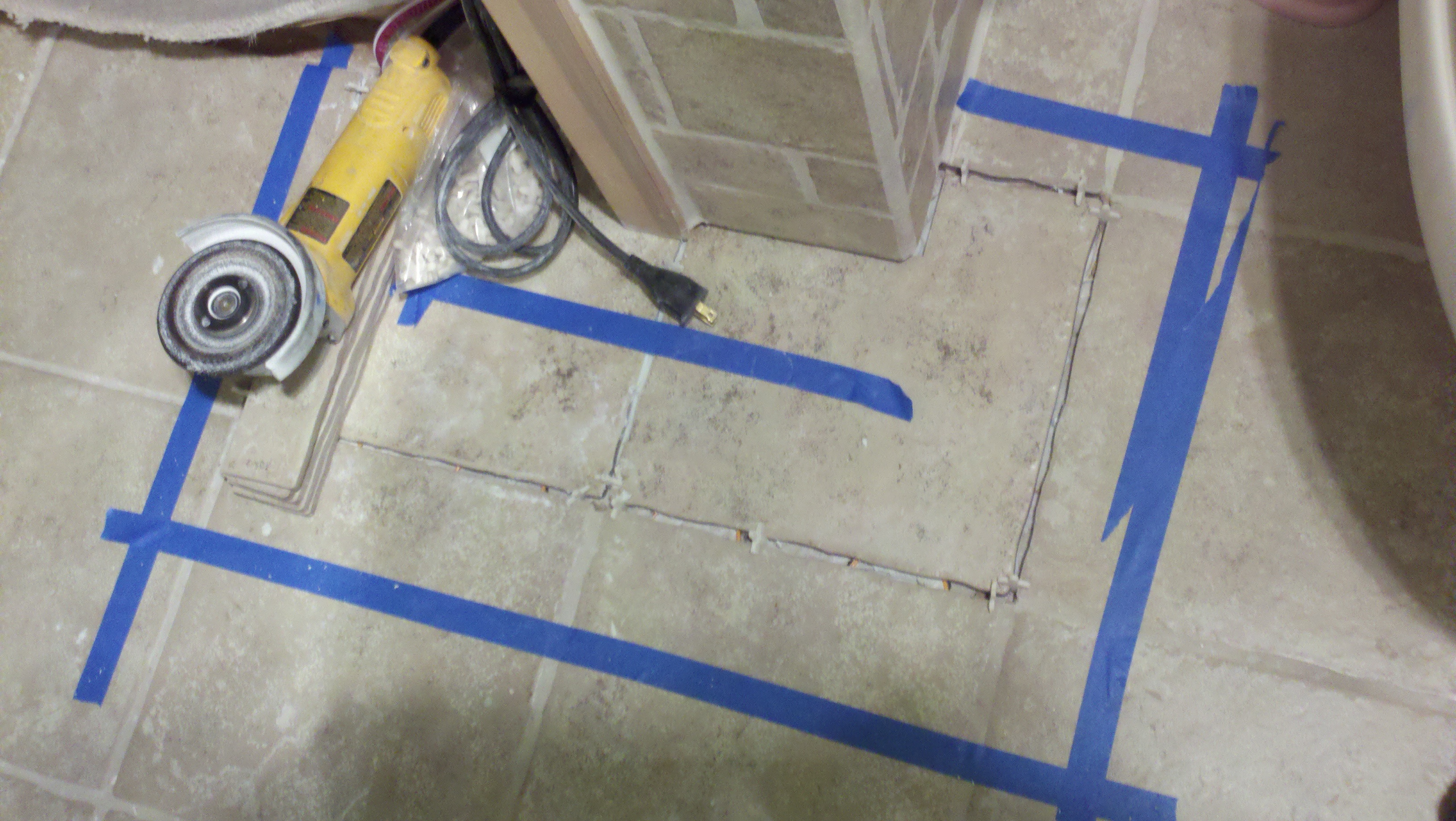

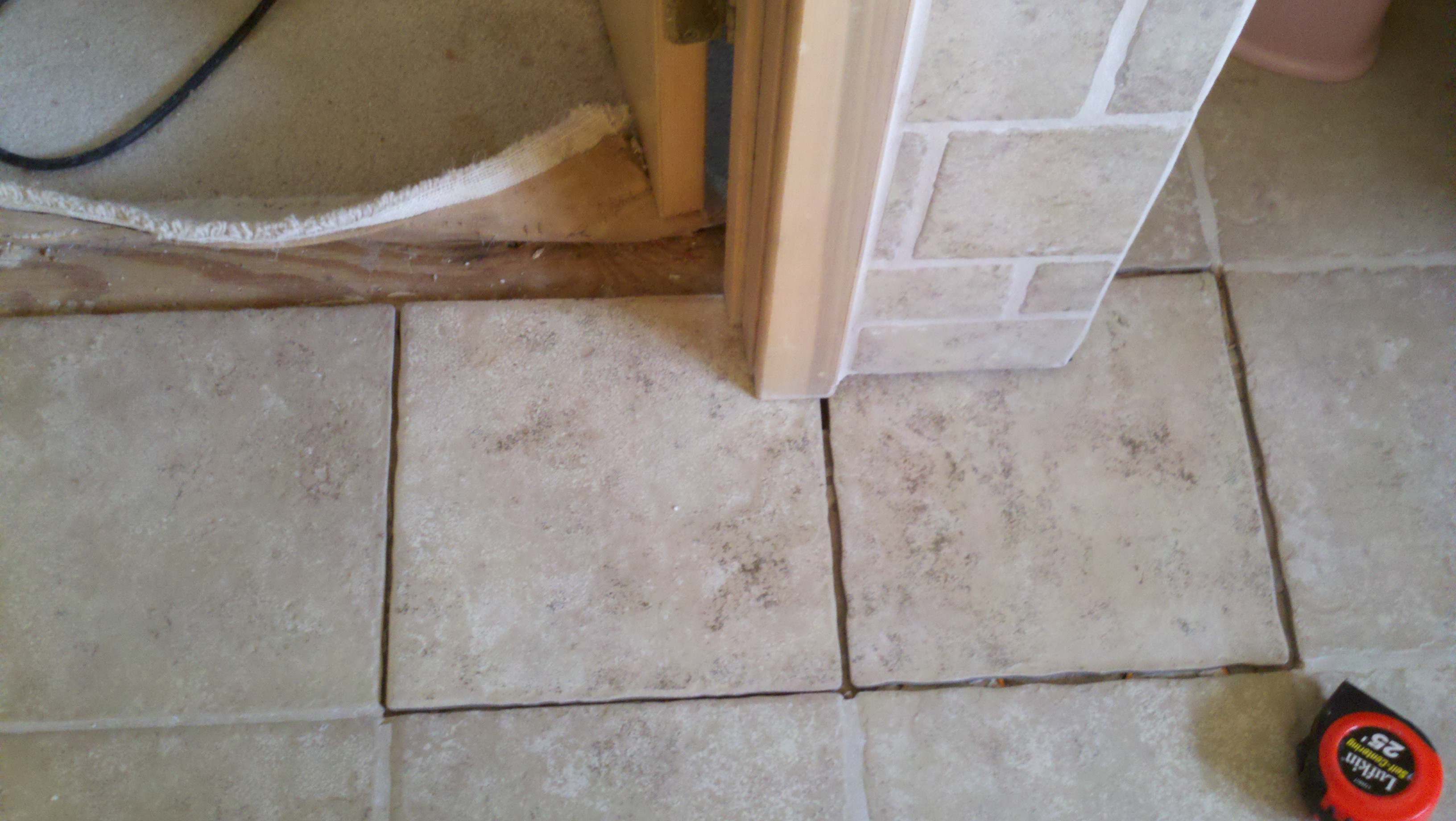

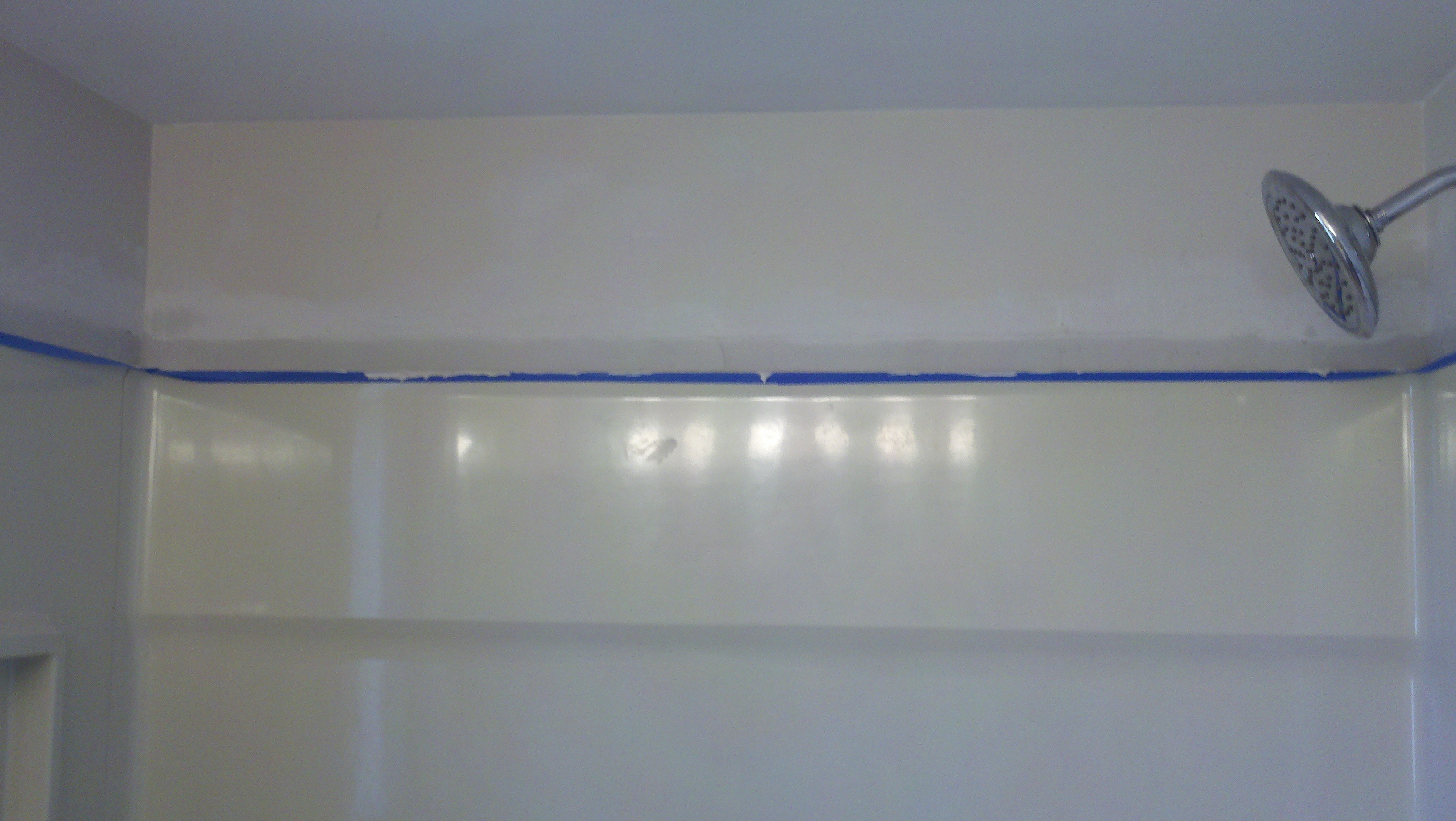

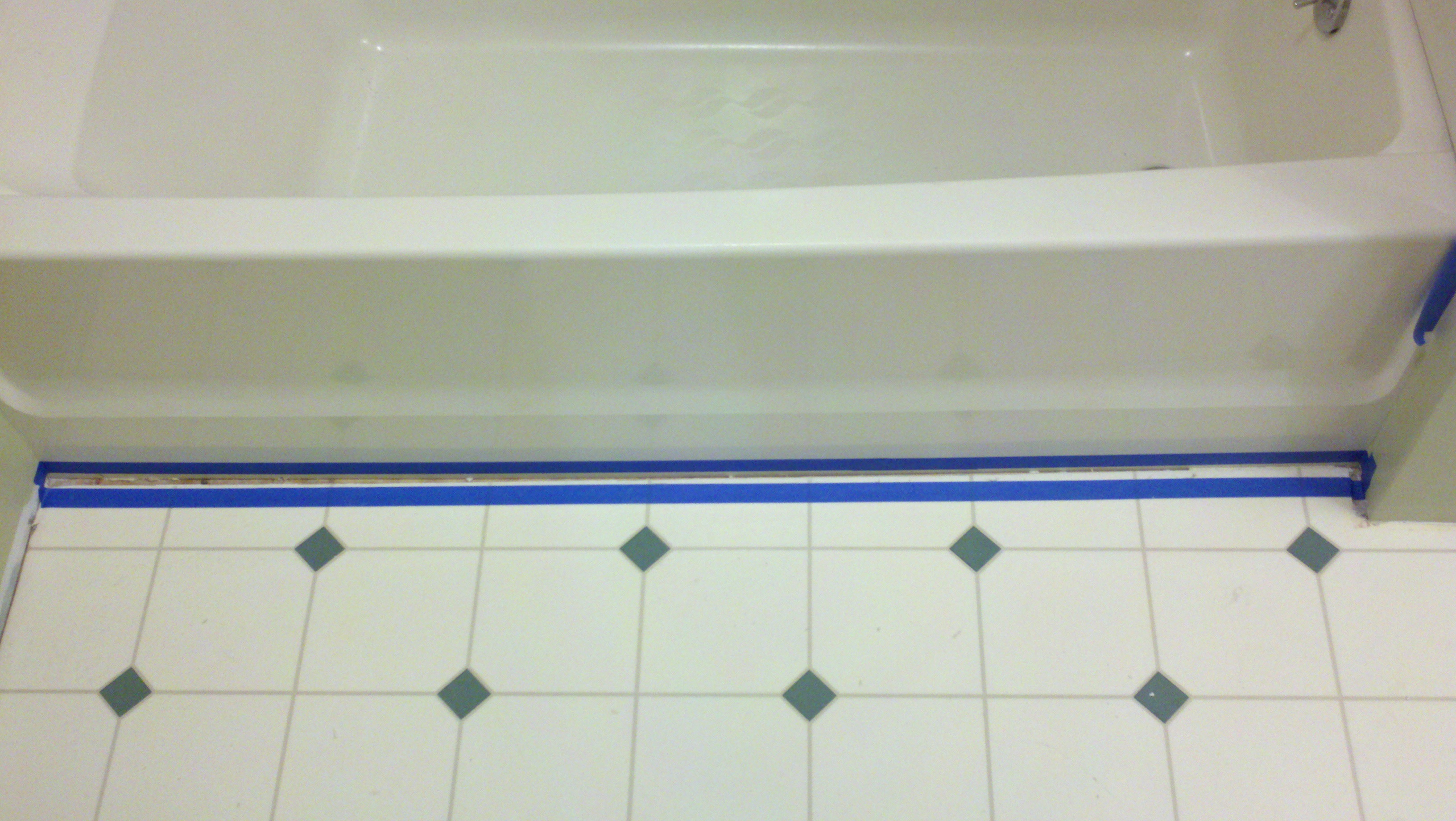

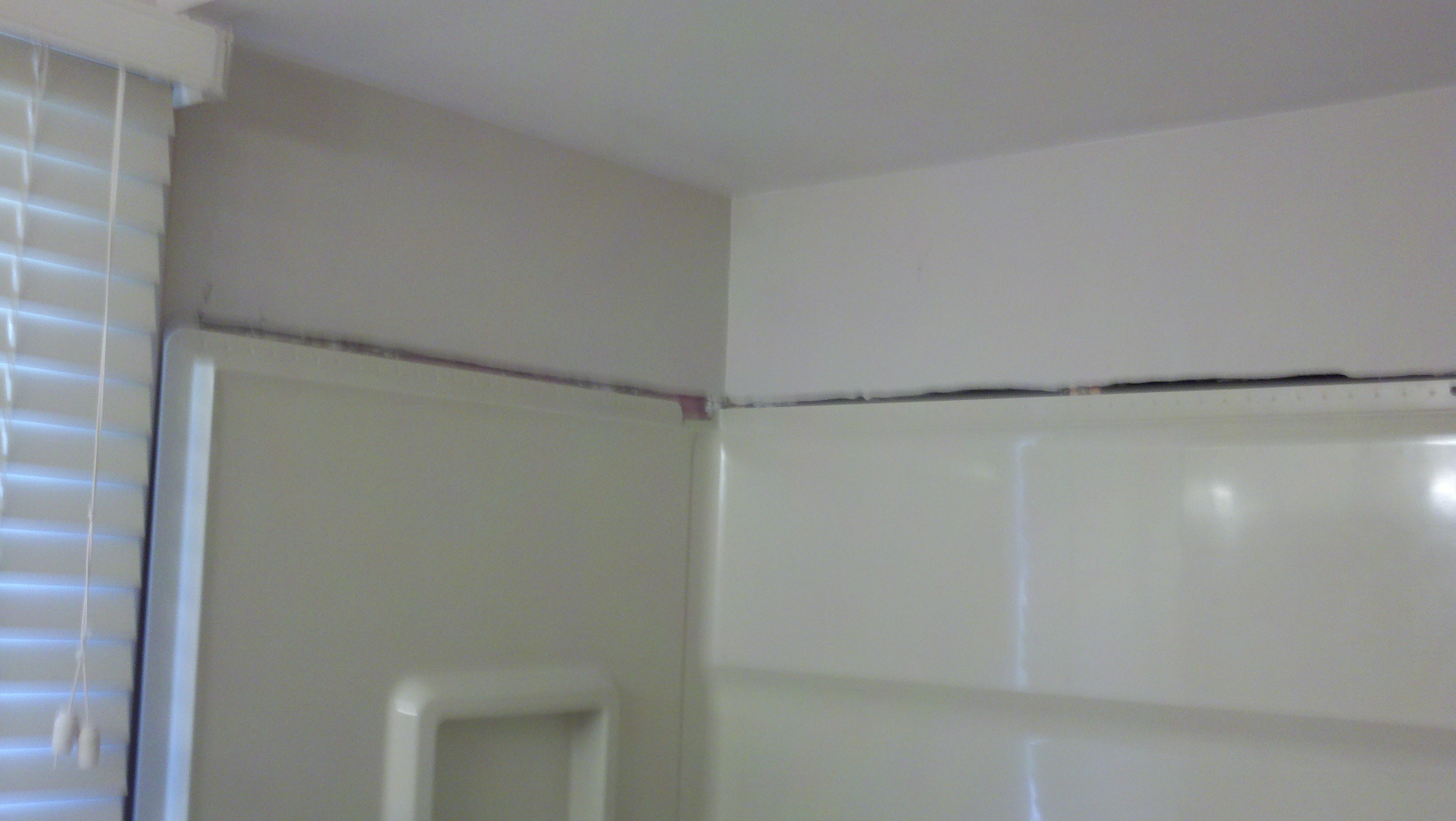

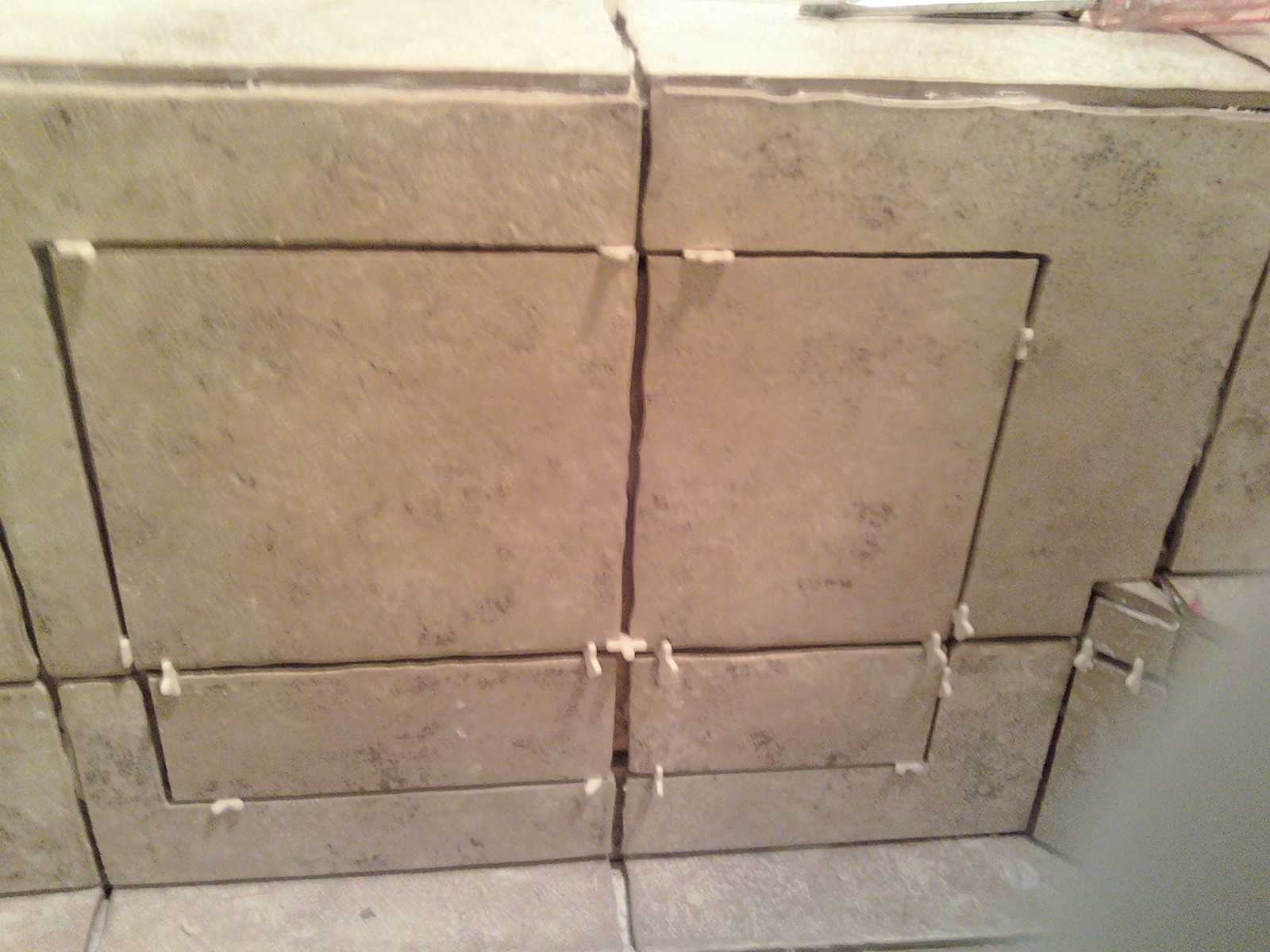

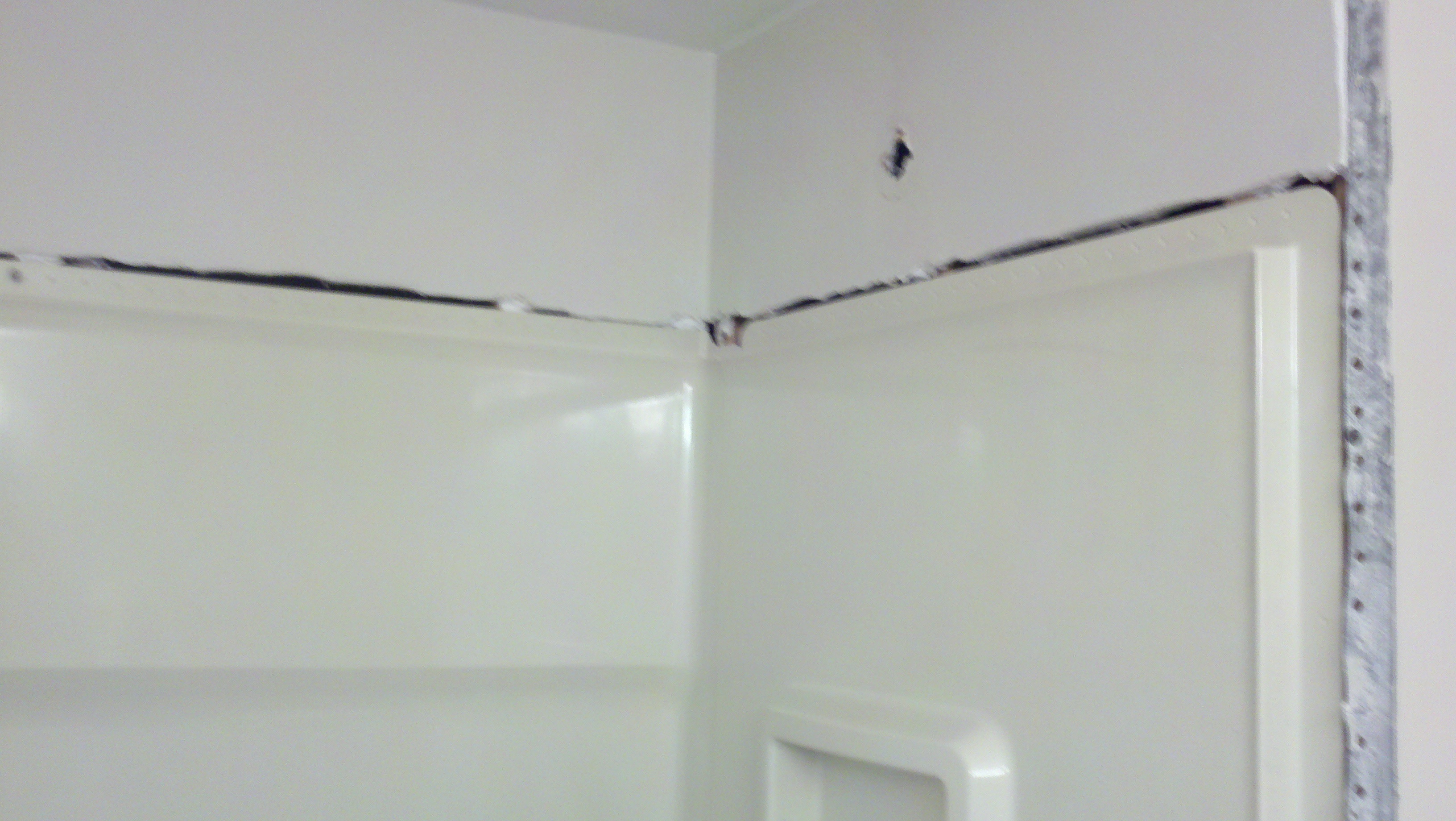

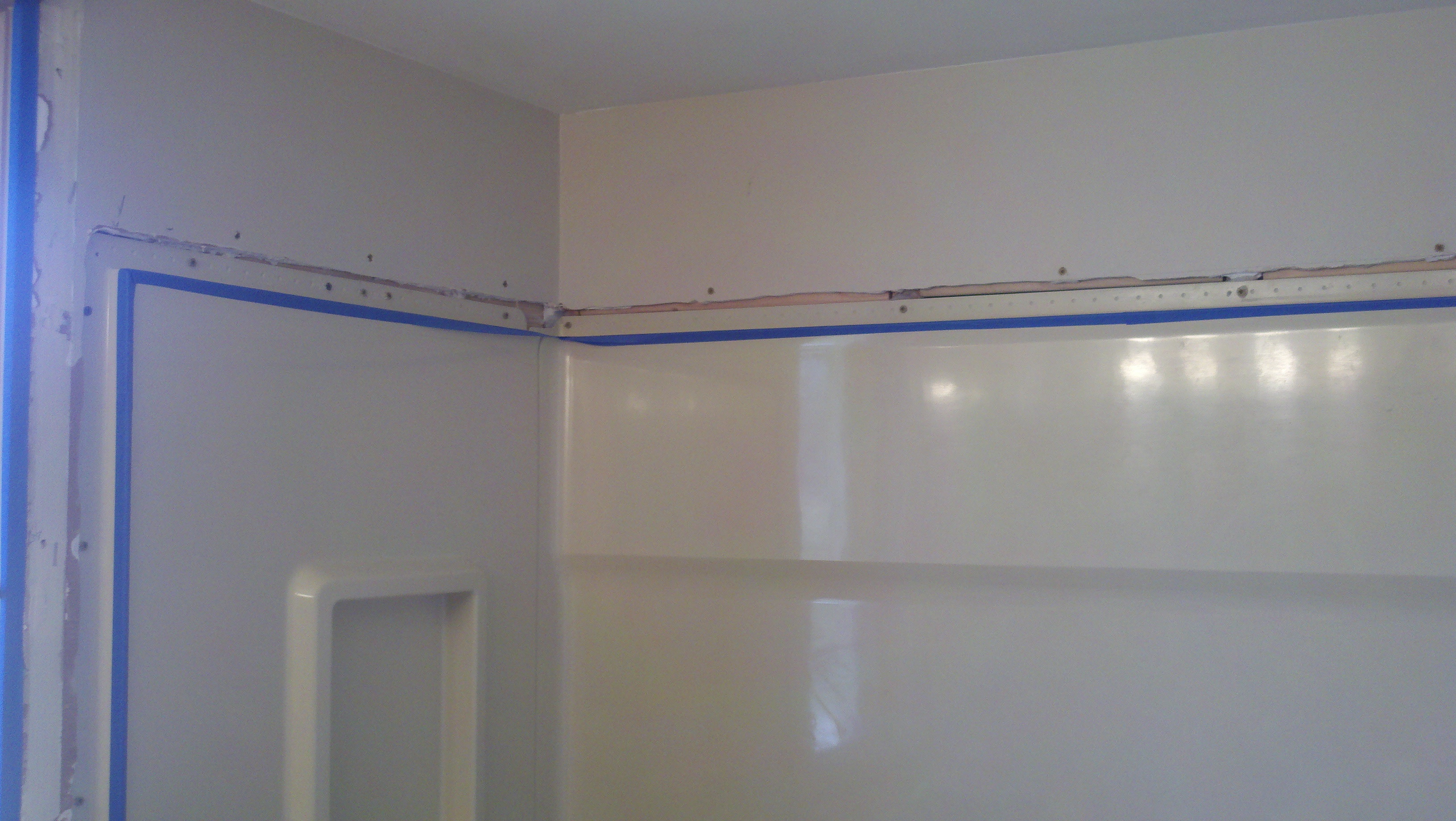

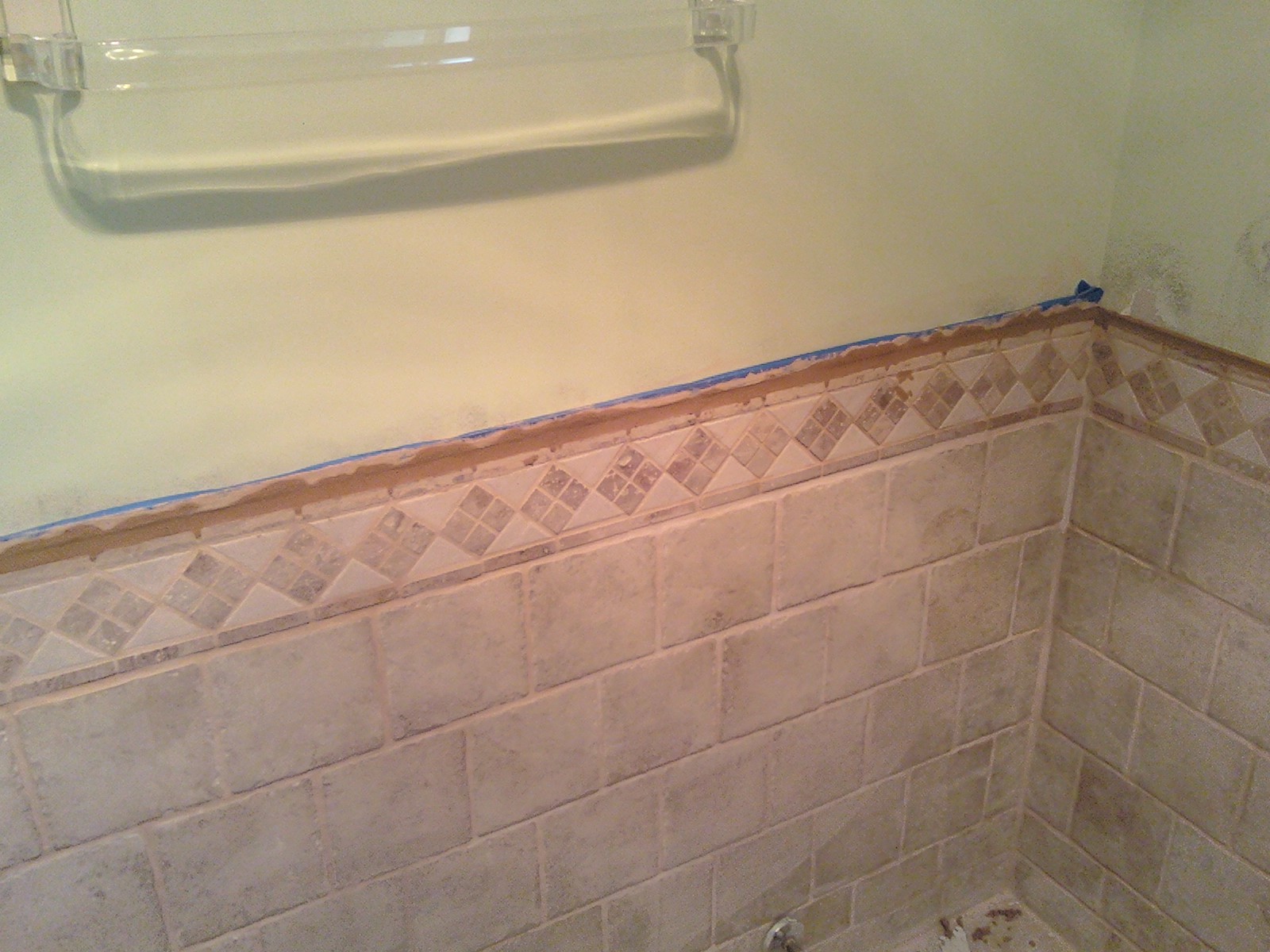

Connecting the tile through application of mortar provided the desired finish appearance. The application of grout provided many tasks and problems that needed to be conquered. Edges of the power tub enclosure and at top of the wall tile needed to be sculptured to a round shape, by hand and friction oriented tools. The following pictures provide some supplementary information about the dirty process.

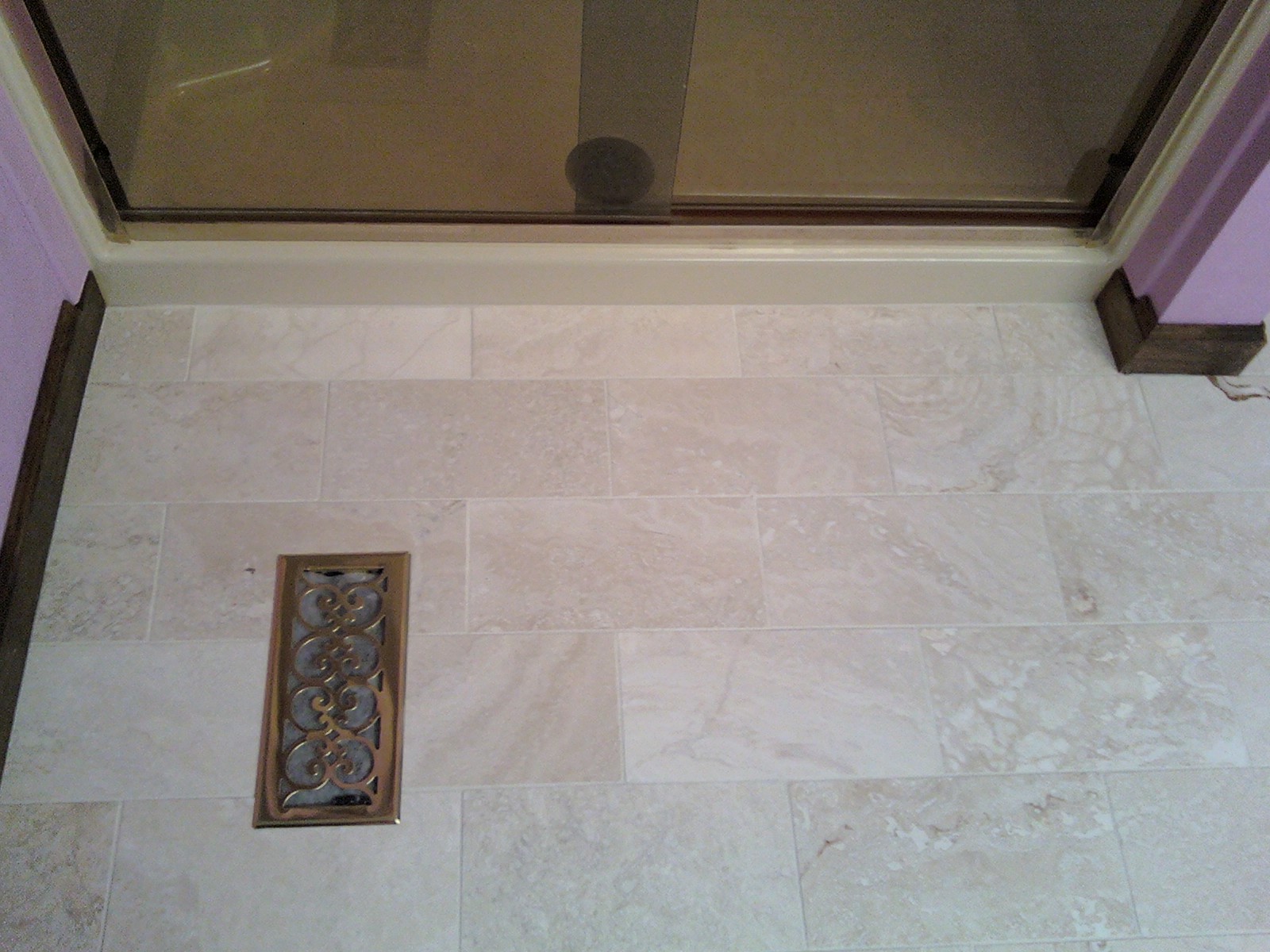

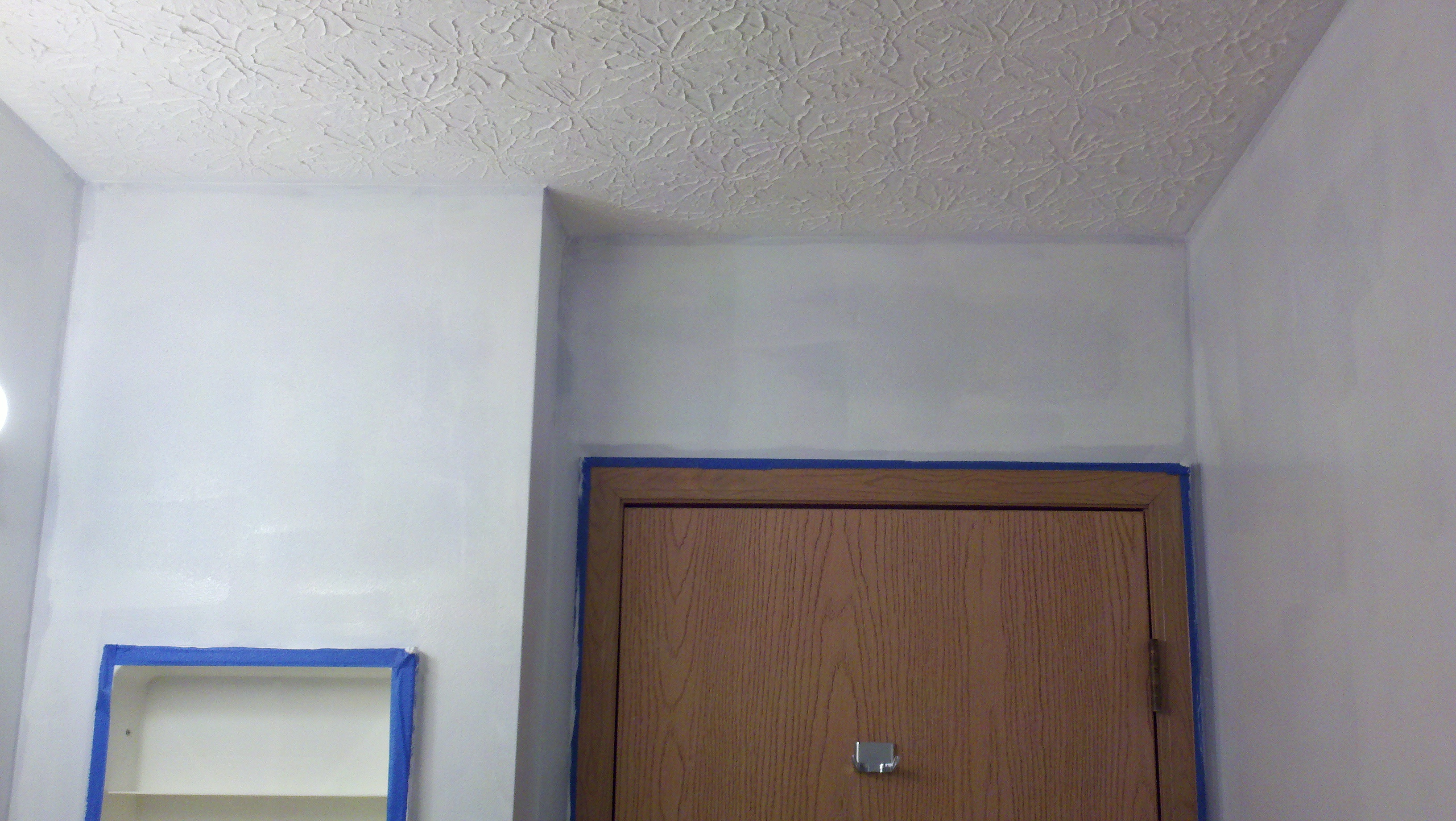

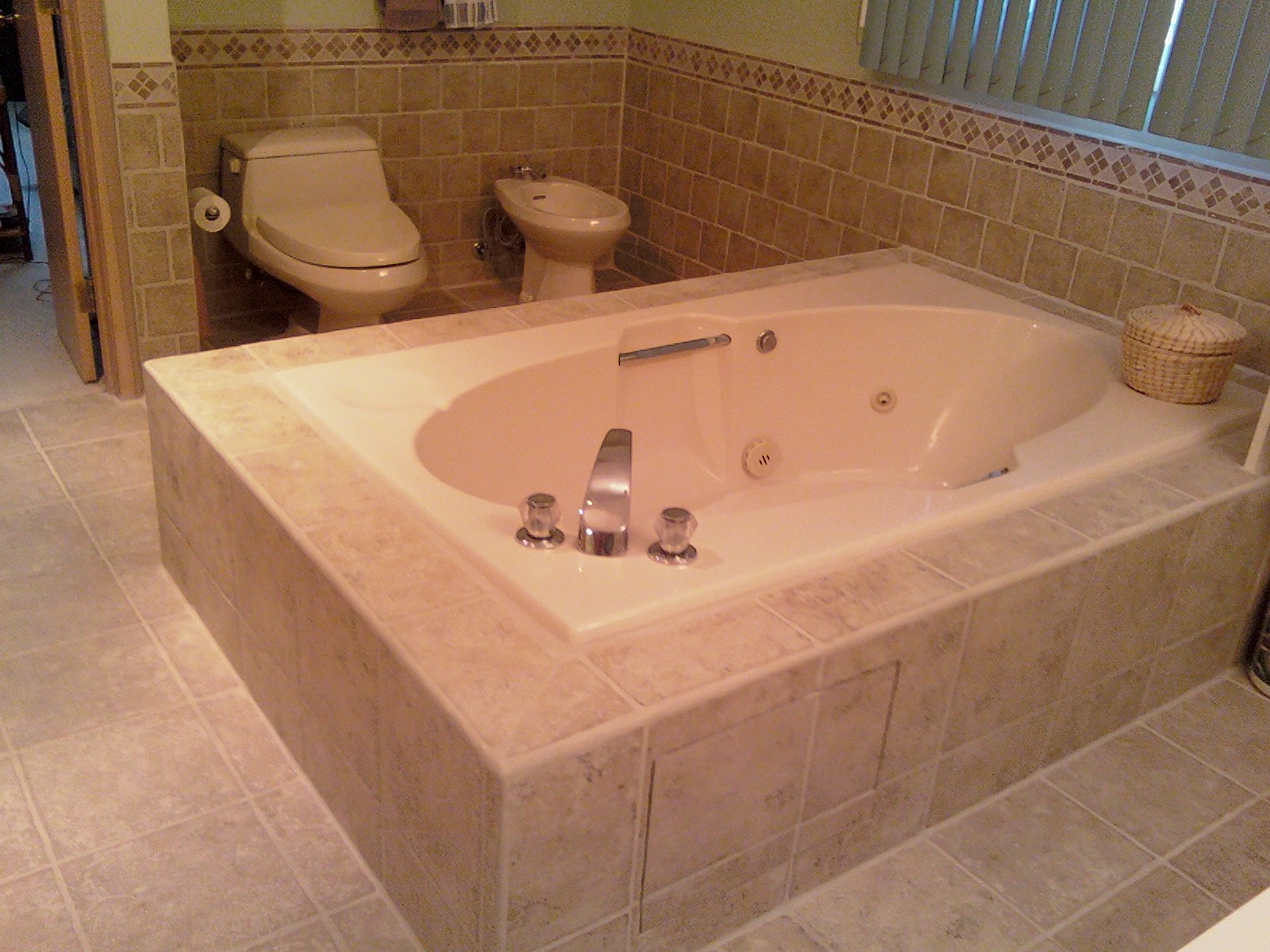

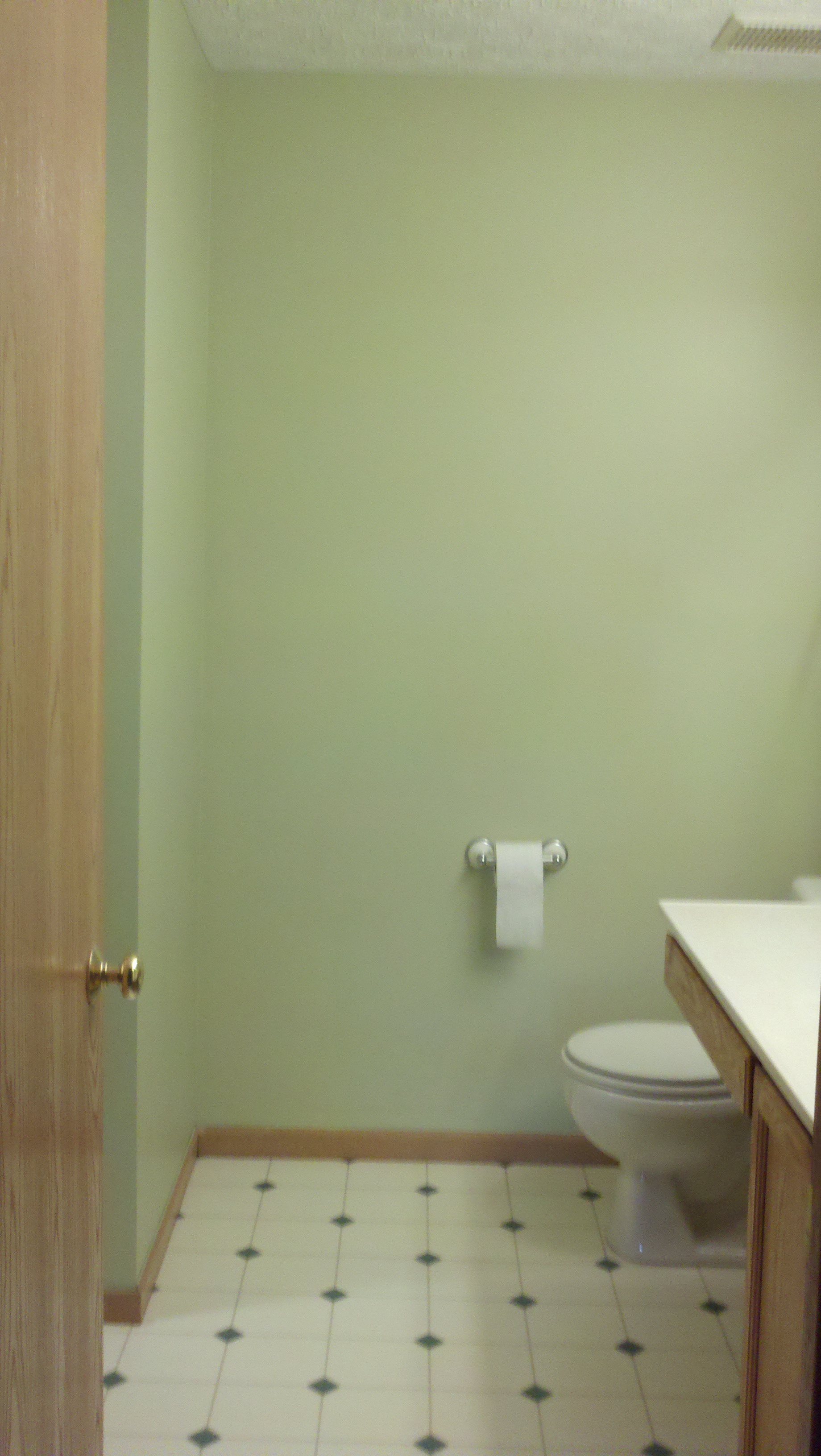

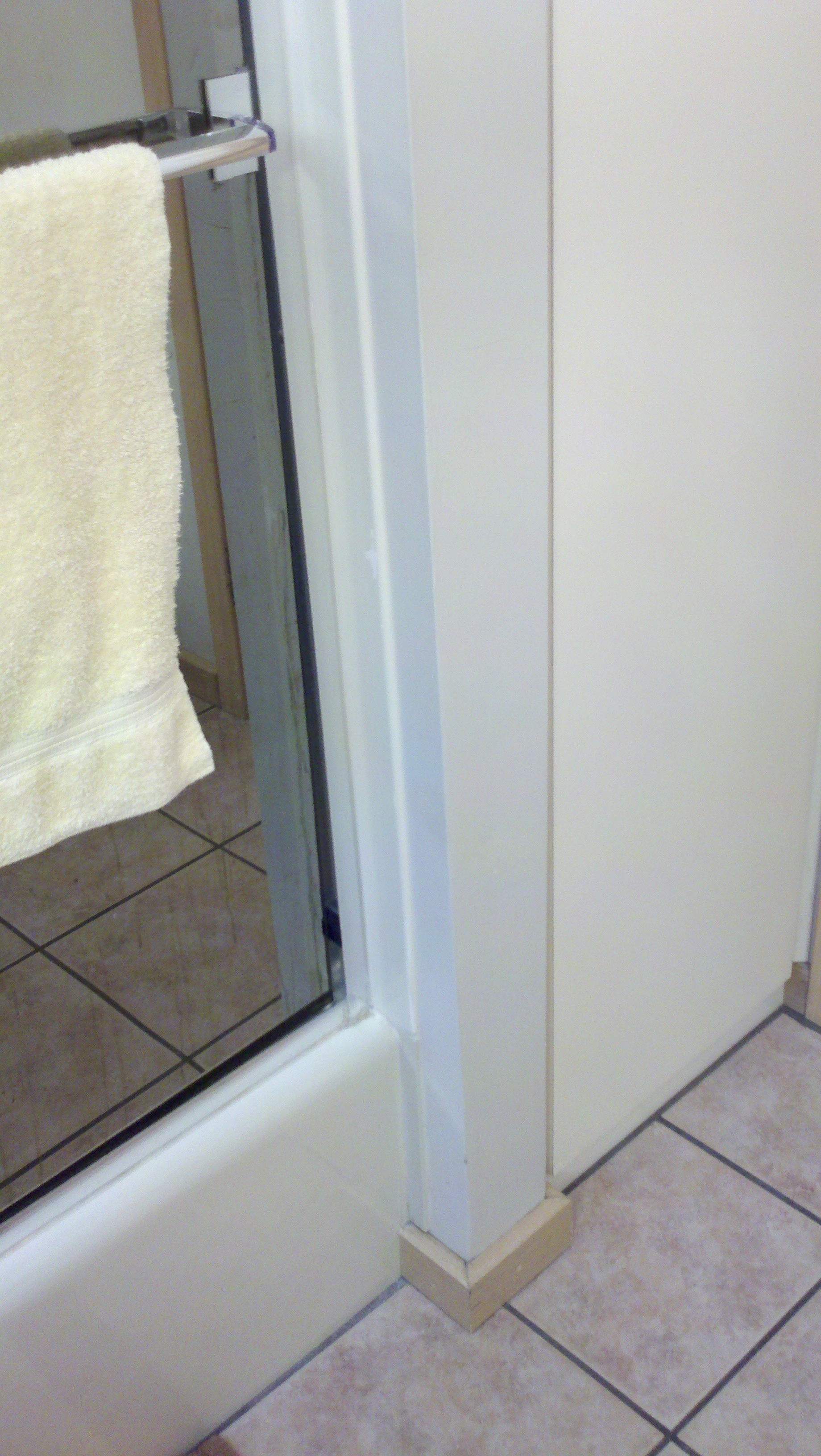

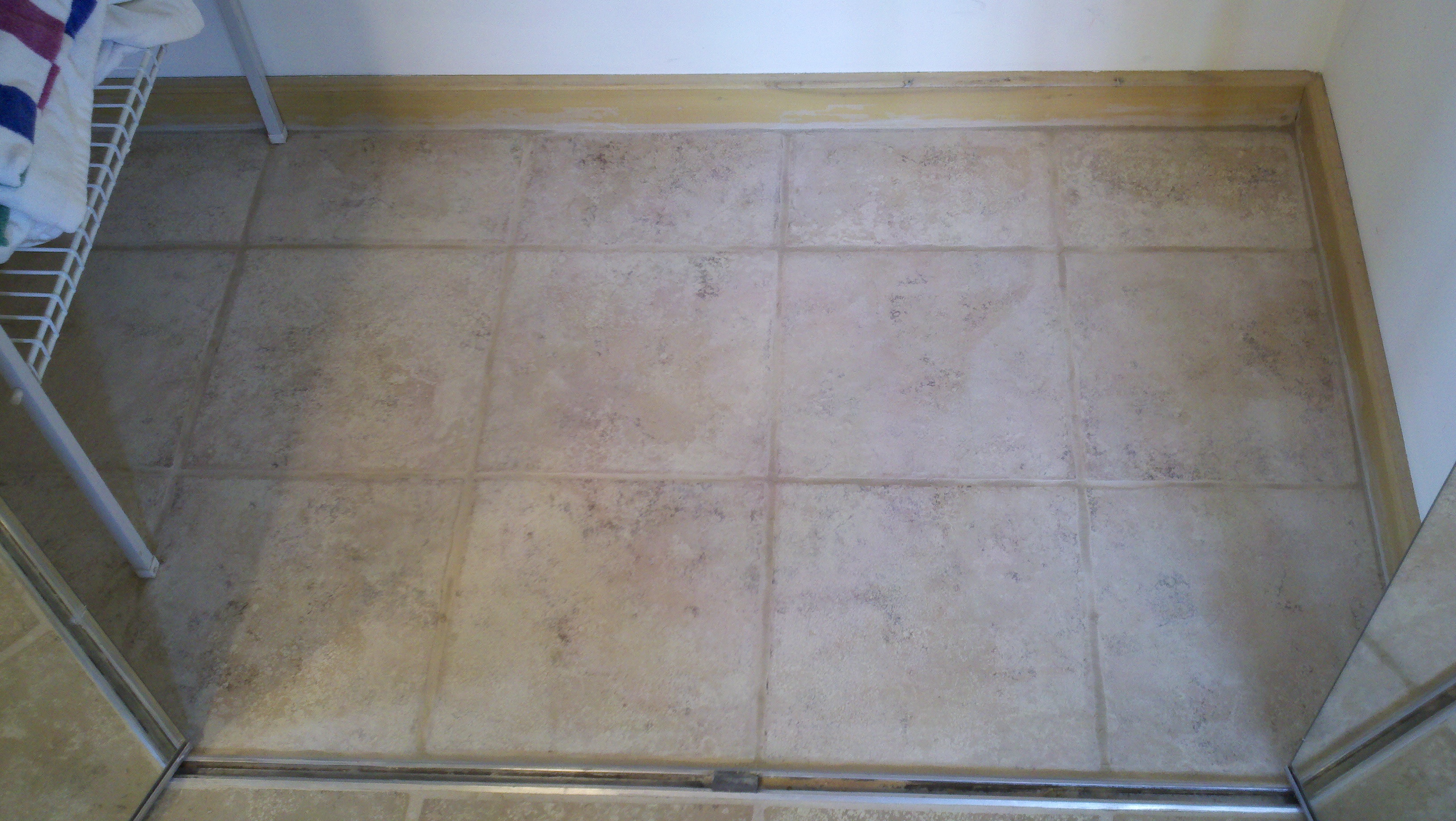

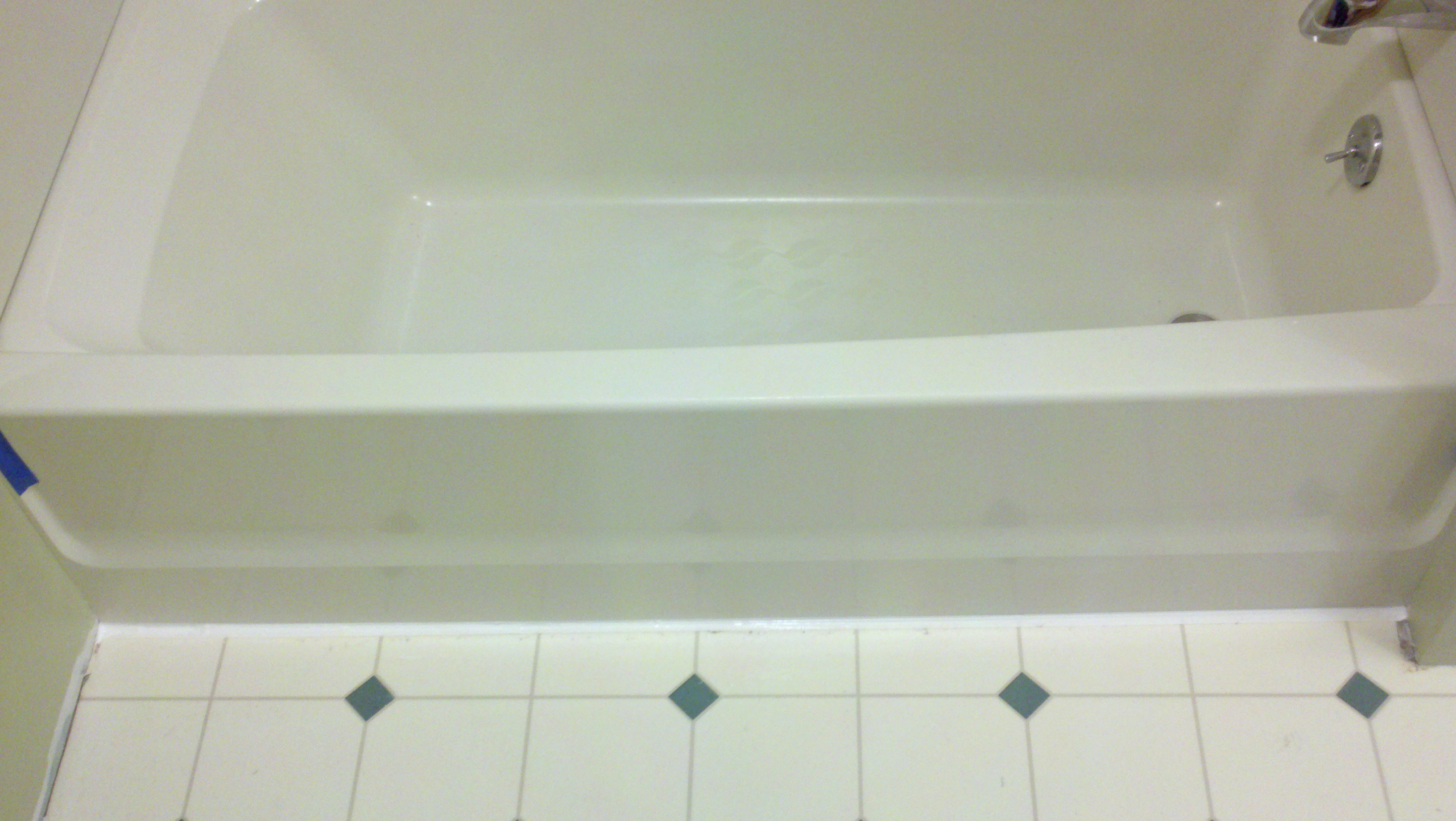

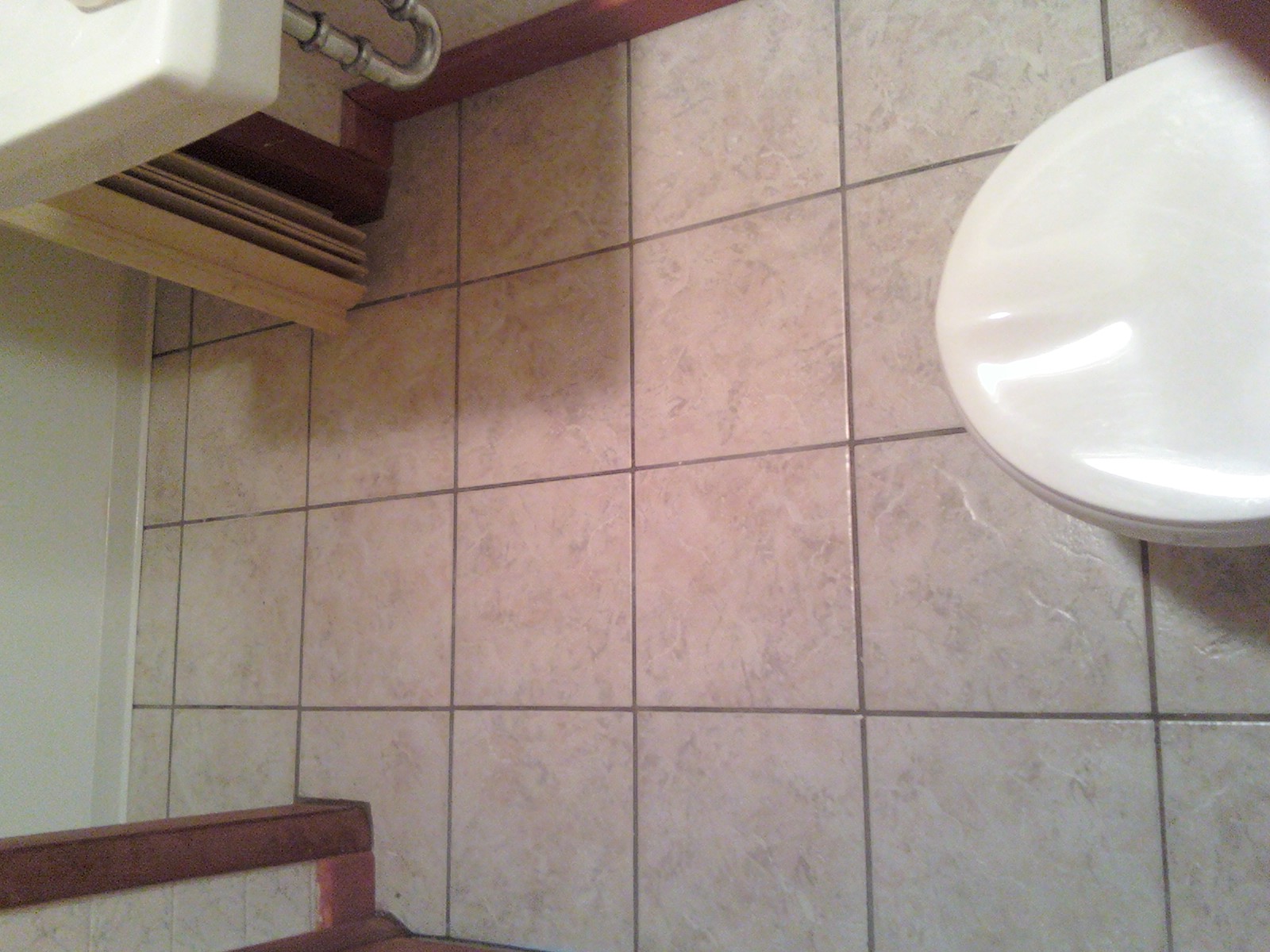

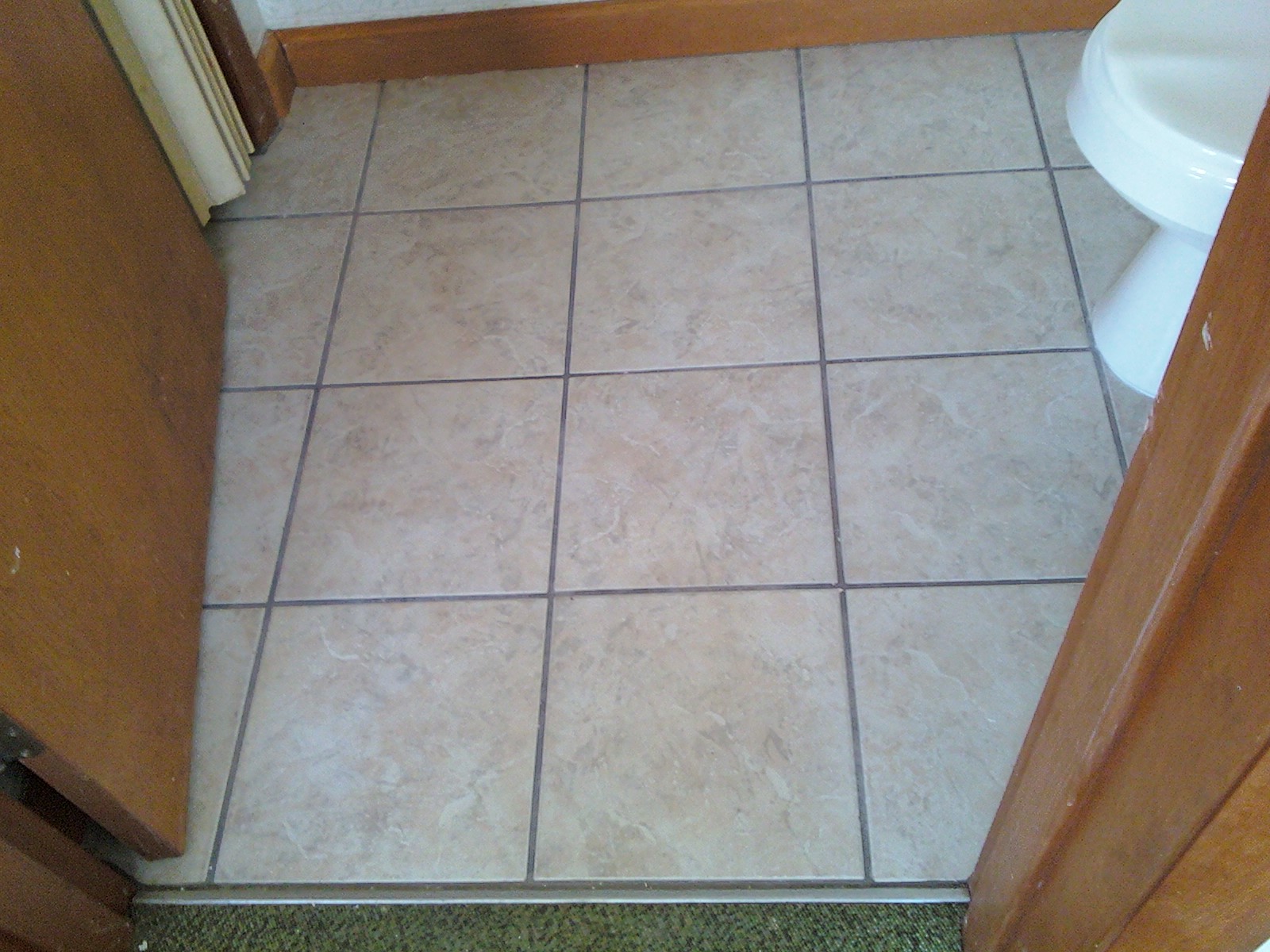

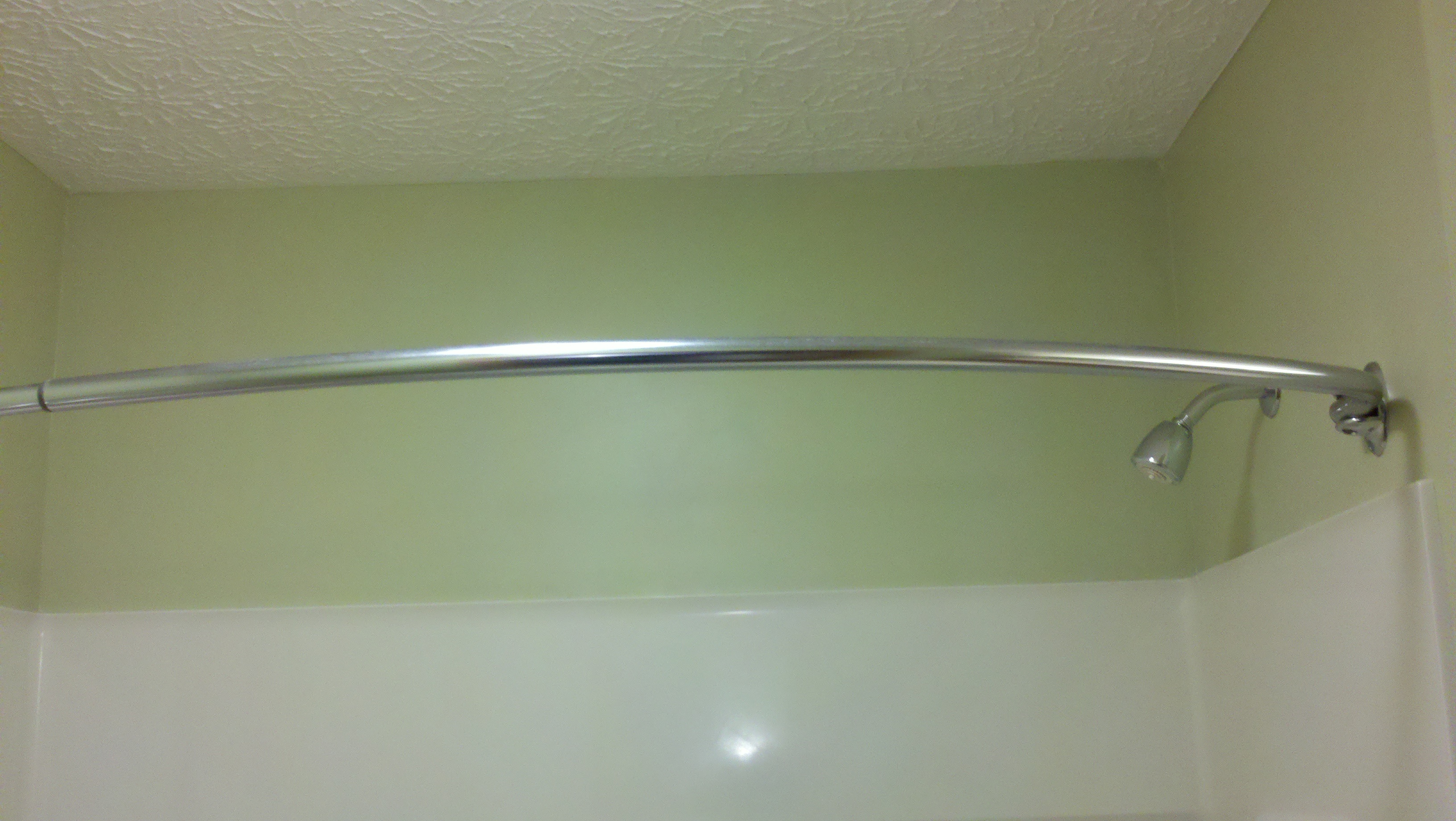

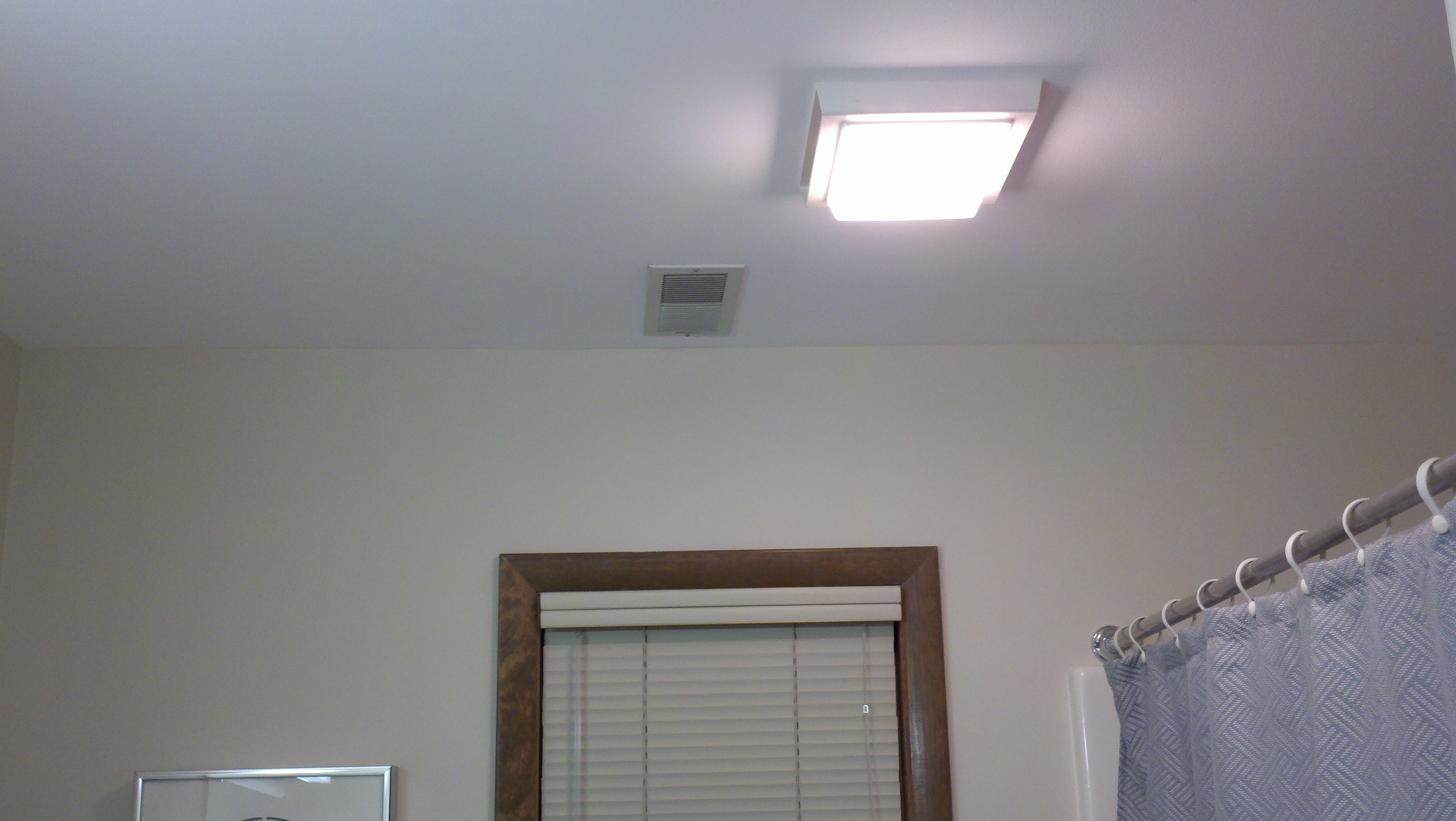

The final pictures show the completion of the electric heat floor and tile installation. Doors were installed back to the original specifications. Final cleaning was performed and considered to be acceptable by Stanley & Carolyn. The remaining pictures are labeled fifty-seven through sixty-three.

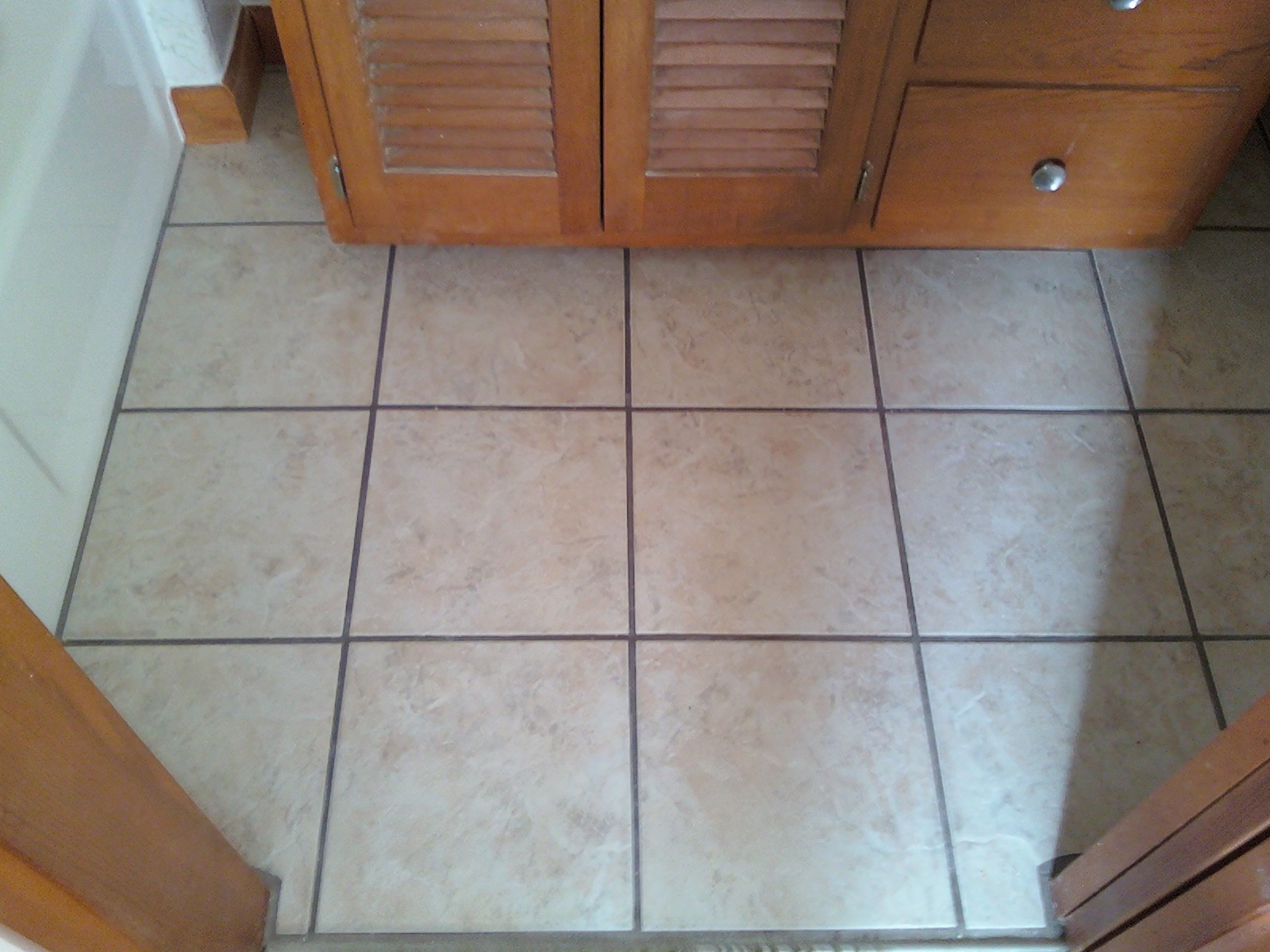

A few months past the completion date, a change in grout color was chosen to apply a thin layer over the original selection. The remaining pictures provide the final appearance of the bathroom.
|
|

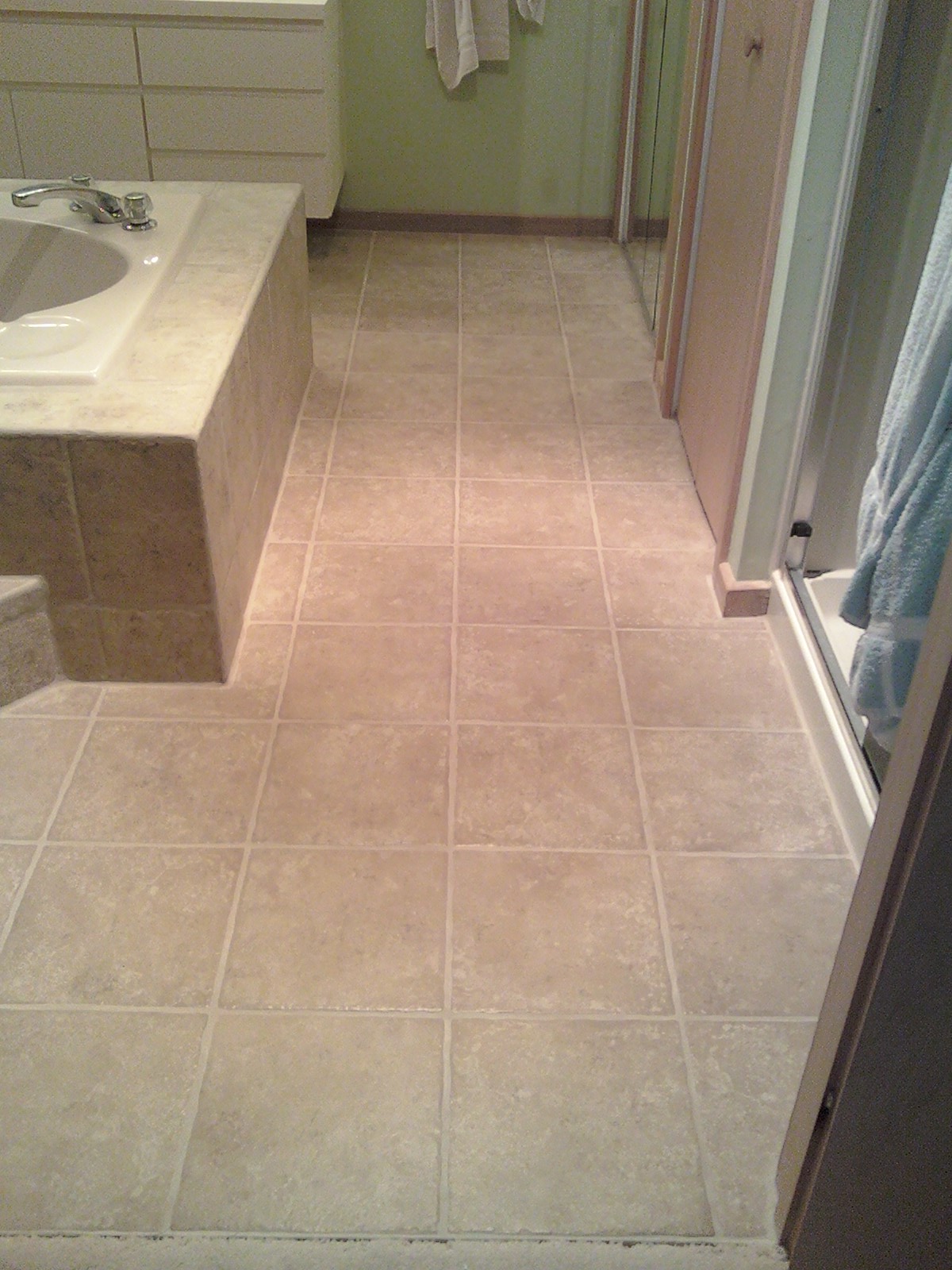

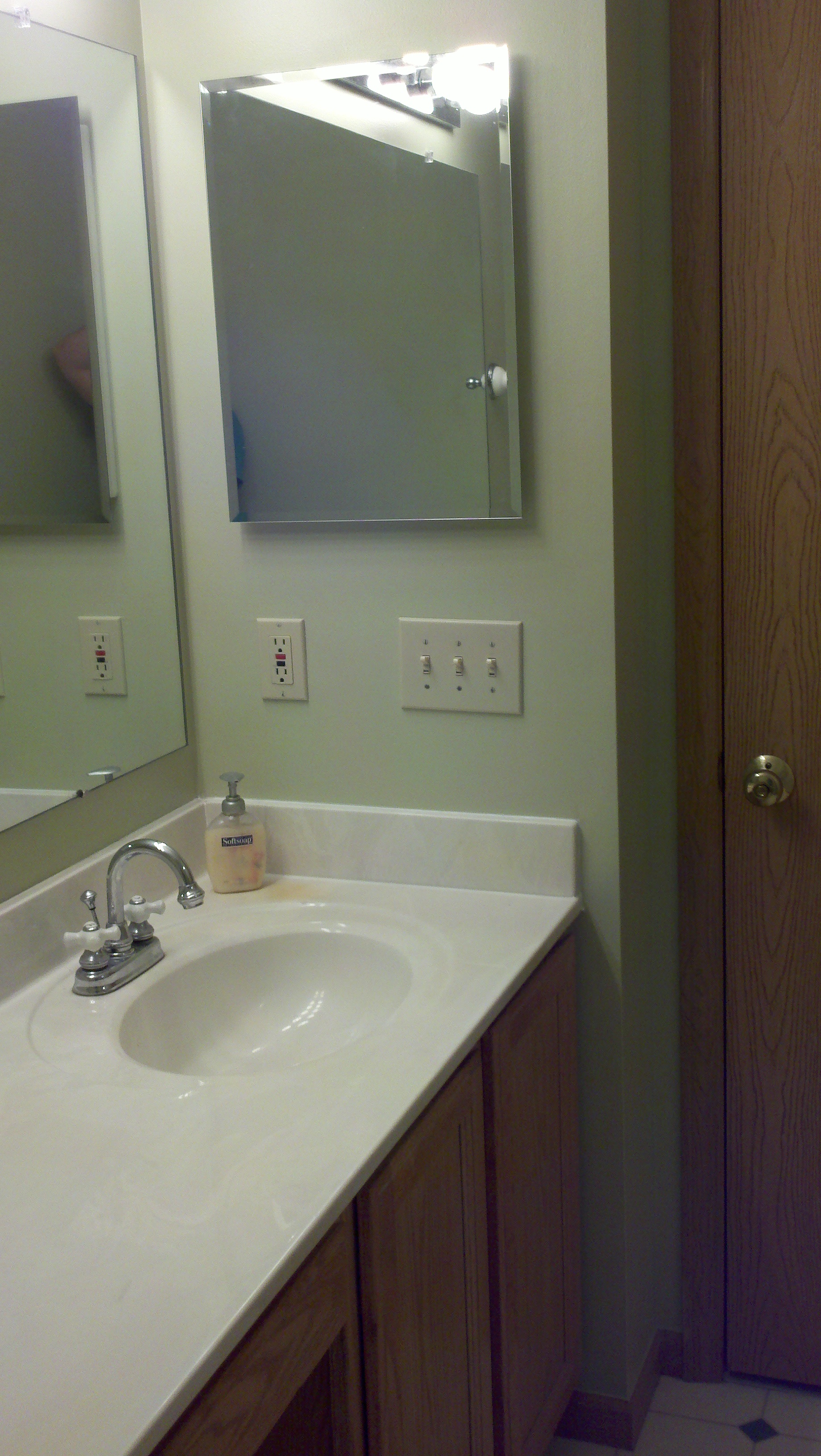

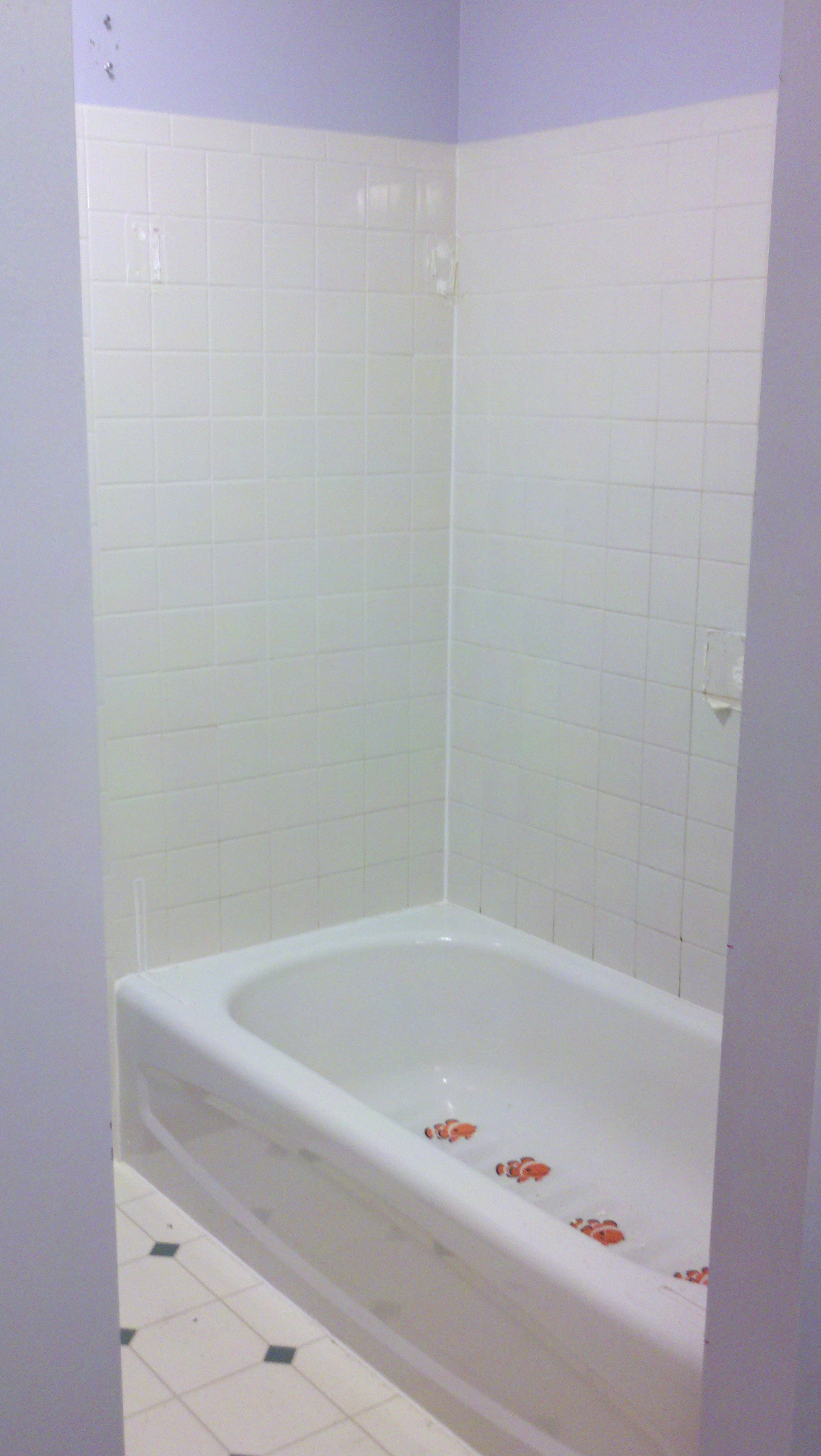

Upstairs Bathroom, 5137
Pebble Brook Drive

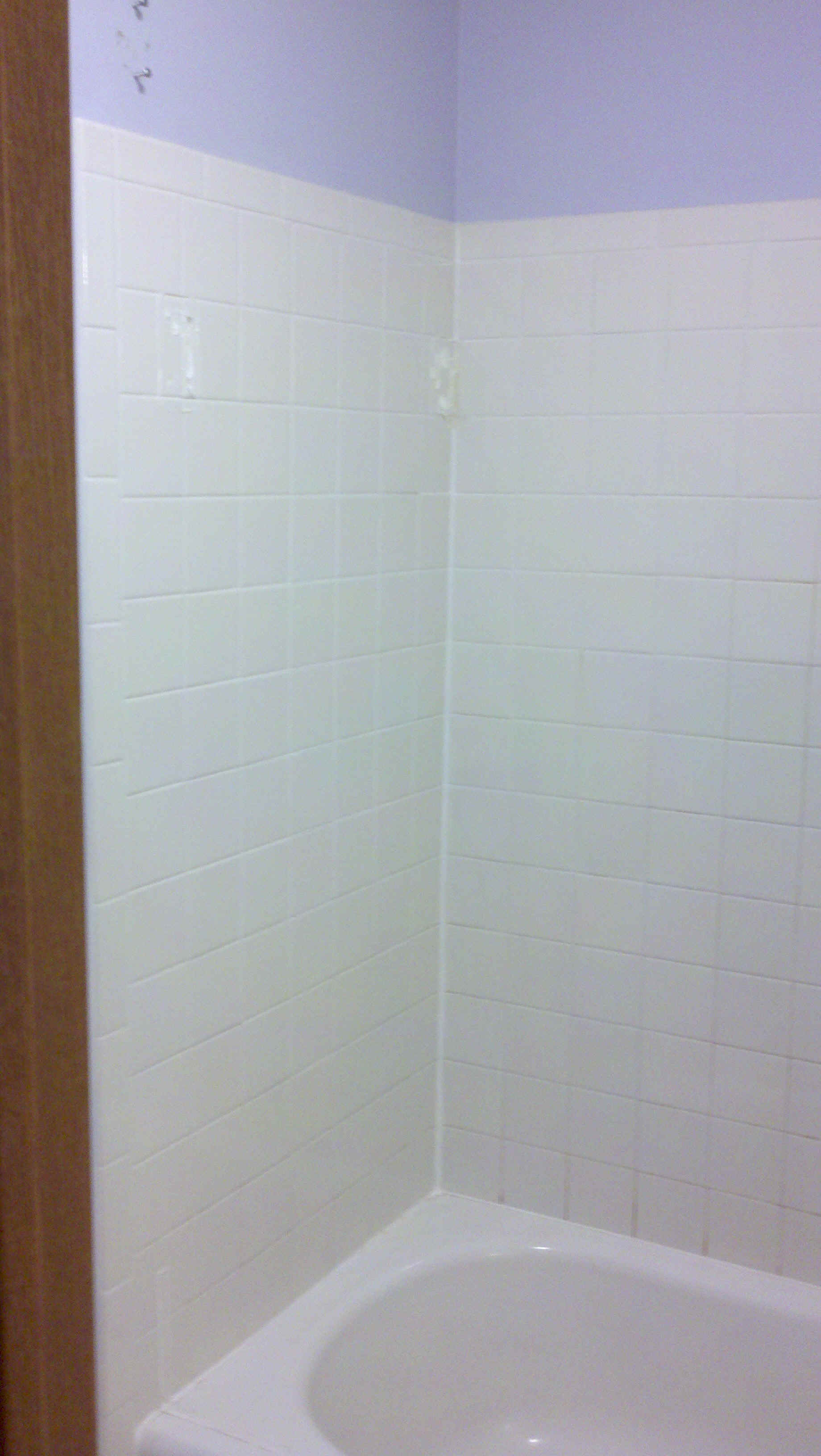

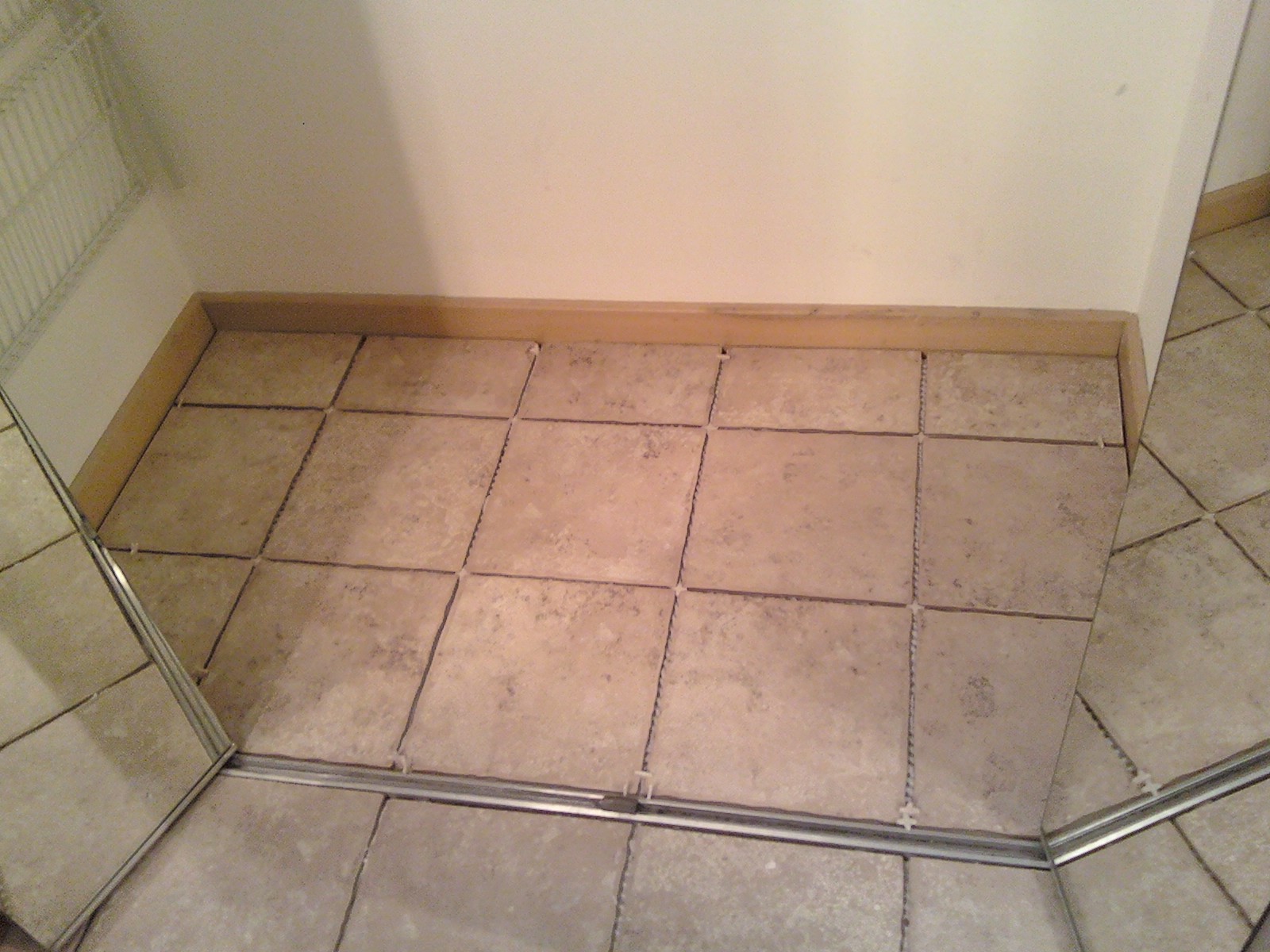

Installation of tile |
![]() |

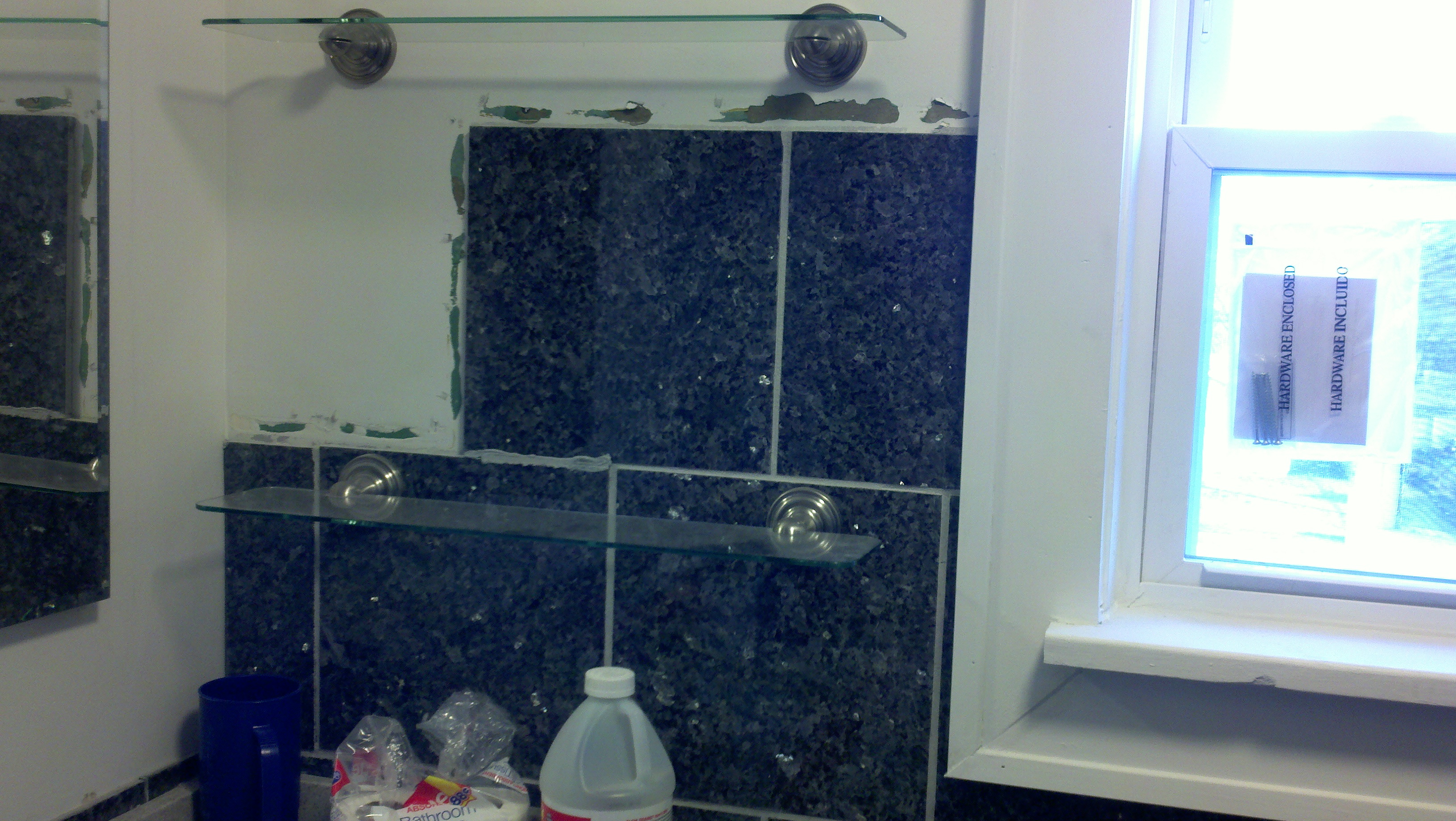

Business Half Bathroom, Dentist
Office
Installation of tile |
![]() |
Habitat Rental Full Bathroom,
Dentist Office
Installation of Tile |
![]() |
Bathroom, Dentist Office
Installation of wall and floor tile |
|

Bathroom Repair

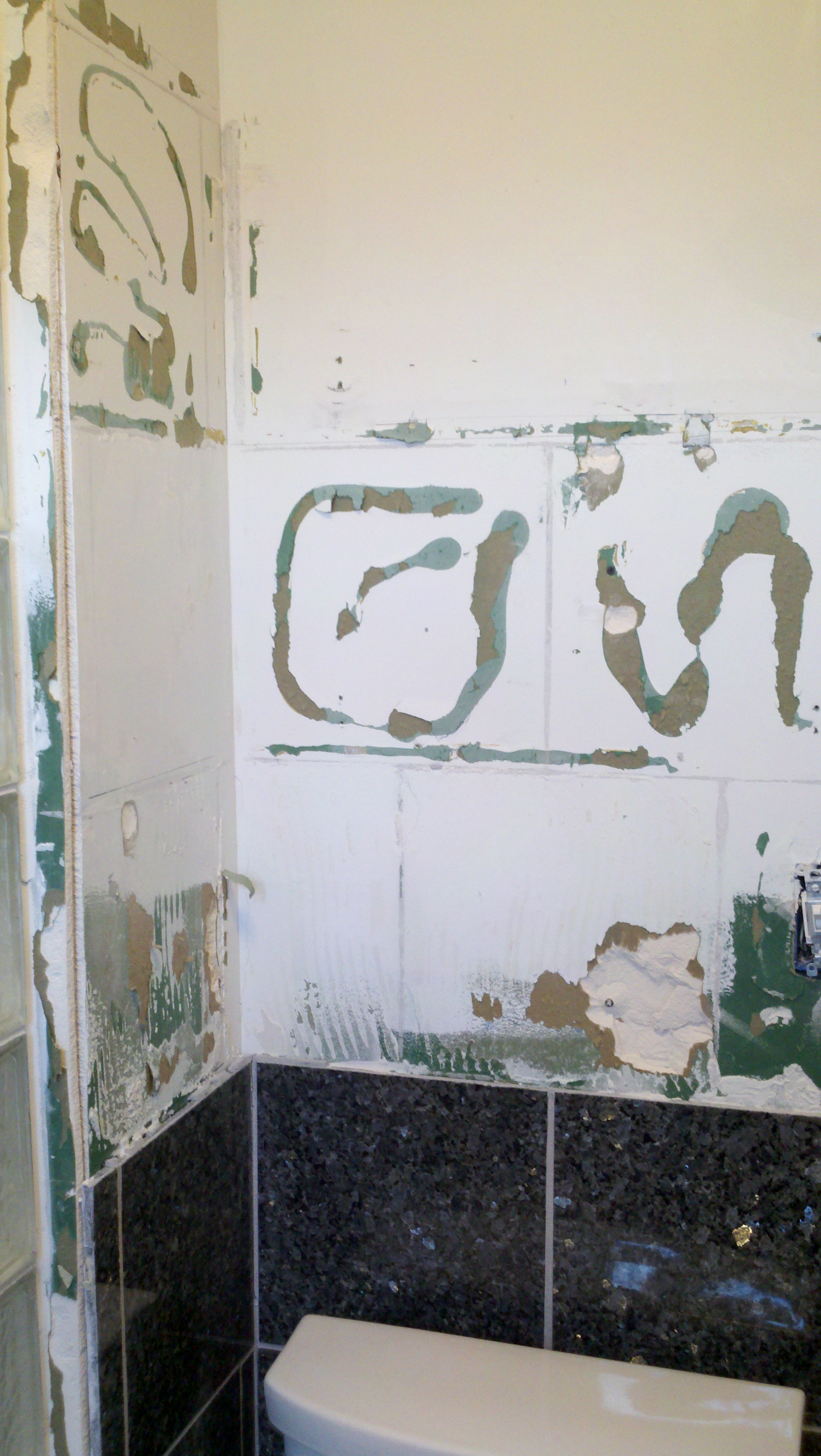

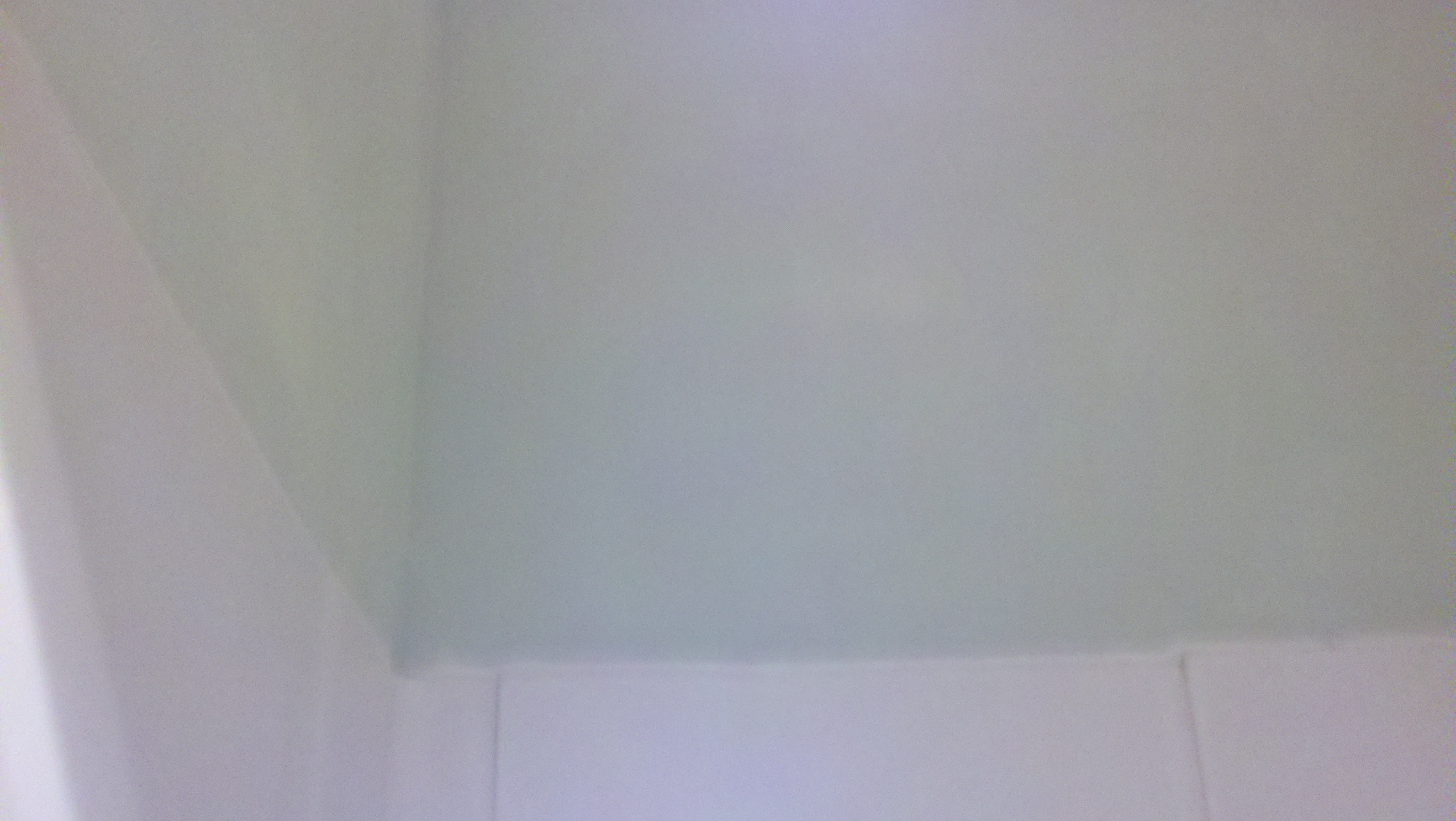

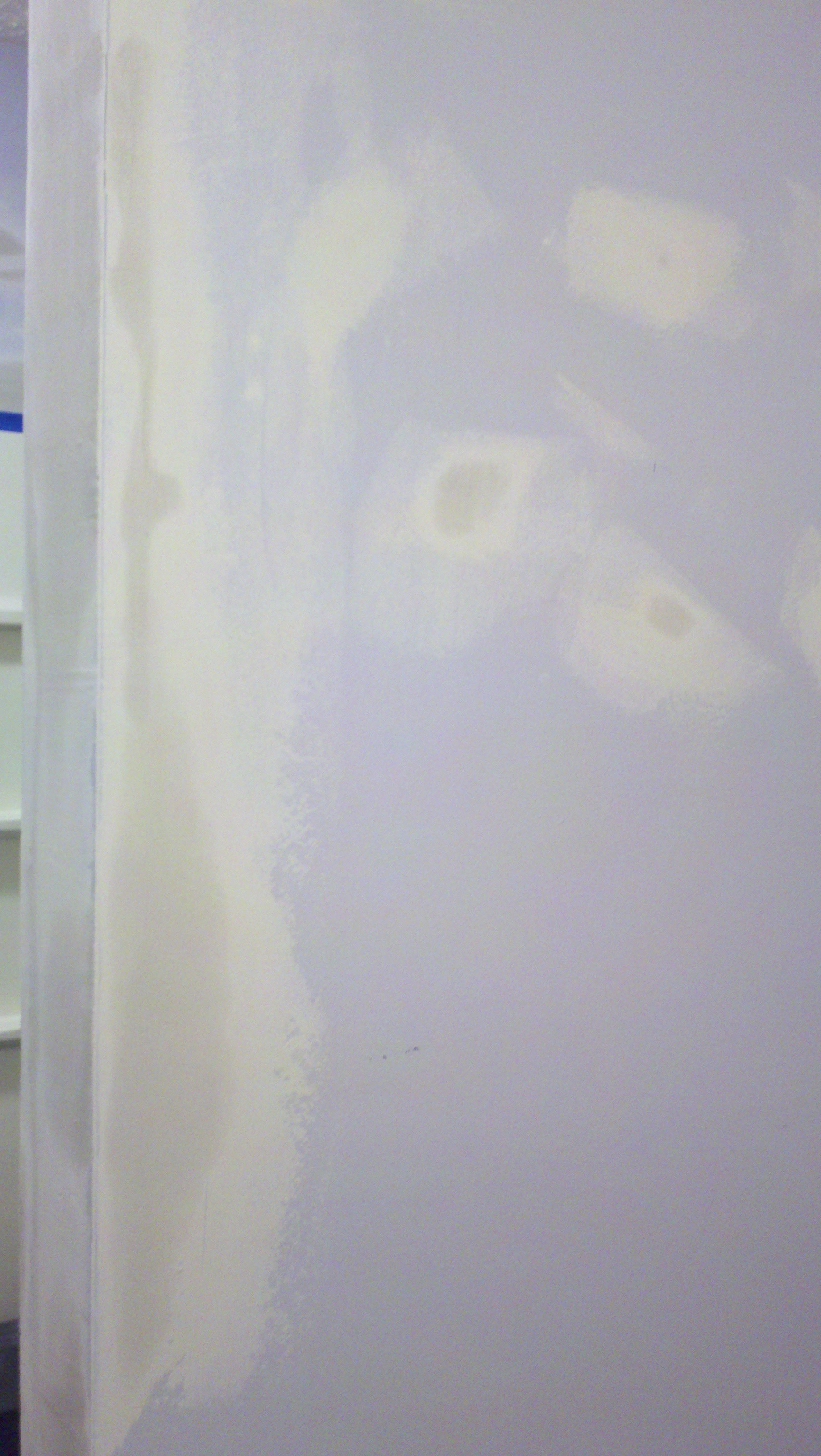

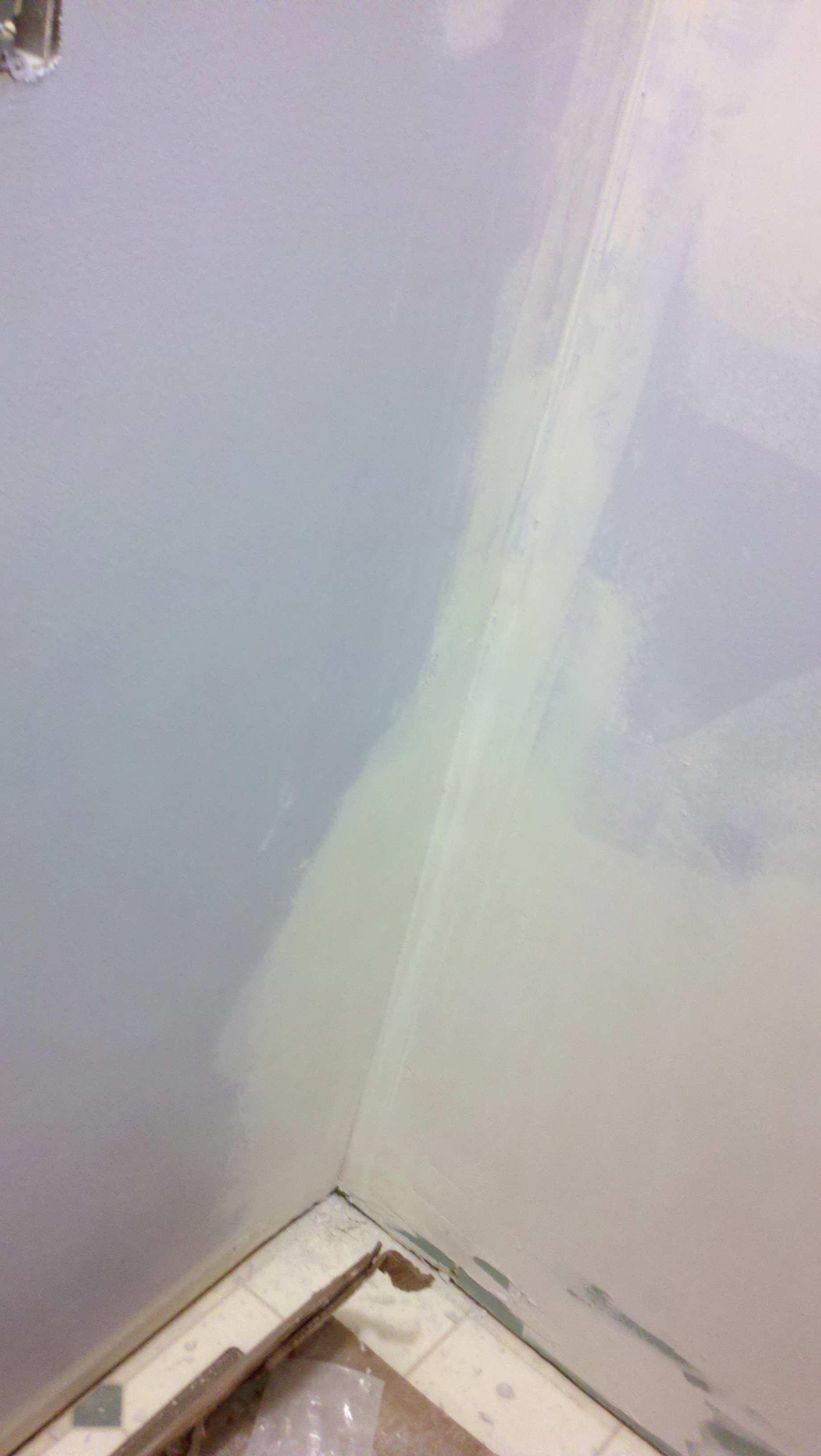

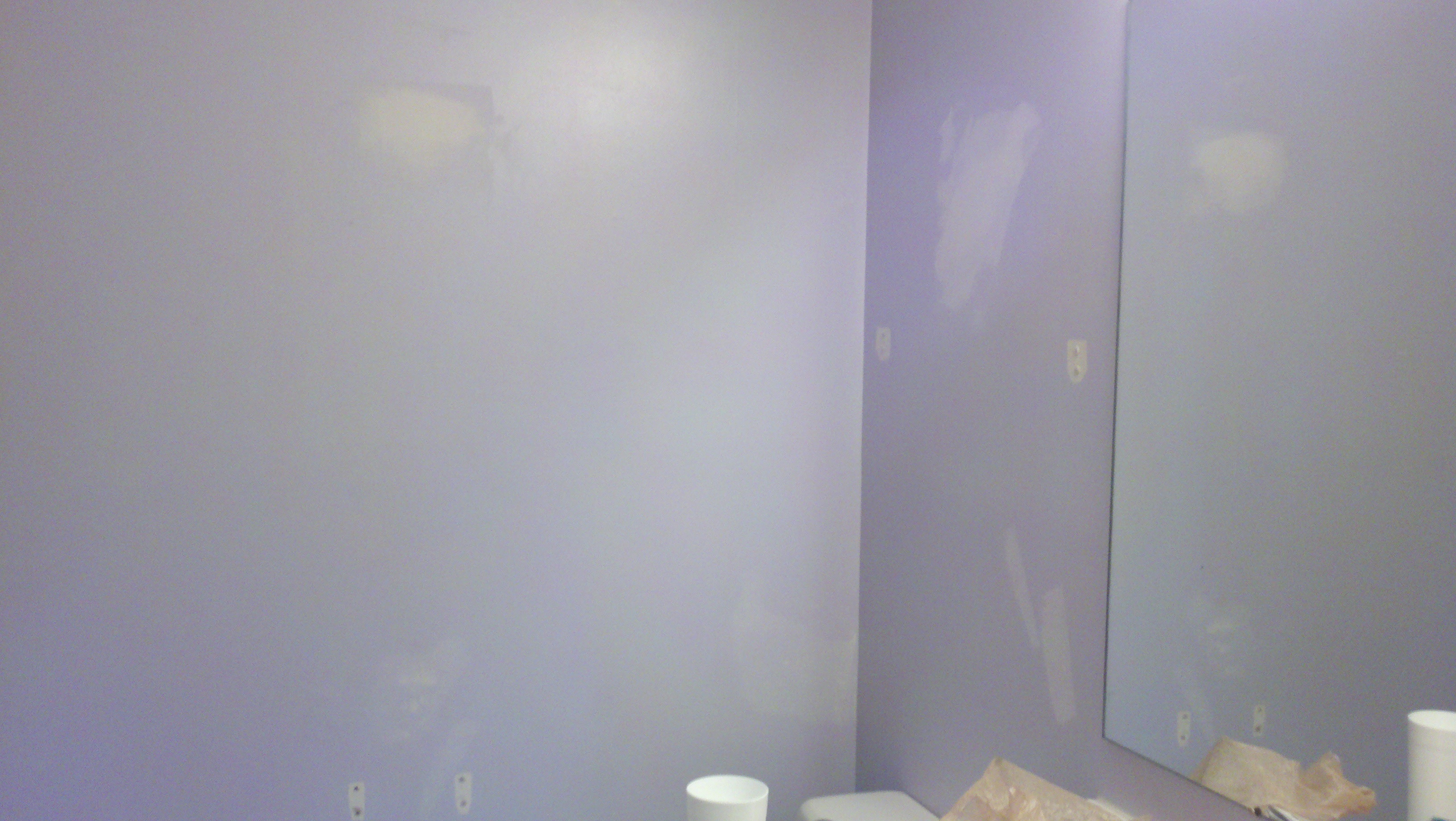

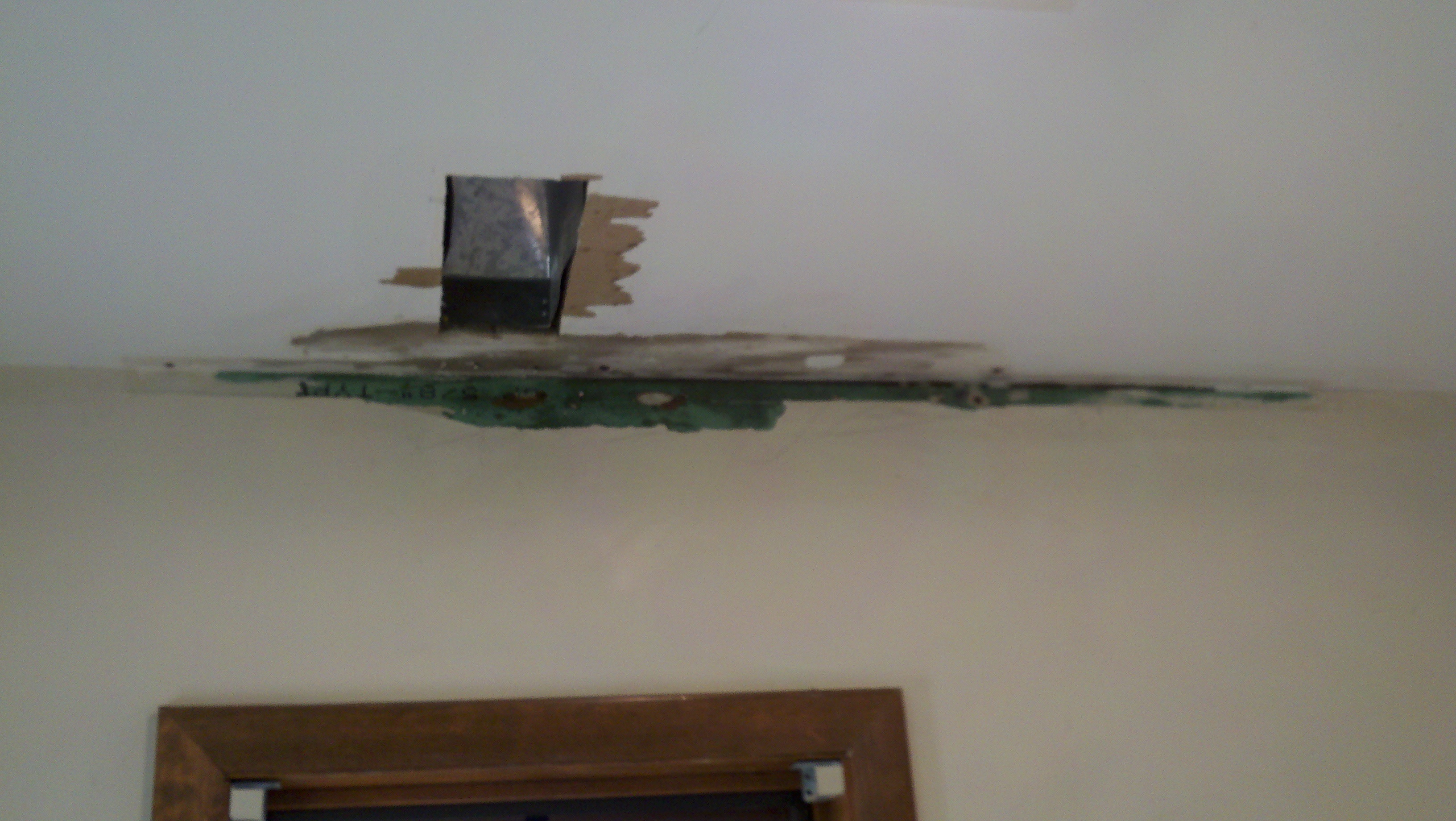

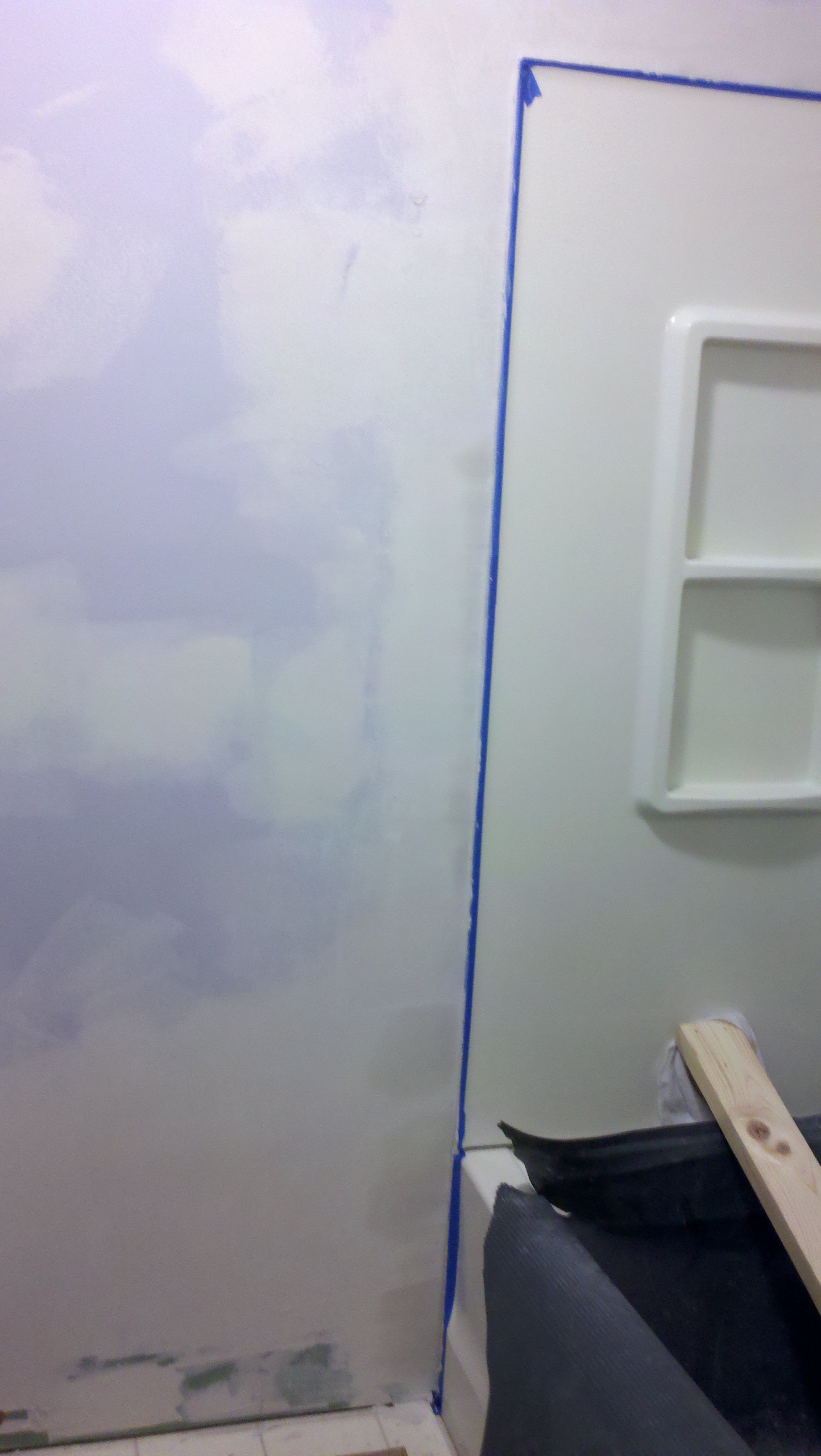

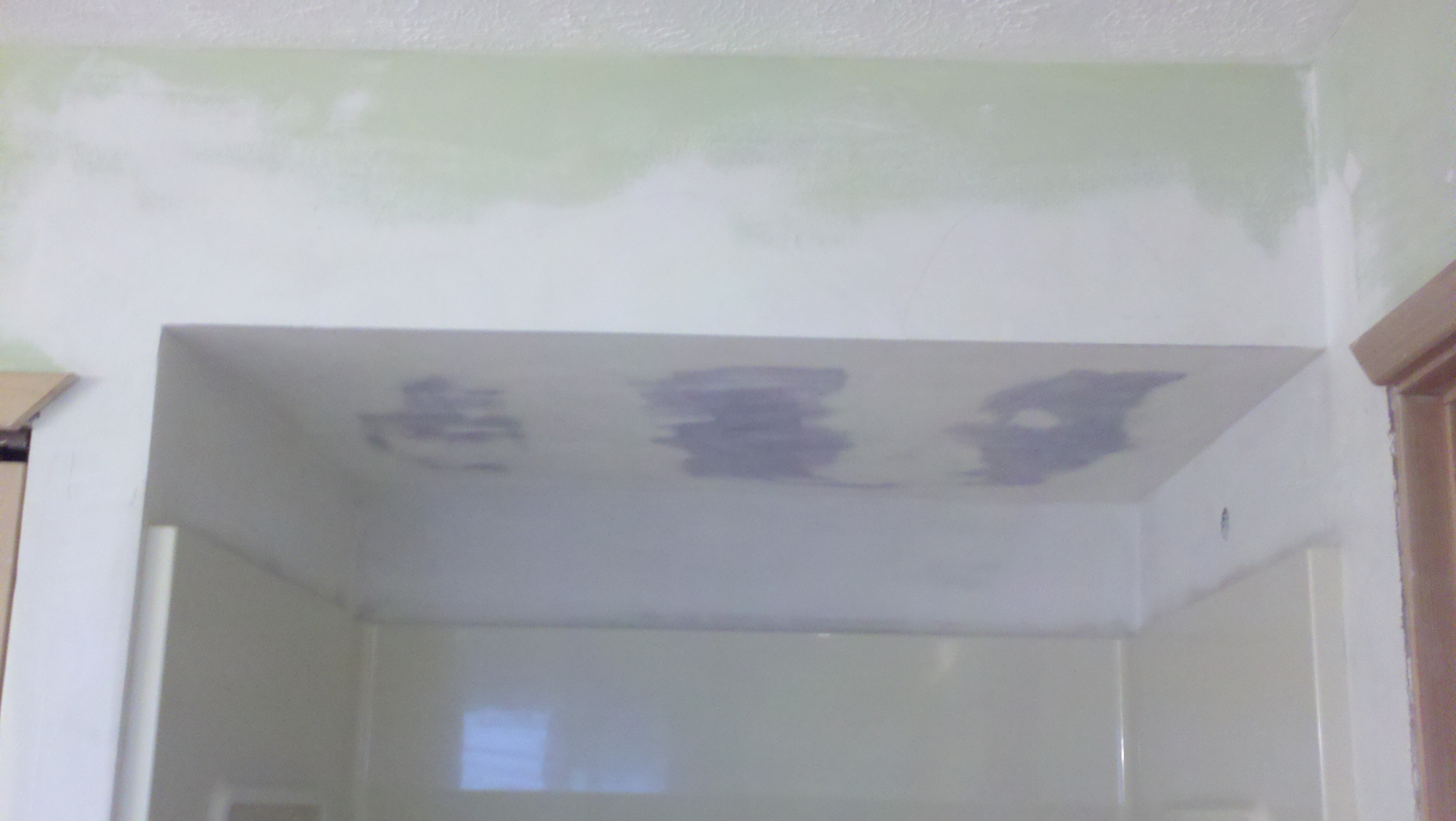

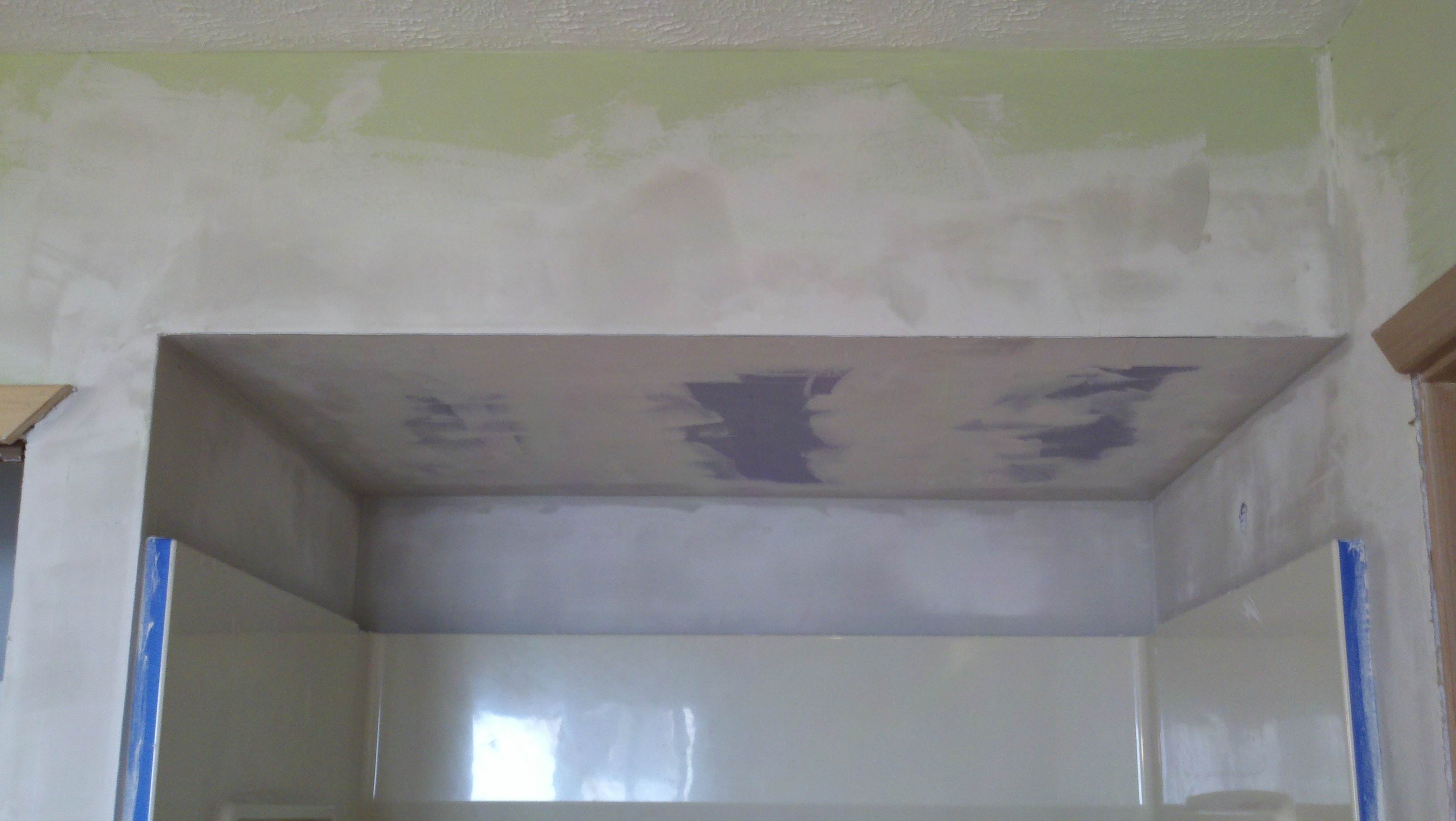

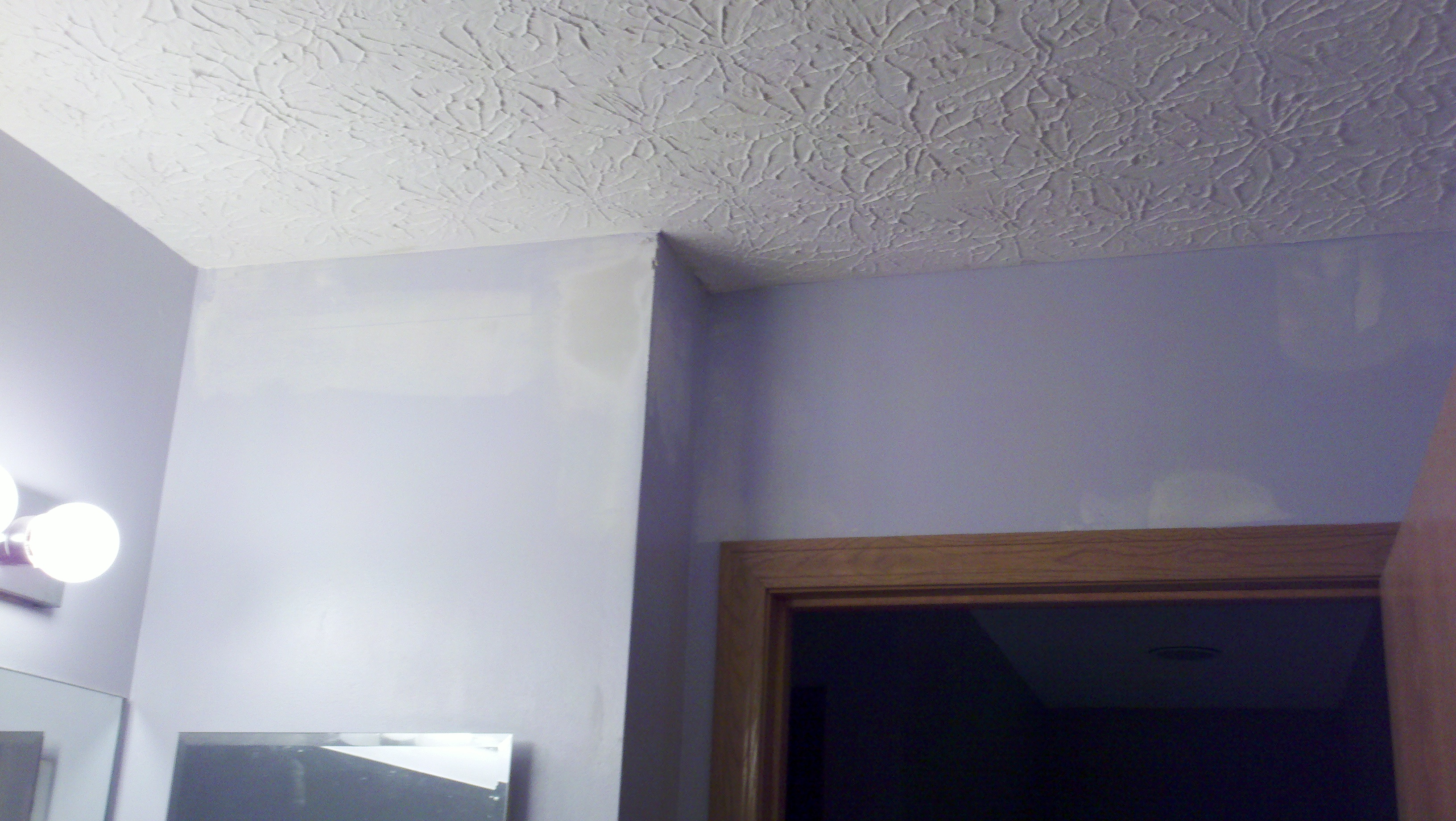

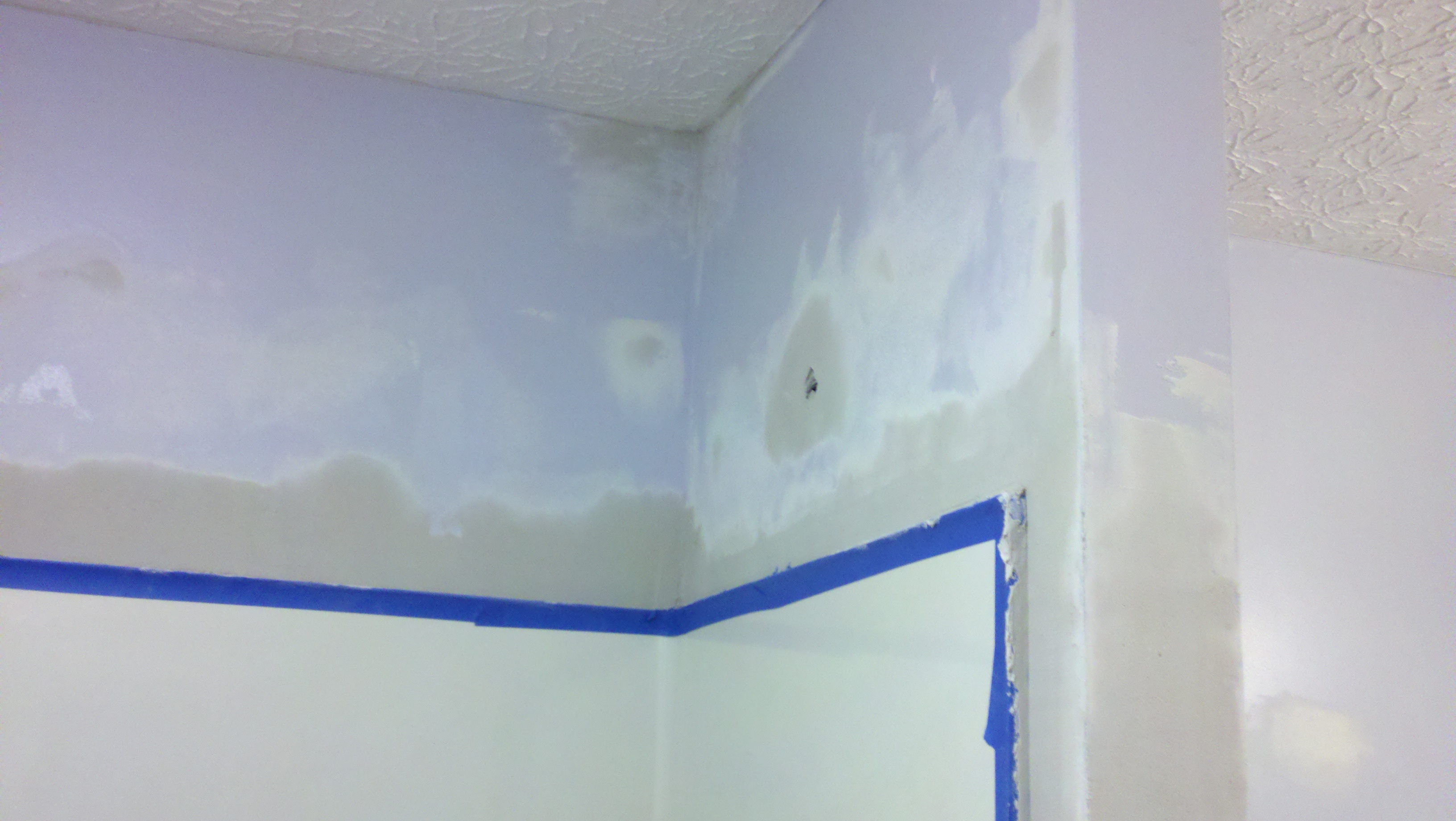

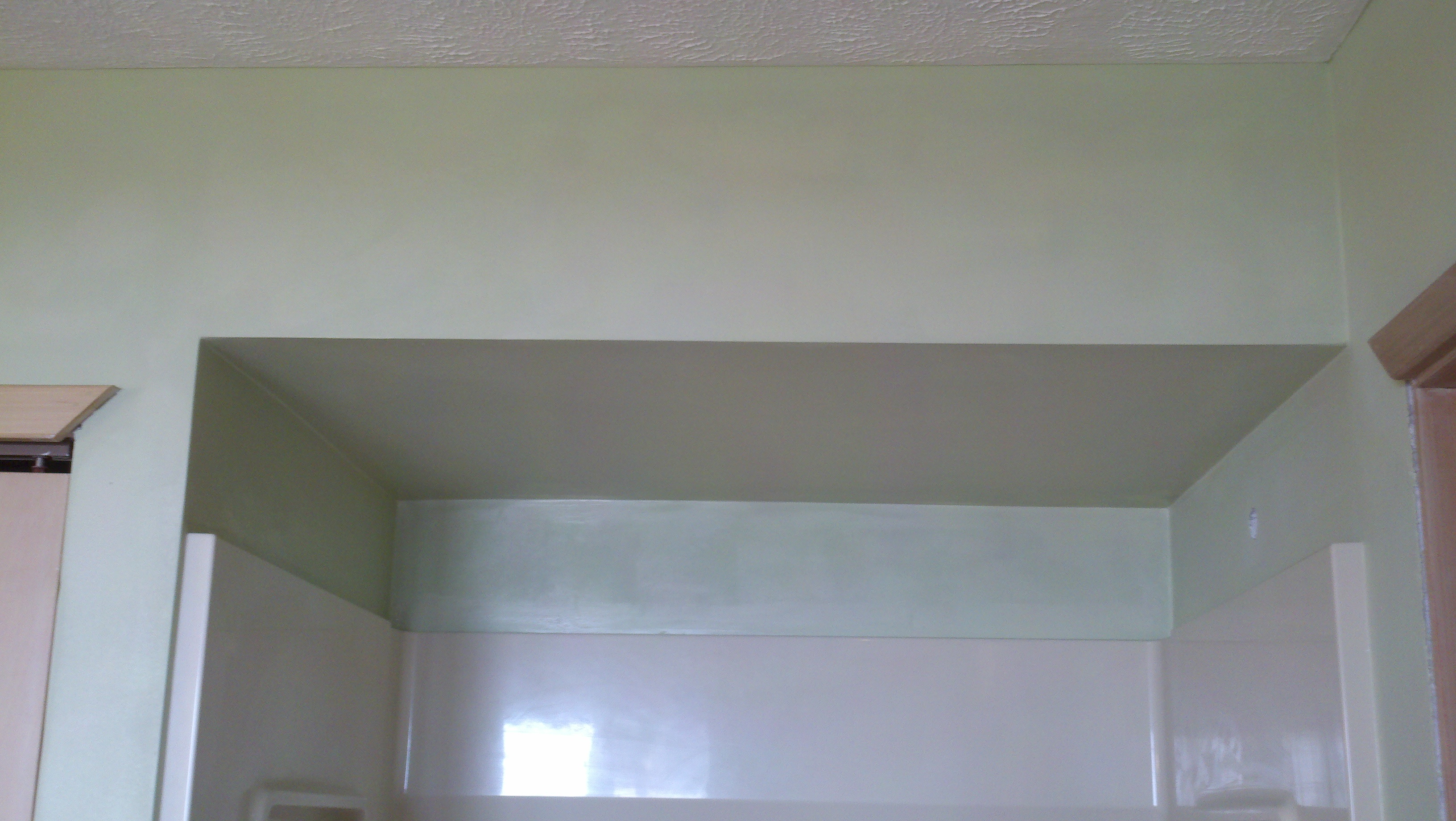

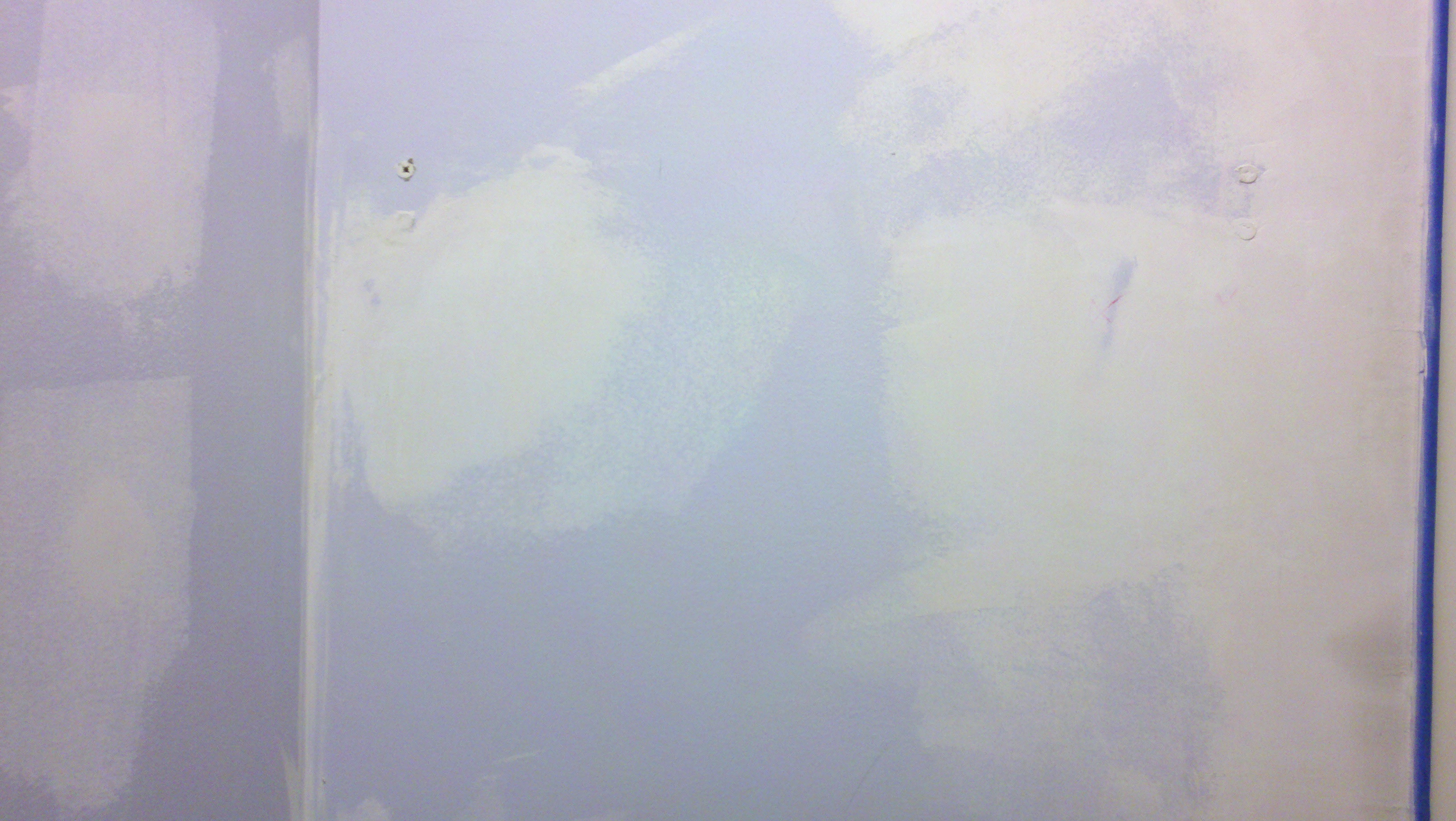

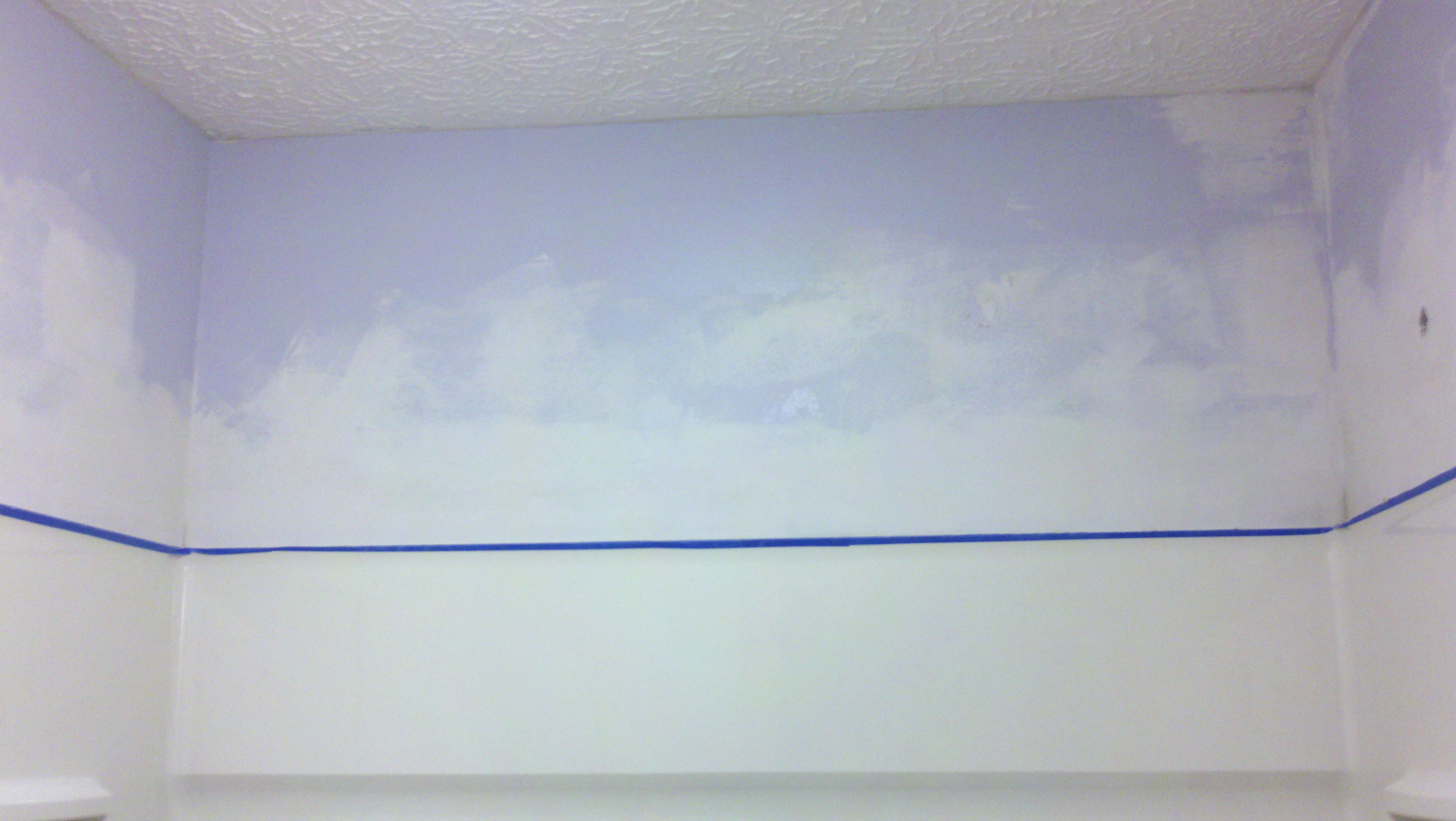

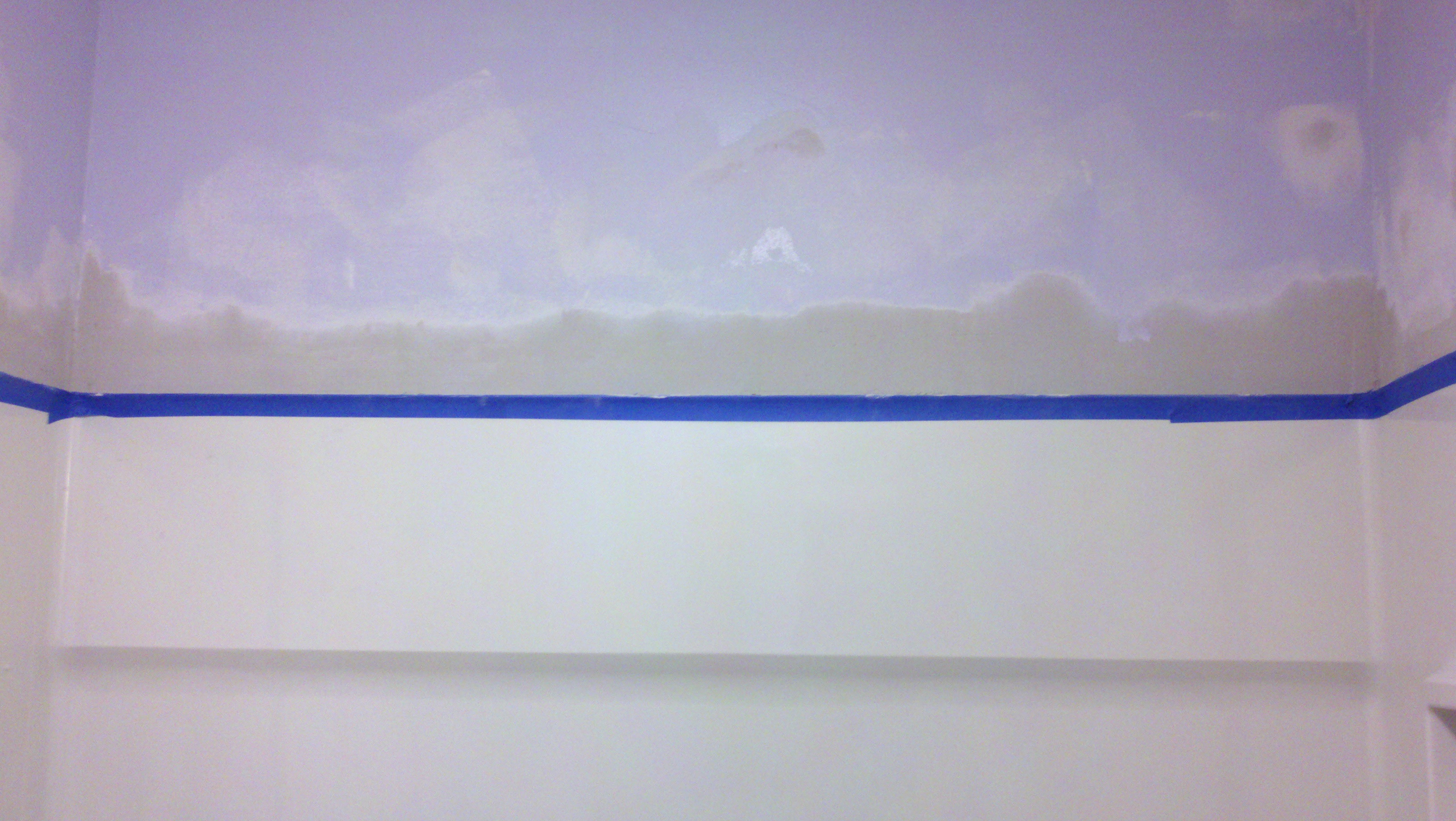

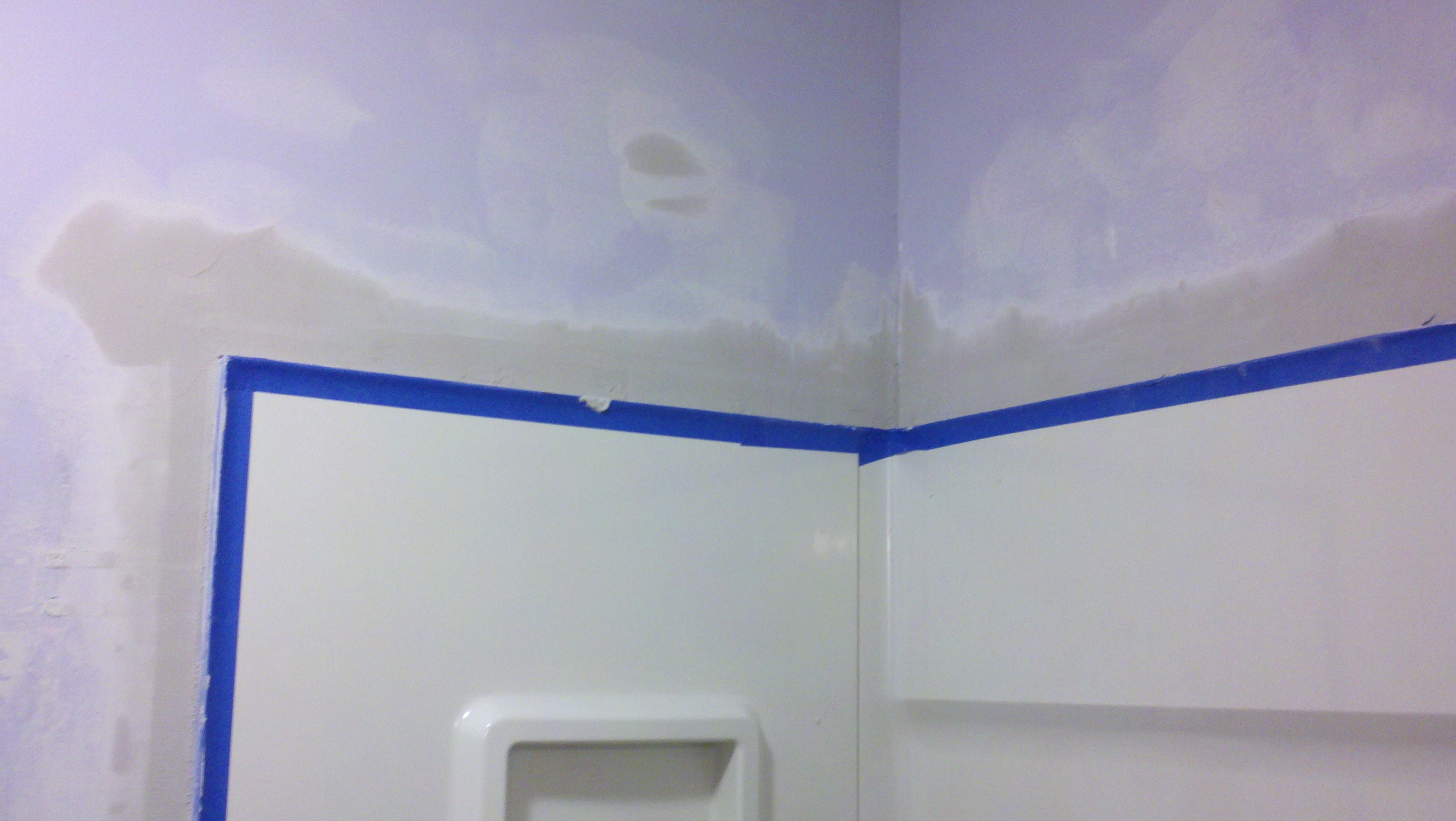

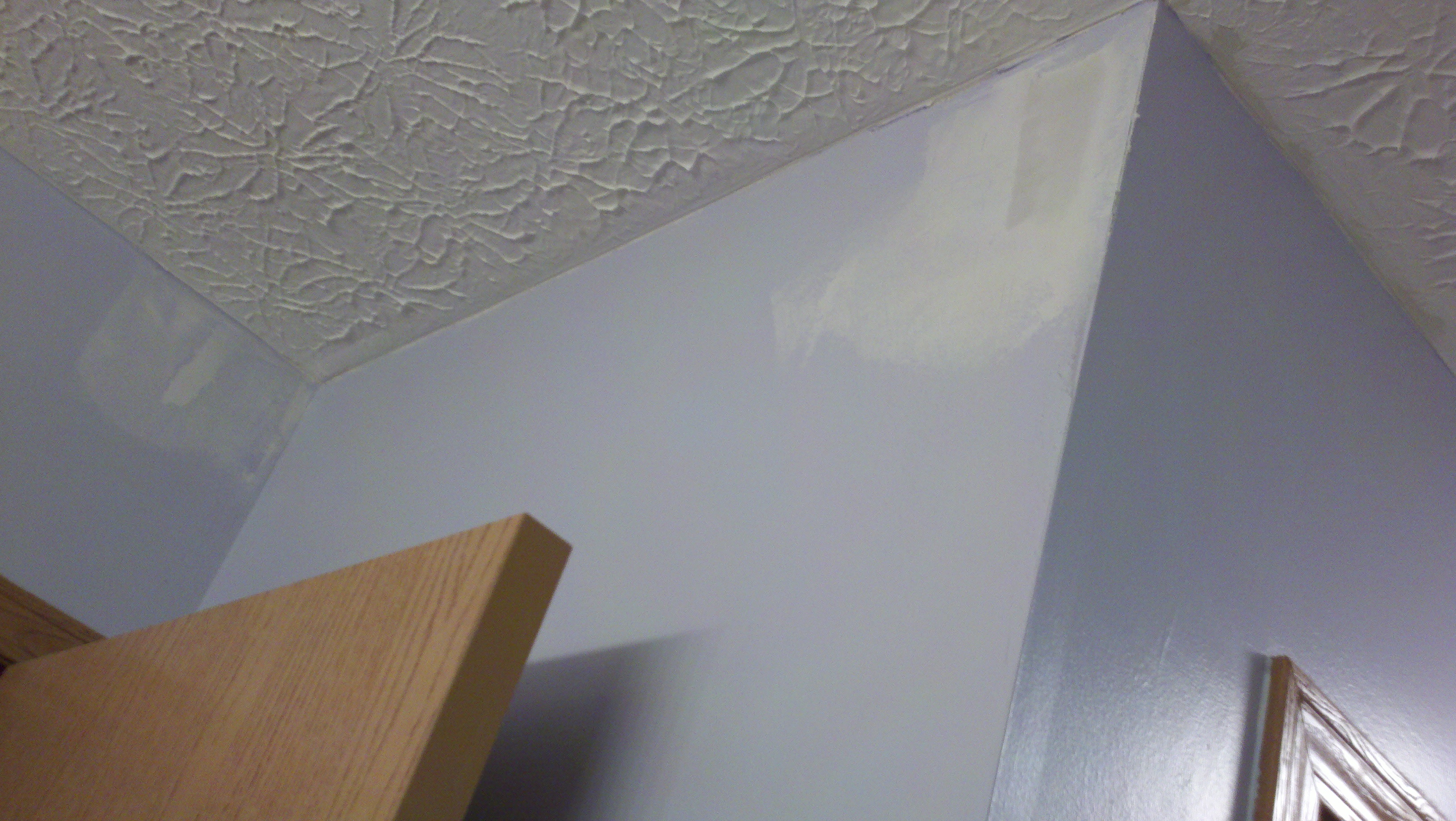

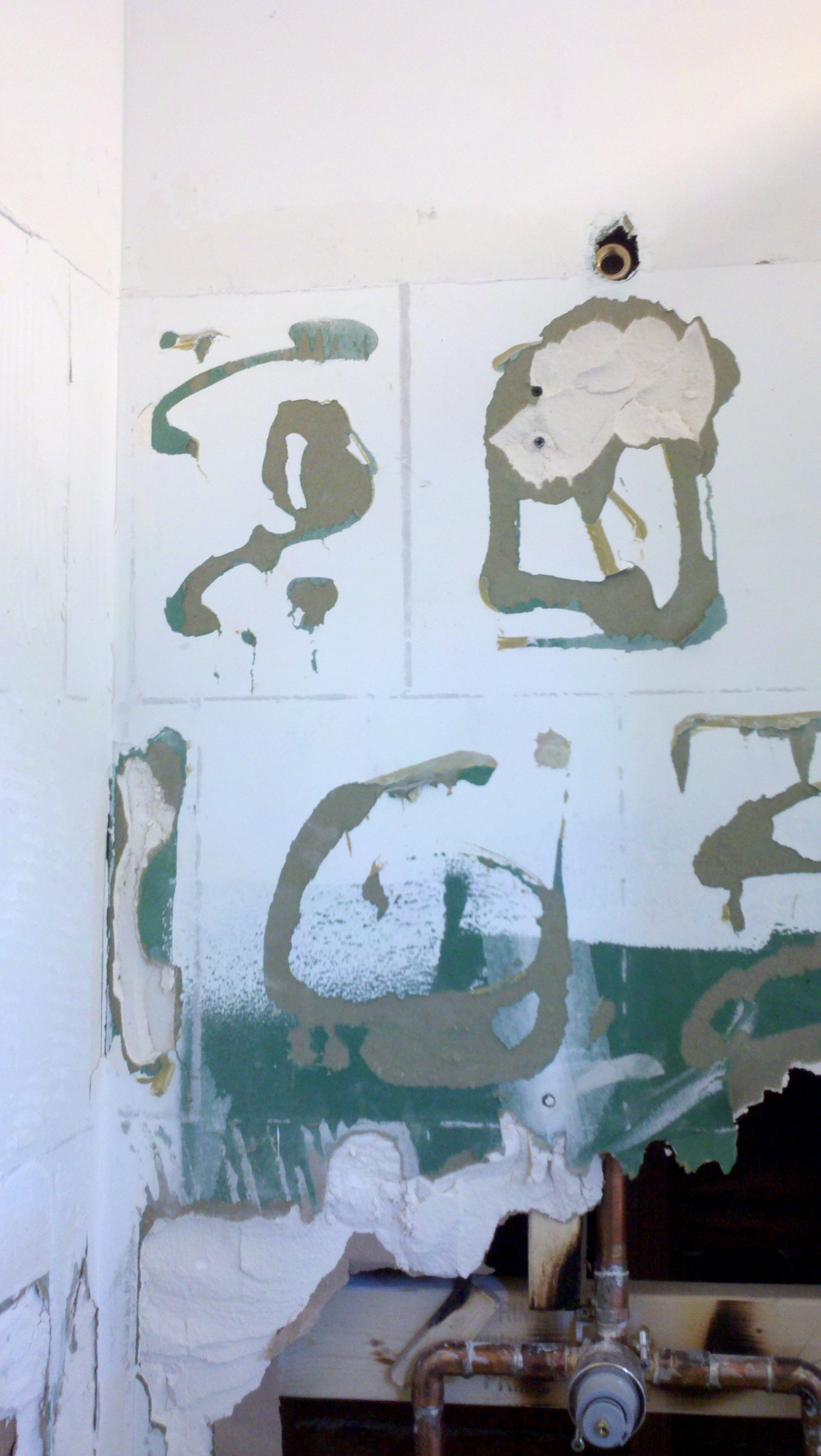

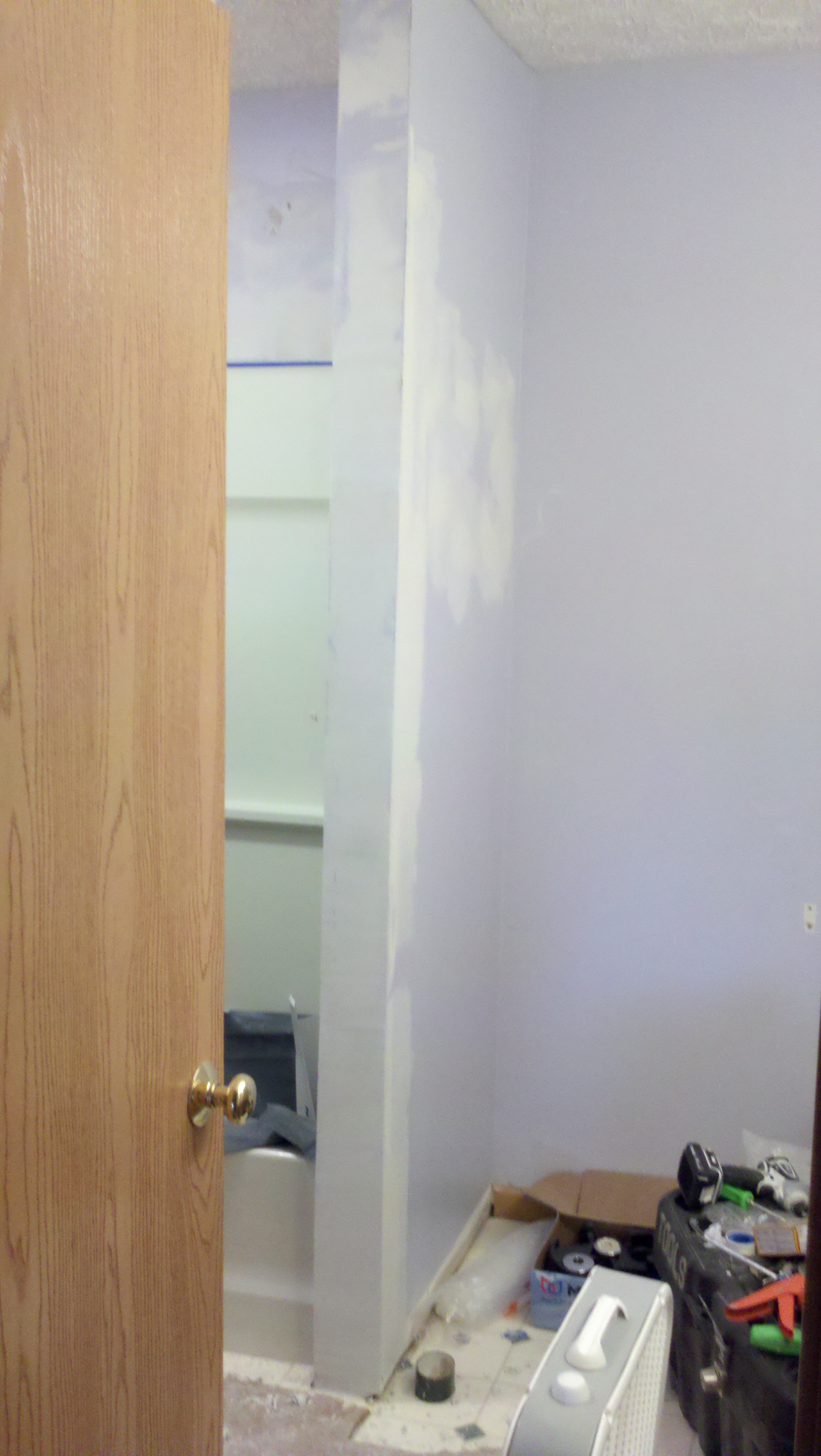

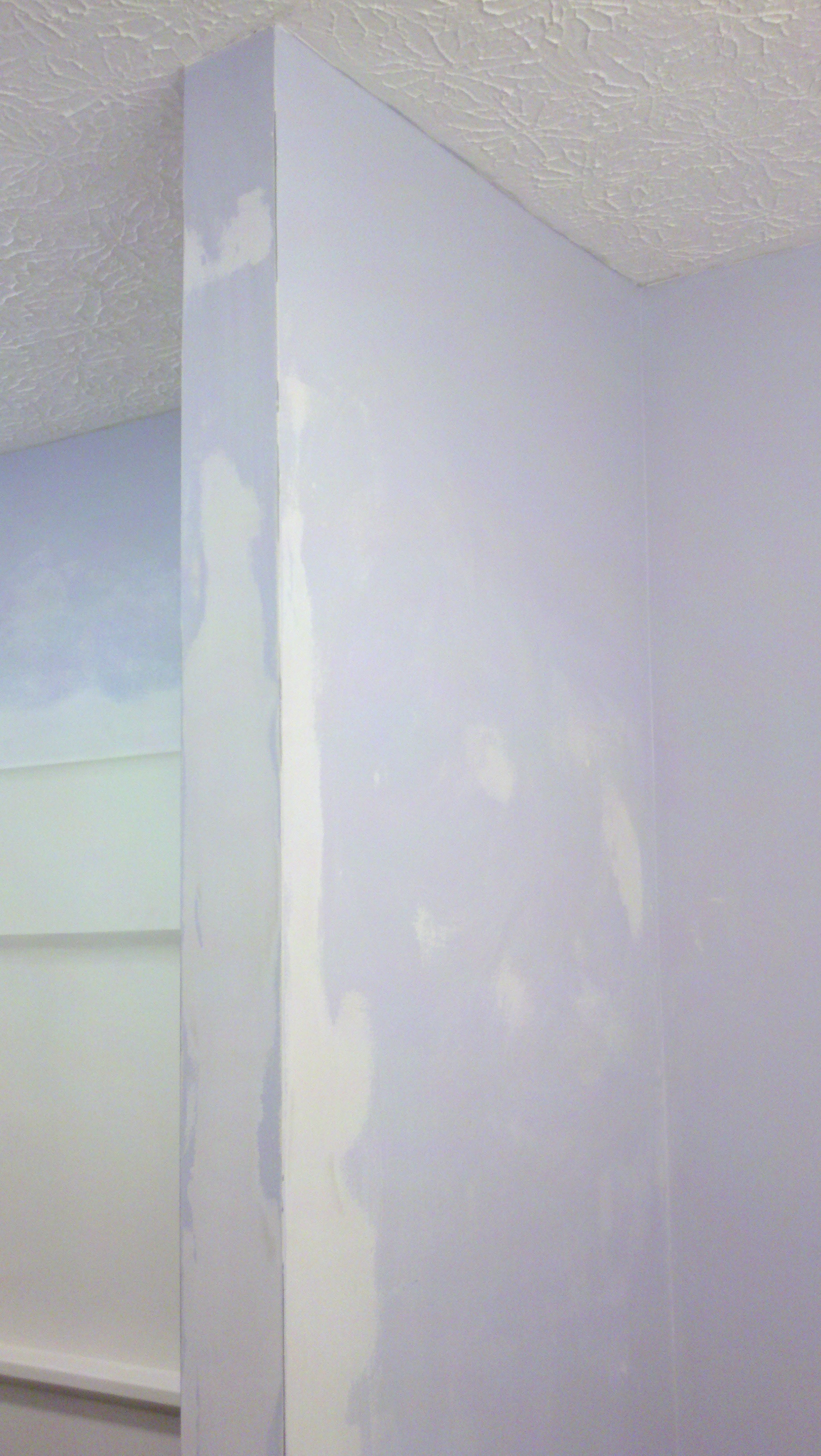

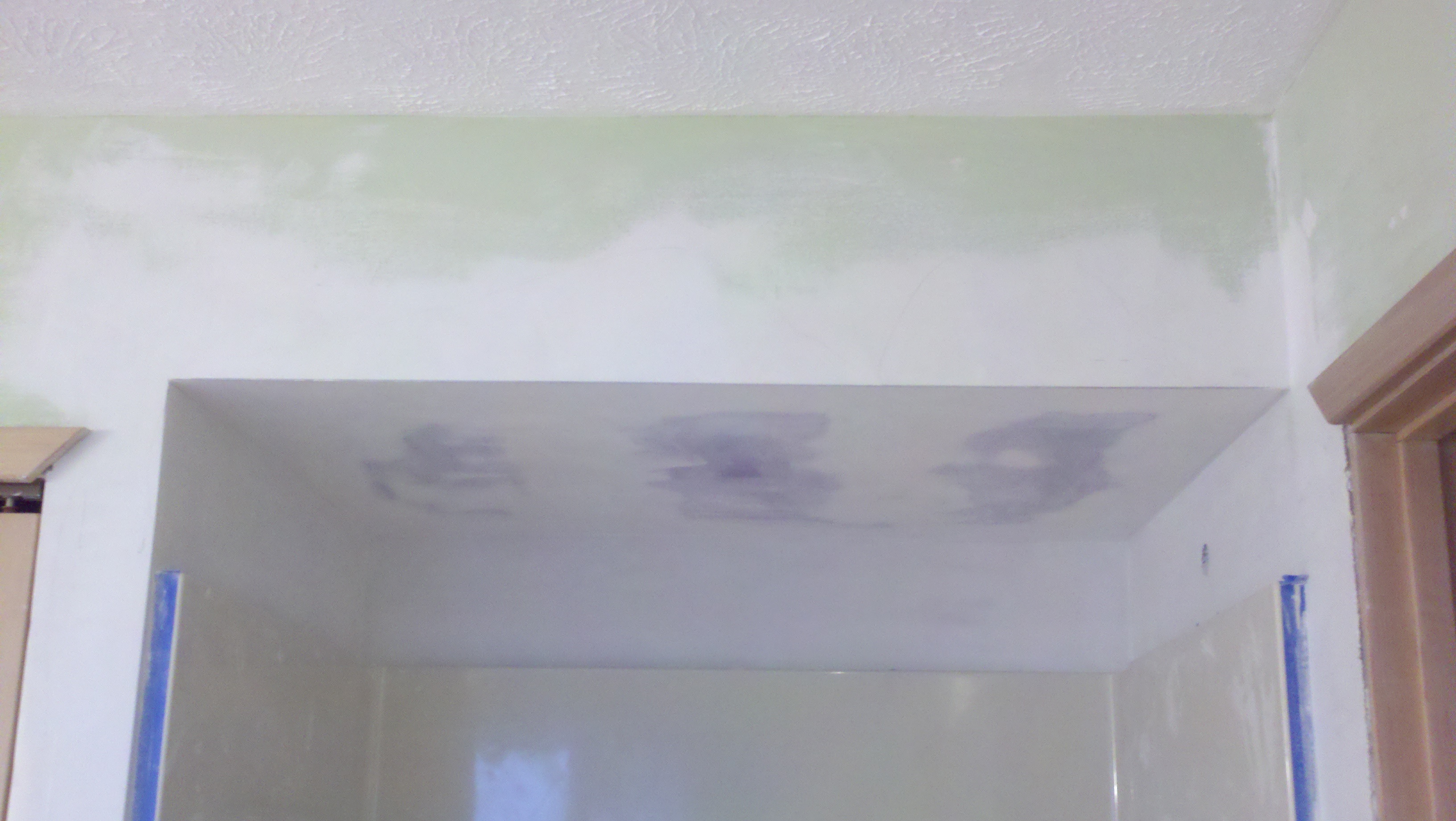

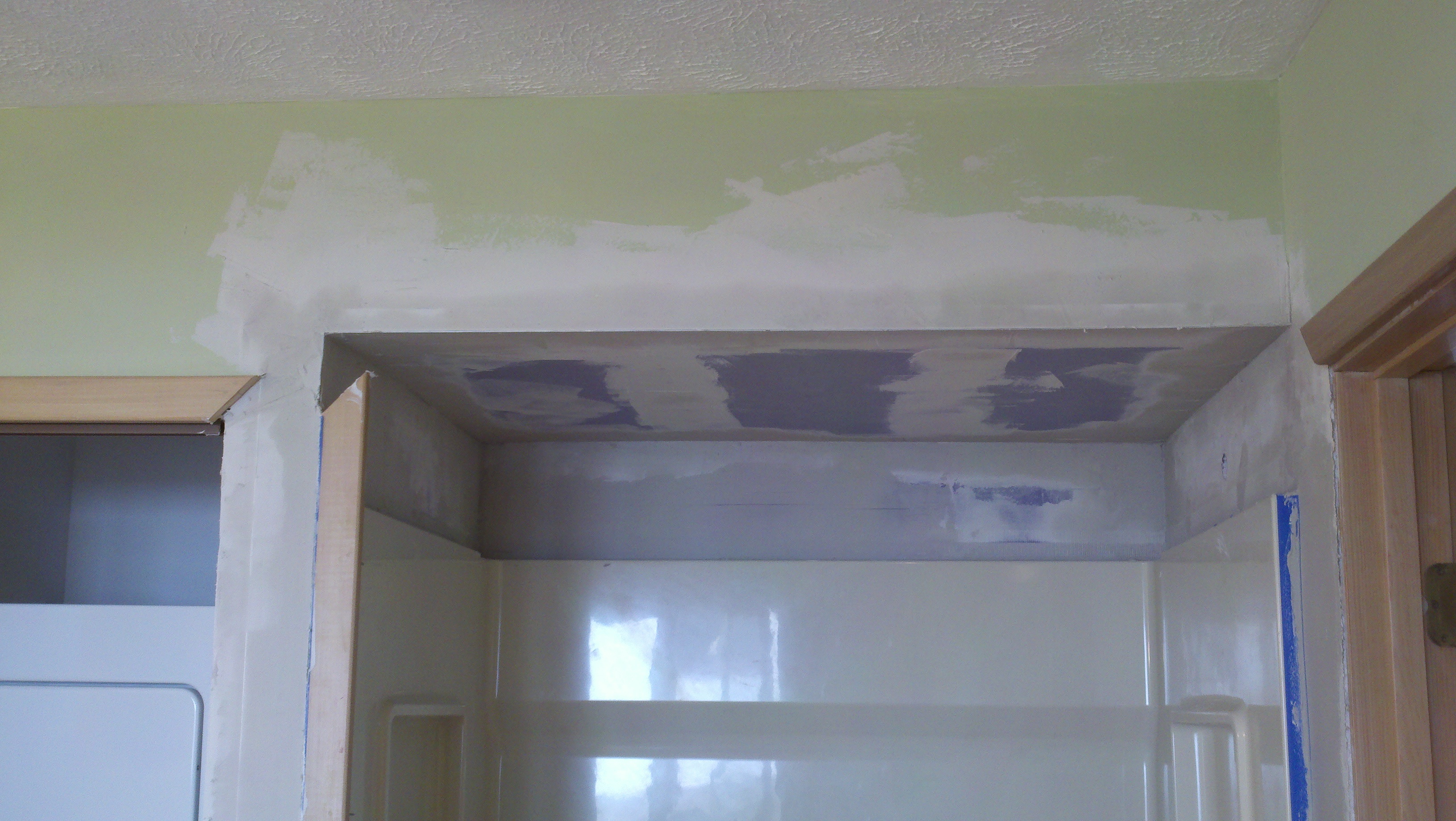

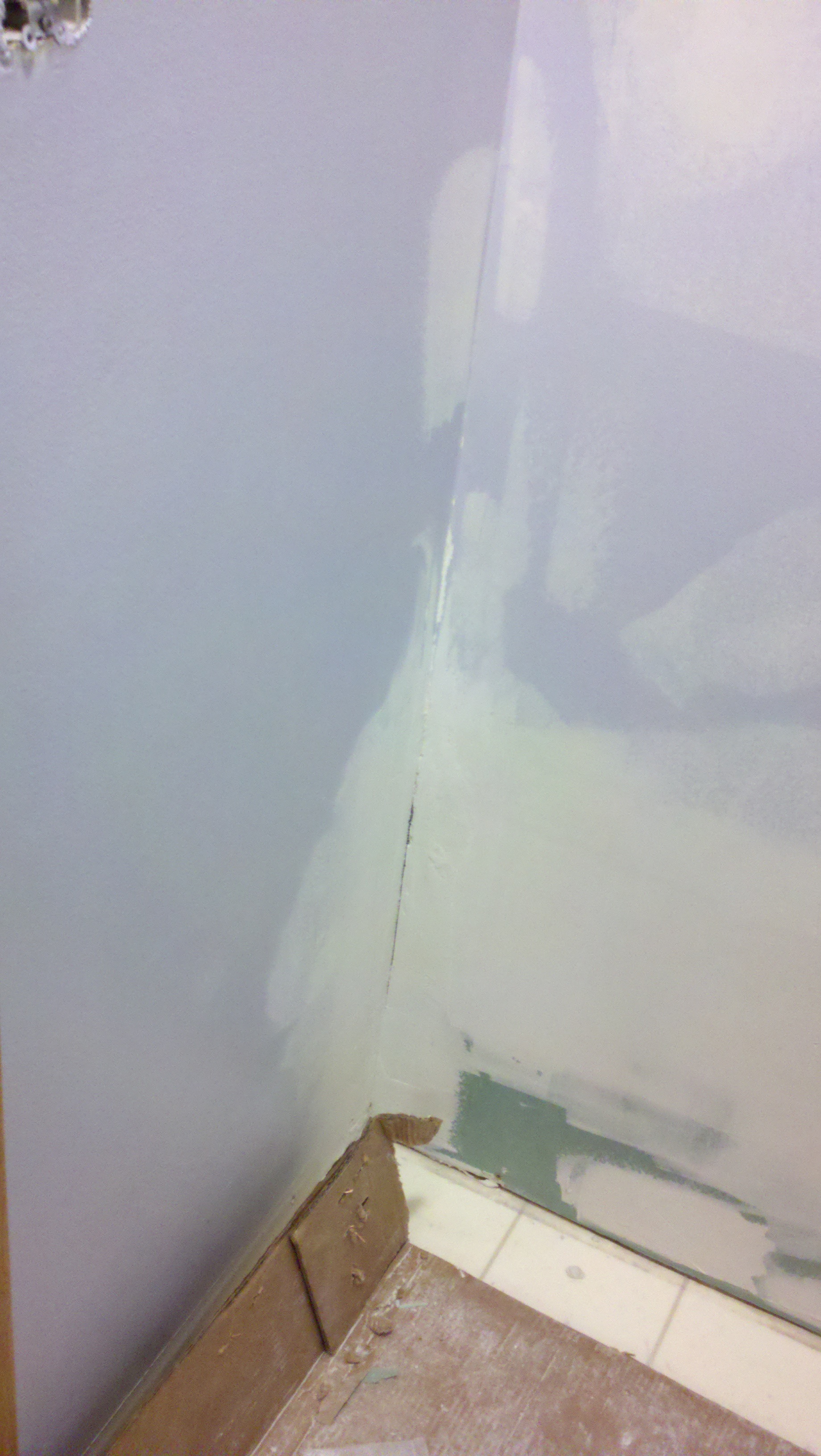

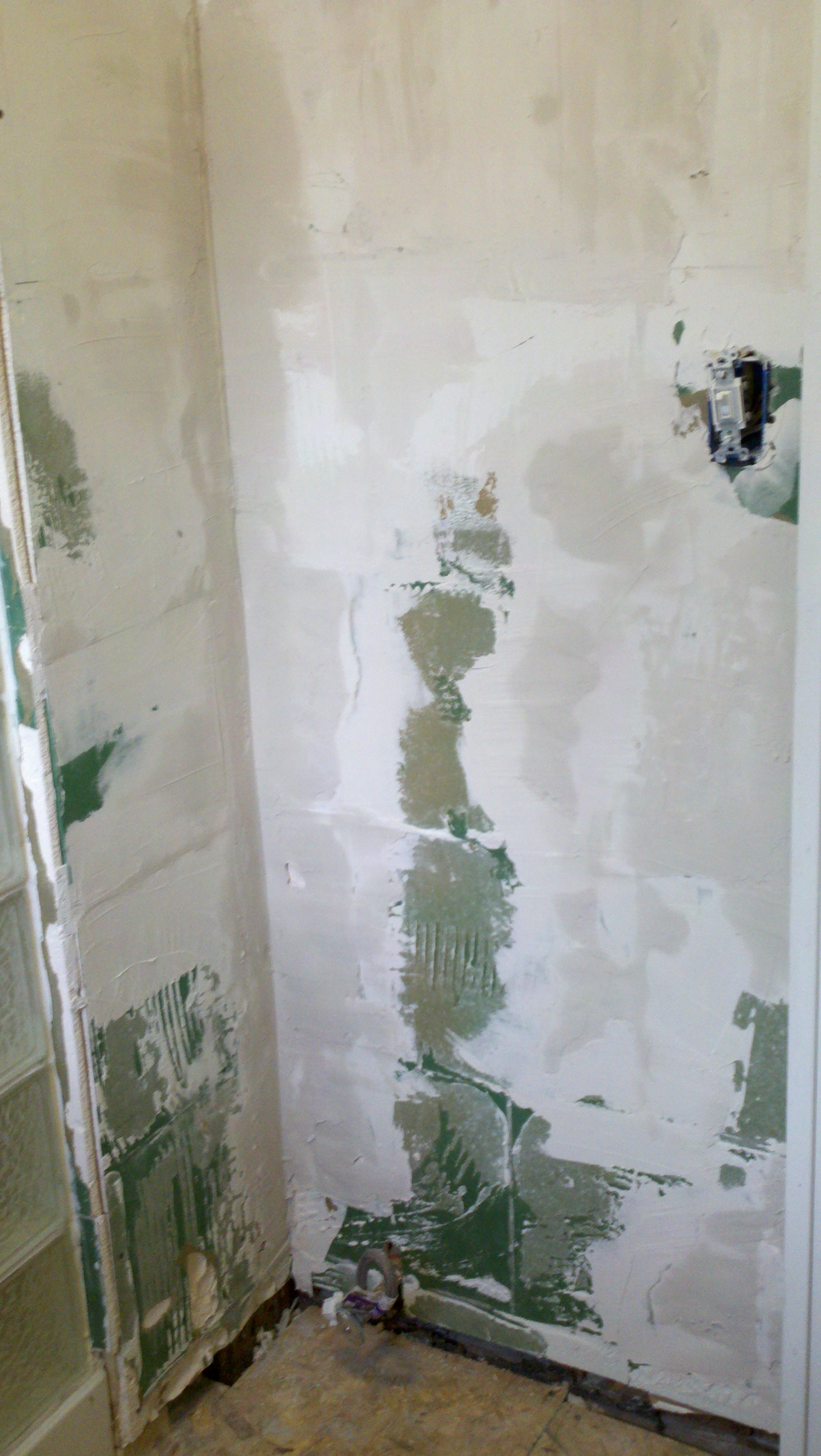

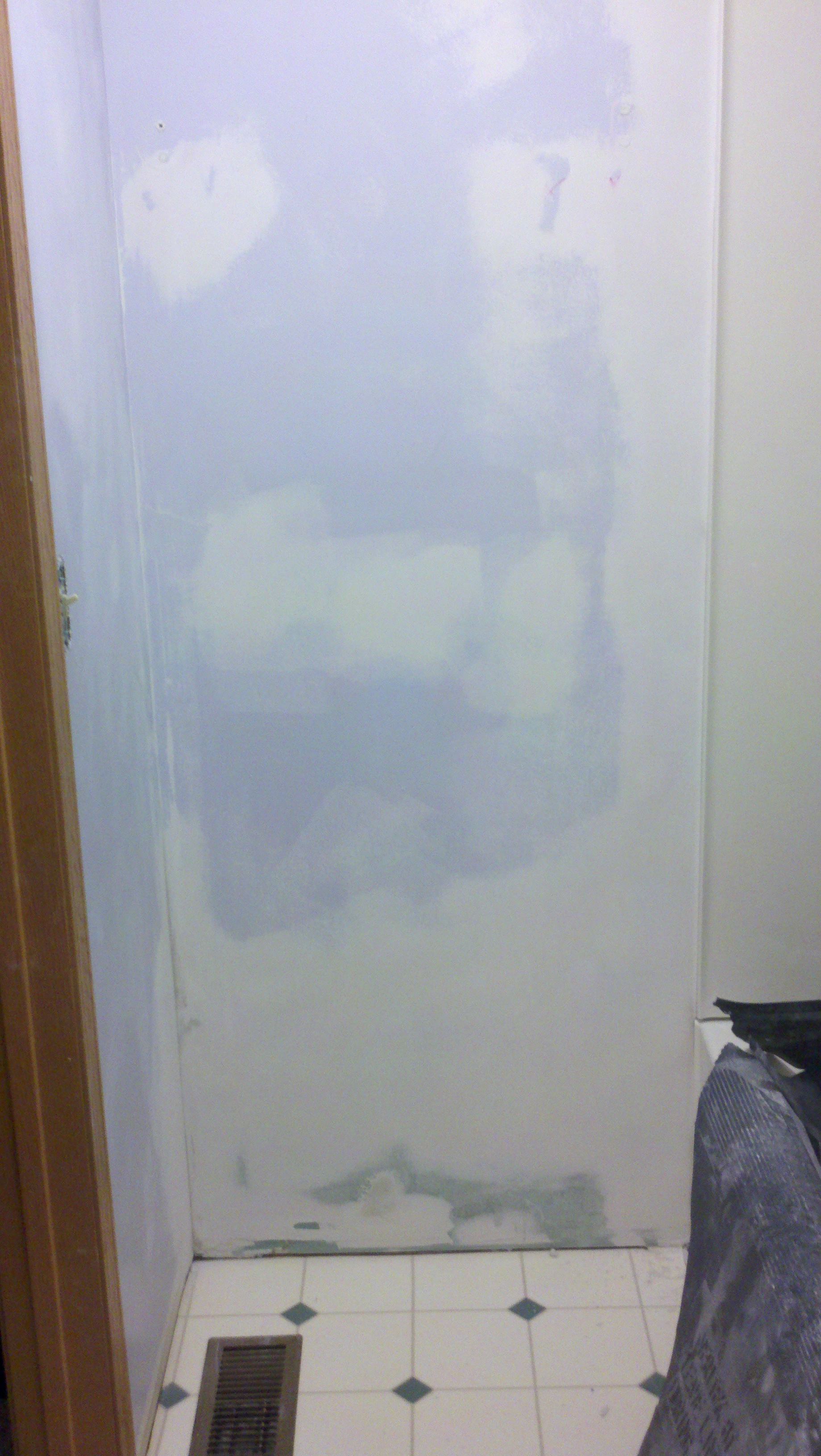

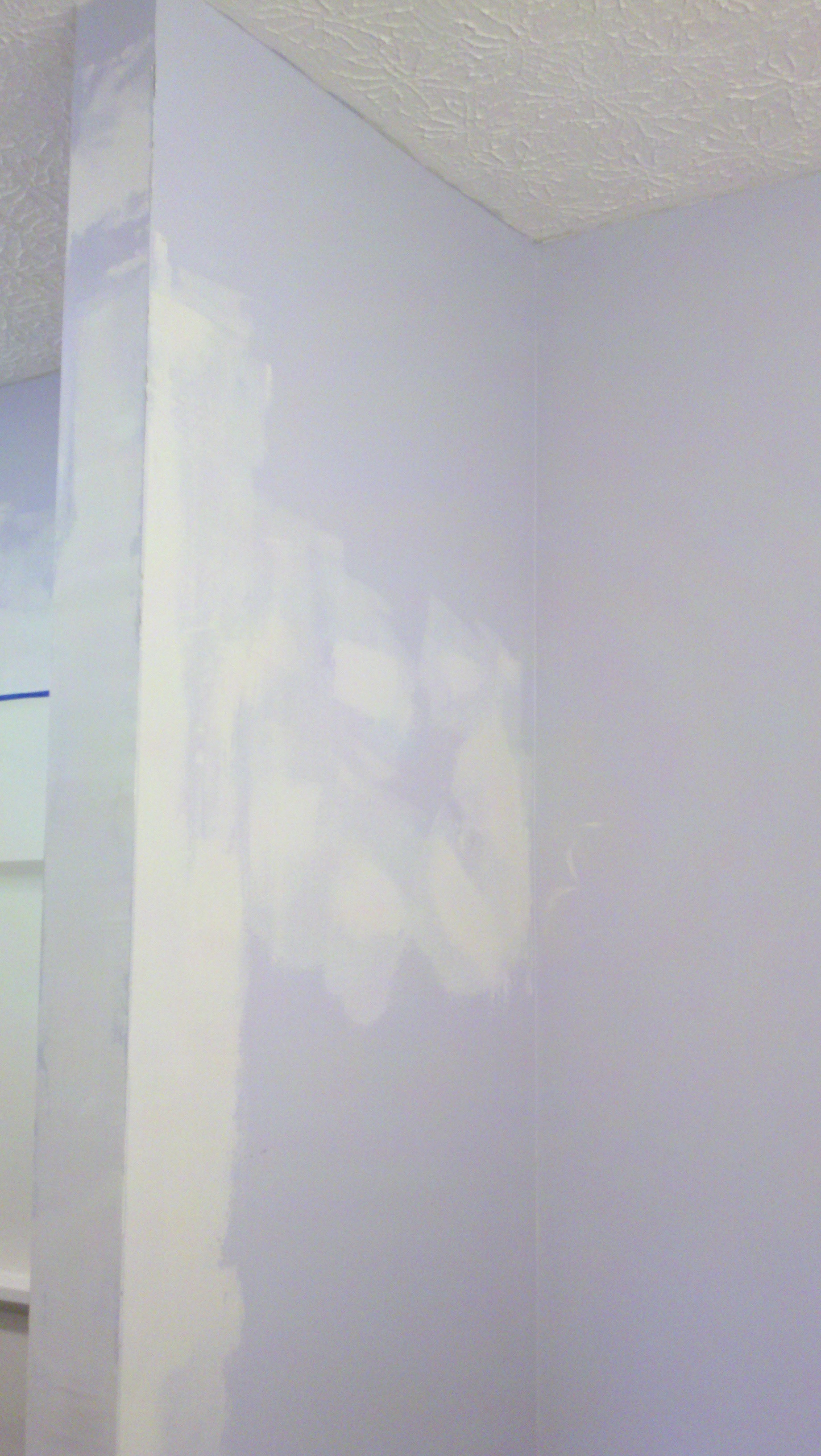

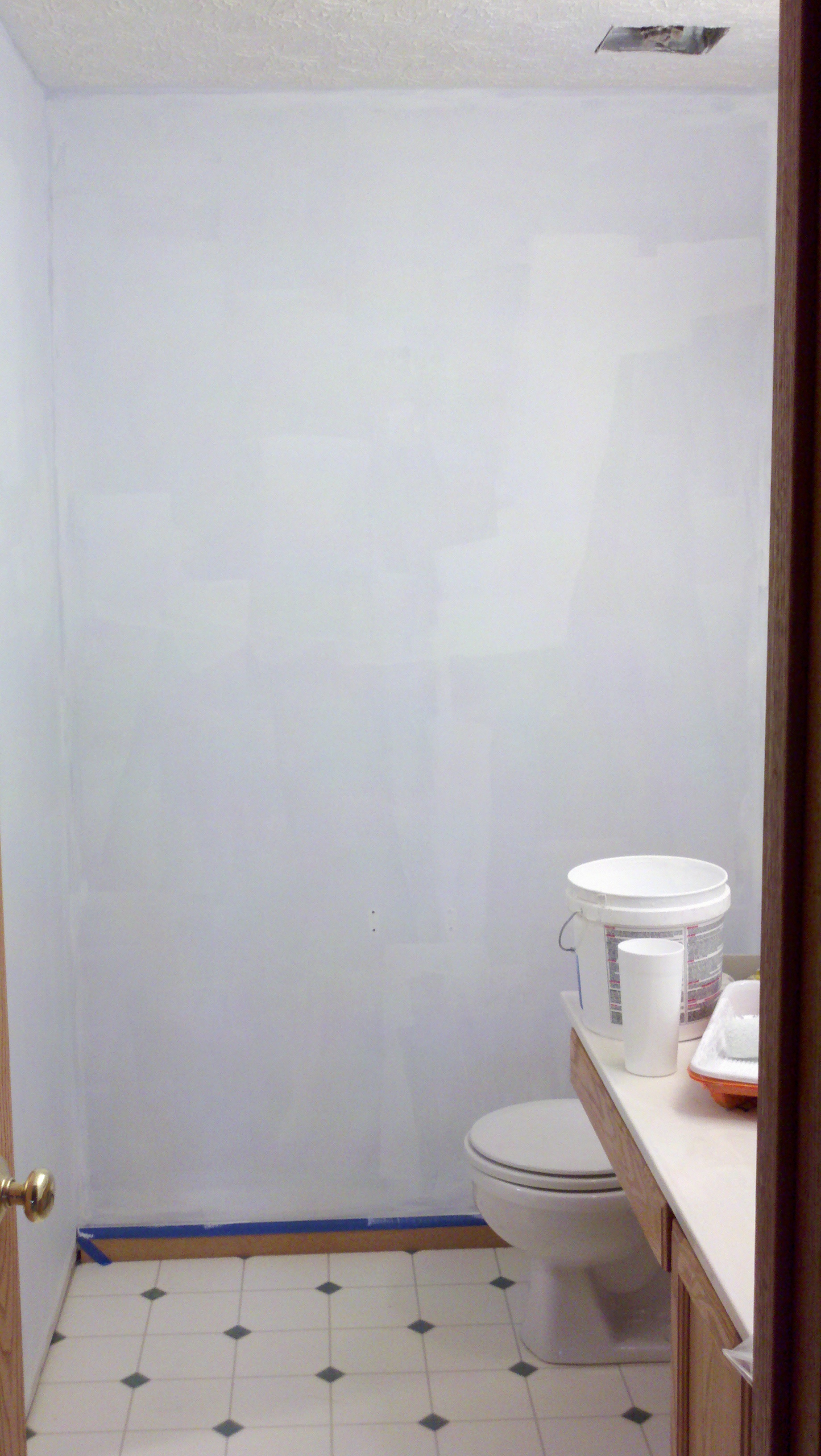

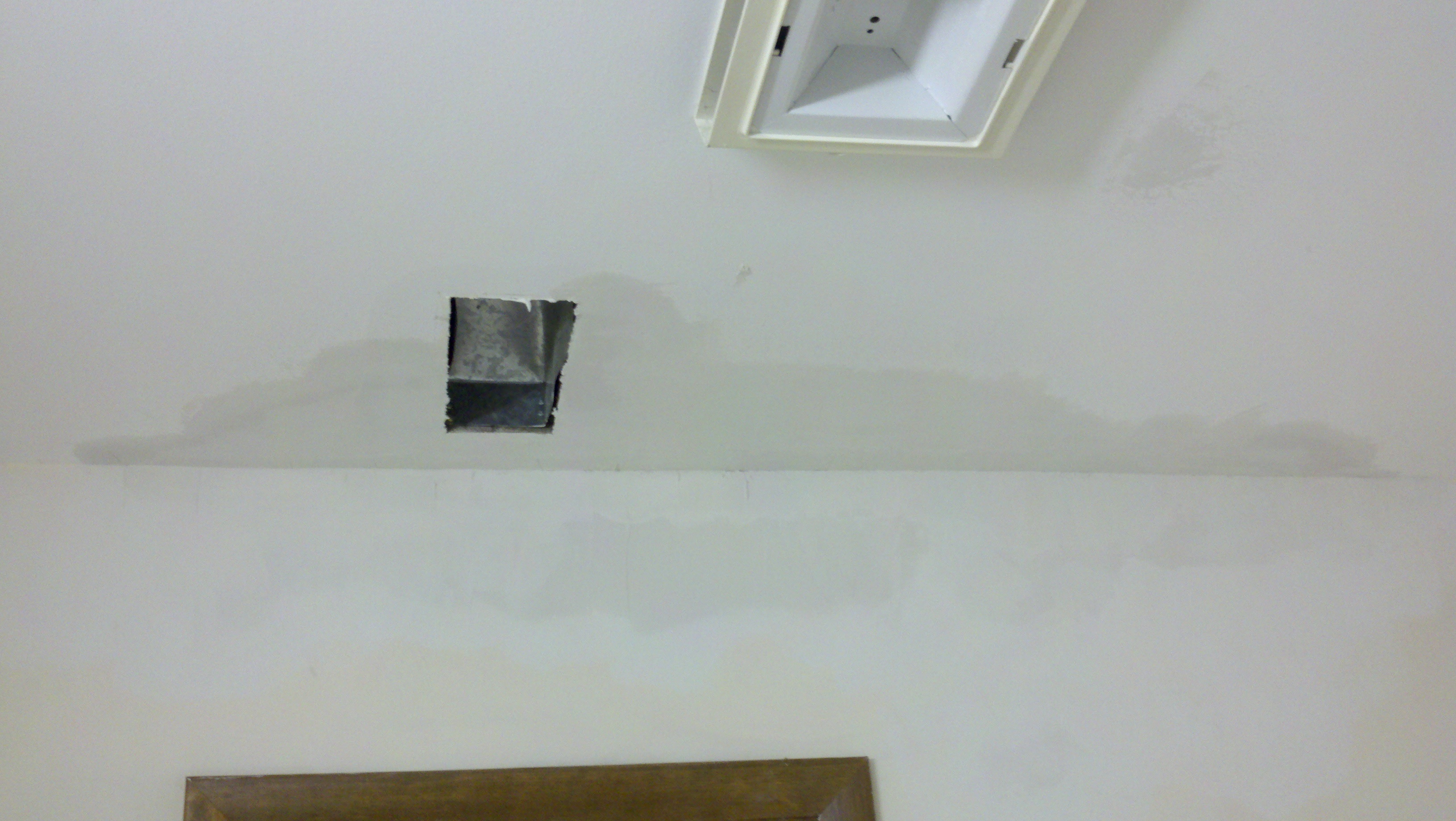

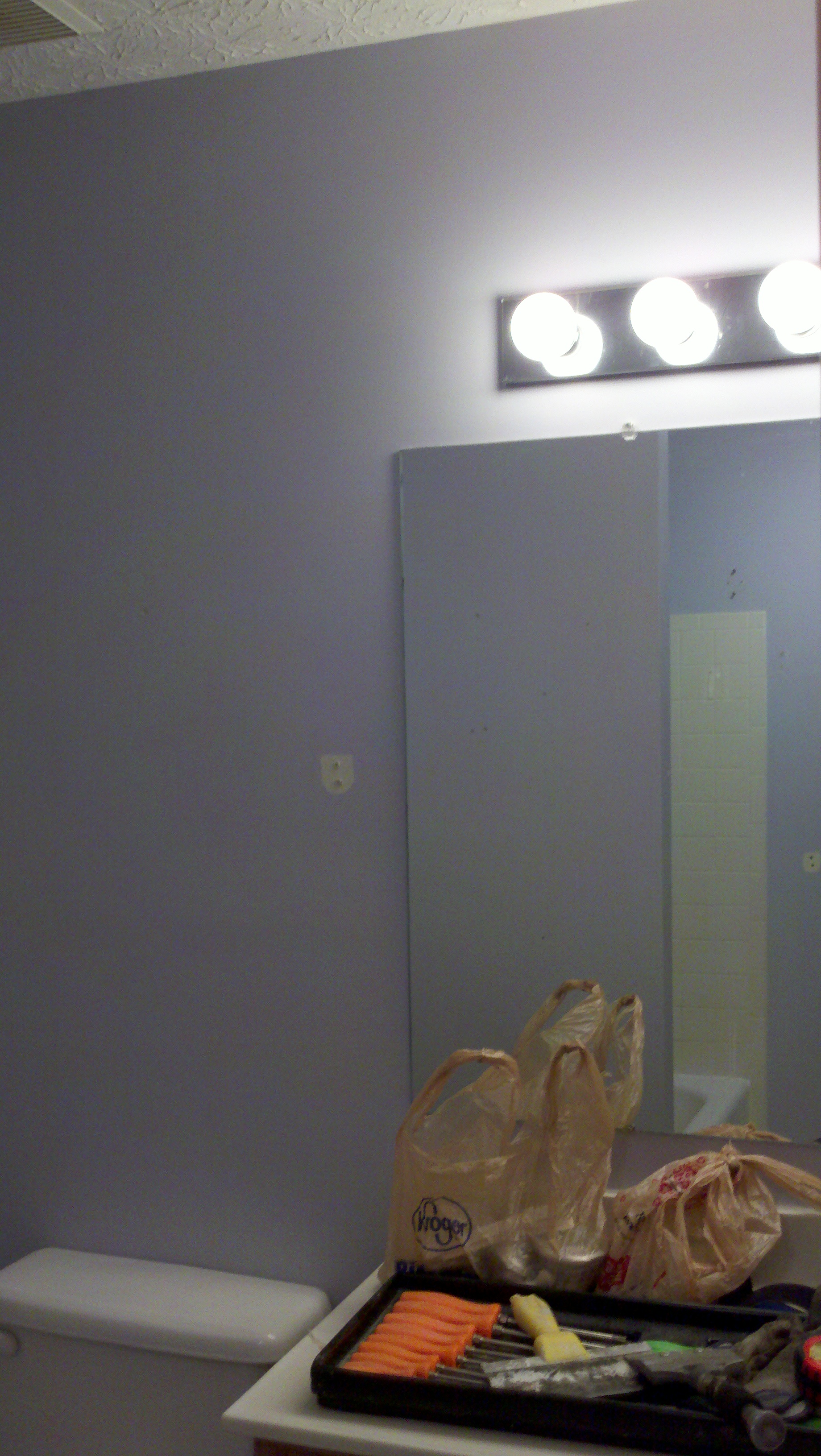

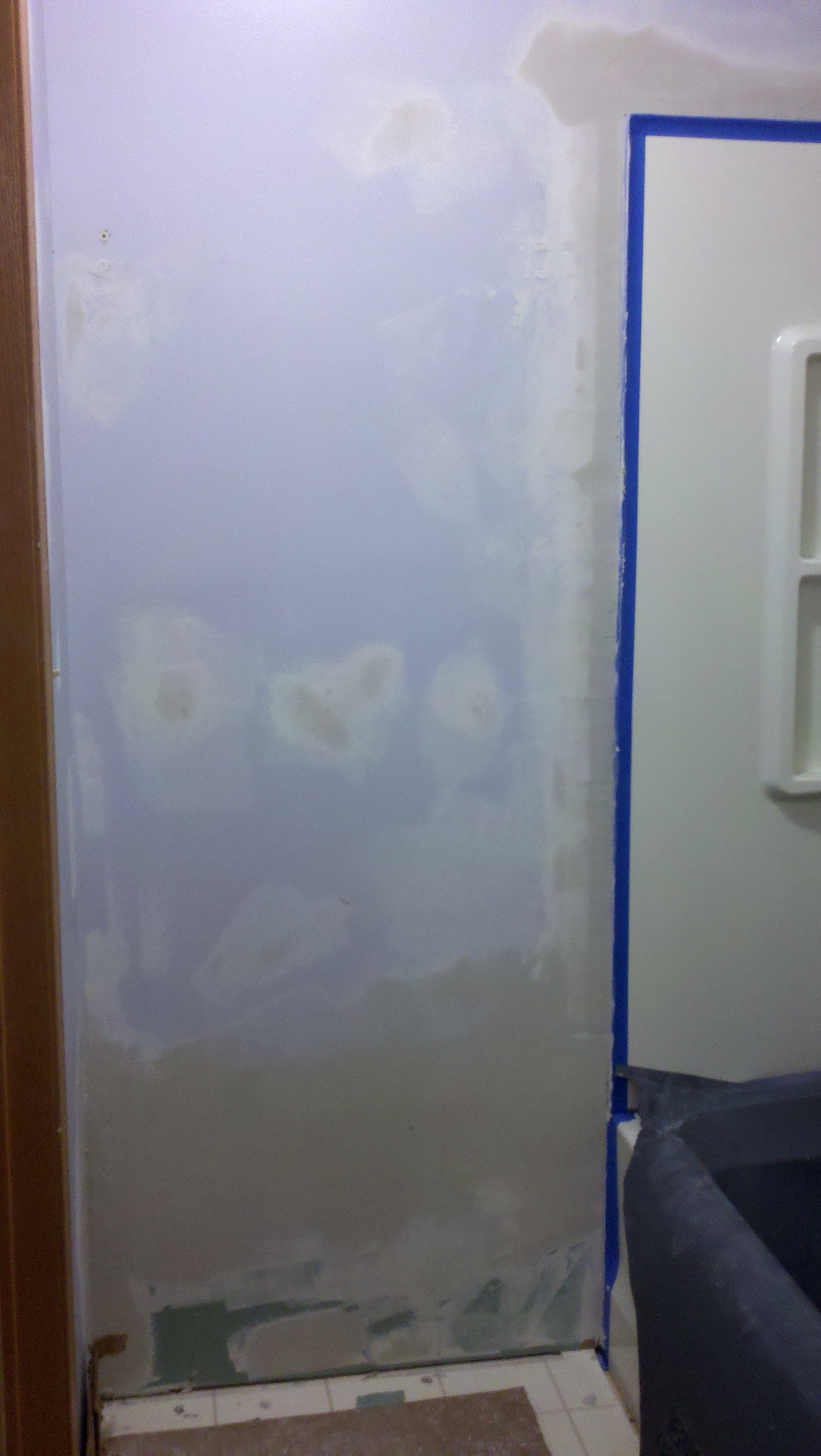

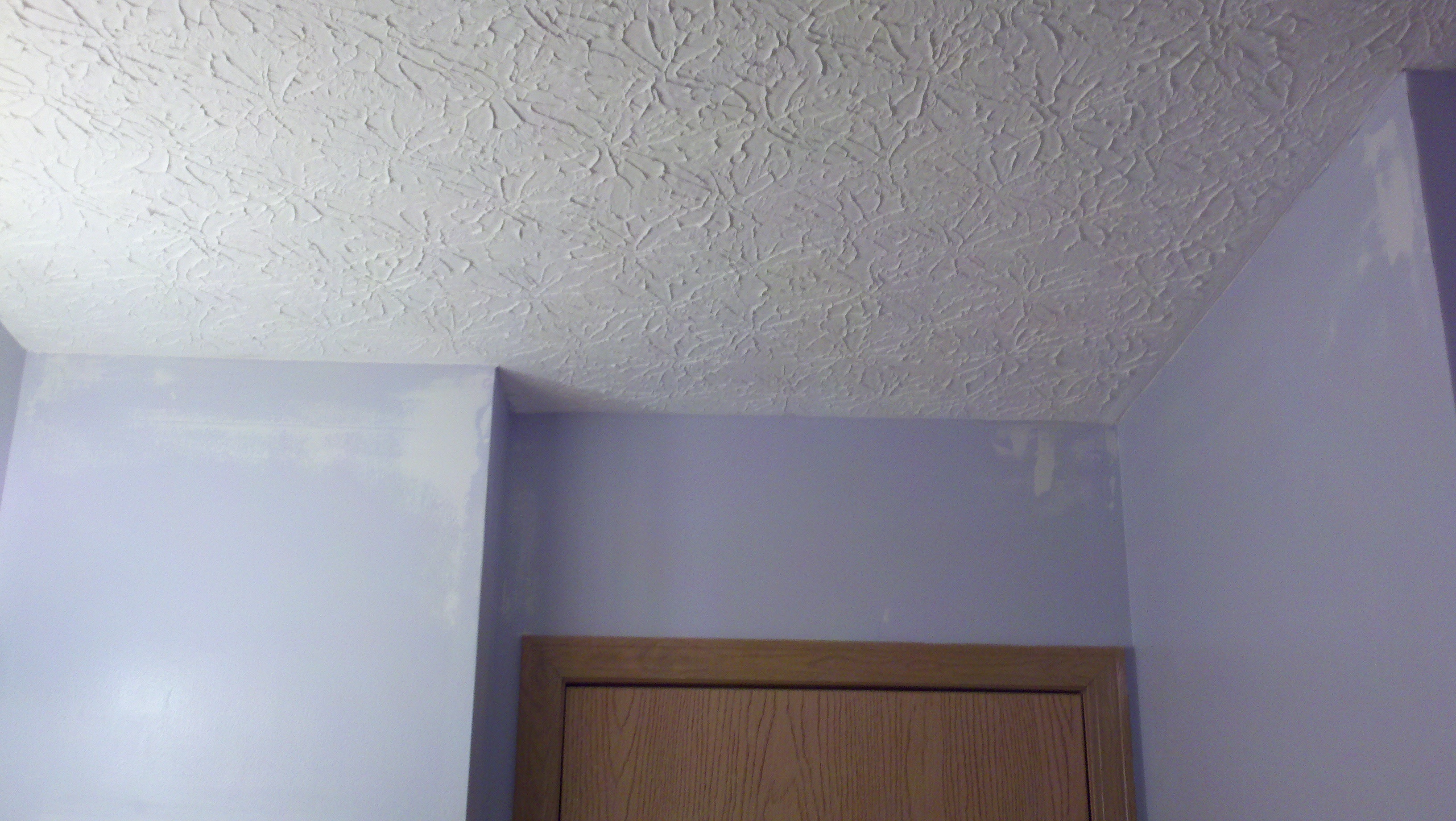

Removal of the damaged gypsum was completed the first part of the repair. Application of the joint compound provided a clean and immaculate result. Completion of the resurfacing required sanding of the compound to unveil a clean ceiling to wall 90 degree corner. Application of primer was completed to seal the compound. A fresh coat of ceiling paint provided a good clean white surround for the fresh coat of wall paint. The wall paint was used from the excess from the original job of selective wall repair and repaint from the previous year. |

Previous Bathroom Tile
Installation Removal, Repair, & Re-Installation of Tile
IN-PROCESS |
